Artech Artech Palm Meadows

Project Description

RERA Number: K-RERA/PRJ/083/2020
A Sanctuary of bliss.. on every level!

Artech Palm Meadows is our 64th project, an integrated experience for living in harmony with the natural world. Where glimpses of landscaping are worked into the design of tower block to create pockets of recreational breathing spaces. Where spacious and well-appointed residences beckon you to live life to the fullest.

The 2 & 3 BHK homes are designed with careful thought. No wonder your personal living space is in harmony with personal style. Designed to let life flow, living large comes naturally. Take your pick from the multiple units plans on offer. Whichever home you choose – well-appointed interiors and the Artech stamp of quality assurance come standard!

Categories: ,

Quick Enquire

Take your first few steps towards finding the ultimate happiness of the Perfect Home.

Floor Plans

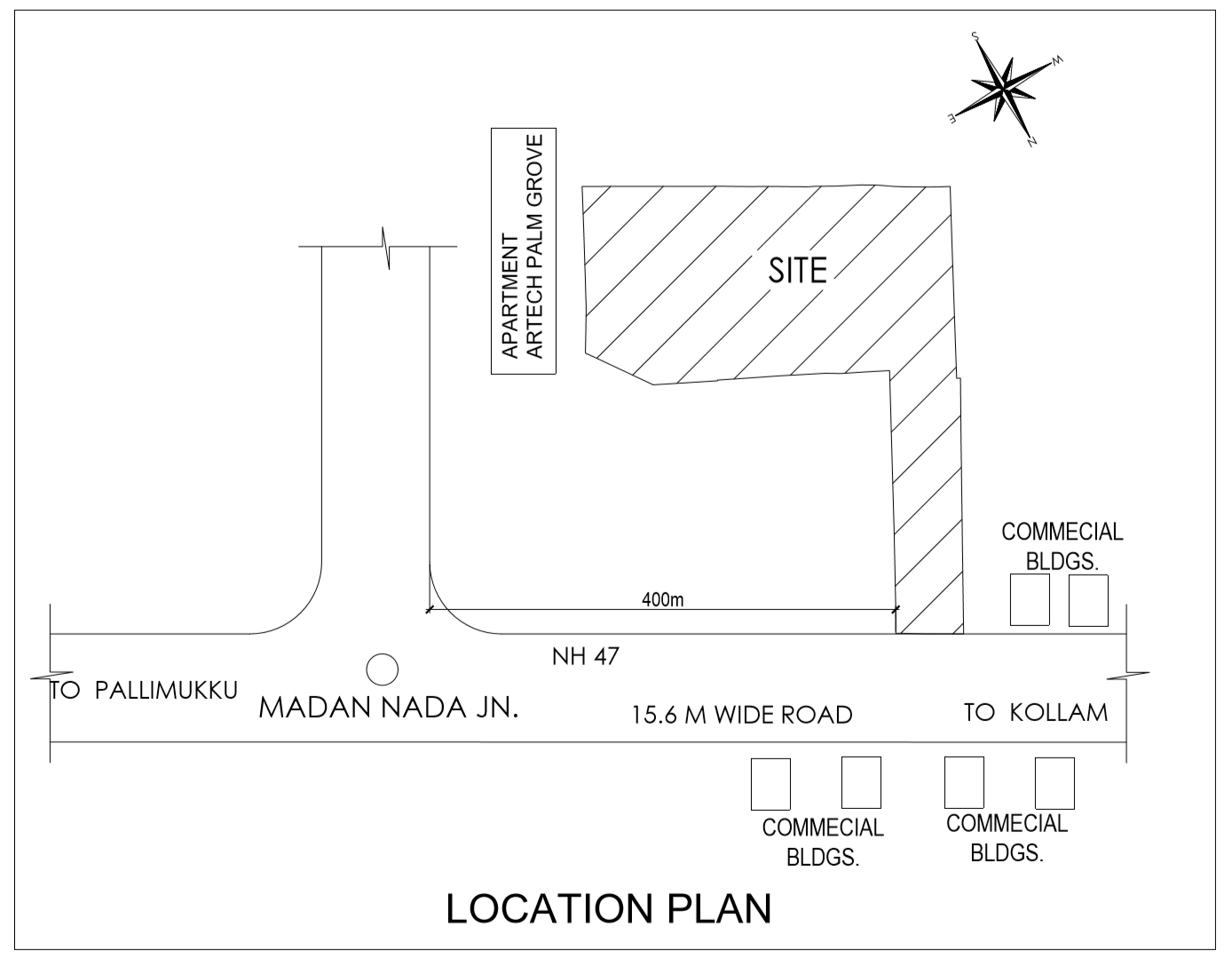

Location

Amenities

  • Terrace Swimming pool with deck and seating
  • Full equipped Air – Conditioned Unisex Gym
  • Children’s Play Area
  • Rooftop party area
  • Plush Entrance lobby
  • Indoor Games Room
  • Multi purpose hall
  • Video door phone
  • Driver’s Dormitory
  • Furnished Guest Suite

Progress

Work status as on 09-04-2021, we have completed the following.

  • Raft slab-S-E-corner side 100% completed.
  • SLAB RCC:
  1. BF Slab RCC Work-98% completed
  2. Slab RCC work GF-95% completed, 1st -18th floor -100% completed, 20th floor:-60% completed,19th floor,21st floor(aminety) -50% completed.
  • Column RCC Work :
  1. 14th floor-19th floor-100% completed.
  2. 20th floor -60% completed
  • Ceiling plastering
  1. 1st -17th floor -100% completed.
  2. 18th -20th floor -50% completed
  • Block Masonry
  1. upto 17th floor -100% completed
  2. 18th-19th floor -50 % completed
  • Wall chasing
  1. upto 15th floor :100% completed
  2. 16th -19th floor:- 40% completed
  • BALCONY HANDRAIL WORK
  1. upto 15th floor – 100% completed.
  • STAIRCASE HANDRAIL WORK
  1. 2nd floor -9th floor main and fire -100% completed.
  • Internal Wall Plastering
  1. upto 14th floor -100% completed.
  • External Wall Plastering
  1. 1st -13th floor elevation1, east side-80% completed
  2. 1st -13th floor elevation2, north side-30% completed
  • FIRST COAT PUTTY (INSIDE )
  1. upto 12th floor:-100 % Completed.
  • WATERPROOFING
  1. upto 8th floor toilet -100% completed
  2. 3th floor balcony -100% completed
  • PLUMBING WORK
  1. upto 12th-100% Completed
  2. Piping work
  3. upto 6th floor-100% completed/li>
  • ELECTRICAL WIRE PULLING
  1. 2nd floor-100% completed
  • WALL TILING TOILET
  1. 2nd floor (A)-100% completed.
  • FABRICATION WORK
  1. Window grill (2A)-100% completed
  • MOCK-UP FLAT (2A)
  1. 2A: Putty work 100% completed
  2. Balcony Handrail work: completed
  3. fire piping (2A)-100% completed
  4. electrical wiring-100% completed
  5. duct door 2nd floor -100% completed.
  6. Plumbing( toilet) -100% completed
  7. Waterproofing:- 100% completed.
  8. floor tile work (2A)-100% completed.

As per the current work status from our site, we are targeted to complete the following works by the end of APRIL 2021.

  • SLAB RCC:
  1. BF Slab RCC Work-100% completed
  2. SLAB RCC work: 19th,20th :-100% to be completed, 21st floor(aminety) -60% to be completed.
  • Column RCC Work :
  1. 20th floor-100% to be completed.
  2. 21st floor -60% to be completed
  • Ceiling plastering
  1. 18th -20th floor-100% to be completed.
  • Block Masonry
  1. 18th floor -100% to be completed
  • Wall chasing
  1. 16th floor:-100% to be completed
  • BALCONY HANDRAIL WORK
  1. 16th floor 100% to be completed
  • STAIRCASE HANDRAIL WORK
  1. 10th-12th floor main and fire -100% to be completed.
  • Internal Wall Plastering
  1. 15th floor-100% to be completed.
  • External Wall Plastering
  1. 1st -13th floor elevation1,east side-100% to be completed
  2. 1st -13th floor elevation2, north side-50% to be completed
  3. 1st -13th floor elevation3, west side-30% to be completed
  • FIRST COAT PUTTY (INSIDE )
  1. 13th floor – 100% to be completed.
  • RAMP WORK
  1. 60% to be completed.
  • WATERPROOFING
  1. 9th-floor toilet -100% to be completed
  2. 4th-floor balcony -100% to be completed
  • PLUMBING WORK
  1. 13th-100% to be Completed
  2. 7th floor-100% to be completed.
  • ELECTRICAL WIRE PULLING
  1. 3rd floor-100% to be completed
  • WALL TILING TOILET
  1. 2nd floor-100% to be completed.
  • MOCK-UP FLAT (2A)
  1. fire piping (2BC)-100% to be completed


Work status as on 11-03-2021, we have completed the following.

  • Raft slab-S-E-corner side 100% completed.
  • SLAB RCC:
  1. BF Slab RCC Work-98% completed
  2. Slab RCC work GF ,FF-95% completed, 2nd -16th  floor -100% completed, 17th ,20th floor:-60% completed,21st floor(aminety) -25% completed.
  • Column RCC Work :
  1. 14th floor-18th floor-100% completed.
  2. 19 floor-20th floor –60% completed
  • Ceiling plastering:
  1. 1st -15th floor –100% completed.
  2. 16th 20th floor -50% completed
  • Block Masonry:
  1. upto 16th floor -100%  completed
  2. 17th-19th floor -50 % completed
  • Wall chasing: upto 14th floor :100% completed, upto 14th floor :100% completed
  • BALCONY HANDRAIL WORK: upto 13th floor – 100% completed.
  • STAIRCASE HANDRAIL WORK: 2nd floor -9th floor main and fire -100% completed.
  • Internal Wall Plastering: up to 12th floor -100% completed.
  • External Wall Plastering:
  1. 1st -13th floor  elevation1, east side-60% completed
  2. 1st -13th floor  elevation2, north side-20% completed
  • FIRST COAT PUTTY (INSIDE): upto 11th floor:-100 %  Completed.
  • RAMP WORK
  • WATERPROOFING:
  1. up to 6th floor  toilet  –100% completed
  2. 3rd-floor balcony –100%  completed
  • PLUMBING WORK: up to 11th-100% Completed
  • Piping work: up to 5th, floor-100%  completed
  • ELECTRICAL WIRE PULLING:2(A)-100% completed,2(B)-40% completed.
  • WALL TILING TOILET:2nd floor (A)-100% completed.
  • FABRICATION WORK
  • MOCK UP FLAT (2A):
  1. 2A : Putty work 100% completed
  2. Balcony Handrail work: completed
  3. fire piping (2A)-100% completed
  4. electrical wiring-100% completed
  5. duct door 2nd floor -100% completed.
  6. Plumbing( toilet) -100% completed
  7. Water proofing :- 100% completed.
  8. floor tile work (2A)-100% completed.

As per the current work status from our site, we are targeted to complete the following works by the end of MARCH 2021.

  • SLAB RCC:
  1. BF Slab RCC Work-100% to be completed.
  2. SLAB  RCC work: 17th:-100% to be completed, 21st floor(amenity) -60% to be completed.
  • Column RCC Work:
  1. 19th floor-100% to be completed.
  2. 21st floor –60% to be completed
  • Ceiling plastering:
  1. 16th -17th floor-100% to be completed.
  • Block Masonry:
  1. up to 18th floor -100% to be completed
  • Wall Chasing:15th – 19th  floor:70% to be completed
  • BALCONY HANDRAIL WORK:14th -15th floor 100%  to be completed
  • STAIRCASE HANDRAIL WORK:10th-12th floor main and fire -100% to be completed.
  • Internal Wall Plastering: 13th floor-100%  to be completed.
  • External Wall Plastering:
  1. 1st -13th floor  elevation1,east side-100%  to be completed
  2. 1st -13th floor  elevation2, north side-40% to be completed
  • FIRST COAT PUTTY (INSIDE): 12th floor – 100% to be completed.
  • RAMP WORK: 60% to be completed
  • WATER PROOFING:
  1. 7th-floor toilet –100% to be completed
  2. 4th-floor balcony –100% to be completed
  • PLUMBING WORK:
  1. 12th-13th-100% to be Completed
  2. 6th floor-100% to be completed.
  • ELECTRICAL WIRE PULLING: 2nd floor-100% to be completed
  • WALL TILING TOILET: 2nd floor (B)-100 to be completed.
  • FABRICATION WORK: Window grill (2A)-100% to be completed, (2B)-100% to be completed.
  • MOCK UP FLAT (2A): fire piping (2BC)-100%  to be completed

As per the current work status from our site we are targeted to complete the following works by end of February 2021

  • SLAB RCC:
  1. BF Slab RCC Work-100% to be completed.
  2. SLAB RCC work: 17th:-100% to be completed, 21st floor(amenity) -60% to be completed.
  • Column RCC Work:
  1. 18th floor-100% to be completed.
  2. 21st floor -60% to be completed
  • Ceiling plastering:
  1. 16th floor-100% to be completed.
  2. 20th floor(E) -100% to be completed
  • Block Masonry:
  1. 16th floor (F)-100 % to be completed
  2. 19th floor (E)-100% to be completed
  • Wall Chasing: 15th floor:100% to be completed
  • Retaining wall work: 450m to be completed (out of 500 m)
  • BALCONY HANDRAIL WORK: 14th floor 100% to be completed
  • STAIRCASE HANDRAIL WORK: 10th-12th floor main and fire -100% to be completed.
  • Internal Wall Plastering: 12th floor-100% to be completed.
  • External Wall Plastering:
  1. 1st -13th floor elevation1,east side-100% to be completed
  2. 1st -13th floor elevation2, north side-40% to be completed
  • FIRST COAT PUTTY (INSIDE): 11th floor – 100% to be completed.
  • RAMP WORK: 60% to be completed
  • WATER PROOFING:
  1. 7th-floor toilet -100% to be completed
  2. 4th-floor balcony -100% to be completed
  • PLUMBING WORK:
  1. 11th-12th-100% to be Completed
  2. 6th floor-100% to be completed.
  • ELECTRICAL WIRE PULLING: 2nd floor-100% to be completed
  • WALL TILING TOILET: 2nd floor (B)-100 to be completed.
  • FABRICATION WORK: Window grill (2A)-100% to be completed, (2B)-100% to be completed.
  • MOCK UP FLAT (2A): fire piping (2ABC)-100% to be completed

Work status as on 09.02.2021, we have completed the following

  • Raft slab-S-E-corner side 100% completed.
  • SLAB RCC:
  1. BF Slab RCC Work-98% completed
  2. Slab RCC work GF ,FF-95% completed, 2nd -16th floor -100% completed, 17th ,20th floor:-60% completed.
  • Column RCC Work :
  1. 14th floor-16th floor-100% completed.
  2. 17 floor-20th floor -60% completed
  • Ceiling plastering:
  1. 1st -15th floor -100% completed
  2. 16th floor (E)-19th floor (E)-100% completed
  • Block Masonry:
  1. 7th -15th floor -100% completed
  2. 16th-18th floor (E)-100 % completed
  • Wall chasing: up to 14th floor:100% completed
  • Retaining wall work: Retaining wall work:421m completed (out of 500 m)
  • BALCONY HANDRAIL WORK: up to 13th floor – 100% completed.
  • STAIRCASE HANDRAIL WORK: 2nd floor -9th floor main and fire -100% completed.
  • Internal Wall Plastering: up to 11th floor, -100% completed.
  • External Wall Plastering:
  1. 1st -13th floor elevation1, east side-60% completed
  2. 1st -13th floor elevation2, north side-20% completed
  • FIRST COAT PUTTY (INSIDE): upto 10th floor:-100 % Completed.
  • WATERPROOFING:
  1. up to 6th floor toilet -100% completed
  2. 3rd-floor balcony -100% completed
  • PLUMBING WORK: up to 10th-100% Completed
  • Piping work: up to 5th, floor-100% completed
  • ELECTRICAL WIRE PULLING: 2(A)-100% completed,2(B)-40% completed.
  • WALL TILING TOILET: 2nd floor (A)-100% completed.
  • MOCK UP FLAT (2A):
  1. 2A : Putty work 100% completed
  2. Balcony Handrail work: completed
  3. fire piping (2A)-100% completed
  4. electrical wiring-100% completed
  5. duct door 2nd floor -100% completed.
  6. Plumbing( toilet) -100% completed
  7. Water proofing :- 100% completed.
  8. floor tile work (2A)-100% completed.

As per the current work status from our site we are targeted to complete the following works by end of June 2020

  • Pile cap -Building area completed,retaining wall area 25nos completed (out of 26 nos)
  • Raft slab-S-E-corner side 90% completed.
  • SLAB RCC:
  1. BF Slab RCC Work-95% completed
  2. Slab RCC work GF ,FF-95% completed, 2nd -11th floor -100% completed,12th -14th floor(A,B)-100% completed,15th floor:-70% completed.
  • Column RCC Work:
  1. 1 to -12th Floor -100% completed
  2. 13th floor- 100% completed
  3. 14th floor-60% completed.
  4. 15th floor-60% completed.
  • Ceiling plastering:
  1. Ground floor :90% completed
  2. 1st -11th floor -100% completed
  3. 12th floor (A,B)- 100%completed
  • Block Masonry:
  1. 2nd -6th floor-100% completed
  2. 7th floor(A&B) -100% completed. 7th(C,D)-90% completed.
  3. 8th floor -100% completed
  4. 9th floor (A,B)-100% completed
  5. 10th floor -100% completed
  6. 11th floor (A,B)-100% completed
  • Wall Chasing :
  1. Second floor :100% completed
  2. Third Floor :100% Completed
  3. Forth floor:(A,B,C,D) -100% completed
  4. Fifth floor :100% completed
  5. Sixth floor :100% completed
  6. seventh floor :100% completed
  • Retaining wall work: 296m completed (out of 500m)
  • BALCONY HANDRAIL WORK :
  1. 2(A,B,C,D):100% Completed
  2. 3(A,B,)-60% completed
  • STAIRCASE HANDRAIL WORK:
  1. Fire stair -( GF,1st ,2nd) -100% completed
  2. Main stair(GF,1st,2nd)-100% completed
  3. 2nd floor main and fire -100% completed.
  • Internal Wall Plastering:
  1. 2nd – 5th floor(A,B,C,D): -100% completed
  2. 6th floor(A,B,C,D)-100% completed
  • FIRST COAT PUTTY (INSIDE):
  1. 2nd floor(A,B,C,D)-100% Completed
  2. 3rd floor(A,B,C,D)-100% Completed
  3. 4th floor-(A,B):-100 % Completed, 4(C,D):-50% completed.
  • WATER PROOFING:
  1. 2nd floor(A)toilet -100% completed
  2. 2nd floor (A)balcony -100% completed
  • MOCK UP FLAT (2A):
  1. 2A : Putty work 100% completed
  2. Balcony Handrail work: completed
  3. fire piping-100% completed
  4. Electrical wiring-100% completed
  5. Plumbing( toilet) -100% completed
  6. Water proofing :- 100% completed.

As per the current work status from our site we are targeted to complete the following works by end of March 2020

  • Raft slab-100% to be completed
  • SLAB RCC work: ,11 th -100% to be completed ,12 th -80% to be completed.,15th floor:-60% to be completed.
  • Column RCC Work:
  1. 13th floor-100% to be completed
  2. 14th floor-100% to be completed
  3. 15th floor-60% to be completed
  • Ceiling plastering:
  1. 10th floor -100% to be completed
  2. 11th floor -100% to be completed
  3. 12th floor- 100% to be completed
  • Block Masonry:
  1. 7th floor(C&D) -100% to be completed
  2. 8th floor(C & D)-100% to be completed
  3. 9th floor (C&D)-100% to be completed
  4. 10th,11th,12thfloor (A&B )-100% to be completed
  • Wall chasing:
  1. sixth floor :100% to be completed
  2. seventh floor :100% to be completed
  • Retaining wall work: 326m to be completed (out of 500 m)
  • BALCONY HANDRAIL WORK: 3(A,B,)-100% to be completed
  • STAIRCASE HANDRAIL WORK: 3rd floor main and fire -100% to be completed.
  • Internal Wall Plastering: 6th floor(A,B,C,D)-100% to be completed
  • FIRST COAT PUTTY (INSIDE ):
  1. 5th floor(A,B)-100 % to be Completed
  2. 5th floor (C,D)-80% to be completed
  • RAMP WORK: 60% to be completed
  • WATERPROOFING: 2nd floor(B)-100% to be completed
  • FABRICATION WORK: Window grill (2A)-100% to be completed, (2B)-100% to be completed.

Work status as on 11.03.2020, we have completed the following

  • Pile cap -Building area completed,retaining wall area 21nos completed (out of 26 nos)
  • Raft slab-S-E-corner side 80% completed
  • SLAB RCC : BF Slab RCC Work-95% completed
  • Slab RCC work GF ,FF-95% completed, 2nd-9th floor-100% ,10 th floor -100% completed,11 th -60% completed,12 th -60% completed. 13th &14th floor-60% completed.
  • Column RCC Work:
  1. 1 to -10th Floor -100% completed
  2. 11th-12th floor -100% completed
  3. 13th-14 floor-60% completed
  • Ceiling plastering:
  1. Ground floor :90% completed
  2. 1st -9th floor -100% completed
  3. 10th -11th floor-60% completed
  • Block Masonry:
  1. 2nd -6th floor-100% completed
  2. 7th floor(A&B) -100% completed
  3. 8th floor (A,B)-100% completed
  4. 9th floor (A,B)-100% completed
  • Wall chasing:
  1. Second floor :100% completed
  2. Third Floor :100% Completed
  3. Forth floor:(A,B,C,D) -100% completed
  4. Fifth floor :100% completed
  • Retaining wall work: 296 m completed (out of 500 m)
  • BALCONY HANDRAIL WORK: 2(A,B,C,D):100% Completed
  • STAIRCASE HANDRAIL WORK:
    1. Fire stair -( GF,1st ,2nd) -100% completed.
    2. Main stair(GF,1st,2nd)-100% completed.
    3. 2nd floor main and fire -100% completed.
  • Internal Wall Plastering:
    1. 2nd floor (A,B,C,D)-100% Completed
    2. 3rd floor(A,B,C,D)-100% Completed
    3. 4th floor(A,B,C,D)-100% completed
    4. 5th floor(A,B,C,D)-100% completed
  • FIRST COAT PUTTY (INSIDE ):
    1. 2nd floor(A,B,C,D)-100% Completed
    2. 3rd floor(A,B,C,D)-100% Completed
    3. 3rd floor(C,D)-100 % Completed
  • WATERPROOFING:
    1. 2nd floor(A)toilet -100% completed
    2. 2nd floor (A)balcony -100% completed
  • MOCKUP FLAT (2A):
  1. 2A : Putty work 100% completed
  2. Balcony Handrail work: completed
  3. Fire piping-100% completed
  4. Electrical wiring-100% completed
  5. Plumbing( toilet) -100% completed

As per the current work status from our site we are targeted to complete the following works by end of February 2020

  • Raft slab-70% to be completed
  • SLAB RCC work: ,11 th -100% to be completed ,12 th -80% to be completed.,14th floor:-60% to be completed.
  • Column RCC Work:
  1. 12th floor-100% to be completed
  2. 13th floor-100% to be completed
  3. 14th floor-60% to be completed
  • Ceiling plastering:
  1. 9th floor-100% to be completed
  2. 10th floor -100% to be completed
  3. 11th floor -100% to be completed
  4. 12th floor-60% to be completed
  • Block Masonry:
  1. 7th floor(C&D) -100% to be completed
  2. 8th floor(B,C & D)-100% to be completed
  3. 9th floor (A&B)-100% to be completed
  4. 10th floor (A&B )-100% to be completed
  • Wall chasing:
  1. Forth floor:(C&D) -100% to be completed
  2. sixth floor :100% to be completed
  3. seventh floor :100% to be completed
  • Retaining wall work: 296m to be completed (out of 500 m)
  • BALCONY HANDRAIL WORK: 2(B,C,D)-100% to be completed
  • STAIRCASE HANDRAIL WORK: 2nd floor main and fire -100% to be completed.
  • Internal Wall Plastering: 5th floor(A,B,C,D)-100% to be completed
  • FIRST COAT PUTTY (INSIDE ):
  1. 4th floor(A,B)-100 % to be Completed
  2. 4th floor (C,D)-80% to be completed
  • RAMP WORK: 60% to be completed
  • WATERPROOFING: 2nd floor(B)-100% to be completed
  • FABRICATION WORK: Window grill (2A)-100% to be completed, (2B)-100% to be completed.

Work status as on 08.02.2020, we have completed the following

  • Pile cap -Building area completed,retaining wall area 21nos completed (out of 26 nos)
  • Raft slab-S-E-corner side 50% completed
  • SLAB RCC : BF Slab RCC Work-95% completed
  • Slab RCC work GF ,FF-95% completed, 2nd-9th floor-100%, 10th floor -100% completed, 11th -60% completed,12th -60% completed. 13th floor-60% completed.
  • Column RCC Work:
  1. 1 to -10th Floor -100% completed
  2. 11th floor -100% completed
  3. 12th floor-60% completed
  4. 13th floor-60% completed
  • Ceiling plastering:
  1. Ground floor :90% completed
  2. 1st -7th floor -100% completed
  3. 8th floor-100% completed
  4. 9th floor-60% completed
  5. 10th floor-60% completed
  6. 11th floor-60% completed
  • Block Masonry:
  1. 2nd -5th floor-100% completed
  2. 6th floor -100% completed
  3. 7th floor(A&B) -100% completed
  4. 8th floor (A,B)-100% completed
  5. 9th floor (A,B)-40% completed
  • Wall chasing:
  1. Second floor :100% completed
  2. Third Floor :100% Completed
  3. Forth floor:(A&B) -100% completed
  4. Fifth floor :100% completed
  • Retaining wall work: 196 m completed (out of 500 m)
  • BALCONY HANDRAIL WORK: 2A:100% Completed
  • STAIRCASE HANDRAIL WORK:
    1. Fire stair -( GF,1st ,2nd) -100% completed
    2. Main stair(GF,1st,2nd)-100% completed
  • Internal Wall Plastering:
    1. 2nd floor (A,B,C,D)-100% Completed
    2. 3rd floor(A,B,C,D)-100% Completed
    3. 4th floor(A,B,C,D)-100% to be completed
  • FIRST COAT PUTTY (INSIDE ):
    1. 2nd floor(A,B,C,D)-100% Completed
    2. 3rd floor(A,B,C,D)-100% Completed
    3. 3rd floor(C,D)-100% Completed
  • WATERPROOFING:
    1. 2nd floor(A)toilet -100% completed
    2. 2nd floor (A)balcony -100% completed
  • MOCKUP FLAT (2A):
  1. 2A : Putty work 100% completed
  2. Balcony Handrail work: completed
  3. fire piping-100% completed
  4. electrical wiring-100% completed
  5. Plumbing( toilet) -100% completed

As per the current work status from our site we are targeted to complete the following works by end of January 2020

  • Pile cap -Building area completed,retaining wall area 20nos completed (out of 26 nos)
  • Raft slab-100% to be completed
  • SLAB RCC : 10 th -100%,11 th -80% ,12 th -80% to be completed
  • Column RCC Work:
  1. 10th-11th floor -100% to be completed
  2. 11th-12th floor-100% to be completed
  3. 12th-13th floor-100% to be completed
  • Ceiling plastering:
  1. 8th floor-100% to be completed
  2. 9th floor-100% to be completed
  3. 10th floor -100% to be completed
  4. 11th floor-60% to be completed
  5. 12th floor-60% to be completed
  • Block Masonry:
  1. 6th floor -100% to be completed
  2. 7th floor(C&D) -100% to be completed
  3. 8th floor(B,C & D)-100% to be completed
  4. 9th floor (A&B)-100% to be completed
  5. 10th floor (A&B )-100% to be completed
  • Wall chasing:
  1. Forth floor:(C&D) -100% to be completed
  2. Fifth floor :100% to be completed
  • Retaining wall work: 170m to be completed (out of 500 m)
  • BALCONY HANDRAIL WORK: 2(B,C,D)-100% to be completed
  • STAIRCASE HANDRAIL WORK: Main stair(GF,1st,2nd)-100% to be completed
  • Internal Wall Plastering: 4th floor(A,B,C,D)-100% to be completed
  • FIRST COAT PUTTY (INSIDE ): 3rd floor(C,D)-50 % To beCompleted
  • RAMP WORK: 60% to be completed
  • FABRICATION WORK: Window grill (2A)-100% to be completed

Work status as on 10.01.2020, we have completed the following

  • Pile chipping -100% completed
  • Pile cap -Building area completed,retaining wall area 16nos completed (out of 26 nos)
  • Raft slab-S-E corner side 40% completed
  • SLAB RCC:
  1. BF Slab RCC Work-95% completed
  2. Slab RCC work GF ,FF-95% completed, 2nd-9th floor-100% ,10 th floor -60% completed,11 th -60% completed,12 th -60% completed.
  • Column RCC Work:
  1. 1 to -10th Floor -100% completed
  2. 10th-11th floor -60% completed
  3. 11th-12th floor-60% completed
  4. 12th-13th floor-60% completed
  • Ceiling plastering:
  1. Ground floor :90% completed
  2. 1st -7th floor -100% completed
  3. 8th floor-60% completed
  4. 9th floor-60% completed
  5. 10th floor-60% completed
  • Block Masonry:
  1. 2nd -5th floor-100% completed
  2. 6th floor -40% completed
  3. 7th floor(A&B) -100% completed
  4. 8th floor (A)-100% completed , (B)-60% completed
  • Wall chasing:
  1. Second floor :100% completed
  2. Third Floor :100% Completed
  3. Fourth floor:(A&B) -100% completed
  • Retaining wall work: 156 m completed (out of 500 m)
  • BALCONY HANDRAIL WORK:
  1. 2A:100% Completed
  2. STAIRCASE HANDRAIL WORK
  3. Fire stair -( GF,1st ,2nd) -100% completed
  4. Internal Wall Plastering
  5. 2nd floor (A,B,C,D)-100% Completed
  6. 3rd floor(A,B,C,D)-100% Completed
  • FIRST COAT PUTTY (INSIDE ):
  1. 2nd floor(A,B,C,D)-100% Completed
  2. 3rd floor(A,B)-100% Completed
  • WATERPROOFING: 2nd floor(A)toilet -100% completed
  • MOCKUP FLAT (2A):
  1. 2A : Putty work 100% completed
  2. Balcony Handrail work: completed
  3. fire piping-100% completed
  4. electrical wiring-100% completed
  5. Plumbing( toilet) -100% completed

As per the current work status from our site we are targeted to complete the following works by end of September 2019

  • SLAB RCC work -5 th &6 th -100 % ,9 th -60% ,10 th -40% to be completed
  • Ceiling plastering: Sixth floor -75%,7 th -60% ,8 th -40% to be completed
  • Block Masonry: Second floor :100% to be completed
  • Block Masonry: Third floor :100% completed
  • Block Masonry: Fourth floor :80% completed
  • Electrical wall chasing: Second floor :100% to be completed
  • Electrical wall chasing: Third floor :60% to be completed
  • Retaining wall work : 130m to be completed (out of 500m)

Work status as on 05.09.2019, we have completed the following

  • Pile chipping -100% completed
  • Pile cap -Building area completed,retaining wall area 10nos completed (out of 26 nos)
  • BF Slab RCC Work-95% completed
  • Slab RCC work GF ,FF-95% completed,SF-100% , 3 rd -100%,4 th -100% ,5 th -100% ,6 th -60% completed ,7 th -60% ,8 th -60%,9 th -50%,10 th floor -40% completed
  • Column RCC Work: 1 to -2 nd Floor -100% completed
  • Column RCC Work: 2 to -3rd Floor -100% completed
  • Column RCC Work: 3rd to -4 th Floor -100% completed
  • Column RCC Work: 4 th to -5 th Floor -100% completed
  • Column RCC Work: 5th to -6 th Floor -100% completed
  • Column RCC Work: 6 th to -7 th Floor -100% completed
  • Column RCC Work: 7 th to -8 th Floor -60% completed
  • Column RCC Work: 8th to -9 th Floor -60% completed
  • Column RCC Work: 9th to -10th Floor -40% completed
  • Ceiling plastering: Ground floor :90% completed
  • Ceiling plastering: First floor :90% completed
  • Ceiling plastering: Second floor :100% completed
  • Ceiling plastering: Third floor :75% completed
  • Ceiling plastering: Fourth Floor :75% completed
  • Ceiling plastering: Fifth floor :75% completed
  • Ceiling plastering: Sixth floor :60% completed
  • Block Masonry: Second floor :95% completed
  • Block Masonry: Third floor :70% completed
  • Block Masonry: Fourth floor :70% completed
  • Block Masonry: Fifth floor :40% completed
  • Electrical wall chasing: Second floor :40% completed
  • Retaining wall work :80 m completed (out of 500 m)

As per the current work status from our site we are targeted to complete the following works by end of August 2019

  • SLAB RCC work -5 th &6 th -100 % ,9 th -60% ,10 th -40% to be completed
  • Column RCC Work : 5th to -6th Floor -100% completed
  • Column RCC Work : 6th to -7thFloor -60% to be completed
  • Column RCC Work : 8th to 9thFloor , 9th-10th -60% to be completed
  • Ceiling plastering: Second floor :100% to be completed
  • Ceiling plastering: Third floor :100% tobe completed
  • Ceiling plastering: Fourth floor -100% to be completed ,fifth & Sixth floor -100% to be completed
  • Block Masonry: Second floor :100% to be completed
  • Block Masonry: Third floor :100% completed
  • Block Masonry: Fourth floor :100% completed
  • Electrical wall chasing: First floor :100% to be completed
  • Electrical wall chasing: Second floor :100% to be completed
  • Electrical wall chasing: Third floor :100% to be completed
  • Retaining wall work :70m to be completed (out of 500 m)

Work status as on 05.08.2019, we have completed the following

  • Pile chipping -100% completed
  • Pile cap -Building area completed,retaining wall area 10nos completed (out of 26 nos)
  • BF Slab RCC Work-95% completed
  • Slab RCC work GF ,FF-95% completed,SF-100% , 3 rd -100%,4 th -100% ,5 th -60% ,6 th -60% completed ,7 th -60% ,8 th -60%,9 th -40%
  • Column RCC Work: 1 to -2 nd Floor -100% completed
  • Column RCC Work: 2 to -3rd Floor -100% completed
  • Column RCC Work: 3rd to -4 th Floor -100% completed
  • Column RCC Work: 4 th to -5 th Floor -100% completed
  • Column RCC Work: 5th to -6 th Floor -60% completed
  • Column RCC Work: 6 th to -7 th Floor -60% completed
  • Column RCC Work: 7 th to -8 th Floor -60% completed
  • Column RCC Work: 8th to -9 th Floor -40% completed
  • Ceiling plastering: Ground floor :90% completed
  • Ceiling plastering: First floor :90% completed
  • Ceiling plastering: Second floor :75% completed
  • Ceiling plastering: Third floor :75% completed
  • Ceiling plastering: Fourth Floor :75% completed
  • Block Masonry: Second floor :95% completed
  • Block Masonry: Third floor :60% completed
  • Block Masonry: Fourth floor :40% completed
  • Retaining wall work :50 m completed (out of 500 m)

As per the current work status from our site we are targeted to complete the following works by end of July 2019

  • SLAB RCC work -7 th & 8 th Floor -60% completed.
  • Column RCC Work : 2 to -3rd Floor -100% to be completed
  • Column RCC Work : 3rd to -4 th Floor -100% to be completed
  • Column RCC Work : 6 th to -7 thFloor -60% to be completed
  • Ceiling plastering: Ground floor :75% to be ompleted
  • Ceiling plastering: First floor :75% to be completed
  • Ceiling plastering: Second floor :100% to be completed
  • Ceiling plastering: Fourth floor :75% to be completed
  • Block Masonry: Second floor :60% to be completed
  • Block Masonry: Third floor :40% to be completed
  • Electrical wall chasing: First floor :60% to be completed
  • Electrical wall chasing: Second floor :60% to be completed
  • Retaining wall work :60m to be completed (out of 500 m)

Work status as on 06.07.2019, we have completed the following

  • Pile chipping -100% completed
  • Pile cap -Building area completed,retaining wall area 10nos completed (out of 26 nos)
  • BF Slab RCC Work-95% completed
  • Slab RCC work GF ,FF-95% completed,SF-100% , 3 rd -85%,4 th -75% ,5 th -60% ,6 th -60% completed
  • Column RCC Work: 1 to -2 nd Floor -100% completed
  • Column RCC Work: 2 to -3rd Floor -95% completed
  • Column RCC Work: 3rd to -4 th Floor -75% completed
  • Column RCC Work: 4 th to -5 th Floor -60% completed
  • Ceiling plastering: Ground floor :60% completed
  • Ceiling plastering: First floor :70% completed
  • Ceiling plastering: Second floor :75% completed
  • Ceiling plastering: Third floor :75% completed
  • Block Masonry: Second floor :40% completed
  • Retaining wall work :30 m completed (out of 500 m)

As per the current work status from our site we are targeted to complete the following works by end of June 2019

  • pile cap (Retaining wall area)-15nos to be completed out of 26 nos
  • BF Slab RCC Work-95% to be completed
  • GF Slab RCC Work-95% to be completed
  • second floor Slab -90% to be completed
  • Column work -FF-SF Column work -100% to be completed,2nd -3rd Column work- 100% completed,4 th -5 th floor Column work -60% completed.
  • Ceiling plastering- 1st floor -75% to be completed ,2 nd floor -75% to be completed
  • Brick masonry work -2 nd floor -40% to be completed
  • Electrical chasing work -2 nd floor -40% to be completed

Work status as on 06.06.2019, we have completed the following

  • Pile chipping -100% completed
  • Pile cap -Building area completed,retaining wall area 9nos completed (out of 26 nos)
  • BF Slab RCC Work-90% completed
  • GF ,FF slab RCC work -90% completed
  • 2 nd ,3 rd,4 th floor Slab RCC Work-75% completed
  • GF-FF Column work -100% completed,FF-SF Column work -85% completed,2ND-3RD Column work -85% completed,3 rd -4 TH Column work -75% completed.
  • Ceiling plastering- 1st floor -60% completed ,2 nd floor -40% completed






As per the current work status from our site we are targeted to complete the following works by end of May 2019

  • pile cap (Retaining wall area)-11 nos to be completed out of 26 nos
  • BF Slab RCC Work-90% to be completed
  • First floor Slab -90% to be completed
  • Fourth floor slab & fifth floor slab RCC Work-60% to be completed.
  • BF -GF Column work -90% to be completed
  • GF-FF Column work -90% to be completed,4 th to 5 th floor column -60% to be completed.
  • Ceiling plastering 1& 2 nd floor -60% to be completed
  • Brick masonry work -2 nd floor -40% to be completed
  • Electrical chasing work -2 nd floor -40% to be completed

Work status as on 06.05.2019, we have completed the following

  • Pile chipping -100% completed
  • Pile cap -Building area completed,retaining wall area 6 nos completed (out of 26 nos)
  • BF Slab RCC Work-80% completed
  • GF slab RCC work – 80% completed
  • FF,SF,TF Slab RCC Work-75% completed
  • Fourth floor slab RCC Work-Shuttering completed
  • BF -GF Column work -80% completed
  • GF-FF Column work -70% completed,FF-SF Column work -60% completed,2ND-3RD Column work -60% completed,3 RD-4 TH Column work -60% completed.

As per the current work status from our site we are targeted to complete the following works by end of April 2019

  • BF Slab RCC Work-100% to be completed
  • GF slab RCC work – 100% to be completed
  • FF Slab RCC Work-100% to be completed,SF,TF-65% to be completed,Forth floor slab -60% to be completed.
  • Column RCC work (Building)basement – 100% to be completed
  • Column RCC work (Building) Ground- 100% to be completed (out of 53)
  • Column RCC work (Building) First floor-65% Completed,SF (65% to be completed),TF Column -60% tobe completed)

Work status as on 05.04.2019, we have completed the following

  • Piling work – 100% completed
  • Pile chipping – 100% completed (out of 148)
  • Pile chipping – Retaining wall area 6completed(out of 26)
  • Pile cap (retaining wall area) – 6completed(out of 26)
  • Pile cap work – 13nos completed (out of 14);
  • BF Slab RCC Work-80% completed
  • GF slab RCC work – 75% completed
  • FF Slab RCC Work-75% completed
  • Column RCC work (Building)basement – 80% completed
  • Column RCC work (Building) Ground-90% completed (out of 53)
  • Column RCC work (Building) First floor-40% Completed

As per the current work status from our site we are targeted to complete the following works by end of March 2019

  • Pile chipping – 148 to be completed (out of 148)
  • BF Slab RCC Work-100% to be completed
  • GF slab RCC work – 100% to be completed
  • FF Slab RCC Work-70% to be completed
  • Column RCC work (Building)basement – 100% to be completed
  • Column RCC work (Building) Ground- 100% to be completed (out of 53)

Work status as on 06-03-2019, we have completed the following

  • Piling work – 100% completed
  • Pile chipping – 142 nos completed (out of 148)
  • Pile chipping – Retaining wall area 3 completed(out of 26)
  • Pile cap work – 13nos completed (out of 14);
  • BF Slab RCC Work-70% completed
  • GF slab RCC work – 70% completed
  • FF Slab RCC Work-40% completed
  • Column RCC work (Building)basement – 80% completed
  • Column RCC work (Building) Ground- 65% completed (out of 53)
  • Column RCC work (Building) First floor-40% Completed

As per the current work status from our site we are targeted to complete the following works by end of February 2019

  • BF Slab RCC Work-100% to be completed
  • GF slab RCC work – 100% to be completed
  • Column RCC work (Building)basement – 100% to be completed

Work status as on 05-02-2019, we have completed the following

  • Piling work – 100% completed
  • Pile chipping – 112 nos completed (out of 148)
  • Pile chipping – Retaining wall area 3completed(out of 26)
  • Pile cap work – 11nos completed (out of 14);
  • BF Slab RCC Work-50% completed
  • GF slab RCC work – 50% completed
  • FF Slab RCC Work-50% completed
  • Column RCC work (Building)basement – 60% completed
  • Column RCC work (Building) Ground- 60% completed (out of 53)
  • Column RCC work (Building) First floor- 30% Completed

As per the current work status from our site we are targeted to complete the following works by end of January 2019

  • BF Slab RCC Work-60% to be completed
  • GF slab RCC work – 60% to be completed

Work status as on 08-01-2019, we have completed the following

  • Piling work – 100% completed
  • Pile chipping – 112 nos completed (out of 148)
  • Pile chipping – Retaining wall area 3completed(out of 26)
  • Pile cap work – 10nos completed (out of 14);
  • BF Slab RCC Work-45% completed
  • GF slab RCC work – 40% completed
  • FF Slab RCC Work-40% completed
  • Column RCC work (Building)basement – 31nos completed (out of 53)
  • Column RCC work (Building) Ground- 19nos completed (out of 53)

As per the current work status from our site we are targeted to complete the following works by end of December 2019

  • Pile chipping – 122 nos to be completed (out of 148)
  • Pile cap work – 11nos to be completed (out of 14)
  • GF slab RCC work – 60% to be completed
  • FF Slab RCC Work-20%to be completed

Work status as on 06-12-2018, we have completed the following

  • Piling work – 100% completed
  • Pile chipping – 102 nos completed (out of 148)
  • Pile chipping – Retaining wall area 2 completed(out of 26)
  • Pile cap work – 8nos completed (out of 14);
  • GF slab RCC work – 40% completed
  • FF Slab RCC Work-on progress
  • Column RCC work (Building)basement – 19nos completed (out of 53)
  • Column RCC work (Building) Ground- 15nos completed (out of 53)

As per the current work status from our site we are targeted to complete the following works by end of November 2018

  • Pile chipping – 100 nos to be completed (out of 148)
  • Pile cap work – 6nos to be completed (out of 14)
  • GF slab RCC work – 60% to be completed
  • Column RCC work (Building) – 28 nos to be completed (out of 52)

Work status as on 16-11-2018, we have completed the following.

  • Piling work – 100% completed
  • Pile chipping – 85 nos completed (out of 148)
  • Pile cap work – 5nos completed (out of 14);
  • GF slab RCC work – 30% completed
  • Column RCC work (Building) – 19nos completed (out of 53)

 Work Schedule for the Month of July 2018

  • Pile chipping – 60nos to be completed (out of 148)
  • Pile cap work – 4nos to be completed (out of 14)
  • Column RCC work (Building) – 8 nos to be completed (out of 52)

Work status as on 05-06-2018, we have completed the following.

  • Piling work – 100% completed
  • Pile chipping – 40 nos completed (out of 148)
  • Pile cap work – 1no completed (out of 14)
  • Column RCC work (Building) – 5 nos completed (out of 52)

 Work Schedule for the Month of June 2018

  • Piling work – 158 nos completed (out of 174)
  • Pile chipping – 9 nos completed (out of 148)
  • Pile cap work – 1no completed (out of 14)
  • Column RCC work (Building) – 5 nos completed (out of 52)

 As per the current work status from our site we are targeted to complete the following works by end of June 2018

  • Piling work – 100% to be completed
  • Pile chipping – 18 nos to be completed (out of 148)
  • Column RCC work (Building) – 8 nos to be completed (out of 52)

As per the current work status from our site we are targeted to complete the following works by end of March 2018

  • Piling work -134 to be completed (out of 174)

Work status as on 1 3 -03 -2018, we have completed.

  • Piling work – 104 nos completed (out of 174)

Situated on the National Highway, Polayathodu is one of the fastest-growing neighbourhoods in Kollam. One of the highly urbanized areas of Kollam, Polayathodu offers all urban amenities. Hospitals, schools and shopping centres are close by making it a much sought out destination for buying a dream home. It is at this bustling centre of Polayathodu that Artech Realtors has launched Artech Palm Meadows, a carefully thought out sanctuary of bliss. Artech Palm Meadows at Polayathodu boasts of 2 and 3 BHK luxury homes that are spacious and in harmony with nature. If you are someone who loves to live large, this is the apartment complex that you have to invest in. You get a pick of an array of well thought out amenities. Fully equipped Air – Conditioned Unisex Gym, Plush Entrance lobby, Furnished Guest Suite and a driver's dormitory are some of the additions that this luxury apartment complex offers you. Add to it the Terrace Swimming pool with deck and seating and you have a great way to relax after a hectic day at work. The amenities at Artech Palm Meadows at Polayathodu are just what you are dreaming of in your future home. Pick for our different 2 and 3 BHK layouts and trust us that you will never have a reason to complain.
