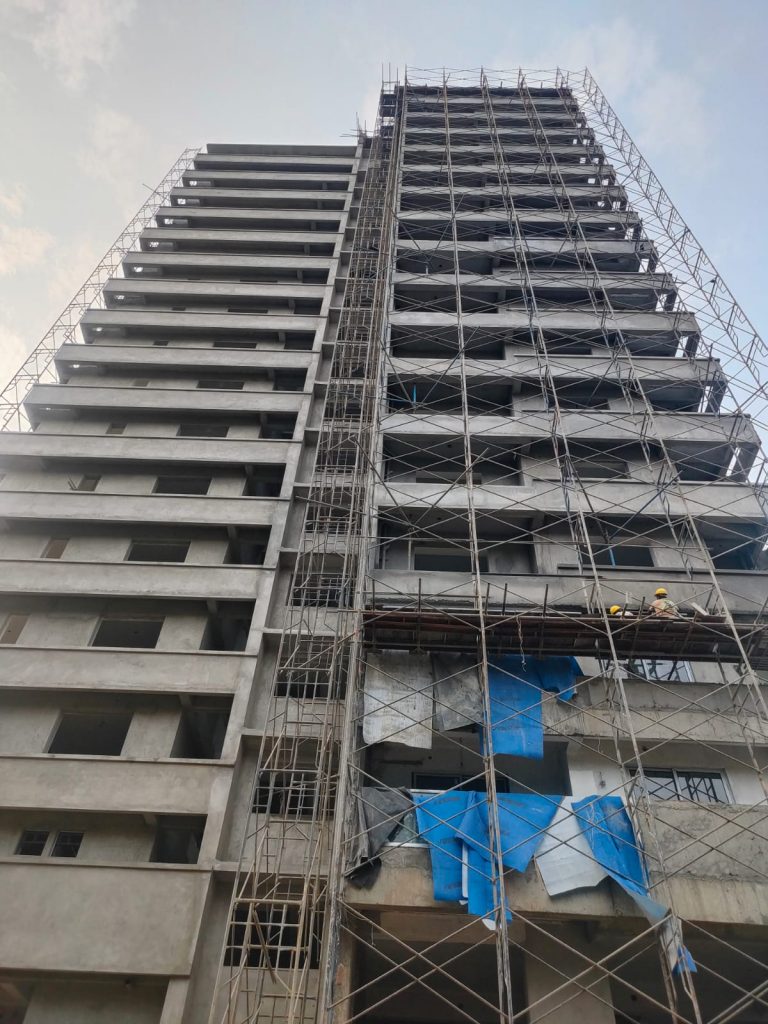

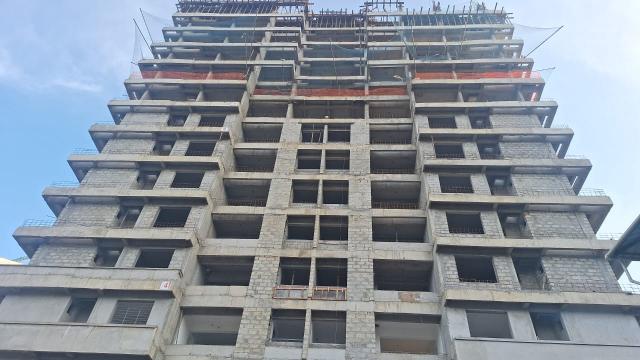

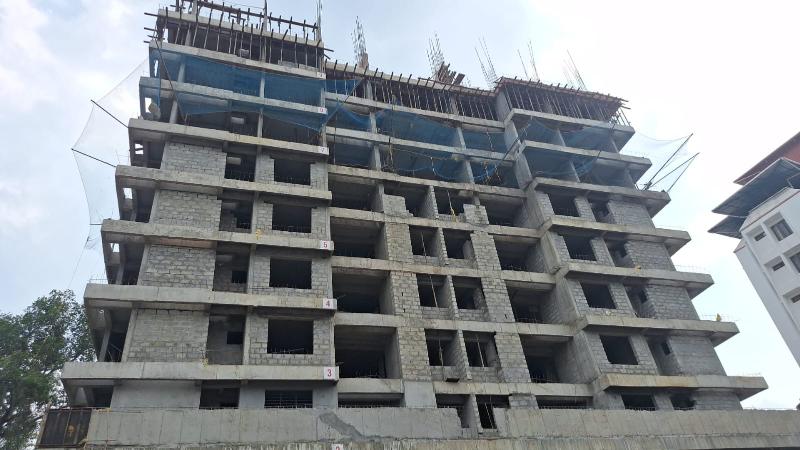

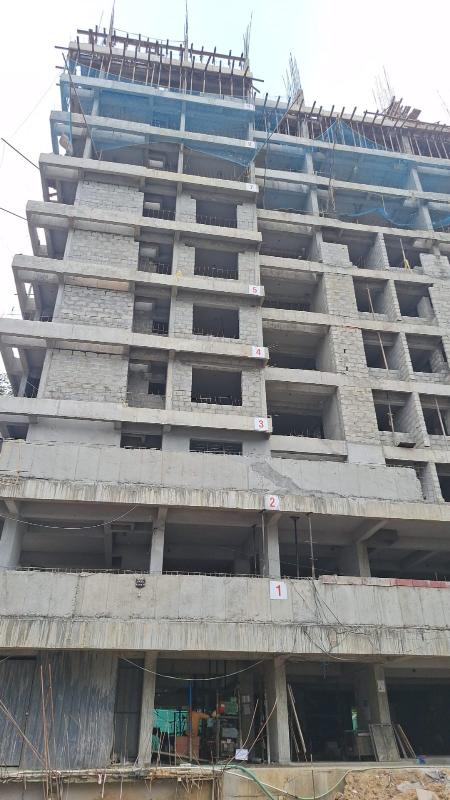

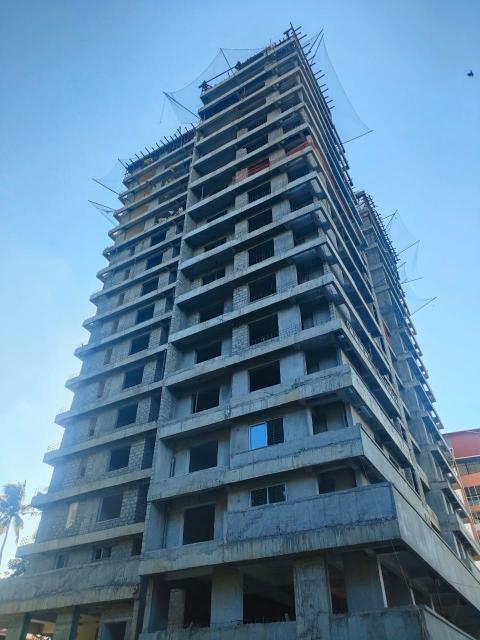

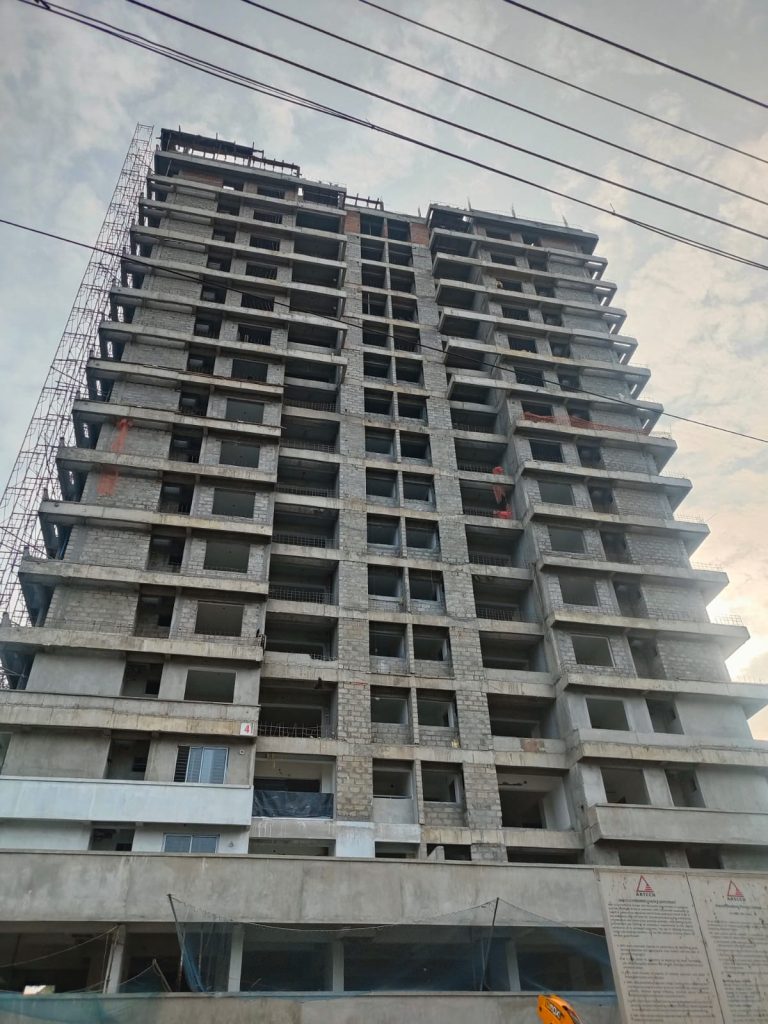

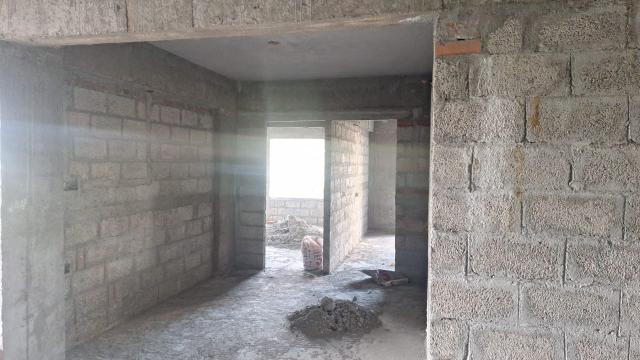

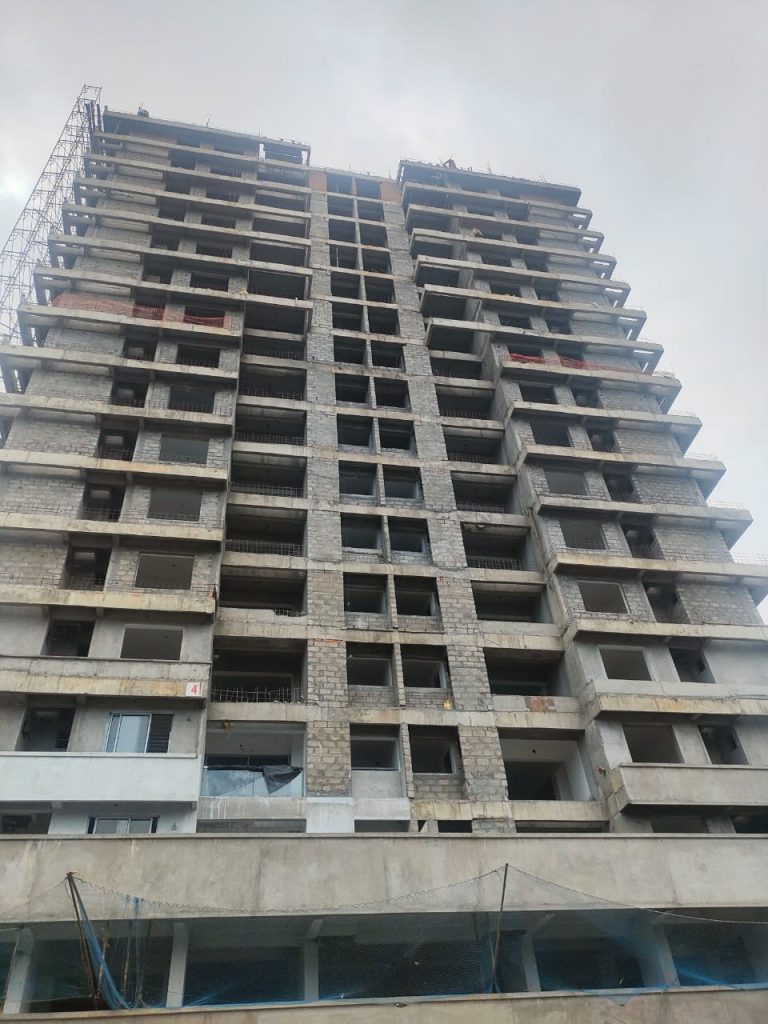

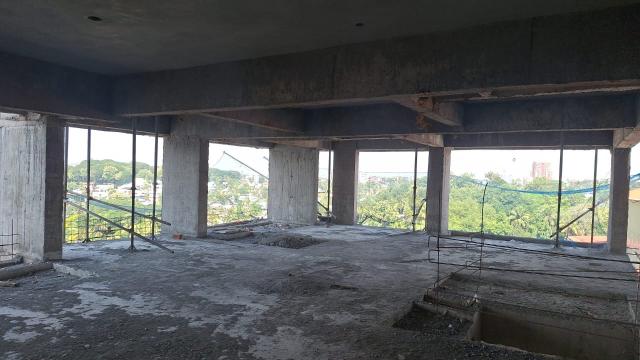

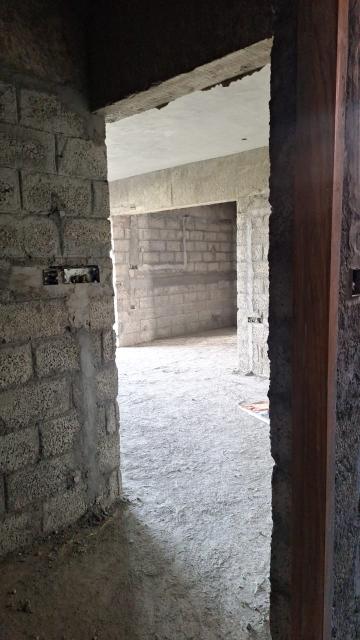

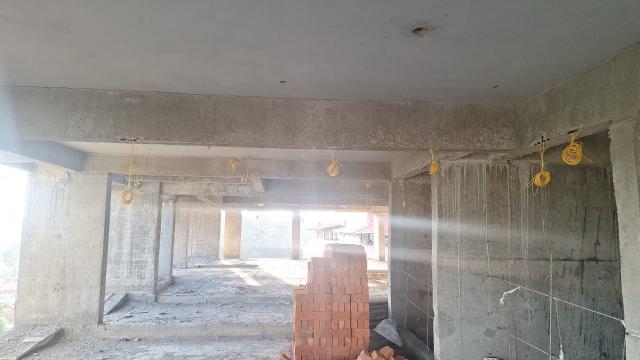

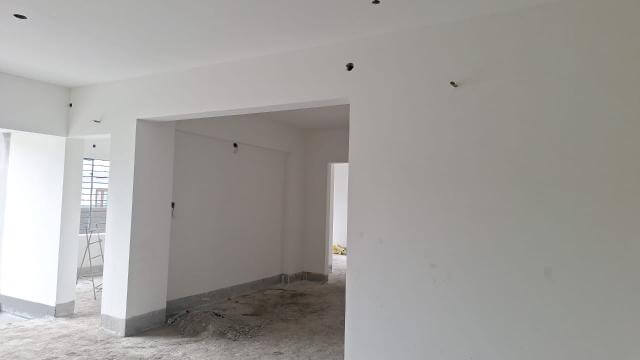

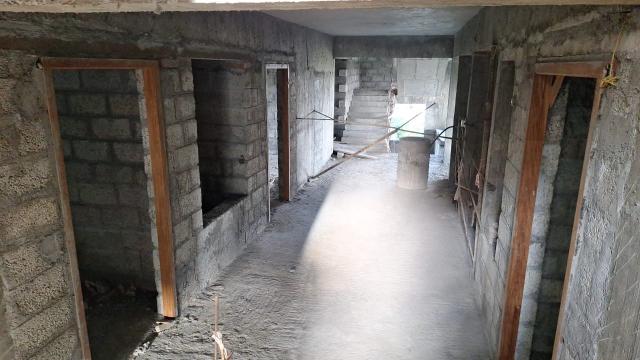

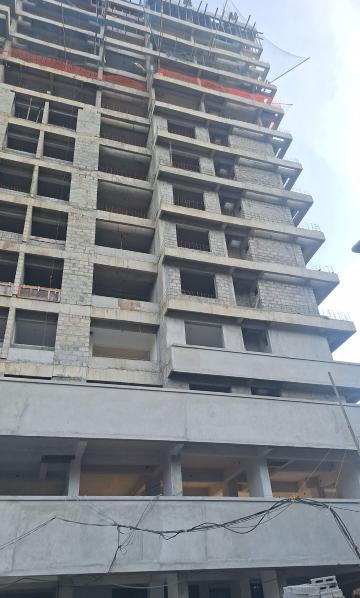

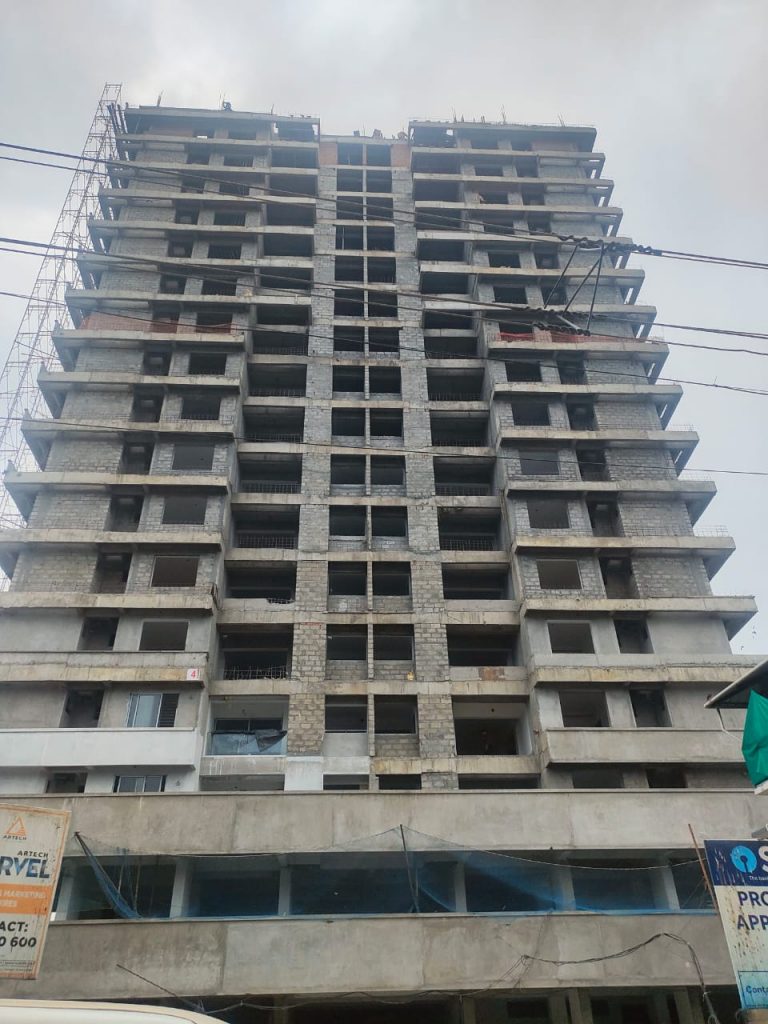

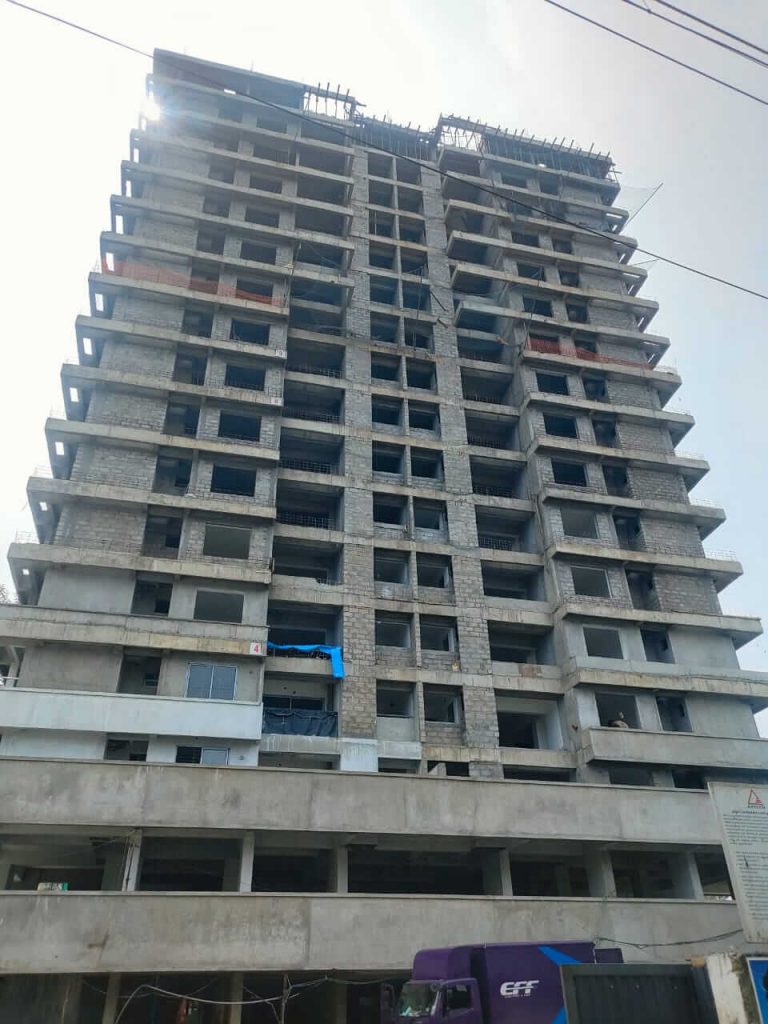

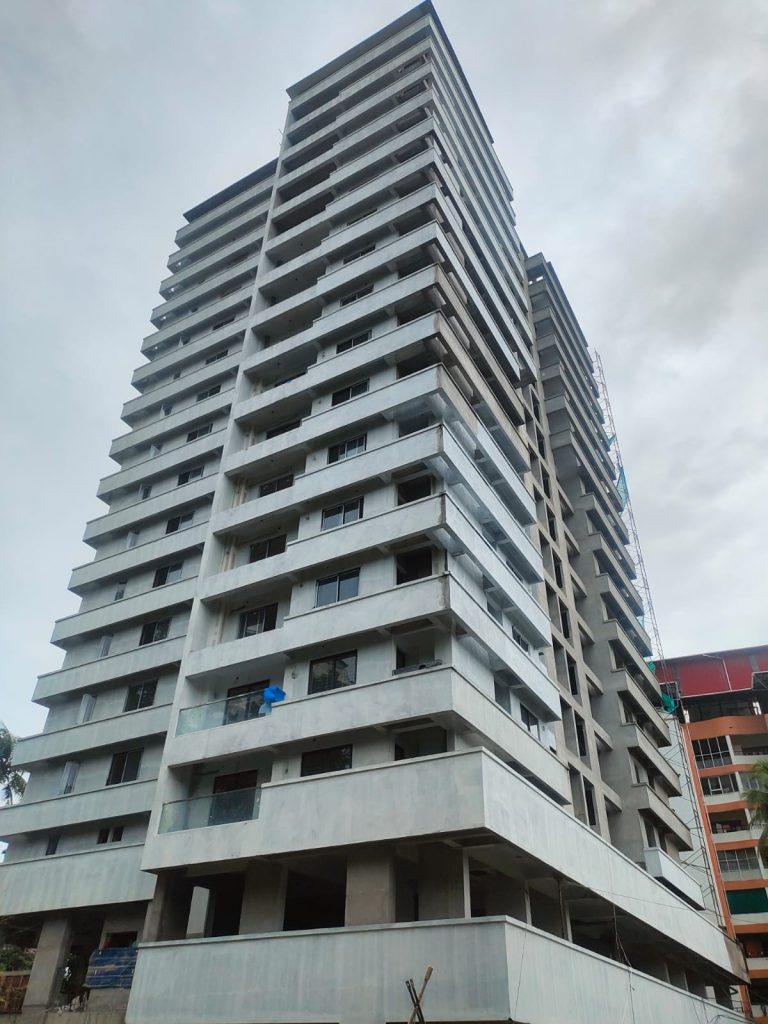

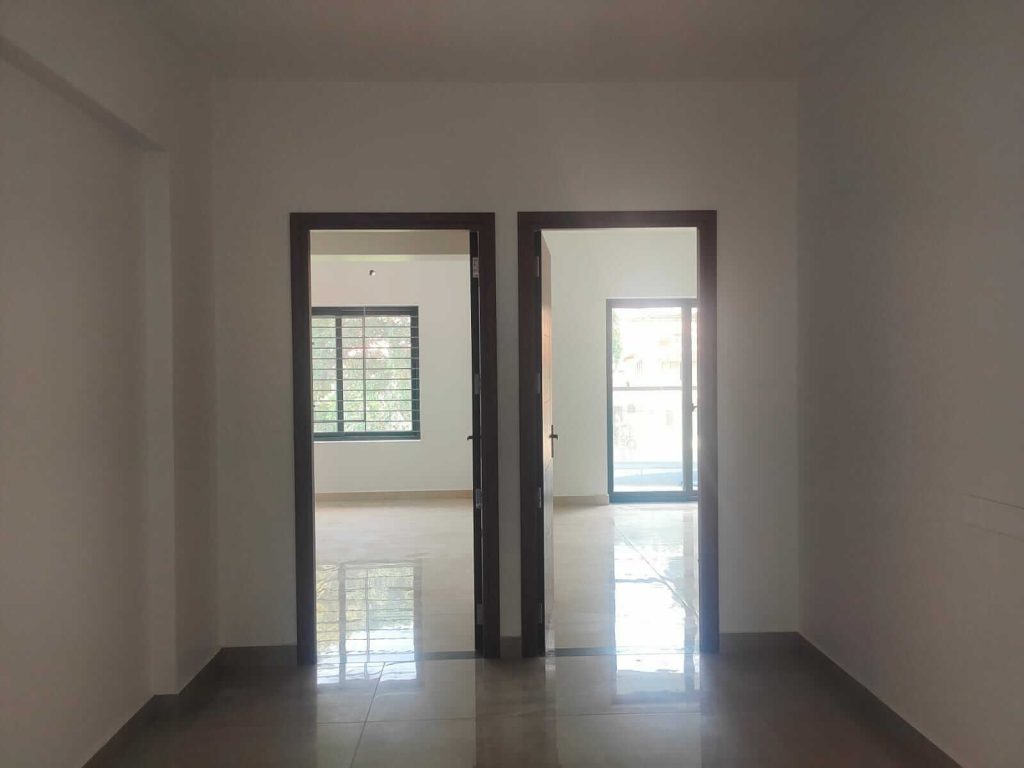

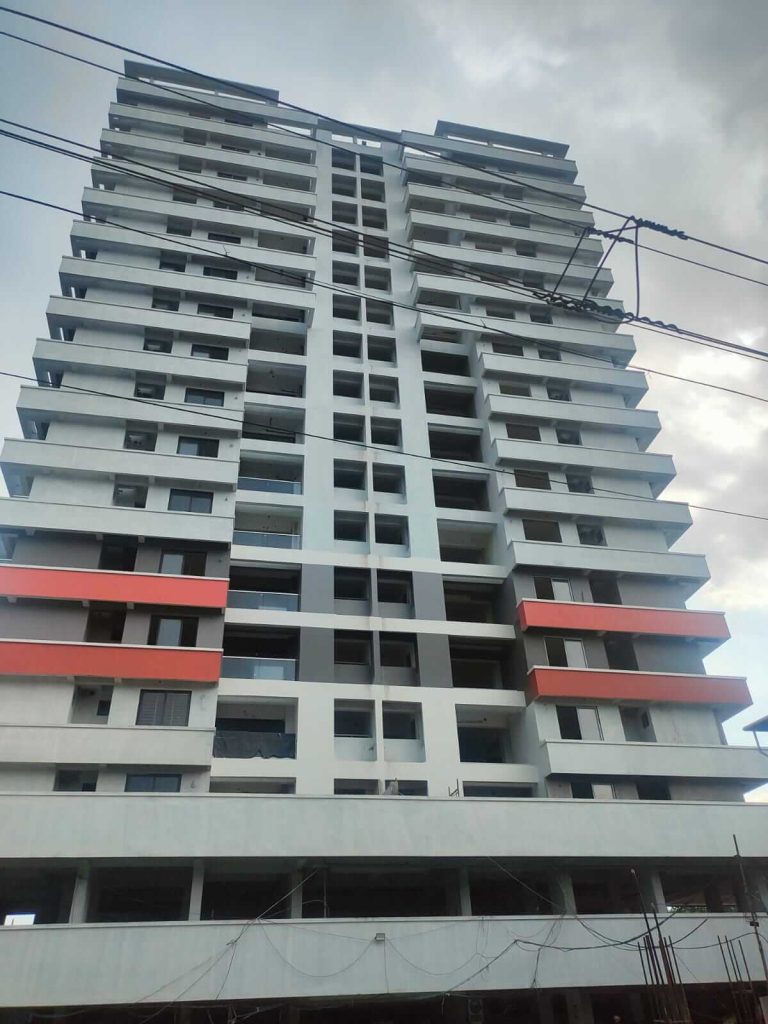

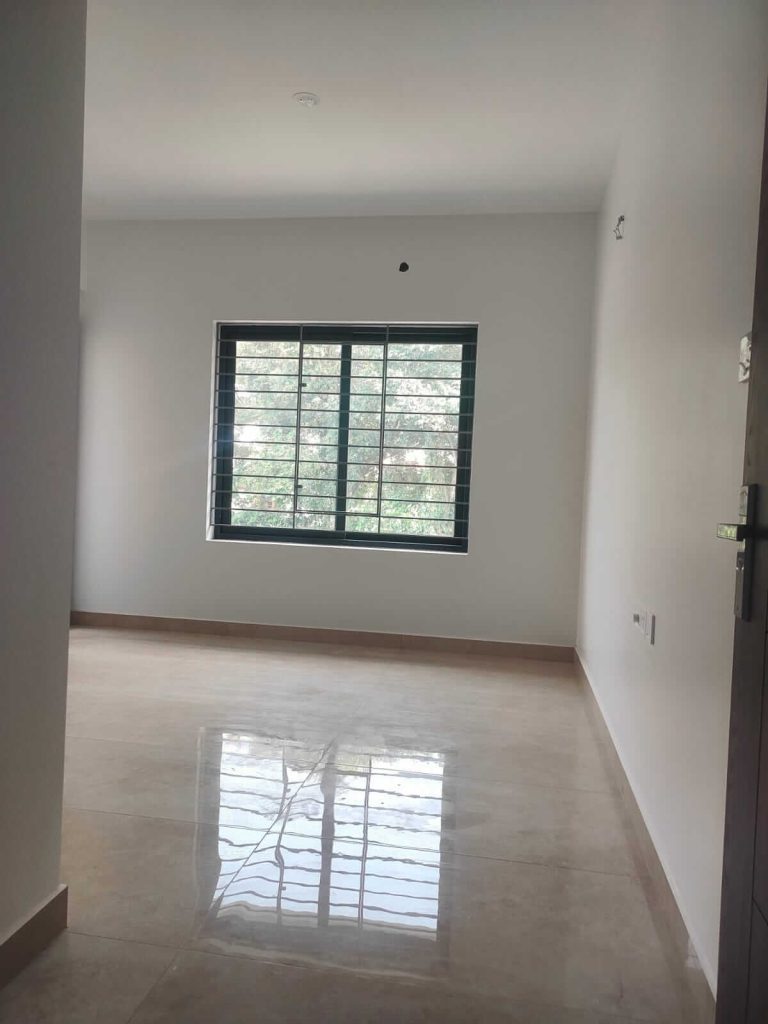

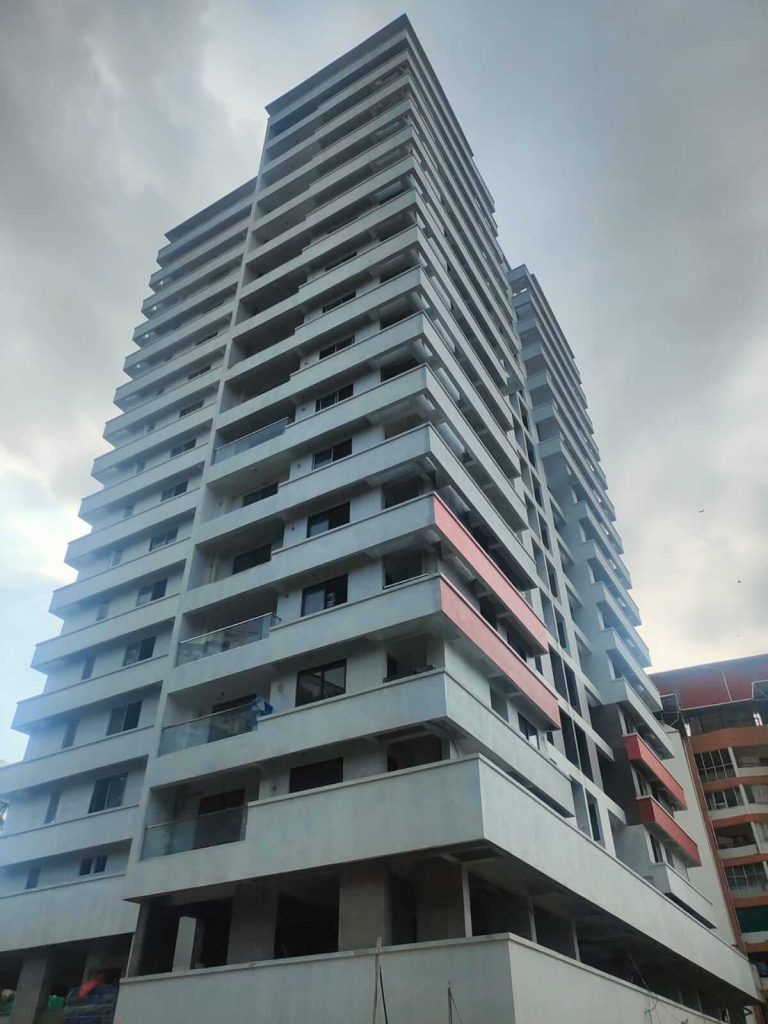

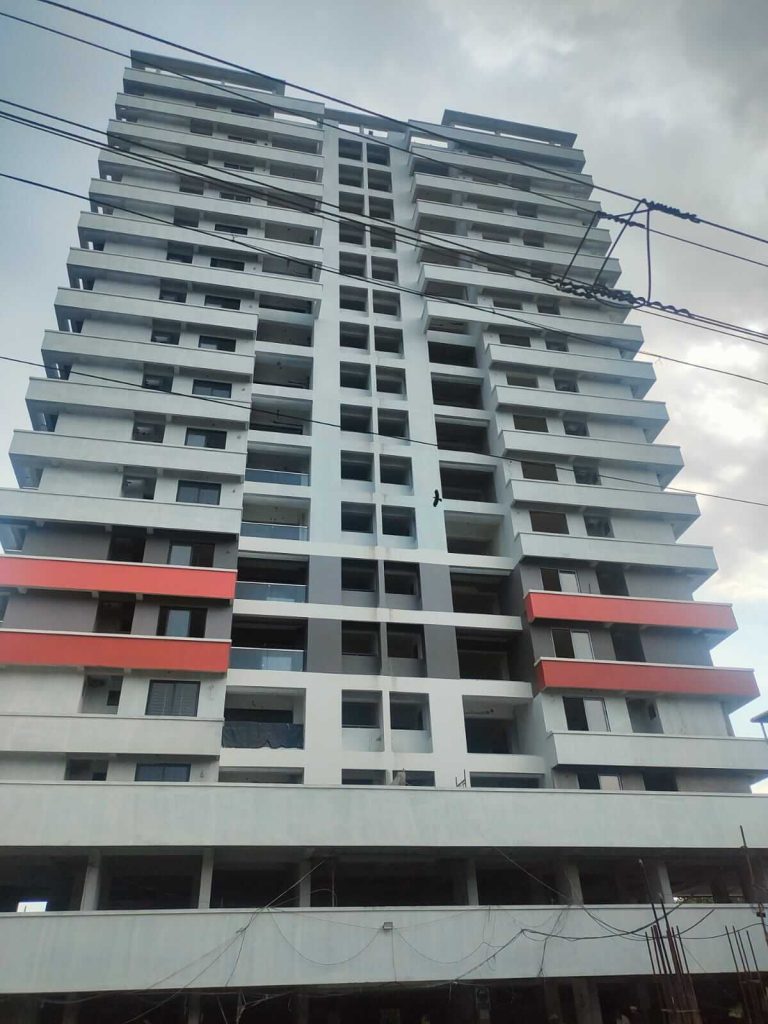

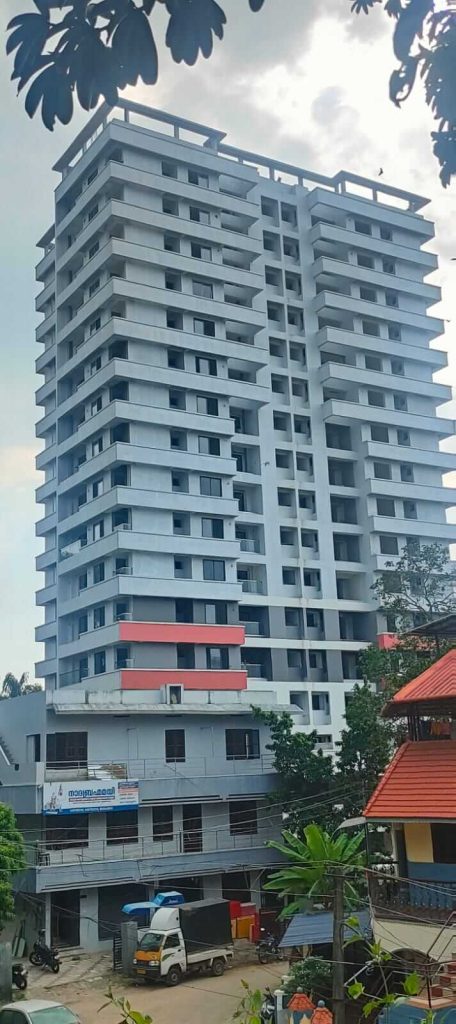

Work status as of 09-06-2026, we have completed the following

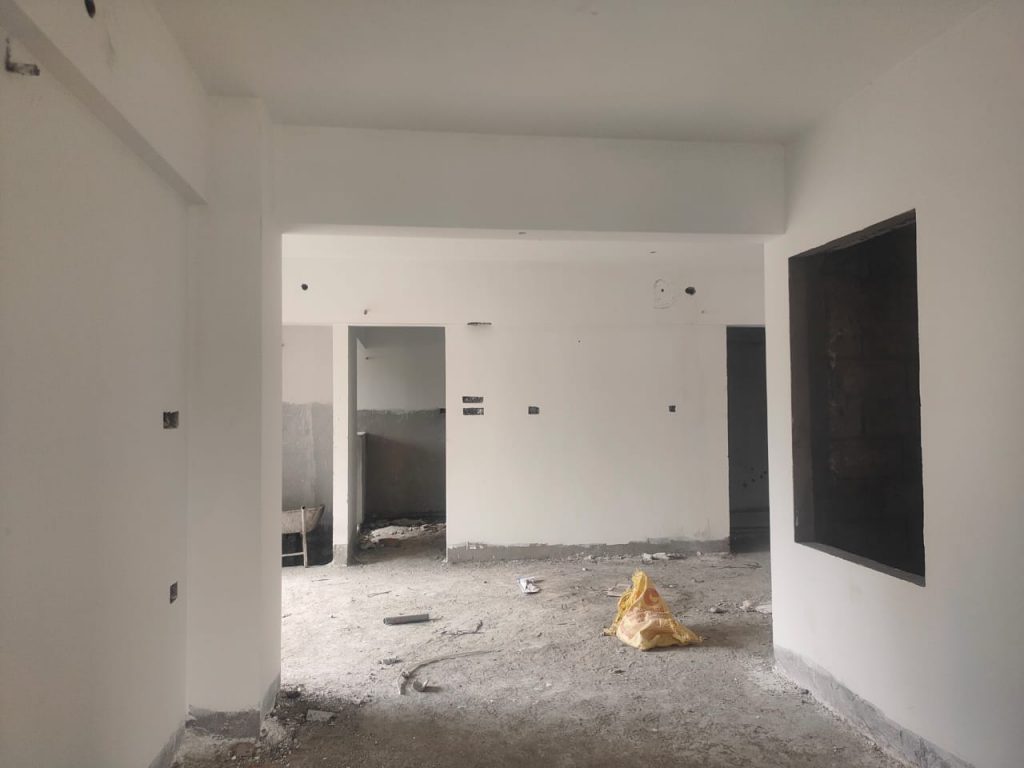

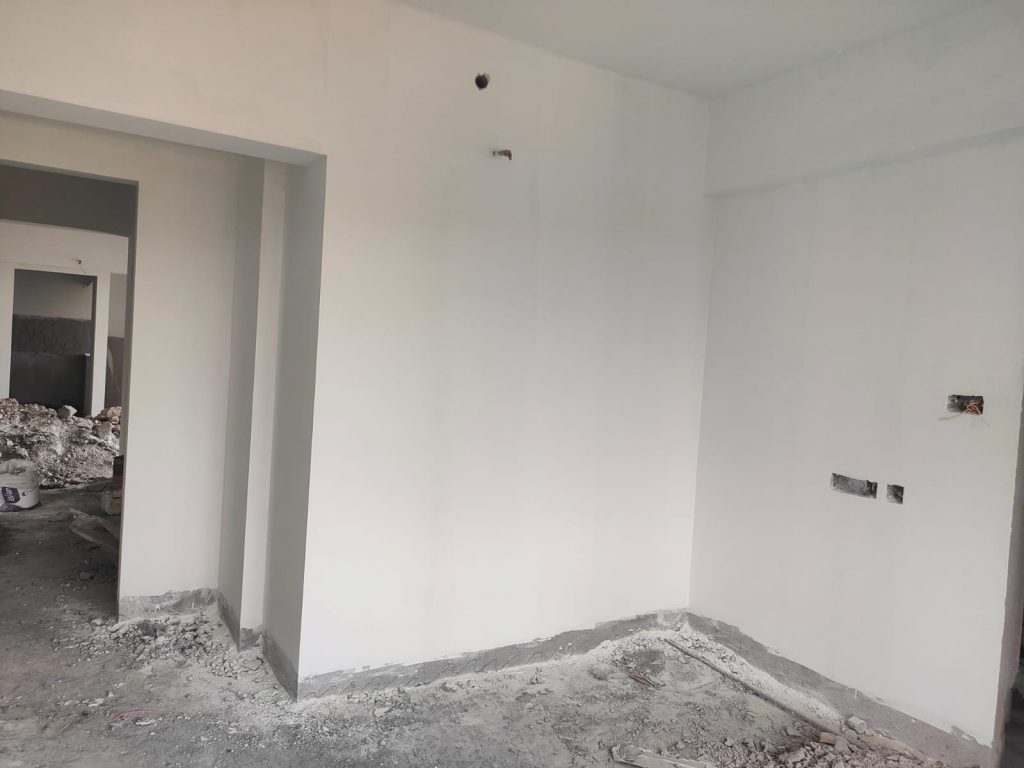

- INSIDE PLASTERING WORKS : Inside wall Plastering work -13th Floor – 90 % completed,14th Floor – 40 % Completed, 15th F to 16th Floor – 20 % Completed.

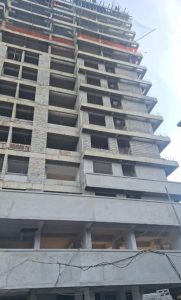

- Ceiling plastering: Basement Floor – 35 % Completed, Ground to 16th Floor – 100% completed.
- External plastering work : East side – 100 % completed, South side – 70 % completed, North side – 85 % completed
- Electrical works : Electrical Rope pulling -Basement to 16th Floor – 100 % Completed; Electrical work – Wall chasing & Box fixing-Ground to 13th Floor – 100 % Completed, 14th Floor – 80 % completed; 15th Floor to 16th Floor – 100 % completed. Electrical Wire pulling work – 2nd floor – 75 % Completed,3rd Floor – 50 % Completed, 4th Floor to 5th Floor – 25 % Completed.

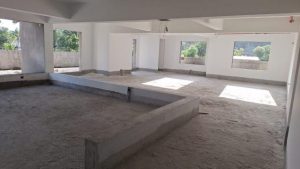

- Fire Fighting Works : 2nd Floor – 75 % Completed & , 3rd Floor to 9th Floor – 90 % Completed, 10th Floor – 80 % Completed; 11th Floor – 40 % completed

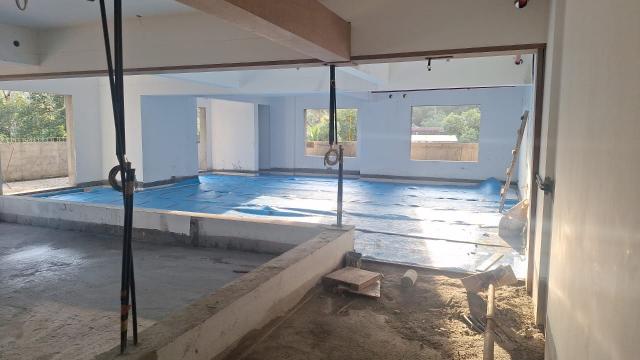

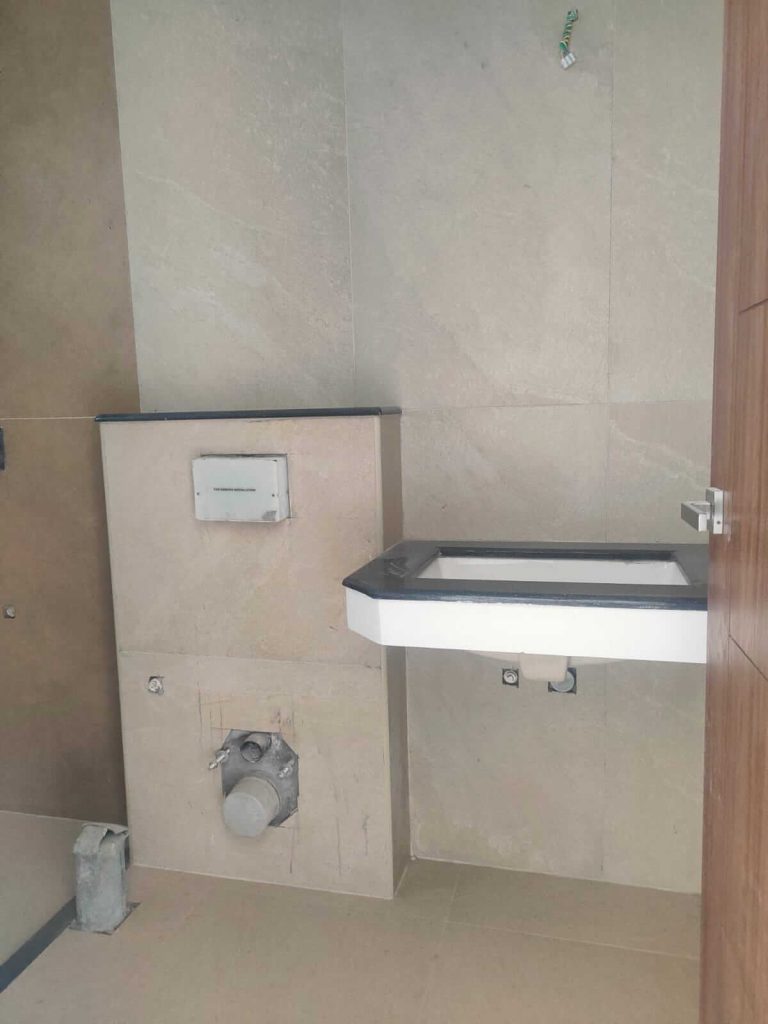

- Plumbing Works (Concealed works) : Mockup & sample & Amenities area concealed works completed ; 3rd to 8th Floor – 100 % Completed, 9th Floor – 40 % Completed, 10th Floor – 100 % Completed, 11th Floor – 80 % Completed, 12th Floor – Started.

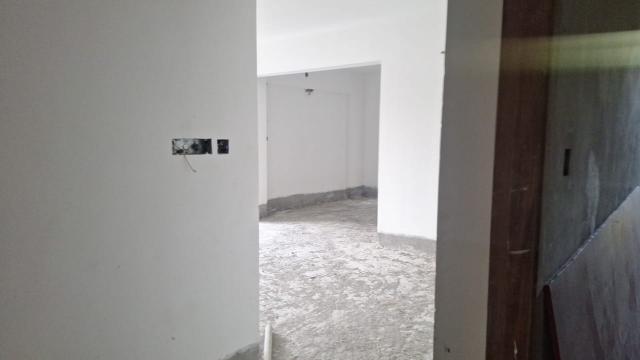

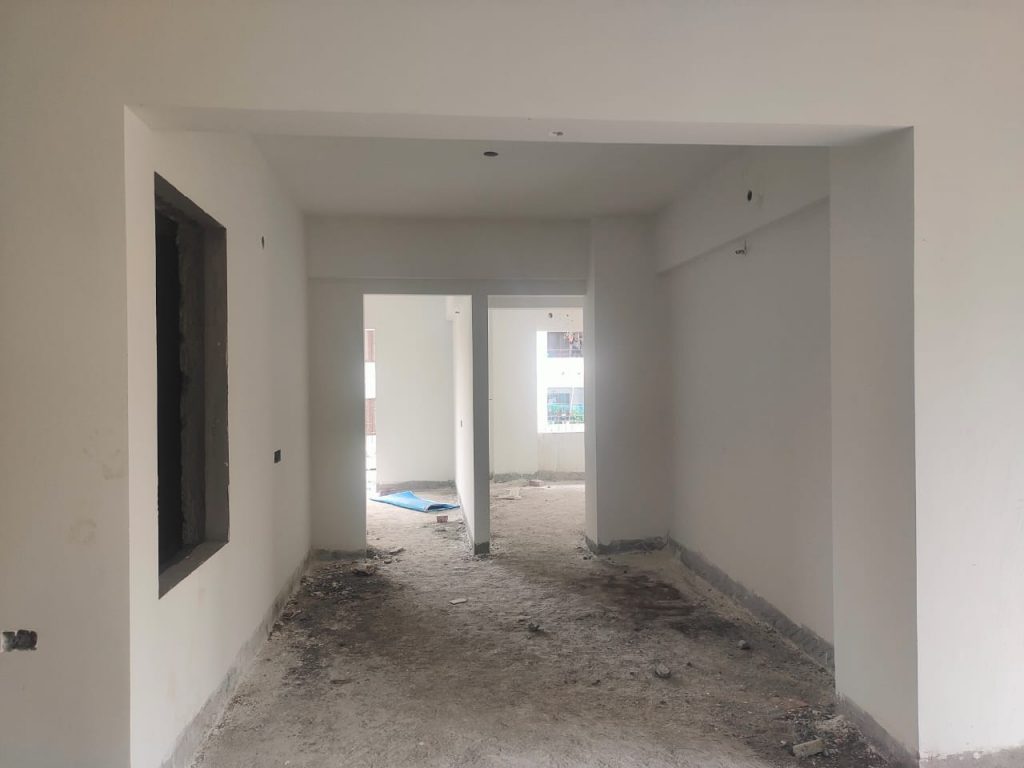

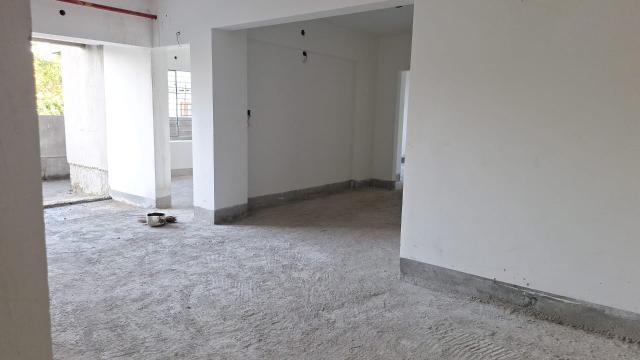

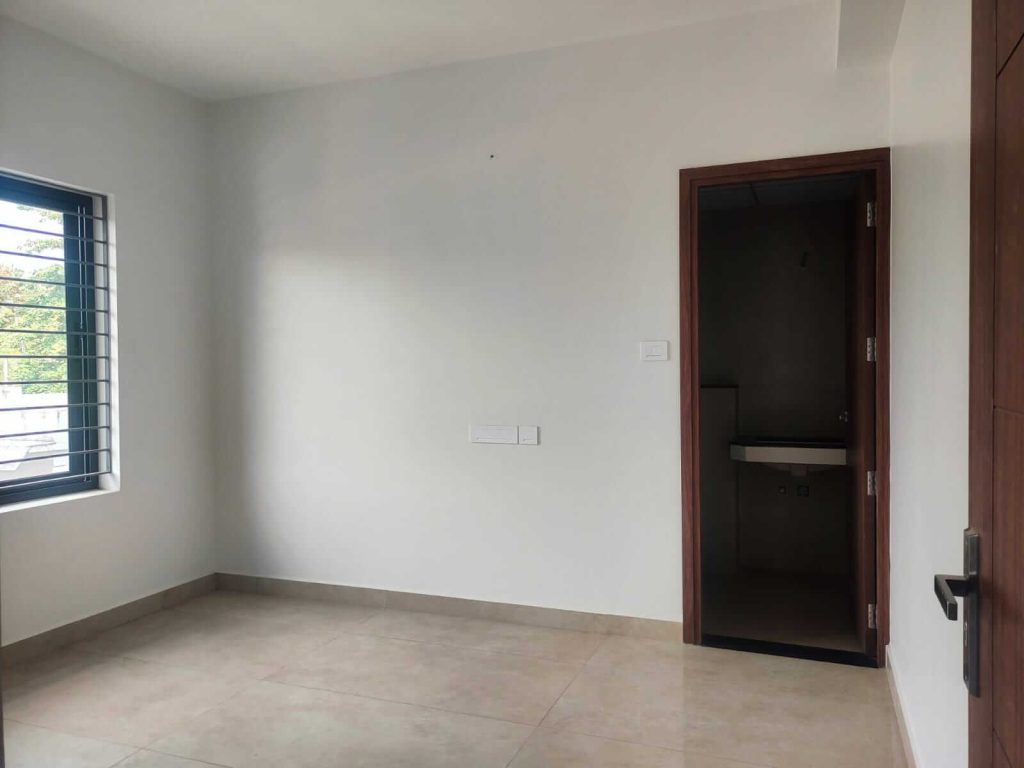

- Internal Finishes : Painting -Primer -Ground Floor – 50 % Completed,1st Floor – 80 % Completed, 2nd Floor – 75 % Completed, 3rd Floor to 10th Floor – 100 % Completed,11th Floor – 100 % Completed; Putty work – 2nd Floor – 75 % completed, 3rd Floor to 10th Floor – 90 % completed, 11th floor – 50 % completed

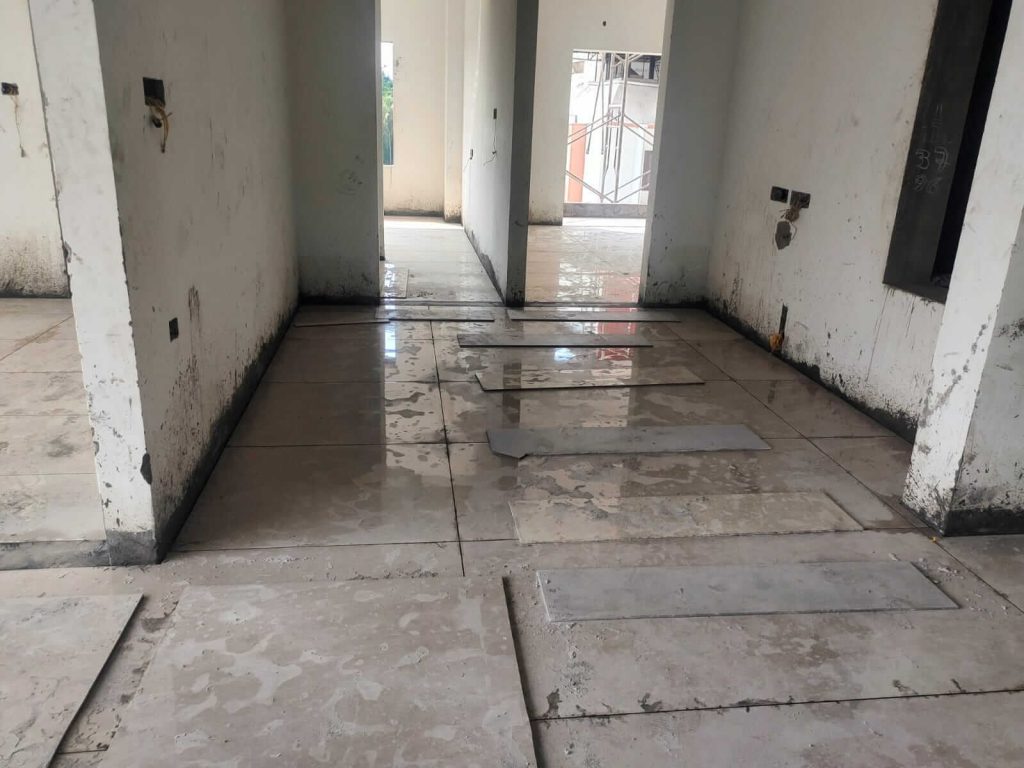

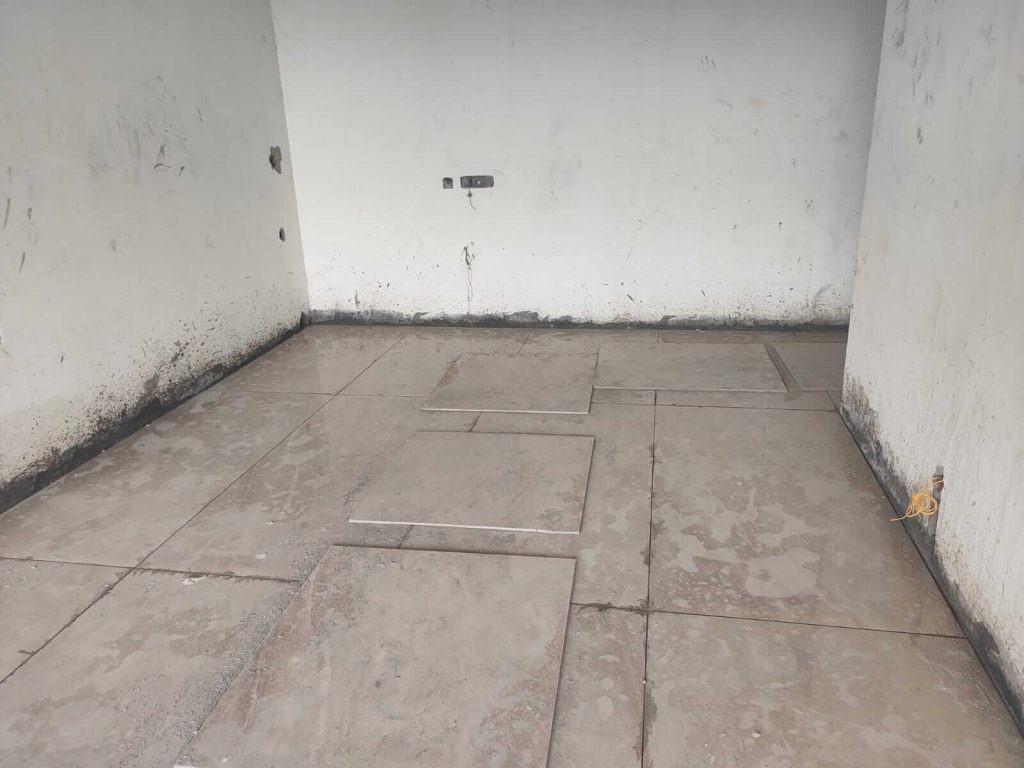

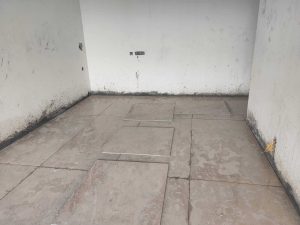

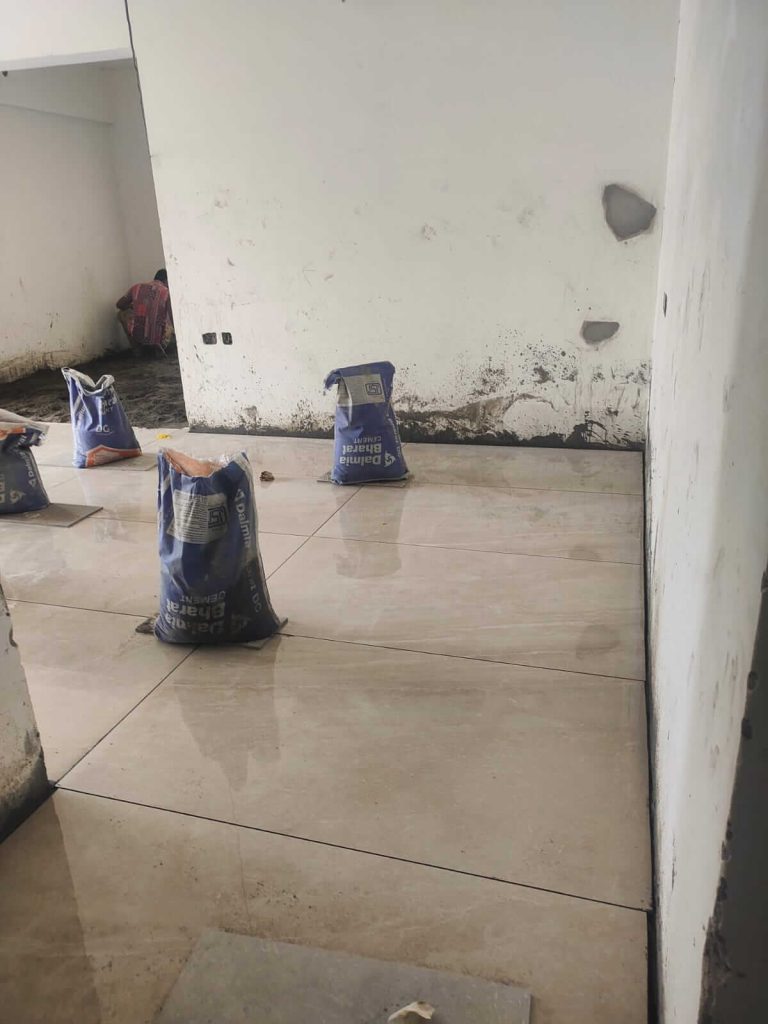

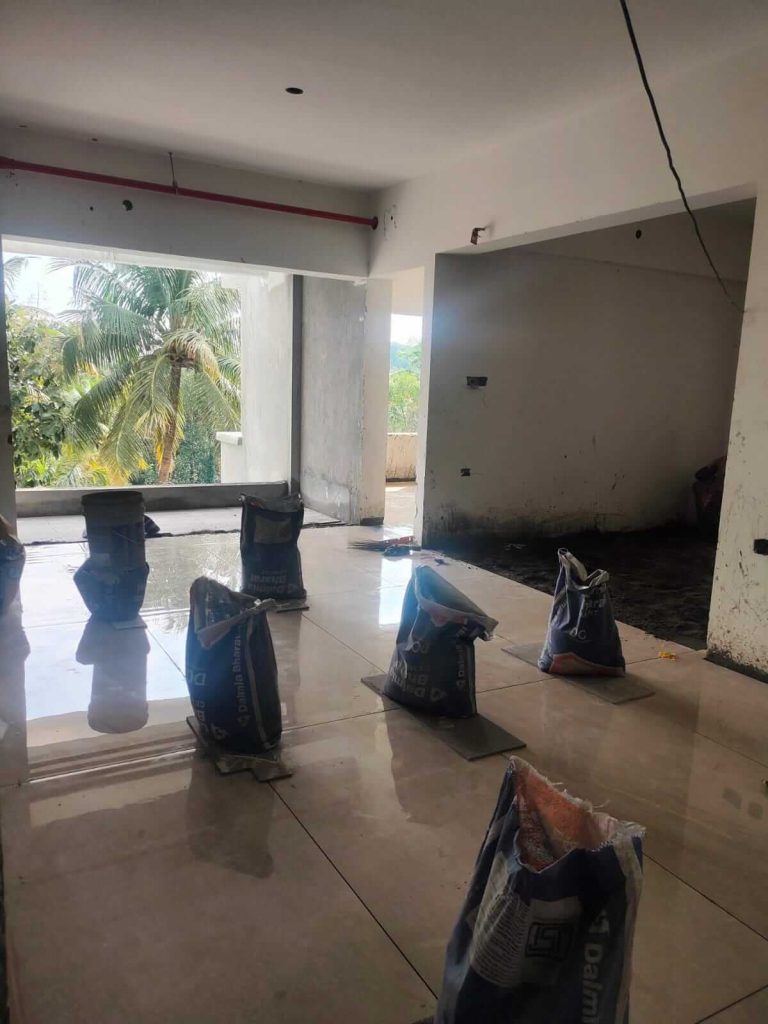

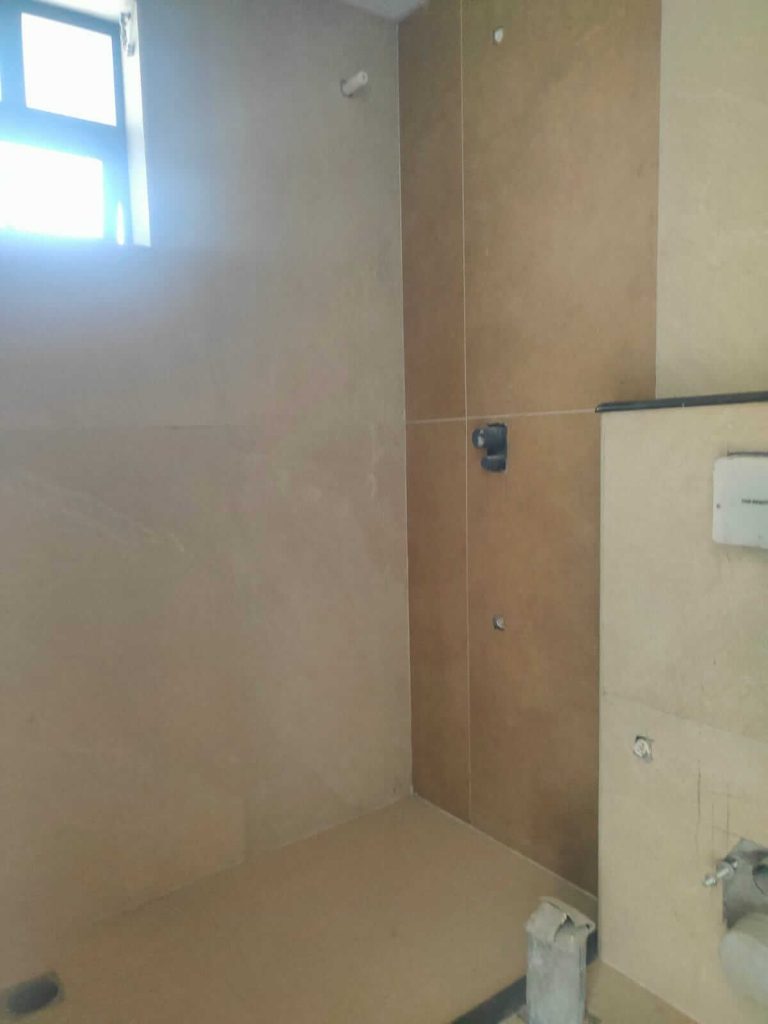

- Tiling work : Sample & Mockup Flat & Amenities Area – 95 % completed, 3rd floor to 5th Floor – 60 % completed; 6th Floor – 55 % completed, 7th Floor to 8th Floor – 50 % complete
- Waterproofing work : 2nd Floor – 70 % completed ; 3rd Floor to 4th floor – 100 % completed ; 5th Floor to 11th Floor – 80 % completed,12th floor to 13th Floor – 65 % completed
- Aluminum doors & windows – 2nd Floor – 60 % Completed, 3rd Floor – 35 % Completed, 4th Floor to 10th Floor – 10 % Completed

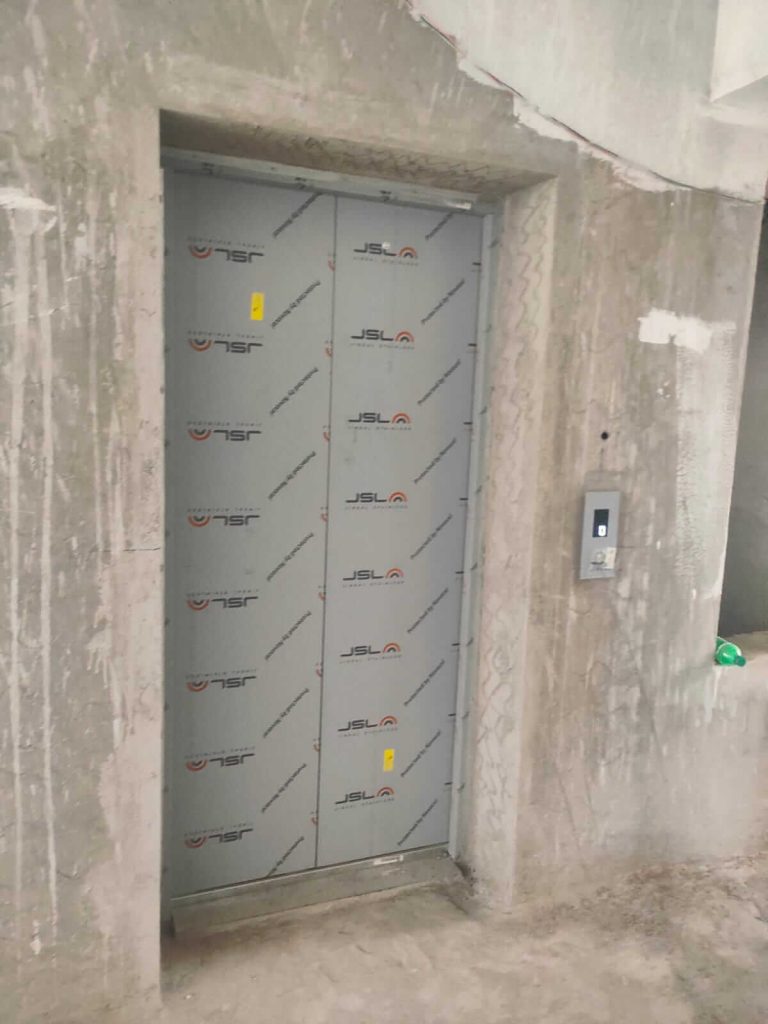

- Lift work Service Lift – 40 % completed
As per the current site work status, we are targeted to complete the following works by the end of June 2026.
- Electrical works: Electrical work – Wall chasing & Box fixing- 14th Floor – 100 % to be complete.Electrical Wire pulling – 4th Floor to 8th Floor – 50 % to be complete.
- Fire Fighting Works : 8 10th floor to 12th Floor – 90 % complete
- Plumbing Works (Concealed works) :Concealed works: 9th floor & 11th Floor to 13th Floor – 100 % to be complete
- Internal Finishes : Painting -Primer – 12th Floor to 14th floor – 100 % to be Complete ; Putty work – 11th to 13th Floor – 90 % to be complete
- Tiling work : 9th Floor to 11th Floor – 60 % to be complete
- Waterproofing work : 12th Floor to 14th Floor- 90% to be complete
- Aluminum doors & windows – 3rd Floor to 8th Floor – 50 % to be Complete
- Lift work Service Lift – Service Lift – 90 % to be complete
Work status as of 07-05-2026, we have completed the following.

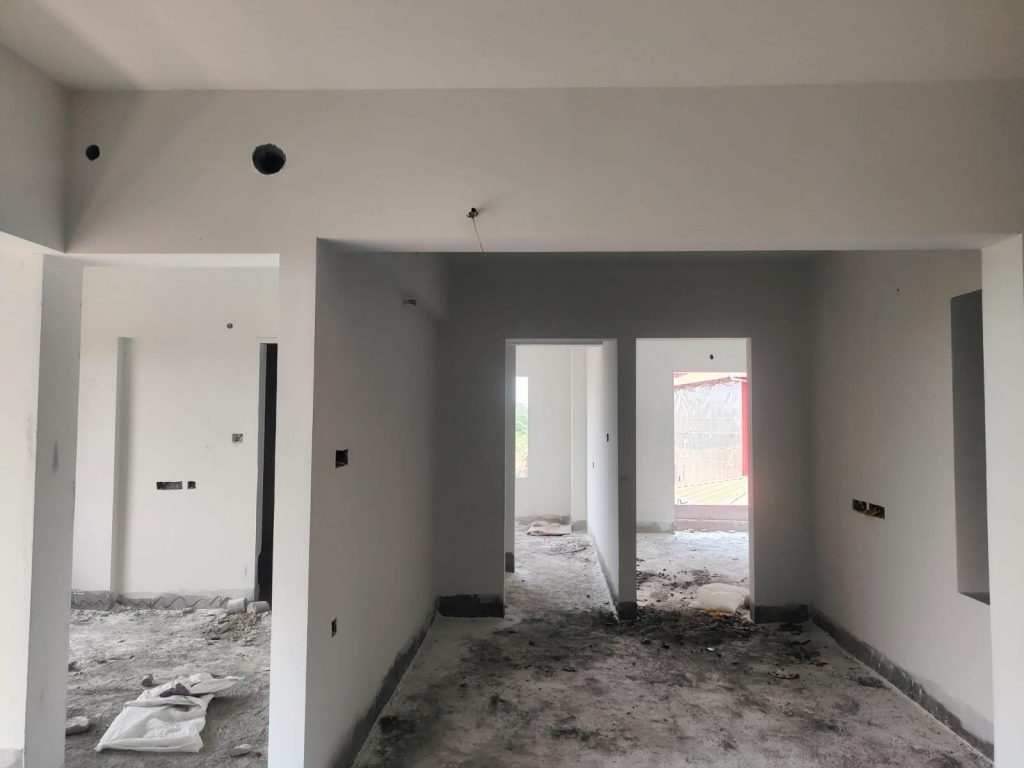

- INSIDE PLASTERING WORKS : Inside wall Plastering work -Ground to 12th Floor – 100% completed,13th Floor – 30 % completed.

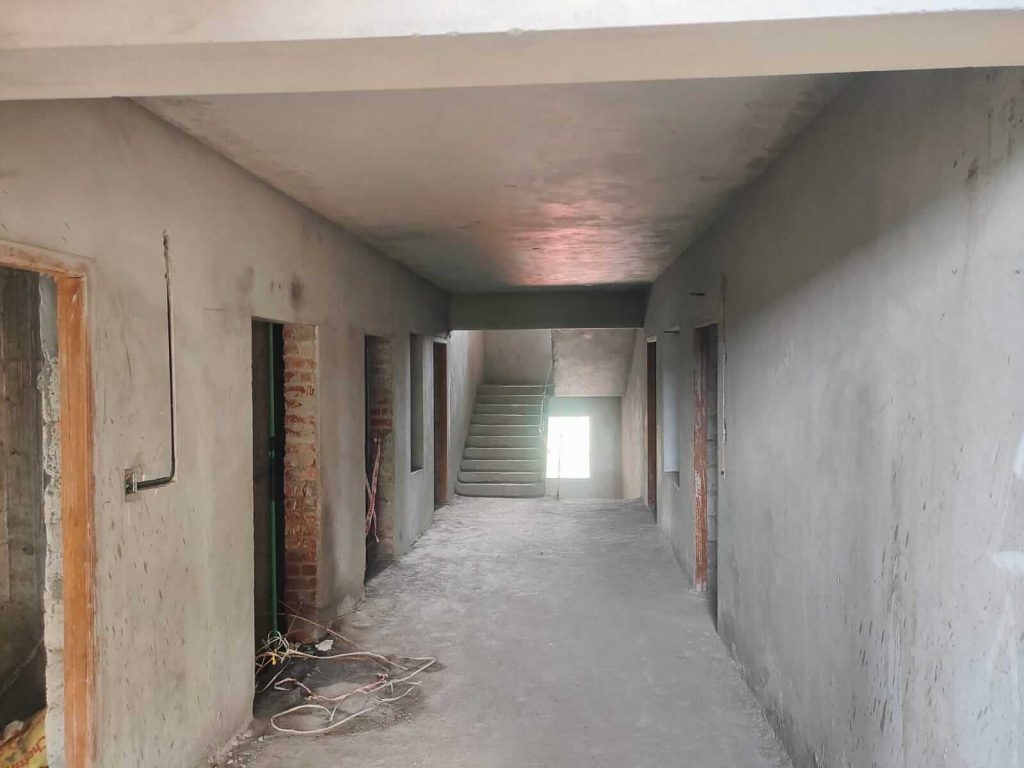

Ceiling plastering: Ground to 16th Floor – 100% completed.
- External plastering work : East side – 100 % completed, South side – 60 % completed, North side – 60 % completed
- Electrical works : Electrical Rope pulling -Basement to 16th Floor – 100 % Completed.
Electrical work – Wall chasing & Box fixing-Ground to 13th Floor – 100 % Completed, 14th Floor – 50 % completed; 15th Floor – 80 % completed; 16th Floor – 100 % completed.
- Fire Fighting Works : 2nd Floor – 75 % Completed & , 3rd Floor to 7th Floor – 80 % Completed, 8th Floor – 60 % Completed; 9th Floor to 10th Floor – 60 % completed
- Plumbing Works (Concealed works) : Mockup & sample & Amenities area concealed works completed ; 3rd to 8th Floor – 90 % Completed.
- Internal Finishes : Painting -Primer -Ground Floor – 50 % Completed,1st Floor – 80 % Completed, 2nd Floor – 75 % Completed, 3rd Floor to 10th Floor – 100 % Completed,11th Floor – 50 % Completed. Putty work – 2nd Floor – 75 % completed, 3rd Floor to 8th Floor – 90 % completed, 9th floor – 75 % completed; 10th floor – 90 % completed
- Tiling work : Sample & Mockup Flat & Amenities Area – 95 % completed, 3rd floor – 60 % completed, 4th & 5th Floor – 50 % completed; 6th Floor – 20 % completed, 7th Floor to 8th Floor – 10 % complete
- Waterproofing work : 2nd Floor – 70 % completed ; 3rd Floor to 4th floor – 100 % completed ; 5th Floor to 8th Floor – 90 % completed,9th floor to 12th Floor – 40 % completed
As per the current site work status, we are targeted to complete the following works by the end of May 2026.
- INSIDE PLASTERING WORKS : Inside wall Plastering work – 13th Floor & 14th Floor & 15th Floor – 100 % to be complete.
- External plastering work : North side – 100 % to be complete
- Electrical works : Electrical work – Wall chasing & Box fixing- 14th Floor to 15th Floor – 100 % to be complete. Electrical Wire pulling – Starting
- Fire Fighting Works : 8th floor to 10th Floor – 90 % complete
- Plumbing Works (Concealed works) : Concealed works: 9th floor to 12th Floor – 90 % to be complete
- Internal Finishes : Painting -Primer – 9th Floor to 13th floor – 100 % to be Complete. Putty work – 9th & 11th & 12th Floor – 90 % to be complete
- Tiling work : Mockup , Sample, Amenities Area – 100 % to be completed ; 6th Floor to 8th Floor – 40 % to be complete
- Waterproofing work : 9th Floor to 13th Floor- 90% to be complete
Work status as on 11-04-2026, we have completed the following.
- External plastering work – East side – 100 % completed, South side – 60 % completed, North side – 60 % completed
- Electrical works- East side – Wall chasing & Box fixing-Ground to 12th Floor – 100 % Completed, 13th Floor – 75 % completed; 14th Floor – 50 % completed; 15th Floor – 50 % completed; 16th Floor – 50 % completed.
- Fire Fighting Works – 2nd Floor – 75 % Completed & , 3rd Floor to 7th Floor – 80 % Completed, 8th Floor – 60 % Completed; 9th Floor to 10th Floor – 40 % completed
- Plumbing Works (Concealed works) – Mockup & sample & Amenities area concealed works completed ; 3rd to 6th Floor – 90 % Completed, 7th Floor – 50 % Completed; 8th Floor – 50 % completed
- Internal Finishes – Painting -Primer – Ground Floor – 50 % Completed,1st Floor – 80 % Completed, 2nd Floor – 75 % Completed, 3rd Floor to 8th Floor – 100 % Completed, 9th Floor – 75 % completed,10th Floor – 100 % Completed
- Putty work – 2nd Floor – 75 % completed, 3rd Floor to 8th Floor – 90 % completed, 9th floor – 75 % completed; 10th floor – 90 % completed
- Tiling work- Sample & Mockup Flat & Amenities Area – 95 % completed, 3rd floor – 60 % completed, 4th & 5th Floor – 50 % completed; 6th Floor – 20 % completed
- Waterproofing work- 2nd Floor – 70 % completed ; 3rd Floor to 4th floor – 100 % completed ; 5th Floor to 8th Floor – 90 % completed,9th floor to 11th Floor – 40 % completed
As per the current site work status, we are targeted to complete the following works by the end of April 2026.

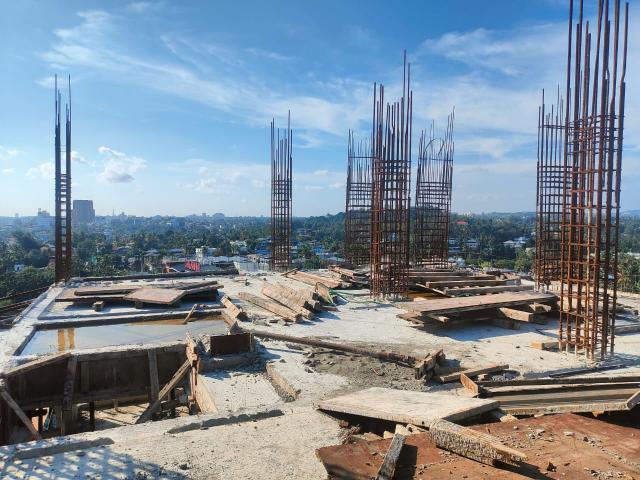

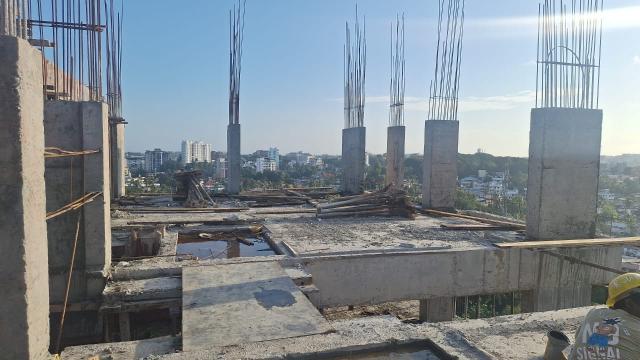

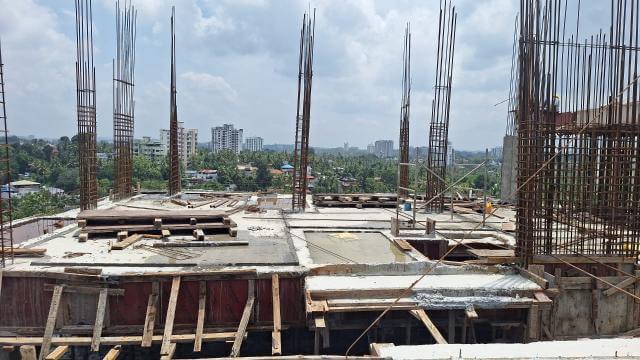

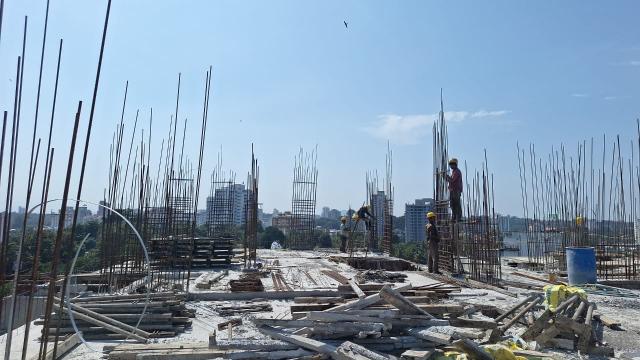

- CIVIL WORKS – Boundary wall works -10 % work to be Complete ; Slabs & Beam – Water tank work to be complete
- INSIDE PLASTERING WORKS – 13th Floor & 14th Floor & 15th Floor – 100 % to be complete.
- Electrical Works – Wall chasing & Box fixing- 13th Floor to 16th Floor – 100 % to be complete.
- Fire Fighting Works – 8th floor to 10th Floor – 90 % complete
- Plumbing Works (Concealed works) – Concealed works: 7th floor to 12th Floor – 90 % to be complete

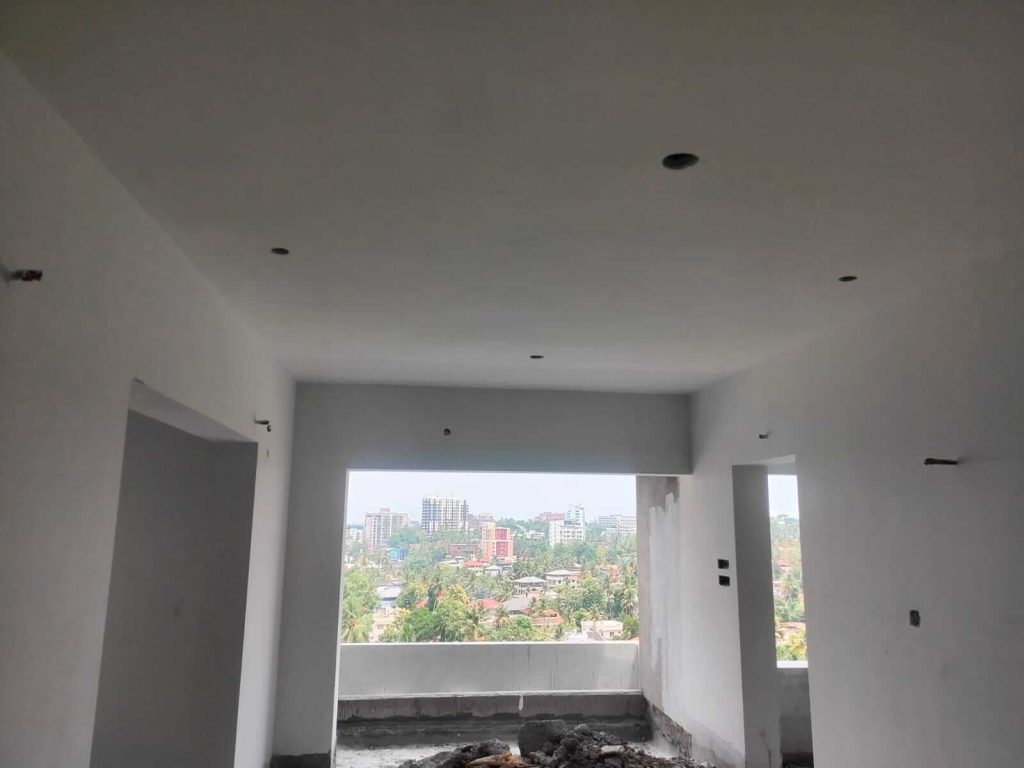

- Internal Finishes – Painting -Primer – 9th Floor to 12th floor – 100 % to be Complete

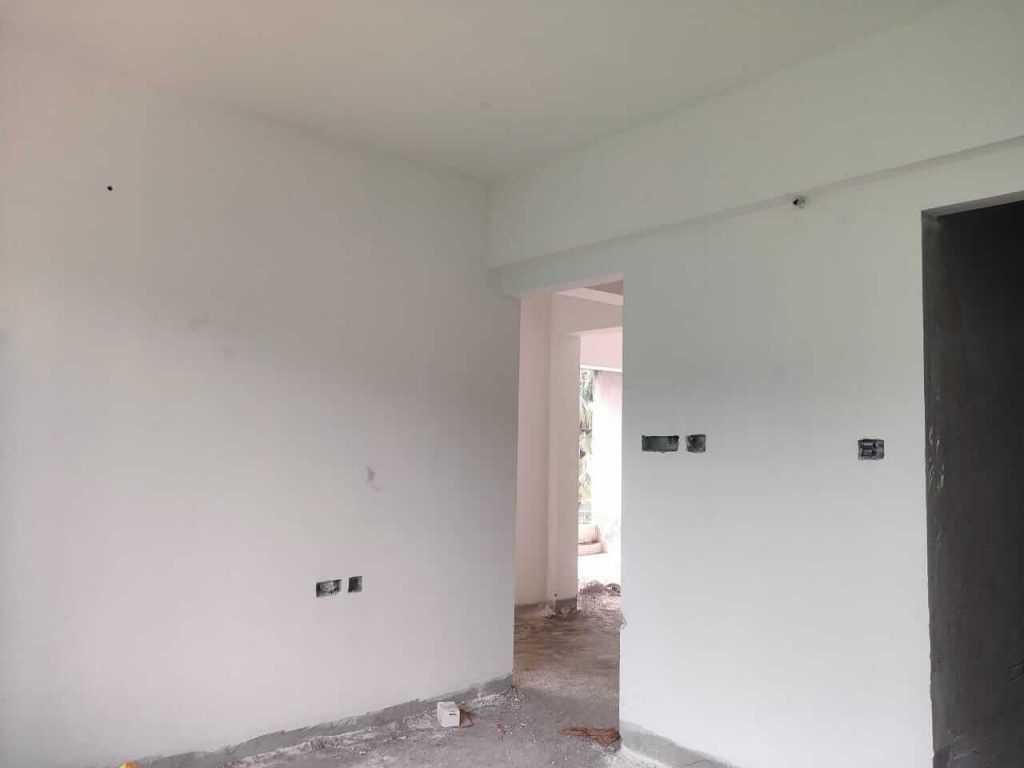

- Putty work – 9th & 11th & 12th Floor – 90 % to be complete
- Tiling work- Mockup , Sample, Amenities Area – 100 % to be completed ; 6th Floor to 7th Floor – 40 % to be complete
- Waterproofing work – 9th Floor to 13th Floor- 90% to be complete
Work status as on 07-03-2026, we have completed the following.
- INSIDE PLASTERING WORKS – nside wall Plastering work -Ground to 8th Floor – 100% completed, 9th Floor – 90 % Completed, 10th Floor – 100 % completed ; 11th Floor – 90 % completed,12th Floor – 75 % completed. Ceiling plastering: Ground to 16th Floor – 100% completed.
- External plastering work – East side – 100 % completed, South side – 60 % completed, North side – 20 % completed
- Electrical works – Electrical Rope pulling -Basement to 16th Floor – 100 % Completed; Electrical work – Wall chasing & Box fixing-Ground to 12th Floor – 100 % Completed, 13th Floor – 75 % completed
- Fire Fighting Works – 2nd Floor – 75 % Completed & , 3rd Floor to 7th Floor – 80 % Completed, 8th Floor – 60 % Completed
- Plumbing Works (Concealed works) – Mockup & sample & Amenities area concealed works completed ; 3rd to 6th Floor – 90 % Completed, 7th Floor – 50 % Completed
- Internal Finishes – Painting -Primer -Ground Floor – 50 % Completed,1st Floor – 80 % Completed, 2nd Floor – 75 % Completed, 3rd Floor to 8th Floor – 100 % Completed, 9th Floor – 75 % completed,10th Floor – 100 % Completed; Putty work – 2nd Floor – 75 % completed, 3rd Floor to 8th Floor – 90 % completed, 9th floor & 10th floor – 60 % completed
- Tiling work- Sample & Mockup Flat & Amenities Area – 95% completed; 3rd floor – 60% completed; 4th & 5th Floor – 40 % completed
- Waterproofing work- 2nd Floor – 70 % completed ; 3rd Floor to 4th floor – 100 % completed ; 5th Floor to 7th Floor – 90 % completed,8th Floor – 50 % completed,9th floor – 40 % completed
- Aluminum doors & windows – Sample & Mockup Flat- 100 % completed
As per the current site work status, we are targeted to complete the following works by the end of March 2026.
- CIVIL WORKS – Boundary wall works -10 % work to be Complete ; Columns & Shear wall – Terrace Floor parapet sunshade work to be complete ; Slabs & Beam – LMR roof slab & Water tank work to be complete
- INSIDE PLASTERING WORKS – Inside wall Plastering work – 9th Floor & 11th Floor & 12th Floor & 13th Floor – 100 % to be completed.
- External plastering works – North side – 100 % to be complete
- Electrical Works – Electrical work – Wall chasing & Box fixing- 13th Floor to 14th Floor – 100 % to be complete.
- Fire Fighting Works – 8th floor to 10th Floor – 80 % complete
- Plumbing Works (Concealed works) – Concealed works: 6th floor to 8th Floor – 90 % to be complete
- Internal Finishes – Painting -Primer – 9th Floor to 12th floor – 100 % to be Complete ; Putty work – 9th & 11th & 12th Floor – 90 % to be complete
- Tiling work- Mockup , Sample, Amenities Area – 100 % to be completed ; 3rd floor & 7th Floor Toilet – 40 % to be complete
- Waterproofing work -8th Floor to 10th Floor- 90% to be complete
Work status as on 06-02-2026, we have completed the following.
- Fire Fighting Works – 2nd Floor – 75 % Completed & , 3rd Floor to 7th Floor – 80 % Completed, 8th Floor – 60 % Completed
- Plumbing Works (Concealed works) – Mockup & sample & Amenities area concealed works completed ; 3rd to 5th Floor – 90 % Completed, 6th Floor – 50 % Completed
- Internal Finishes – Painting -Primer -Ground Floor – 50 % Completed,1st Floor – 80 % Completed, 2nd Floor – 75 % Completed, 3rd Floor to 8th Floor – 100 % Completed, 9th Floor – 75 % completed; Putty work – 2nd Floor – 75 % completed, 3rd Floor to 8th Floor – 90 % completed, 9th floor – 50 % completed
- Tiling work – Sample & Mockup Flat & Amenities Area – 95 % completed
- Waterproofing work – 2nd Floor – 70 % completed ; 3rd Floor to 4th floor – 100 % completed ; 5th Floor to 7th Floor – 90 % completed.
- Aluminum doors & windows – Sample & Mockup Flat- 100 % completed
As per the current work status from our site, we are targeted to complete the following works by the end of February 2026
- CIVIL WORKS – Boundary wall works -15 % work to be Complete ; Columns & Shear wall – Terrace Floor parapet sunshade work to be complete ; Slabs & Beam – LMR roof slab & Water tank work to be complete
- PLASTERING WORKS – Inside wall Plastering work – 9th Floor & 11th Floor & 12th Floor – 100 % to be completed.
- Electrical works – Electrical work – Wall chasing & Box fixing- 13th Floor to 14th Floor – 90 % to be complete.
- Fire Fighting Works – 8th floor to 10th Floor – 80 % complete
- Plumbing Works (Concealed works) – Concealed works: 6th floor to 7th Floor – 90 % to be complete
- Internal Finishes – Painting -Primer – 9th Floor to 11th floor – 100 % to be Complete ; Putty work – 9th & 11th Floor – 90 % to be complete
- Tiling work – Mockup , Sample, Amenities Area – 100 % to be completed ; 3rd floor & 4th Floor Toilet – 90 % to be complete
- Waterproofing work – 5th Floor to 9th Floor- 90% to be completed
Work status as on 08-01-2026, we have completed the following.

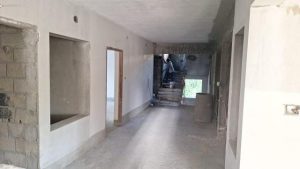

- PLASTERING WORKS – Inside wall Plastering work -Ground to 8th Floor – 100% completed, 9th Floor – 75 % Completed, 10th Floor – 70 % completed. Ceiling plastering: Ground to 16th Floor – 100% completed
- Electrical works – Electrical Rope pulling -Basement to 16th Floor – 100 % Completed; Electrical work – Wall chasing & Box fixing-Ground 11th Floor – 100 % Completed
- Fire Fighting Works – 2nd Floor – 75 % Completed & , 3rd Floor to 5th Floor – 100 % Completed, 6th Floor – 60 % Completed
- Plumbing Works (Concealed works) – Mockup & sample & Amenities area concealed works completed ; 3rd Floor & 4th Floor – 100 % Completed, 5th Floor – 30 % Completed
- Internal Finishes – Painting -Primer -Ground Floor – 50 % Completed,1st Floor – 80 % Completed, 2nd Floor – 75 % Completed, 3rd Floor to 7th Floor – 100 % Completed, 8th Floor – 75 % completed; Putty work – 2nd Floor – 75 % completed, 3rd Floor to 7th Floor – 100 % completed, 8th floor – 20 % completed
- Tiling work – Sample & Mockup Flat & Amenities Area – 95 % completed
- Waterproofing work – 2nd Floor – 70 % completed ; 3rd Floor to 4th floor – 100 % completed ; 5th Floor to 7th Floor – 70 % completed.
- Aluminum doors & windows – Sample & Mockup Flat- 100 % completed
As per the current work status from our site, we are targeted to complete the following works by the end of January 2026
- CIVIL WORKS – Boundary wall works-15 % work to be completed ; Columns & Shear wall – Terrace Floor parapet work to be complete ; Slabs & Beam – LMR roof slab & Stair Head Room & Water tank base to be completed

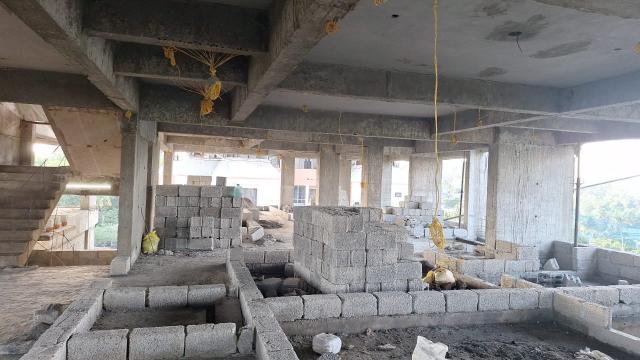

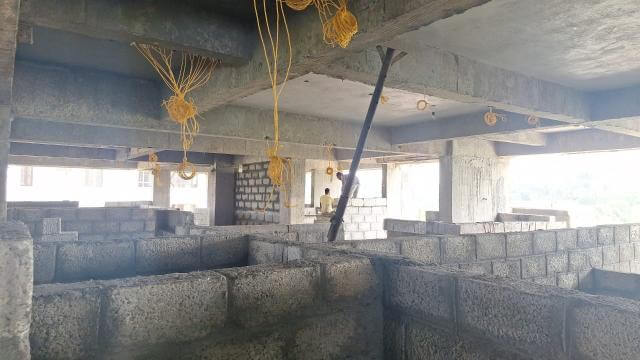

- BLOCK WORK – 16th floor to be completed
- PLASTERING WORKS – Inside wall Plastering work -10th Floor & 11th Floor – 100 % to be completed.
- Electrical works -Wall chasing & Box fixing- 12th Floor to 14th Floor – 100 % to be completed
- Fire Fighting Works – 6th floor to 8th Floor – 100 % completed
- Plumbing Works (Concealed works) – Concealed works: 5th floor to 7th Floor – 100 % to be completed
- Internal Finishes – Painting -Primer – 8th Floor to 10th floor – 100 % to be Completed ; Putty work – 8th & 10th Floor – 100 % to be completed
- Tiling work – Mockup , Sample, Amenities Area – 100 % to be completed
- Waterproofing work – 5th Floor to 7th Floor- 100% to be completed
- Aluminum doors & windows – Mockup & Sample flat – 100 % to be completed
Work status as on 08-12-2025, we have completed the following.
- PLASTERING WORKS – Inside wall Plastering work -Ground to 6th Floor – 100% completed, 7th Floor – 90 % Completed, 8th Floor – 100 % completed, 9th Floor – 20 % completed Ceiling plastering: Ground to 15th Floor – 100% completed, 16th floor – 40 % Completed.
- Electrical works – Electrical Rope pulling -Basement to 15th Floor – 100 % Completed, 16th Floor – 70% completed ; Electrical work – Wall chasing & Box fixing-Ground 8th Floor – 100 % Completed ; 9th Floor – 90 % completed
- Fire Fighting Works – 2nd Floor – 75 % Completed & , 3rd Floor – 75 % Completed
- Plumbing Works (Concealed works) – Mockup & sample & Amenities area concealed works completed ; 3rd Floor & 4th Floor – 90 % Completed
- Internal Finishes – Painting -Primer -Ground Floor – 50 % Completed,1st Floor – 80 % Completed, 2nd Floor – 75 % Completed, 3rd Floor to 5th Floor – 100 % Completed, 6th Floor – 75 % completed; Putty work – 2nd Floor – 75 % completed, 3rd Floor to 5th Floor – 100 % completed, 6th floor – 50 % completed
- Tiling work – Sample & Mockup Flat & Amenities Area – 95 % completed
- Waterproofing work – 2nd Floor – 70 % completed & 3rd Floor – 80 % completed ; 4th Floor – 70 % completed ; 5th Floor – 50 % completed ; 6th Floor – 50 % completed
- Aluminum doors & windows – Sample & Mockup Flat- 75 % completed
As per the current work status from our site, we are targeted to complete the following works by the end
- CIVIL WORKS – Boundary wall works-15 % work to be Complete ;Columns & Shear wall – Terrace Floor column work to be complete ; Slabs & Beam – LMR base slab & Stair Head Room to be complete
- BLOCK WORK – 16th floor to be complete
- PLASTERING WORKS – Inside wall Plastering work – 7th Floor – 100 % to be completed,9th Floor & 10th – 100 % to be completed ; Ceiling plastering: 16th Floor to be complete
- Electrical works – Electrical Rope pulling – 16th Floor – 100 % to be Completed; Electrical work – Wall chasing & Box fixing- 9th Floor to 11th Floor – 100 % to be complete.
- Fire Fighting Works – 3rd floor to 5th Floor – 100 % complete
- Plumbing Works (Concealed works) – Concealed works: 3rd floor to 5th Floor – 100 % to be complete
- Internal Finishes – Painting -Primer – 6th Floor to 8th floor – 100 % to be Complete ; Putty work- 6th & 8th Floor – 100 % to be complete
- Tiling work – Mockup , Sample, Amenities Area – 100 % to be completed
- Waterproofing work – 3rd Floor – 100 % to be completed , 4th Floor to 6th Floor- 100% to be completed
- Aluminum doors & windows – Mockup & Sample flat – 100 % to be completed
Work status as on 06-11-2025, we have completed the following.
- BLOCK WORK – Ground to 12th Floor – 100% completed;13th floor – 90 % Completed ; 14th Floor – 80 % Completed
- PLASTERING WORKS – Inside wall Plastering work -Ground to 5th Floor – 100% completed, 6th Floor – 90 % Completed Ceiling plastering: Ground to 14th Floor – 100% completed, 15th floor – 70 % Completed.
- Electrical works – Electrical Rope pulling -Basement to 15th Floor – 100 % Completed, ; Electrical work – Wall chasing & Box fixing-Ground 7th Floor – 100 % Completed ; 8th Floor – 20 % completed
- Fire Fighting Works – 2nd Floor – 75 % Completed & , 3rd Floor – 25 % Completed
- Plumbing Works (Concealed works) – Mockup & sample & Amenities area concealed works completed ; 3rd Floor & 4th Floor – 50 % Completed
- Internal Finishes – Painting -Primer -Ground Floor – 50 % Completed,1st Floor – 80 % Completed, 2nd Floor – 75 % Completed, 3rd Floor to 4th Floor – 100 % Completed; Putty work – 2nd Floor – 75 % completed, 3rd Floor to 4th Floor – 100 % completed
- Tiling work – Sample & Mockup Flat & Amenities Area – 90 % completed
- Waterproofing work – 2nd Floor – 40 % completed & 3rd Floor – 70 % completed ; 4th Floor – 50 % completed ; 5th Floor – 50 % completed
As per the current work status from our site, we are targeted to complete the following works by the end of NOVEMBER 2025
- BLOCK WORK – 13th to 16th floor to be complete
- PLASTERING WORKS – Inside wall Plastering work – 6th Floor – 100 % to be completed,7th Floor & 8th – 100 % to be completed ; Ceiling plastering: 15th Floor & 16th Floor to be complete
- Electrical works – Electrical Rope pulling – 16th Floor – 100 % to be Completed; Electrical work – Wall chasing & Box fixing- 7th Floor & 8th Floor – 100 % to be complete,
- Fire Fighting Works
- Plumbing Works (Concealed works) – Concealed works: 3rd floor & 4th Floor – 100 % to be complete
- Internal Finishes – Painting -Primer – 5th Floor & 6th floor – 100 % to be Complete ; Putty work- 5th & 6th Floor – 50 % to be complete
- Tiling work – Mockup , Sample, Amenities Area – 100 % to be completed
- Waterproofing work-3rd Floor – 100 % to be completed , 4th Floor & 5th Floor- 100% to be completed
Work status as on 07-10-2025 we have completed the following.
- BLOCK WORK: Ground to 10th Floor – 100% completed;11th floor – 90 % Completed ; 12th Floor – 50 % Completed
- PLASTERING WORKS: Inside wall Plastering work -Ground to 4th Floor – 100% completed, 5th Floor – 70 % Completed , 6th Floor – 40 % completed ; Ceiling plastering: Ground to 13th Floor – 100% completed, 14th floor – 80 % Completed.
- Electrical works: Electrical Rope pulling -Basement to 14th Floor – 100 % Completed; Electrical work – Wall chasing & Box fixing-Ground to 6th Floor – 100 % completed,7th Floor – 50 % completed
- Fire Fighting Works- 2nd Floor – 75 % Completed & , 3rd Floor – 25 % Completed
- Fire Fighting Works- 2nd Floor – 75 % Completed & , 3rd Floor – 25 % Completed
- Plumbing Works- Mockup & sample & Amenities area concealed works completed
- Internal Finishes- Painting -Primer -Ground Floor – 50 % Completed,1st Floor – 80 % Completed, 2nd Floor – 75 % Completed, 3rd Floor – 90 % Completed; Putty work- 2nd Floor – 75 % completed, 3rd Floor – 75 % completed
- Tiling work- Sample & Mockup Flat & Amenities Area – 90 % completed
- Waterproofing work- 2nd Floor – 30 % completed & 3rd Floor – 70 % completed ; 4th Floor – 50 % completed ; 5th Floor – 30 % completed
As per the current work status from our site, we are targeted to complete the following works by the end of OCTOBER 2025
- CIVIL WORKS- Boundary wall works-15 % work to be Completed;Columns & Shear wall-,16th floor column work to be completed ;Slabs & Beam-Terrace Floor slab to be completed
- BLOCK WORK- 11th to 13th floor to be completed

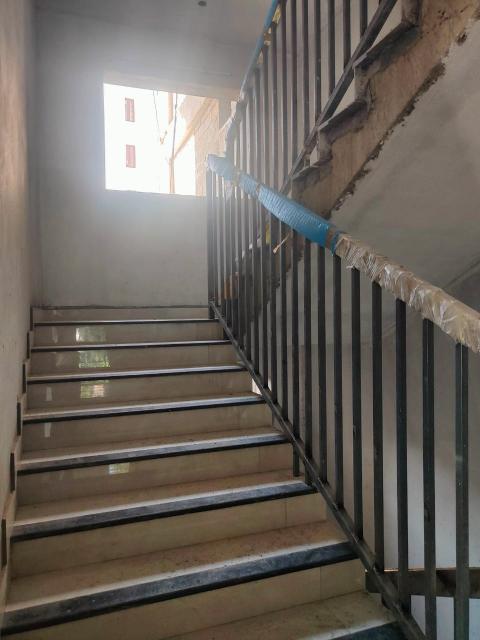

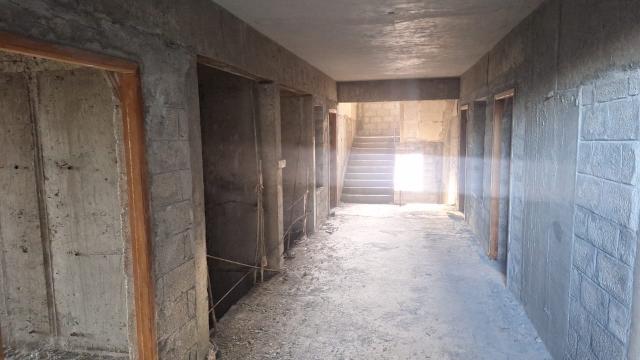

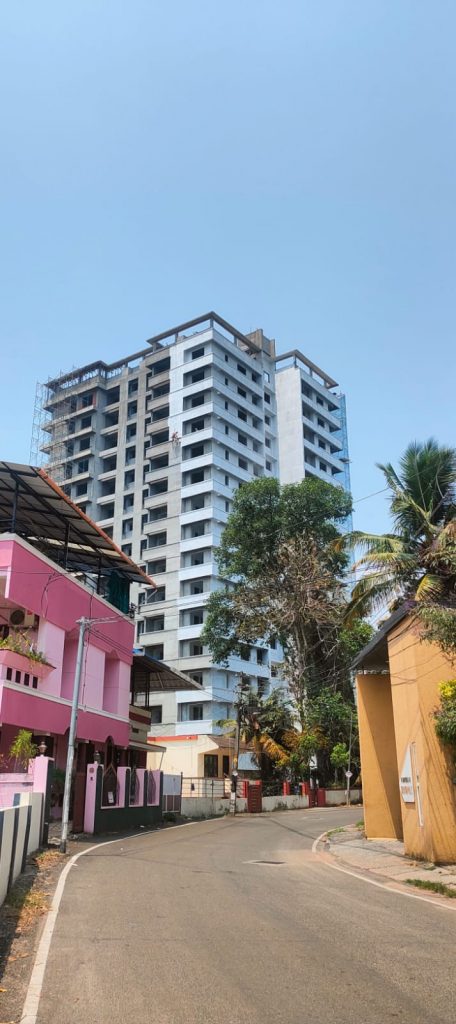

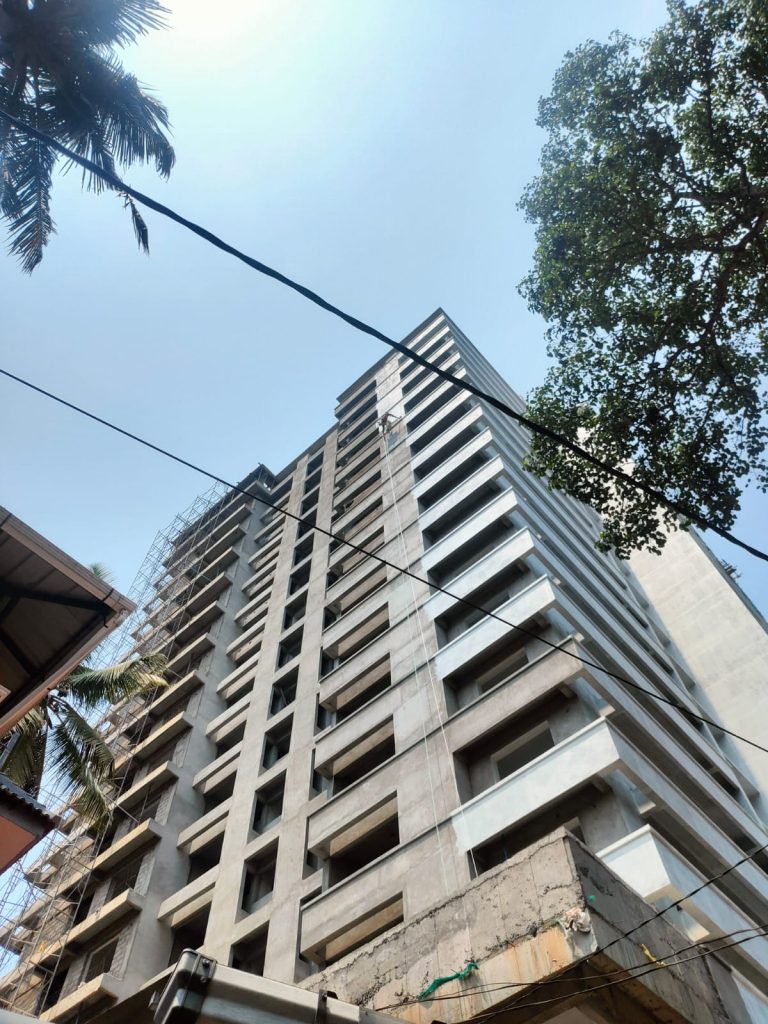

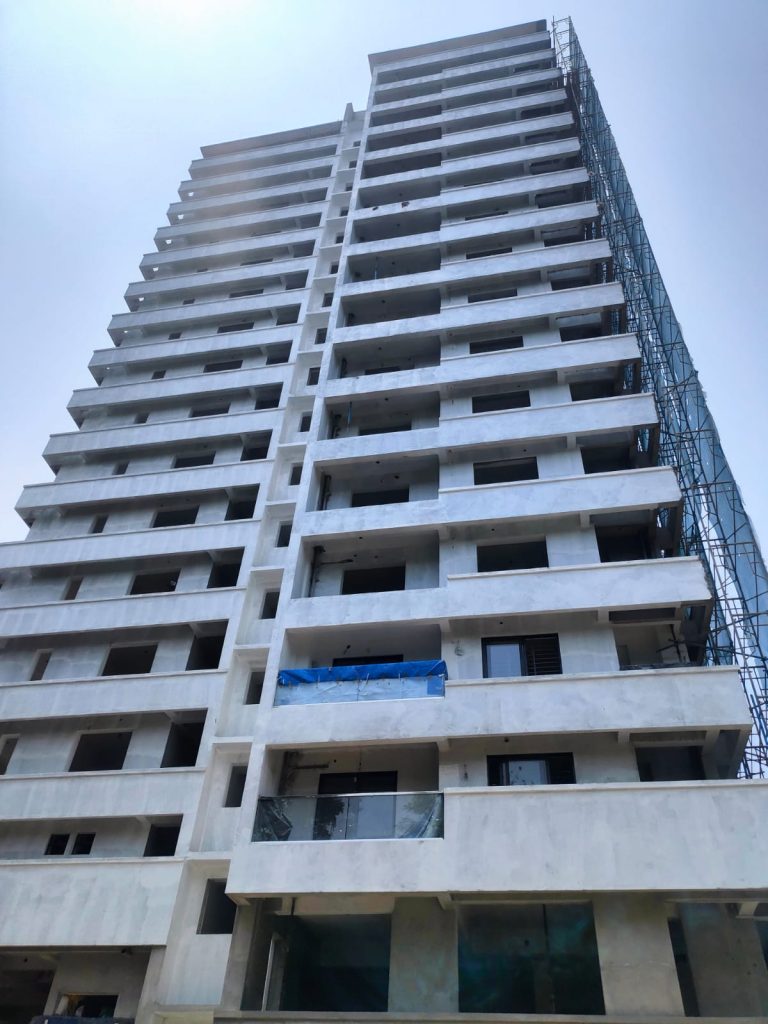

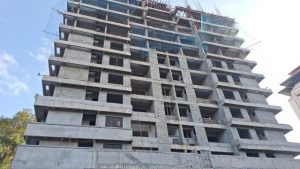

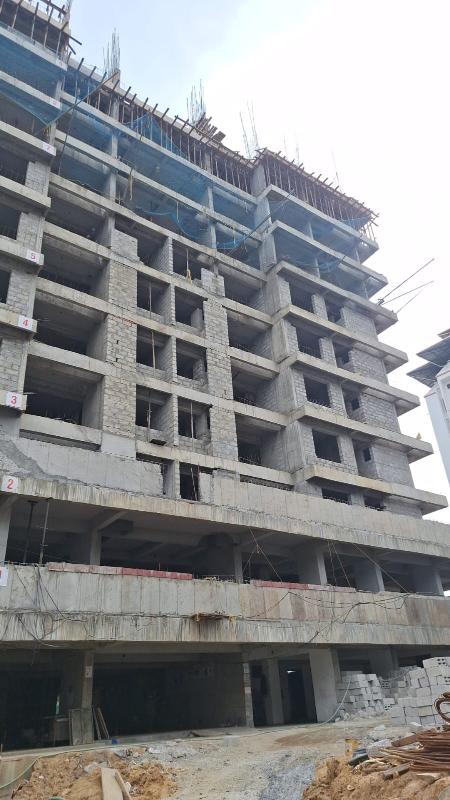

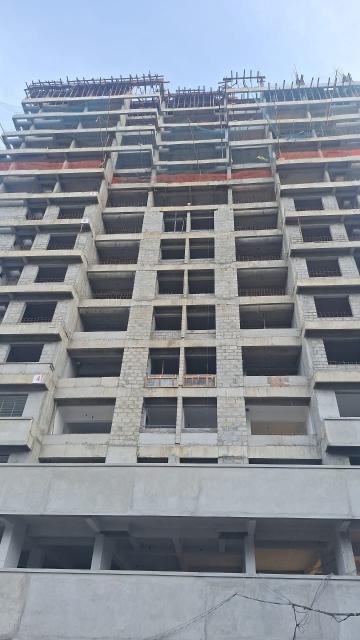

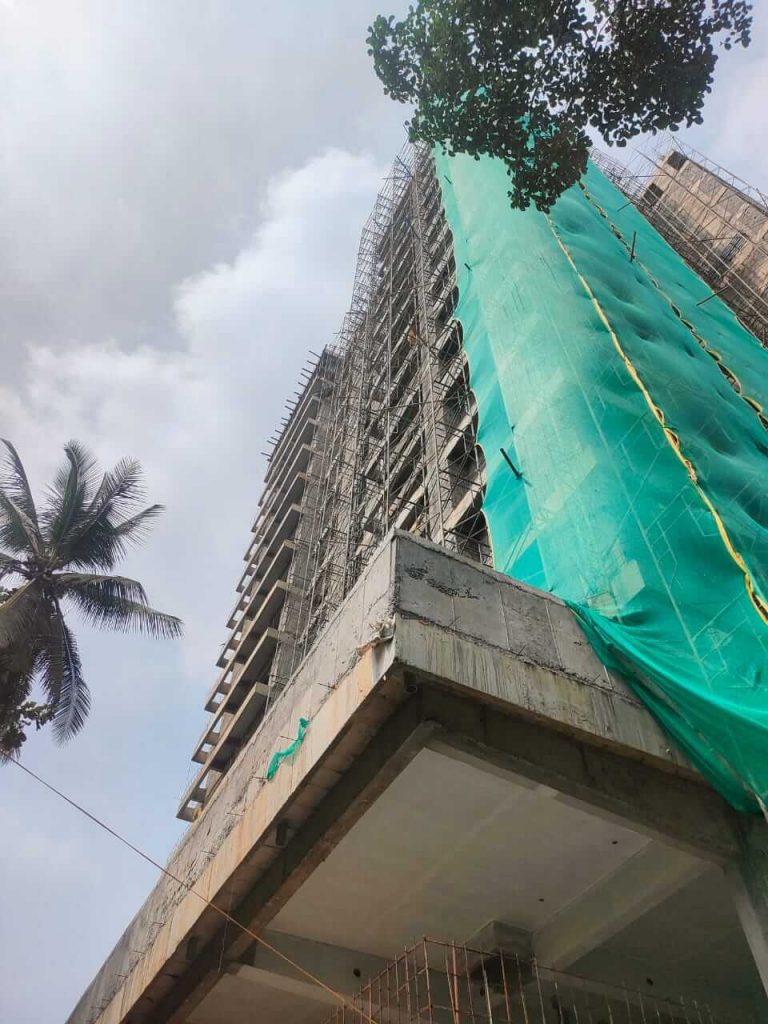

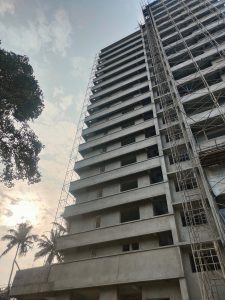

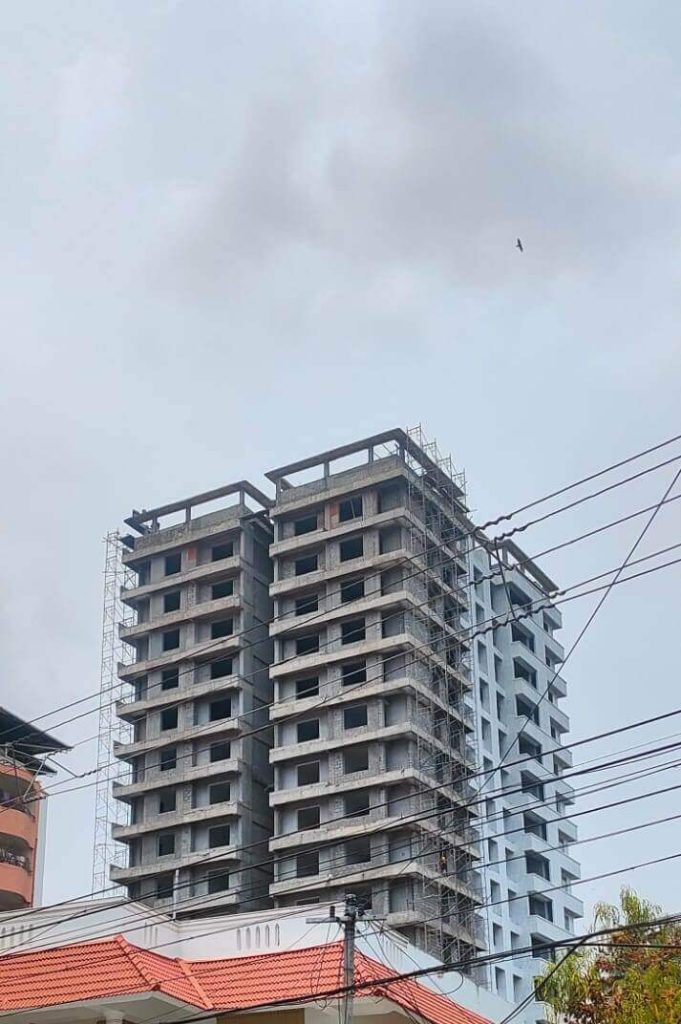

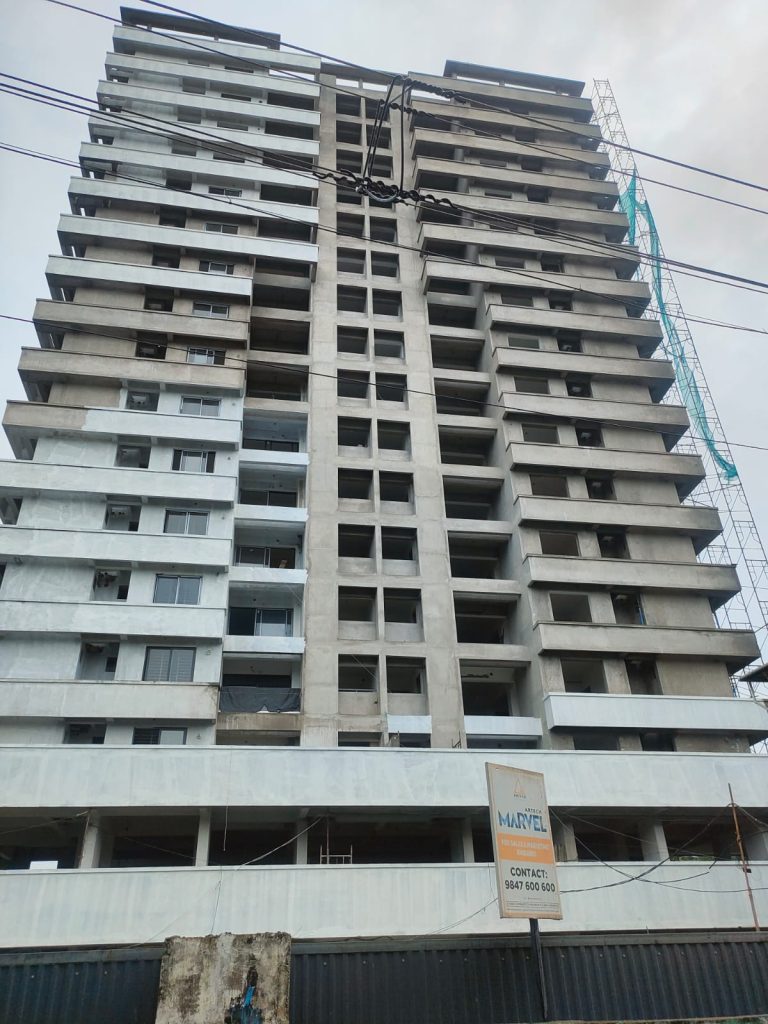

- PLASTERING WORKS- Inside wall Plastering work – 5th Floor – 100 % to be completed,6th Floor – 100 % to be completed ; Ceiling plastering: 14th Floor & 15th Floor to be completed
- Electrical works- Electrical Rope pulling – 15th Floor – 100 % to be Completed; Electrical work – Wall chasing & Box fixing- 7th Floor & 8th Floor – 100 % to be completed,

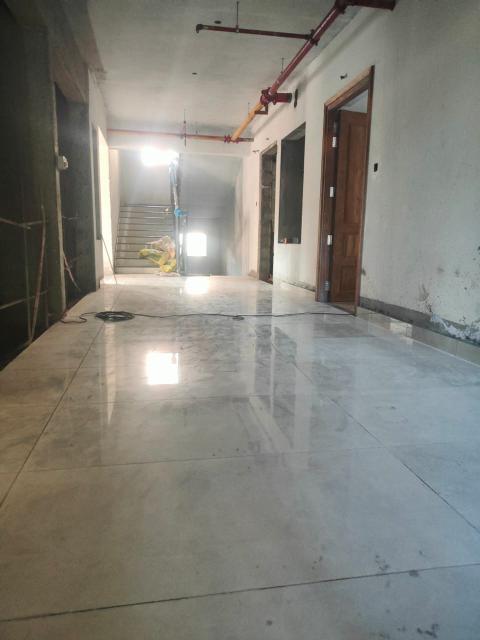

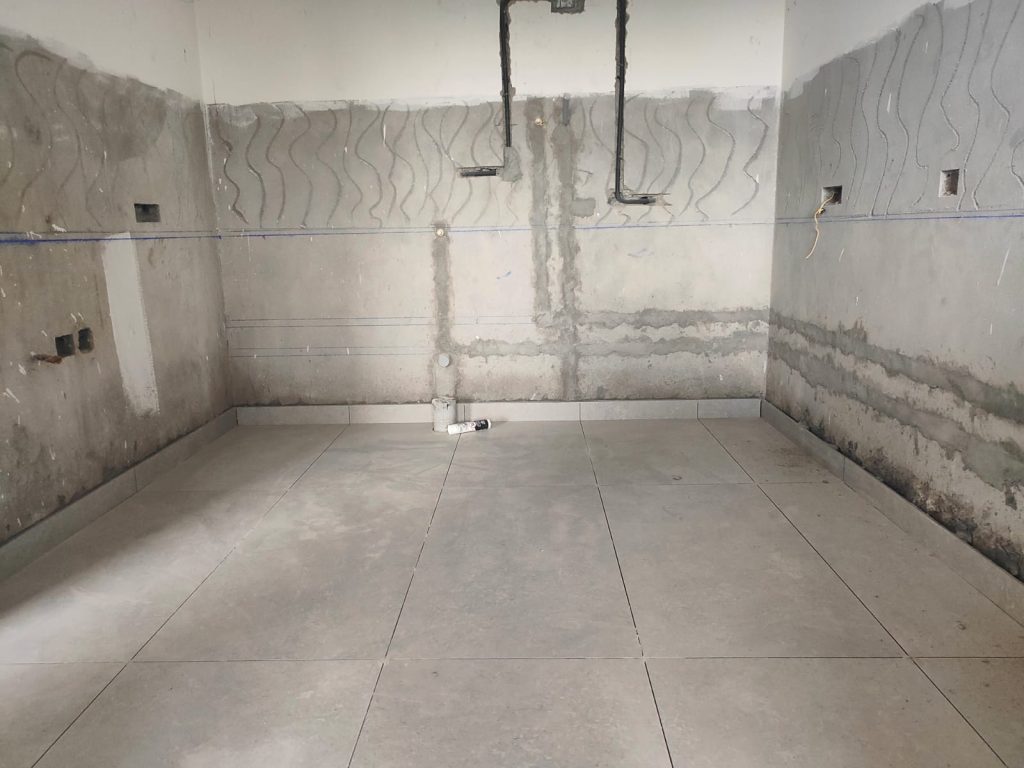

- Plumbing Works – Concealed works: 3rd floor to be complete

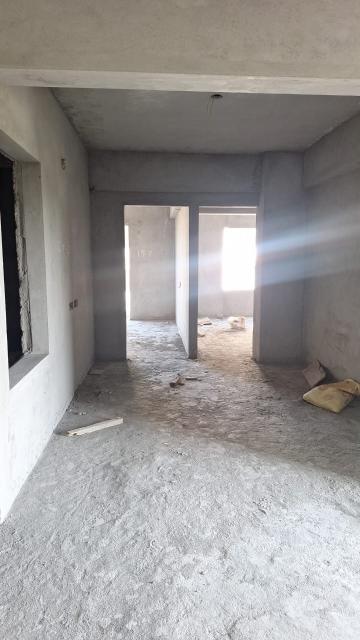

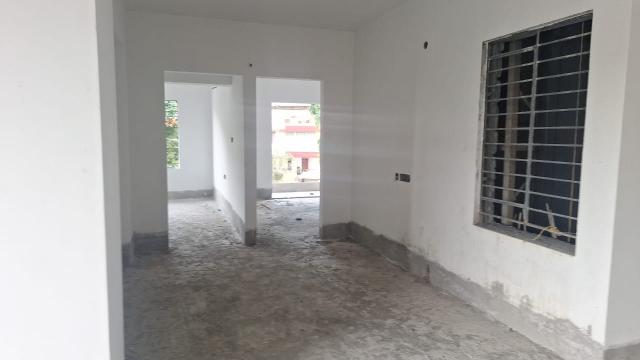

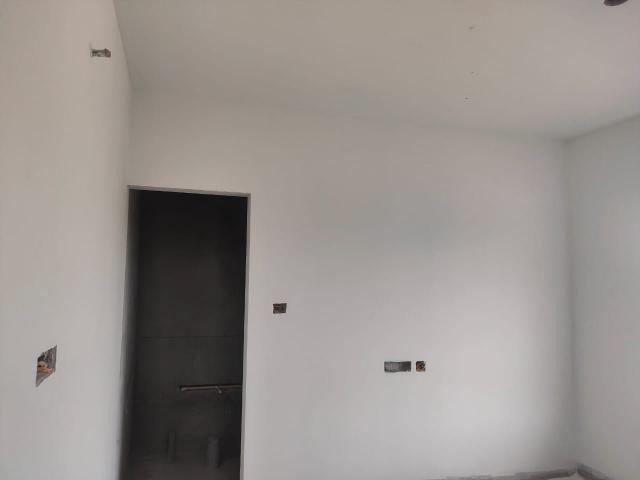

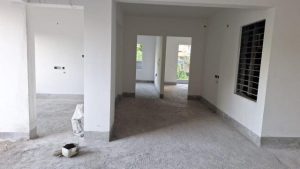

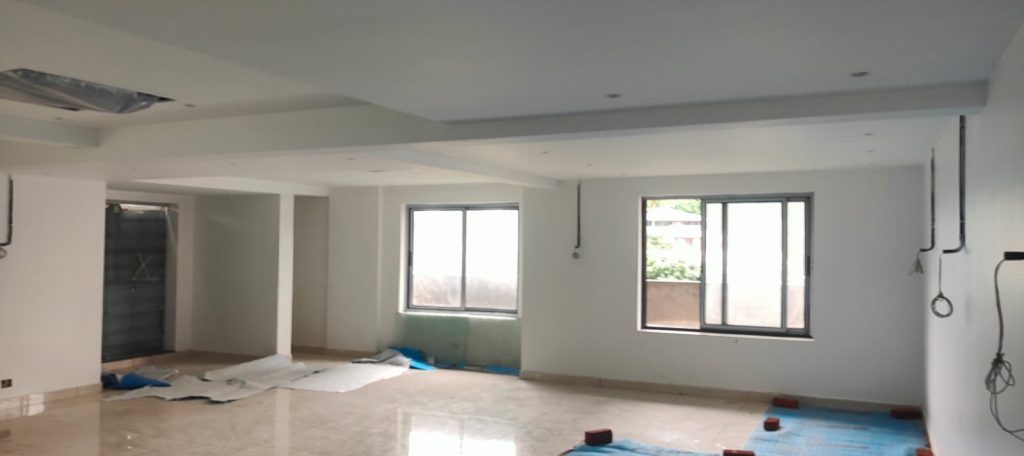

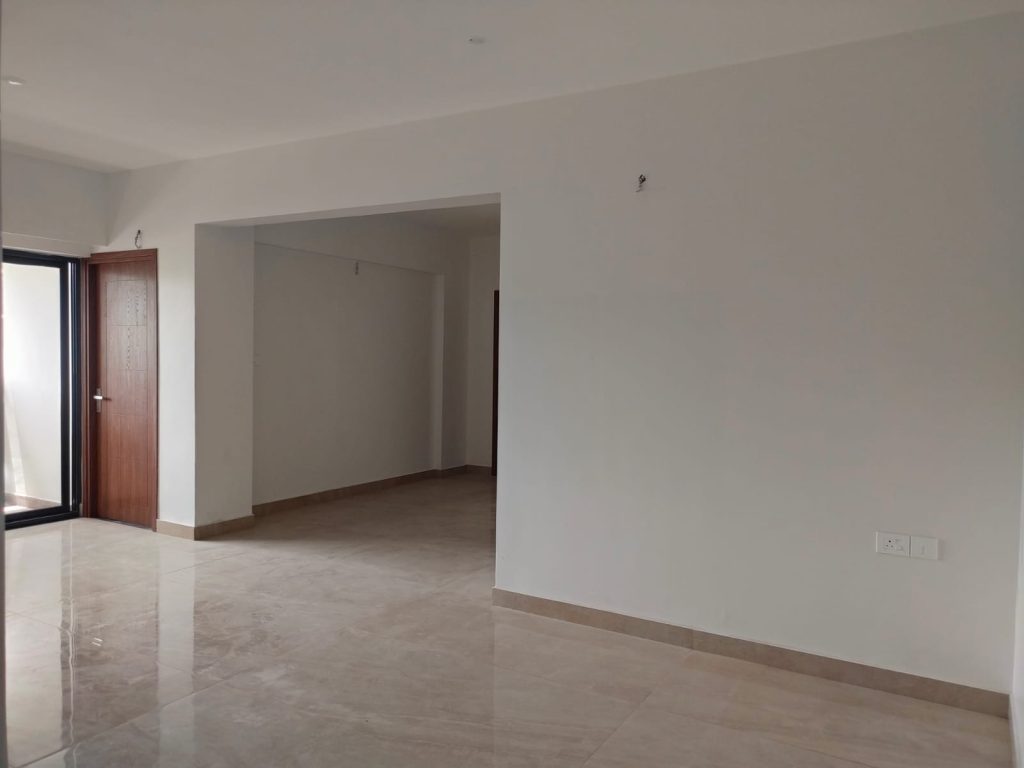

- Internal Finishes- Painting -Primer -3rd Floor & 4th floor – 100 % to be Completed; Putty work- 3rd Floor – 100% to be completed ; 4th Floor – 50 % to be completed
- Tiling work – Mockup , Sample, Amenities Area – 100 % to be completed
- Waterproofing work – 3rd Floor – 100 % to be completed , 4th Floor & 5th Floor- 100% to be completed
Work status as on 09-09-2025, we have completed the following.

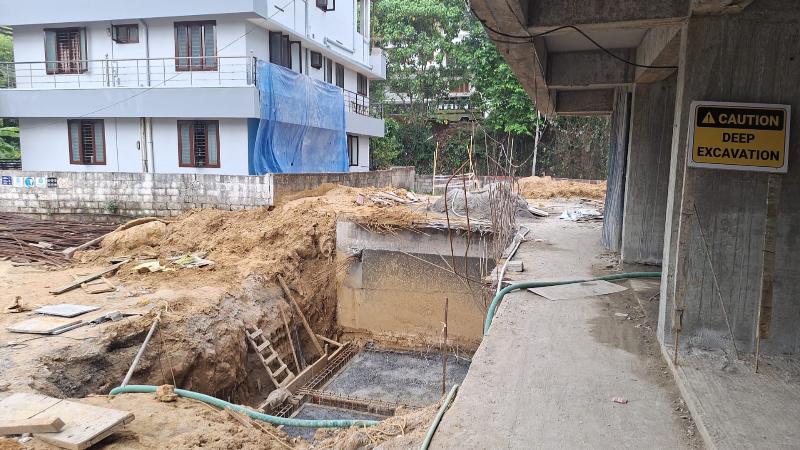

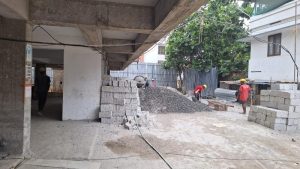

- Sub Structural Works Piling Work-100 % completed

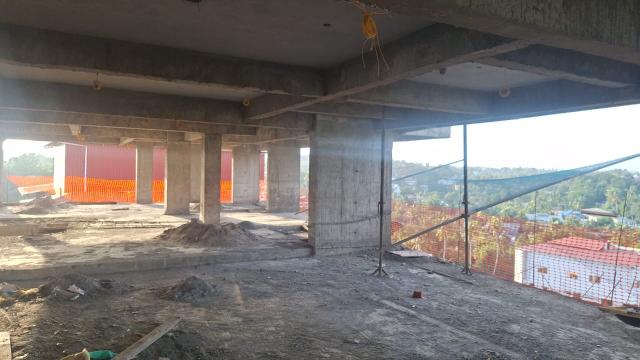

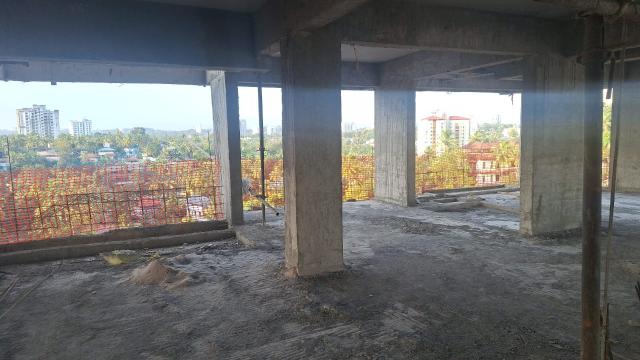

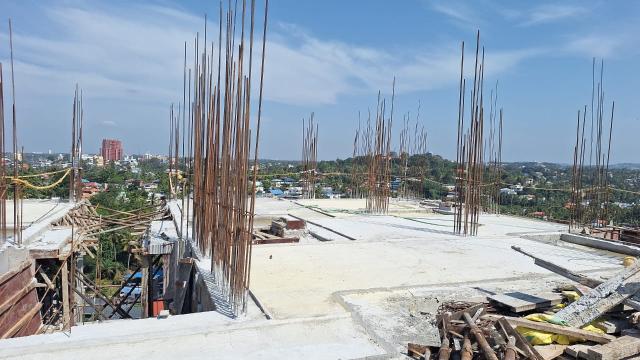

- CIVIL WORKS Pile Cap , Plinth beam, Base slab- 100 % completed; Sump tank-100 % completed;Boundary wall works-85 % work Completed;Columns & Shear wall-Basement to 15th Floor column work – 100% work completed;Slabs & Beam-Ground to 16th floor – 100 % completed,Terrace Floor slab work ongoing

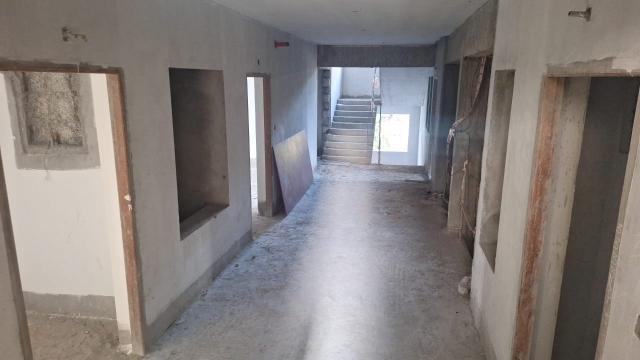

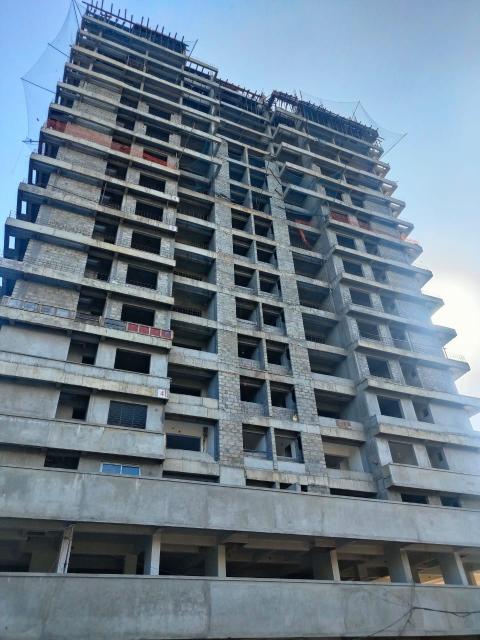

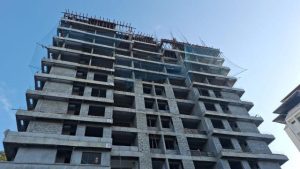

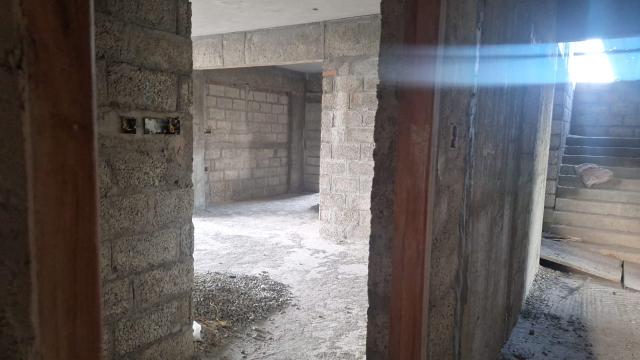

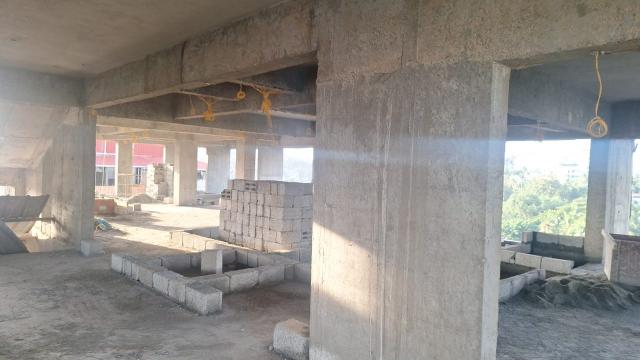

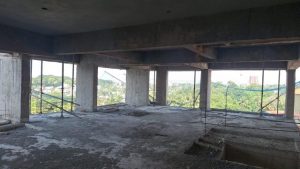

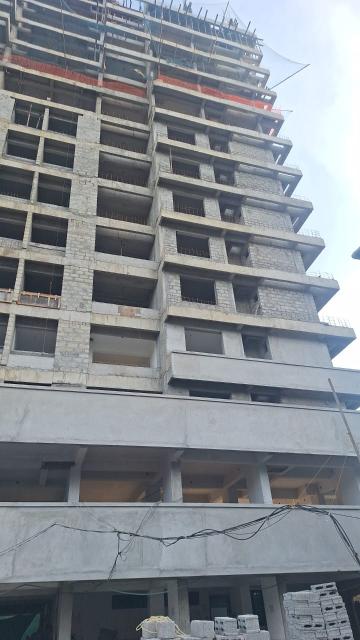

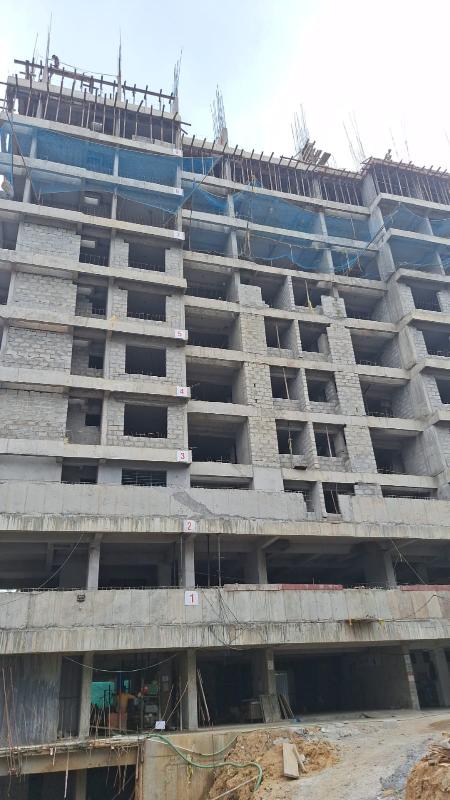

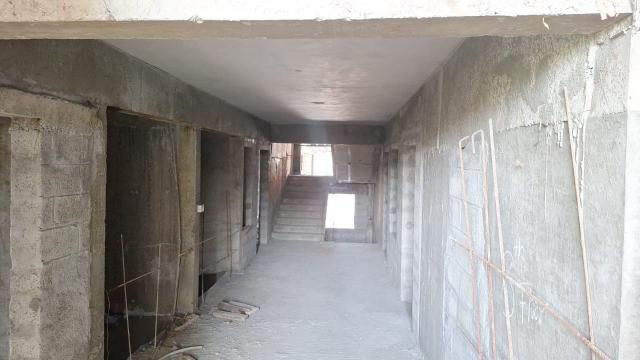

- BLOCK WORK Ground to 8th Floor – 100% completed;9th floor – 90 % Completed ; 10th Floor – 20 % Completed

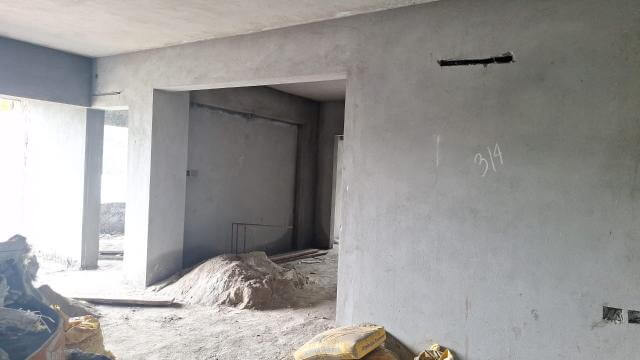

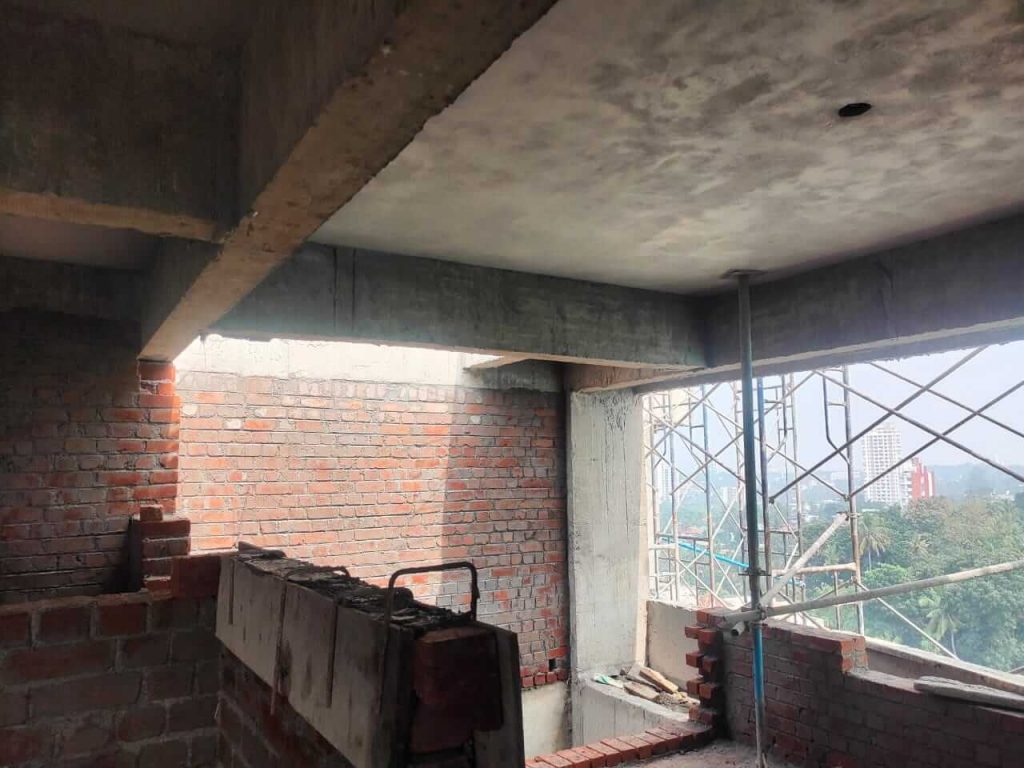

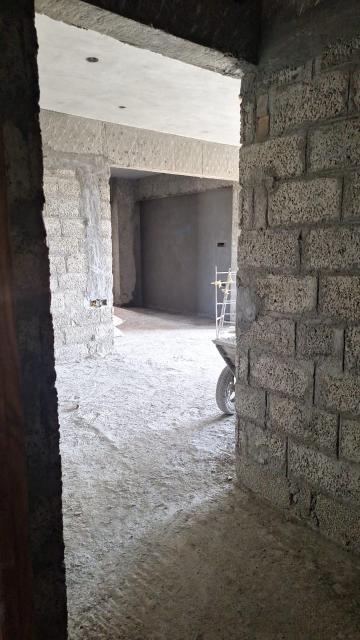

- PLASTERING WORKS Inside wall Plastering work -Ground to 4th Floor – 100% completed, 5th Floor – 50 % Completed , 6th Floor – Started only ; Ceiling plastering: Ground to 11th Floor – 100% completed, 12th floor – 80 % Completed , 13th Floor – Started only
- Electrical works Electrical Rope pulling -Basement to 12th Floor – 100 % Completed; Electrical work – Wall chasing & Box fixing-Ground to 6th Floor – 100 % completed,7th Floor – Started only
- Fire Fighting Works 2nd Floor – 75 % Completed & , 3rd Floor – 25 % Completed
- Plumbing Works Mockup & sample & Amenities area concealed works completed

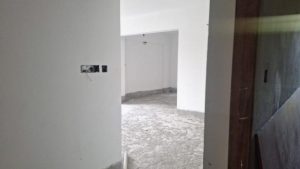

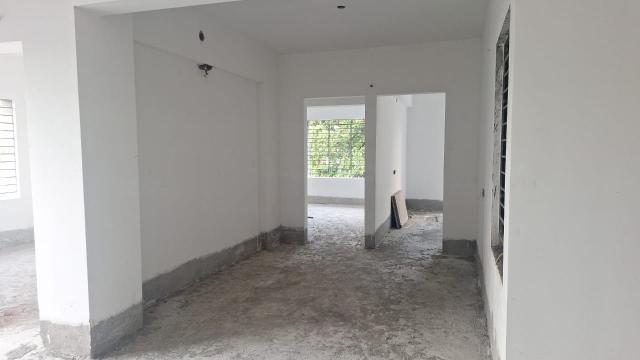

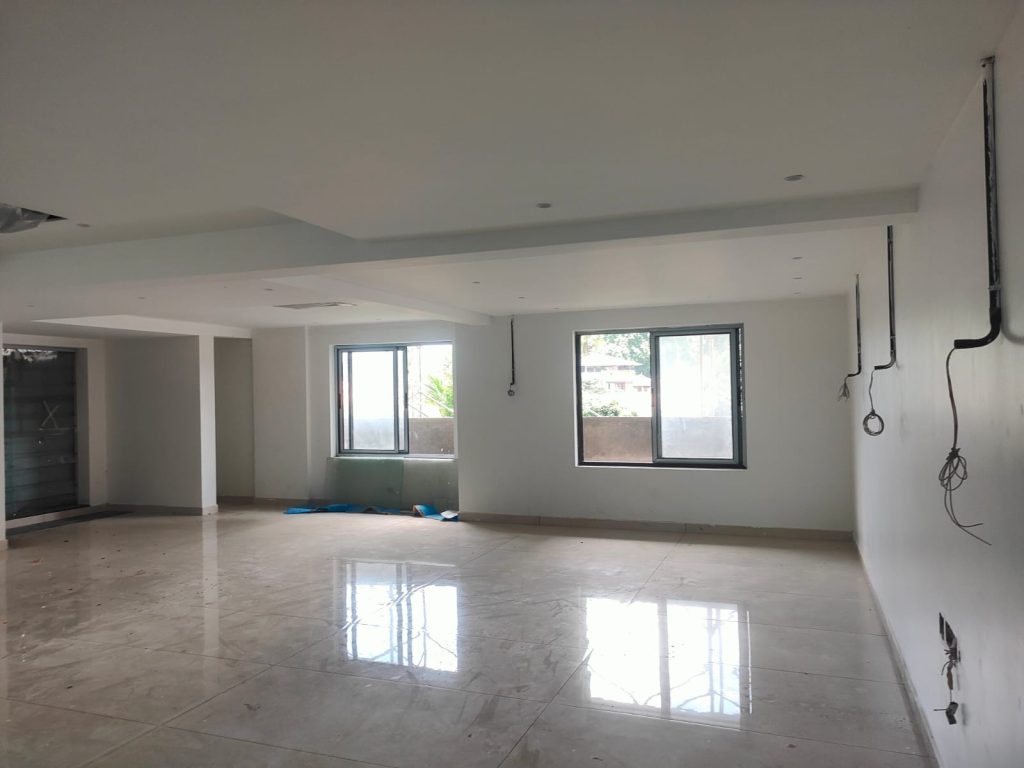

- Internal Finishes Painting -Primer -Ground Floor – 50 % Completed,1st Floor – 80 % Completed, 2nd Floor – 75 % Completed, 3rd Floor – 50 % Completed; Putty work- 2nd Floor – 75 % completed, 3rd Floor – 50 % completed

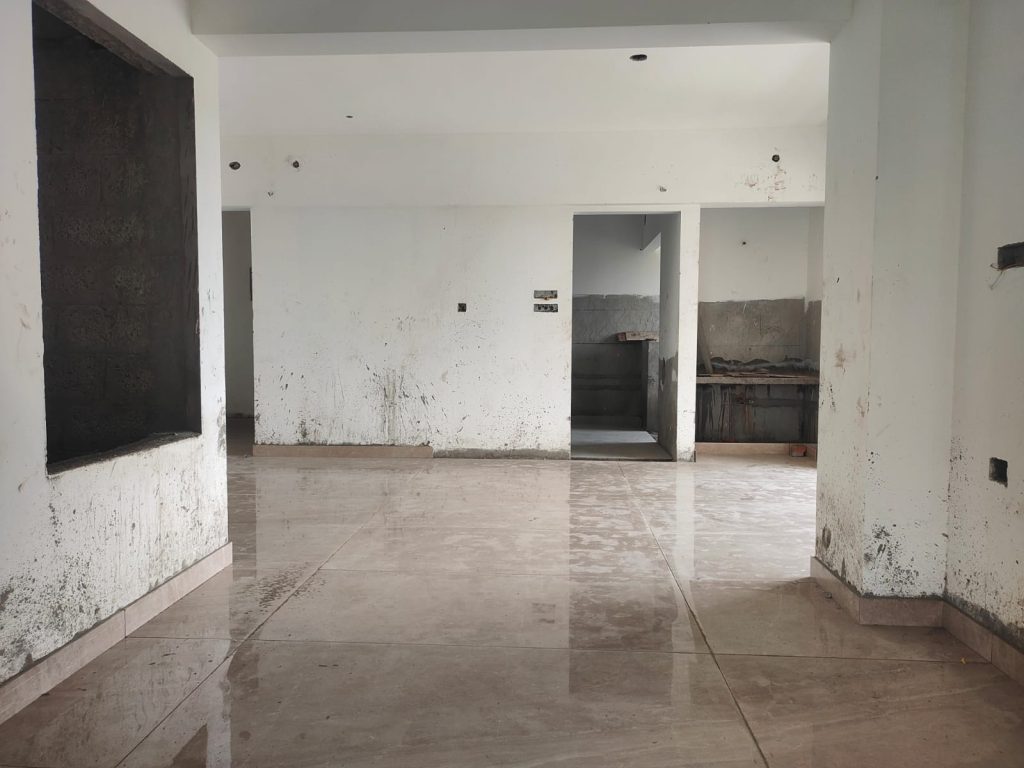

- Tiling work Sample & Mockup Flat & Amenities Area – 50 % completed
- Waterproofing work 2nd Floor – 30 % completed & 3rd Floor – 70 % completed ; 4th Floor – 50 % completed
As per the current work status from our site, we are targeted to complete the following works by the end of SEPTEMBER 2025

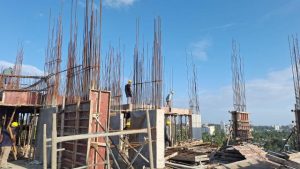

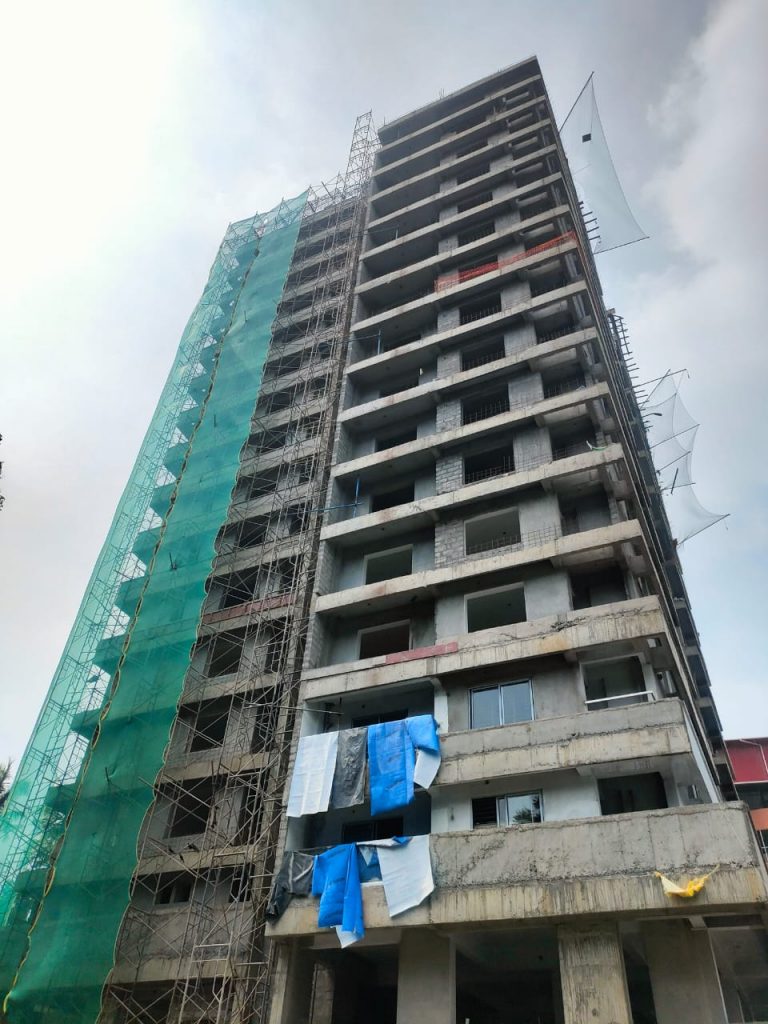

- CIVIL WORKS Boundary wall works-15 % work to be Completed;Columns & Shear wall-,16th floor column work to be completed ;Slabs & Beam-Terrace Floor slab to be completed
- BLOCK WORK 9th to 11th floor to be completed
- PLASTERING WORKS- Inside wall Plastering work – 5th Floor – 100 % to be completed,6th Floor – 100 % to be completed ; Ceiling plastering: 12th floor & 13th Floor & 14th Floor to be completed
- Electrical works- Electrical Rope pulling – 13th Floor & 14th Floor – 100 % to be Completed; Electrical work – Wall chasing & Box fixing- 7th Floor & 8th Floor – 100 % to be completed,
- Fire Fighting Works 3rd Floor – 100 % to be Completed
- Plumbing Works Concealed works: 3rd floor to be complete
- Internal Finishes Painting -Primer -3rd Floor – 50 % to be Completed; Putty work- 3rd Floor – 50 % to be completed
- Tiling work Mockup , Sample, Amenities Area – 100 % to be completed
- Waterproofing work 3rd Floor – 100 % to be completed , 4th Floor – 100% to be completed
Work status as on 06-08-2025, we have completed the following.
- Sub Structural Works Piling Work-100 % completed

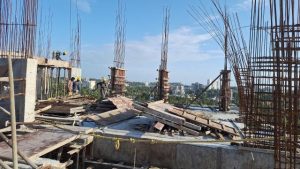

- CIVIL WORKS Pile Cap , Plinth beam, Base slab- 100 % completed; Sump tank-100 % completed;Boundary wall works-85 % work Completed;Columns & Shear wall-Basement to 13th Floor – 100 % Completed,14th Floor column work – 90% work completed;Slabs & Beam-Ground to 14th floor – 100 % completed,15th Floor slab work ongoing
- BLOCK WORK Ground to 8th Floor – 100% completed;9th floor – started only
- PLASTERING WORKS Inside wall Plastering work -Ground to 3rd Floor – 100% completed,4th floor – 90 % completed, 5th Floor – started only; Ceiling plastering: Ground to 10th Floor – 100% completed, 11th floor – started only
- Electrical works Electrical Rope pulling -Basement to 11th Floor – 100 % Completed; Electrical work – Wall chasing & Box fixing-Ground to 5th Floor – 100 % completed,6th Floor – 90 % completed,
- Fire Fighting Works 2 no.of Flat completed
- Plumbing Works Mockup & sample & Amenities area concealed works completed
- Internal Finishes Painting -Primer -Ground Floor – 50 % Completed,1st Floor – 80 % Completed, 2nd Floor – 75 % Completed, 3rd Floor – 50 % Completed; Putty work- 2nd Floor – 75 % completed, 3rd Floor – 50 % completed
- Tiling work Amenities area started only
- Waterproofing work 2nd Floor – 30 % completed & 3rd Floor – 40 % completed
As per the current work status from our site, we are targeted to complete the following works by the end of AUGUST 2025.
- CIVIL WORKS Boundary wall works-15 % work to be Completed;Columns & Shear wall-,14th Floor & 15th floor column work to be completed ;Slabs & Beam-15th Floor slab & 16th Floor slab to be completed
- BLOCK WORK 9th floor to be completed
- PLASTERING WORKS- Inside wall Plastering work -4th floor – 10 % to be completed, 5th Floor – 100 % to be completed,6th Floor – 50 % to be completed ; Ceiling plastering: 11th floor & 12th Floor to be completed
- Electrical works- Electrical Rope pulling – 12th Floor & 13th Floor – 100 % to be Completed; Electrical work – Wall chasing & Box fixing-Ground to 6th Floor – 10 %to be completed,7th Floor – 100 % to be completed,
- Fire Fighting Works
- Plumbing Works Concealed works: 3rd floor to be complete
- Internal Finishes Painting -Primer -3rd Floor – 50 % to be Completed; Putty work- 3rd Floor – 50 % to be completed
- Tiling work Mockup , Sample, Amenities Area – 100 % to be completed
- Waterproofing work 3rd Floor – 60 % to be completed , 4th Floor – 50% to be completed
Work status as on 09-06-2025, we have completed the following.

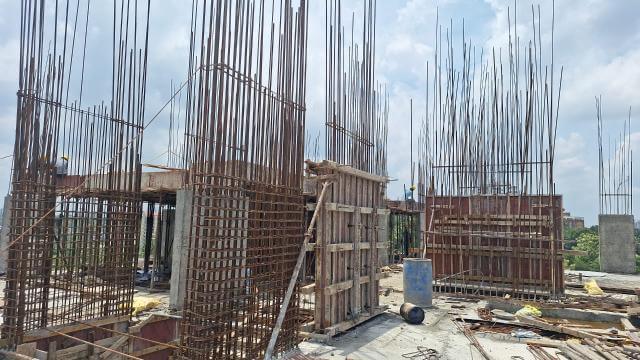

- Sub Structural Works – Column RCC-28 cum, Beam & slab & Staircase RCC-174 cum, Staircase RCC – 4 cum, Shear wall RCC -4 cum, Sump tank cover slab- 39cum
- BLOCK WORK – 8″Block work-57.48 cum,4″Block work- 175.78 sqm,
- PLASTERING WORKS – Wall Plastering; 395 Sqm Ceiling plastering: 440 sqm completed
- Electrical works – Electrical Rope pulling 6th,7th floor completed,Electrical work – wall chasing & box fixing-1 flat completed
- Waterproofing Works – Waterproofing work- 135 sqft, Waterproofing work – Apartments- 154 sqm, Core cutting-2flat
- Internal Finishes – Painting -primer – Painting -primer -3A-450 sqft ,Handrail work – Main Staircase- 35Rm
As per the current work status from our site, we are targeted to complete the following works by the end of JUNE 2025.

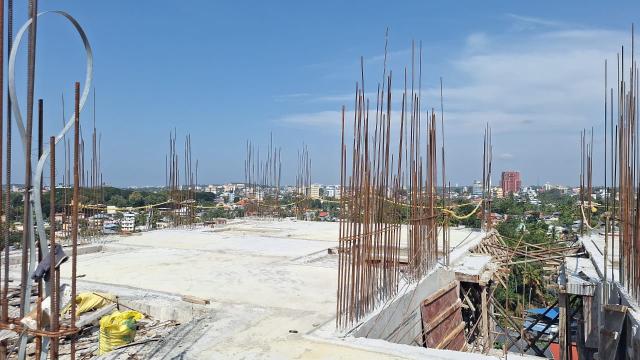

- Sub Structural Works – Pile chipping-8 Rm,Column RCC-60cum,Beam and slab RCC- 242 cum, Staircase RCC- 10 cum,Shear wall RCC-8cum ,Sunshade drop- 35.6 cum, Sump tank base-40 cum to be completed ,Parapet wall-16 cum, Boundary wall base- 22.4 cum, Boundary Retaining wall-
- BLOCK WORK – 8″ Block Work: 130m3 ,4″ Block Work- 350 sqm to be completed
- PLASTERING WORKS – Wall Plastering-1035 sqm, Ceiling plastering- 890 sqm to be completed
- Electrical works – Electrical Rope pulling -3 floors to be completed, Wall chasing & box fixing- 5 apartments to be completed, Electrical wire pulling-2 flats
- Waterproofing Works – Waterproofing work- Retaining Wall- 420 sqft to be completed, Core cutting- 4 flats to be completed, Waterproofing work – Apartments- 141.4 sqm to be completed, Door Frame fixing – 8apartments to be completed
- Internal Finishes – Painting -primer 900 sqft to be completed, Plumbing- 2 Flats to be completed, Tiling work-230sqm
Work status as on 09-05-2025, we have completed the following.

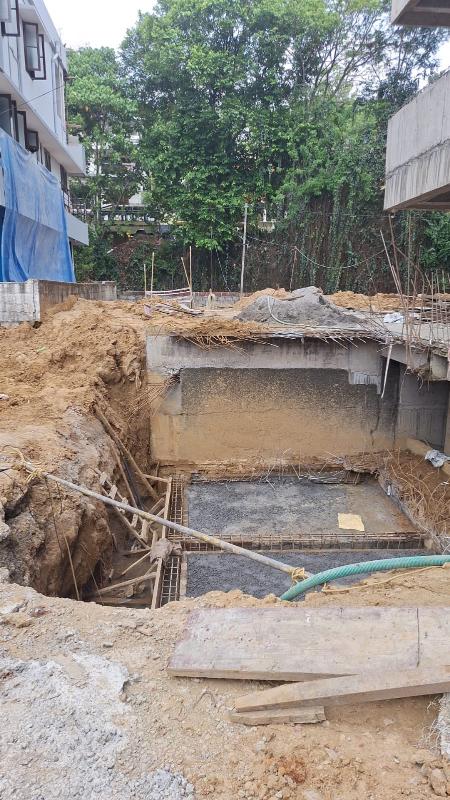

- Sub Structural Works – Column RCC-28cum, Beam & slab & Staircase (2nd flight) RCC-174 cum, Staircase (1st flight & landing) RCC – 4cum, Shear wall RCC -4 cum, Sump tank cover slab- 39cum
- BLOCK WORK – 8″Block work-63.03 cum,4″Block work- 215.11 sqm,
- PLASTERING WORKS – Wall Plastering; 517 Sqm Ceiling plastering: 664.94 sqm completed
- Electrical works – Electrical Rope pulling 6th,7th floor completed,Electrical work – wall chasing & box fixing-1 flat completed
- Waterproofing Works – Waterproofing work- 700 sq ft, Waterproofing work – Apartments- 154 sqm, Core cutting-1 flat
- Internal Finishes – Painting -primer -2A-450 sqft
As per the current work status from our site, we are targeted to complete the following works by the end of MAY 2025.
- Sub Structural Works – Pile chipping-8 Rm,Column RCC-60cum,Beam and slab RCC- 242 cum, Staircase RCC- 10 cum,Shear wall RCC-8cum ,Sunshade drop- 35.6 cum, Sump tank base-40 cum to be completed ,Parapet wall-16 cum,
- BLOCK WORK – 8″ Block Work: 120m3 ,4″ Block Work- 450 sqm to be completed
- PLASTERING WORKS – Wall Plastering-600 sqm, Ceiling plastering- 800 sqm to be completed
- Electrical works – Electrical Rope pulling -2 floors to be completed, Wall chasing & box fixing- 7 apartments to be completed,
- Waterproofing Works – Waterproofing work- Retaining Wall- 420 sqft to be completed, Core cutting- 5 flats to be completed, Waterproofing work – Apartments- 141.4 sqm to be completed, Door Frame fixing – 14 apartments to be completed
- Internal Finishes – Painting -primer 900 sqft to be completed, Plumbing- 2 Flats to be completed
Work status as on 10-04-2025, we have completed the following.
- Sub Structural Works – Column RCC-28cum, Beam & slab & Staircase (2nd flight) RCC-174 cum, Staircase (1st flight & landing) RCC – 4cum, Shear wall RCC -4 cum, Sump tank cover slab- 28 cum, Earth work excavation- 45 cum
- BLOCK WORK – 8″Block work-63.03 cum,4″Block work- 215.11 sqm,
- PLASTERING WORKS – Wall Plastering; 219.48 Sqm Ceiling plastering: 664.94 sqm completed
- Electrical works – Electrical Rope pulling 6th,7th floor completed,Electrical work – wall chasing & box fixing-1 flat completed
- Waterproofing work- 1211 sqft, Waterproofing work – Apartments- 154 sqm, Core cutting-1 flat
As per the current work status from our site, we are targeted to complete the following works by the end of APRIL 2025.
- Sub Structural Works – Earth levelling and back filling-300 cum, Earth work excavation for sump tank-110 cum, Pile chipping-8 Rm,Column RCC-60cum,Beam and slab RCC- 242 cum, Staircase RCC- 10 cum,Shear wall RCC-8cum ,Sunshade drop- 35.6 cum, Sump tank base-40 cum to be completed ,Parapet wall-16 cum,
- BLOCK WORK – 8″ Block Work: 132m3 ,4″ Block Work- 416 to be completed
- PLASTERING WORKS – Wall Plastering-600 sqm, Ceiling plastering- 900 sqm to be completed
- Electrical Rope pulling -2 floors to be completed, Wall chasing & box fixing- 7 apartments to be completed,
- Waterproofing work- Retaining Wall- 420 sqft to be completed, Core cutting- 5 flats to be completed, Waterproofing work – Apartments- 141.4 sqm to be completed, Door Frame fixing – 7 apartments to be completed

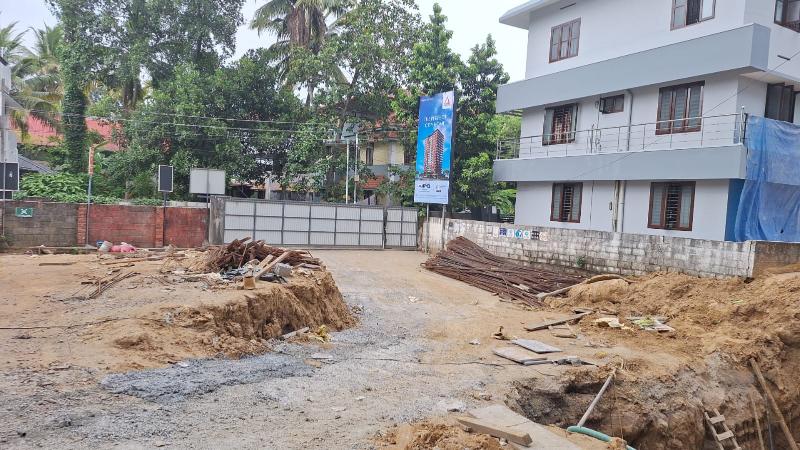

Work status as on 10-03-2025, we have completed the following.
- Sub Structural Works – Earth work excavation for sump tank 110m3 Pile chipping 6 Rm Column RCC 26 cum,Beam & slab & Staircase (2nd flight) RCC 174 cum,Staircase (1st flight & landing) RCC 6cum,Shear wall RCC 7cum,Sump tank base 49cum, Beam & slab & Staircase (2nd flight) RCC-68cum completed,Staircase (1st flight & landing) RCC- 4 cum, Shear wall RCC-7 cum, Sump tank wall- 38.58cum,
- BLOCK WORK – 8″Block work 76.57cum , 4″Block work 286.34 sqm
- PLASTERING WORKS – Wall Plastering; 1157sqm completed out of 35000sqm Ceiling plastering: 664.94 sqm completed
- Electrical works – Electrical Rope pulling 6th,7th floor completed,Electrical work – wall chasing & box fixing-1 flat completed
As per the current work status from our site, we are targeted to complete the following works by the end of MARCH 2025.
- Sub Structural Works – Earth levelling and back filling-300 cum, Earth work excavation for sump tank-110 cum, Pile chipping-8 Rm,Column RCC-60cum,Beam and slab RCC- 242 cum, Staircase RCC- 10 cum,Shear wall RCC-7cum ,Sunshade drop- 35.6 cum, Sump tank base-40 cum to be completed
- BLOCK WORK – 8″ Block Work: 70m3 ,4″ Block Work-240 to be completed
- PLASTERING WORKS – Wall Plastering-600 sqm, Ceiling plastering- 500 sqm to be completed
Work status as on 13-02-2025, we have completed the following.
- Sub Structural Works – Earth work excavation for sump tank 110m3 Pile chipping 6 Rm Column RCC 40 cum,Beam & slab & Staircase (2nd flight) RCC 174 cum,Staircase (1st flight & landing) RCC 6cum,Shear wall RCC 7cum,Sump tank base 49cum,
- BLOCK WORK – 8″Block work 50 cum , 4″Block work 113 sqm
- PLASTERING WORKS – Wall Plastering; 1157sqm completed out of 35000sqm Ceiling plastering: 331sqm completed
- Electrical works- Electrical Rope pulling 5th floor completed
As per the current work status from our site, we are targeted to complete the following works by the end of FEBRUARY 2025.
- Sub Structural Works – Earth levelling and back filling-300 cum, Earth work excavation for sump tank-110 cum, Pile chipping-8 Rm,Column RCC-60cum,Beam and slab RCC- 242 cum, Staircase RCC- 10 cum,Shear wall RCC-7cum ,Sunshade drop- 35.6 cum, Sump tank base-40 cum to be completed
- BLOCK WORK- 8″ Block Work: 70m3 ,4″ Block Work-240 to be completed
- PLASTERING WORKS – Wall Plastering-600 sqm, Ceiling plastering- 500 sqm to be completed
