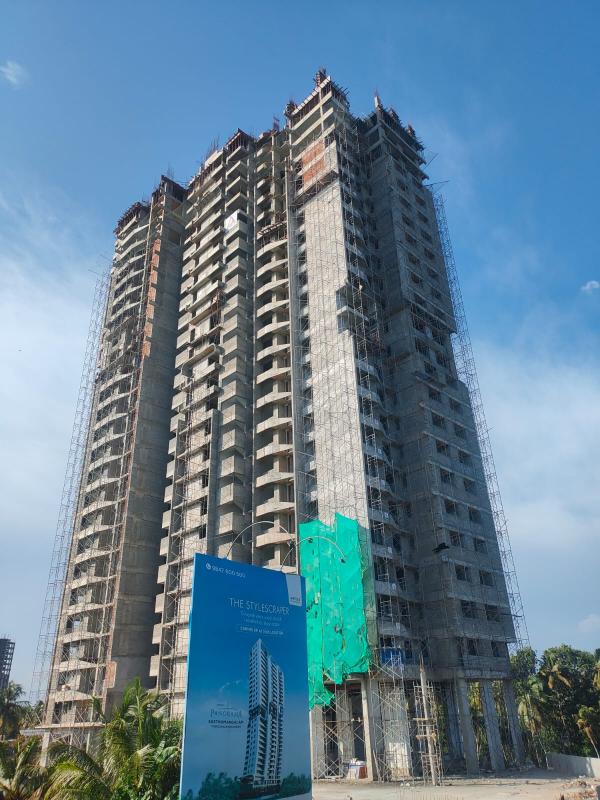

ArtechPanorama

3 BHK Flats in Trivandrum , 4 BHK Flats in Trivandrum , Builders in Trivandrum , Luxury apartments in trivandrum , Ongoing , Trivandrum
Sasthamangalam | Trivandrum

RERA Number: K‐RERA/PRJ/TVM/121/2022

Project Description

At Artech Panorama your dream homes will not only wrap you in luxury but also amaze you with stunning architecture.
Simply stylish in design, the magnificent façade is modern, chic and alluring.
The cleanlines, curved edges and contemporary textures exude a sense of understated luxury that is sure to impress all.
Premium 3 & 4 bed residences set in a 25-storey tower, majestically rising above the city’s skyline to bring you an elevated living experience, quite literally.

QUICK
ENQUIRE

Take your first few steps towards finding the ultimate happiness of the Perfect Home.
  • Air-conditioned multi purpose hall
  • Air-conditioned unisex Gym
  • Guest Suite
  • Indoor Games Room
  • Rooftop Party Area
  • Swimming Pool and Toddler’s Pool
  • Children’s Play Area
  • Video door phone with intercom facility
  • Children’s play area.
  • Video door phone with intercom facility.
  • Driver’s restroom.
  • Common toilet for supporting staff.
  • Reticulated LPG supply.
  • Gas leakage detector.
  • Boom barrier.
  • Access control system
  • Surveillance camera system.
  • Common Electric car charging point.
  • Efficient waste disposable system.
  • Fire suppression system.
  • Car wash facility

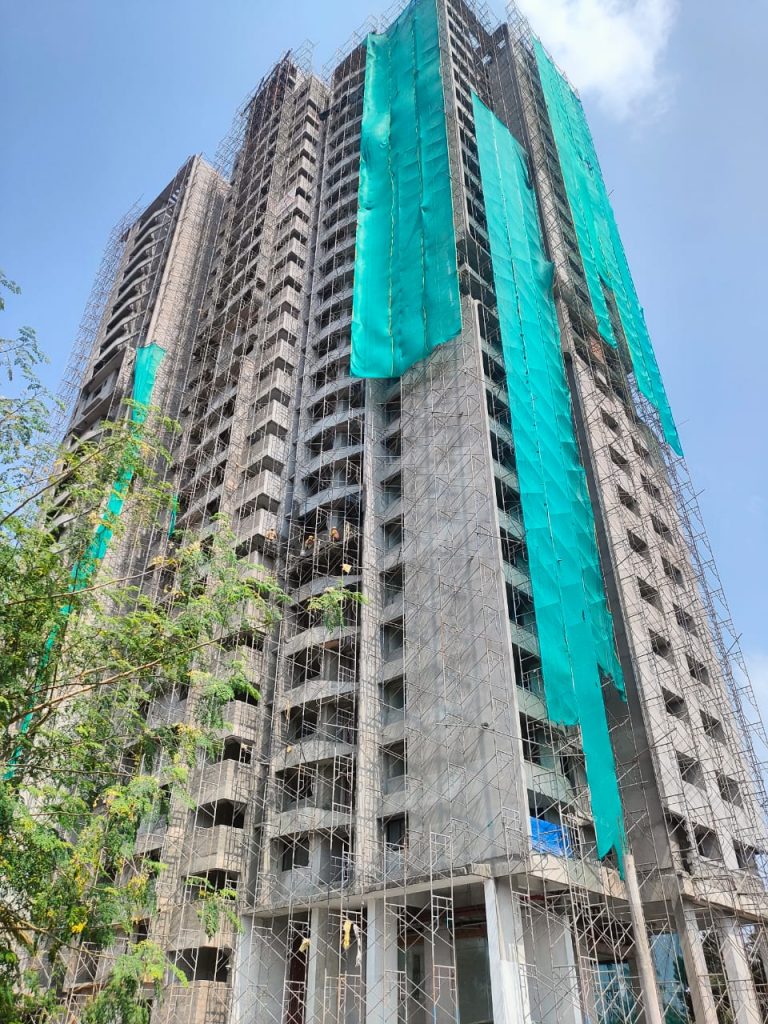

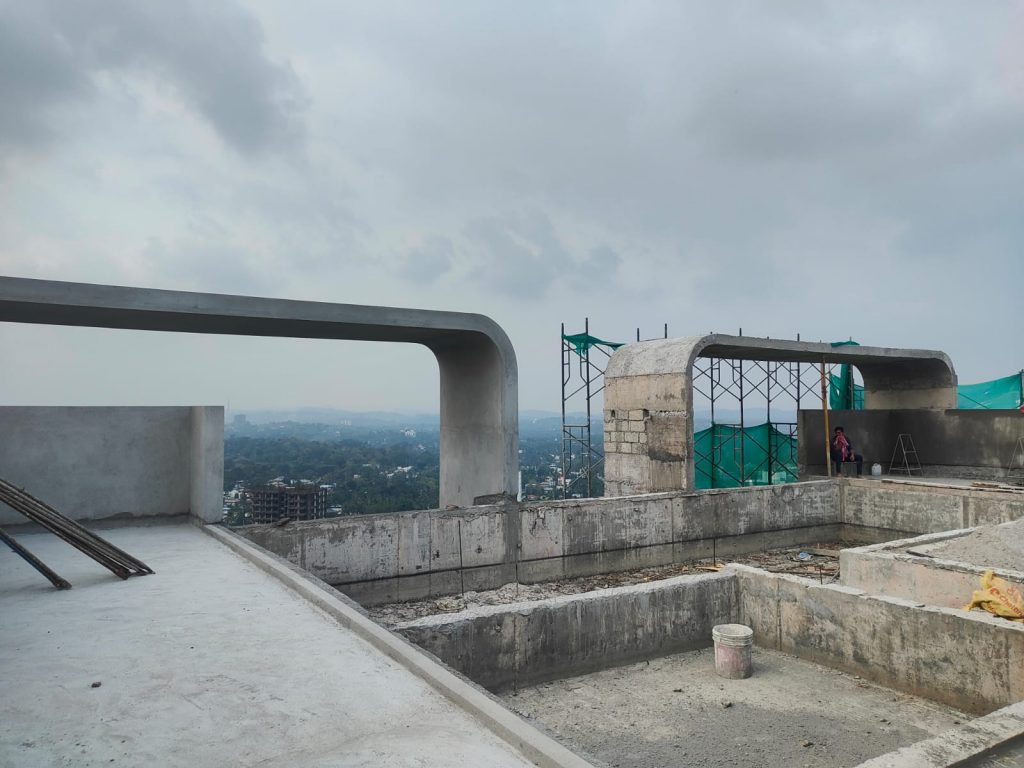

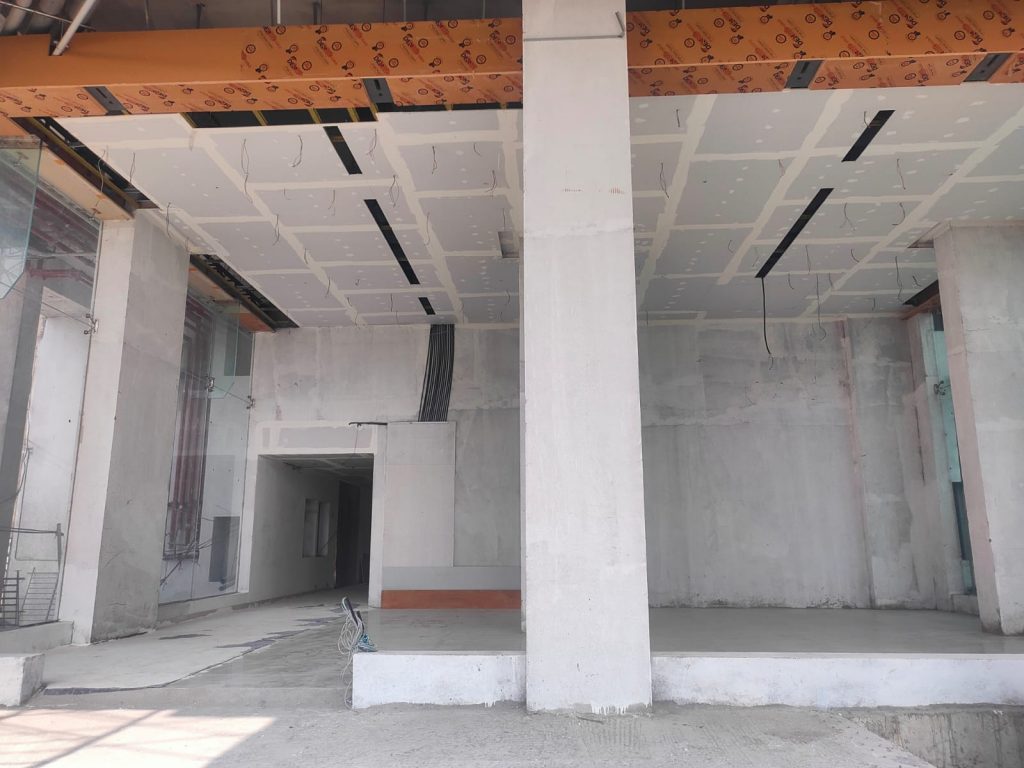

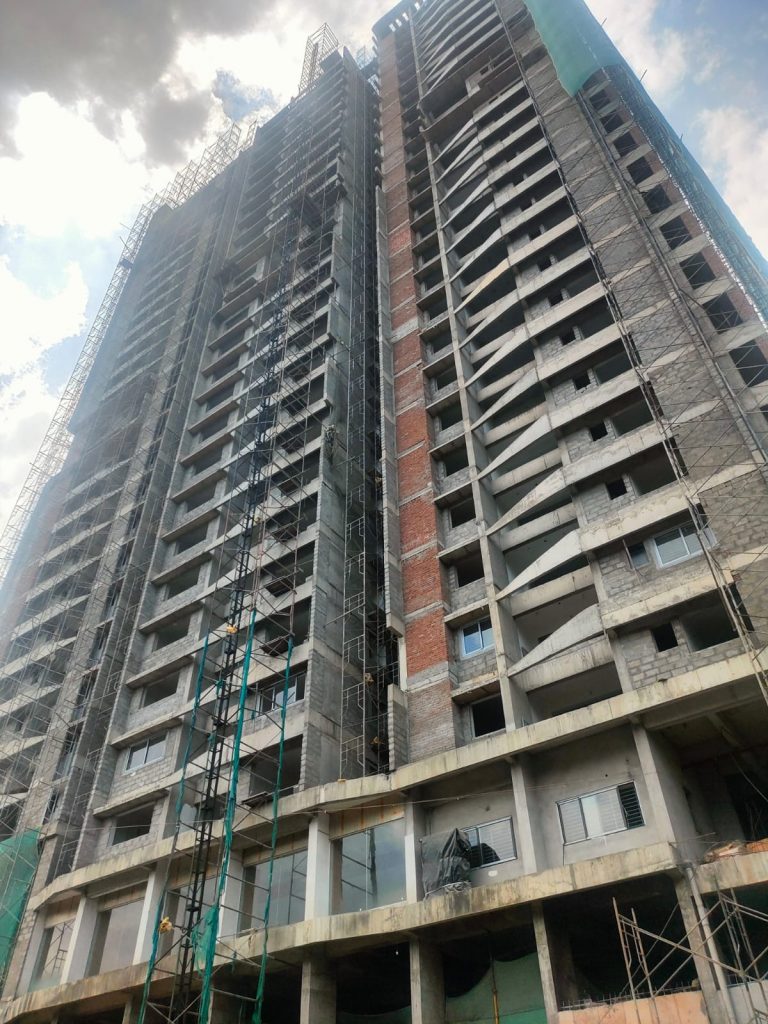

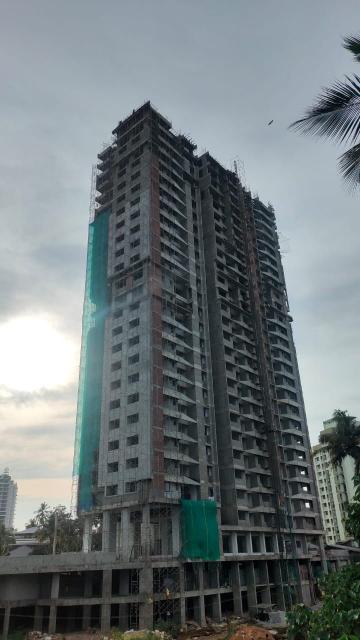

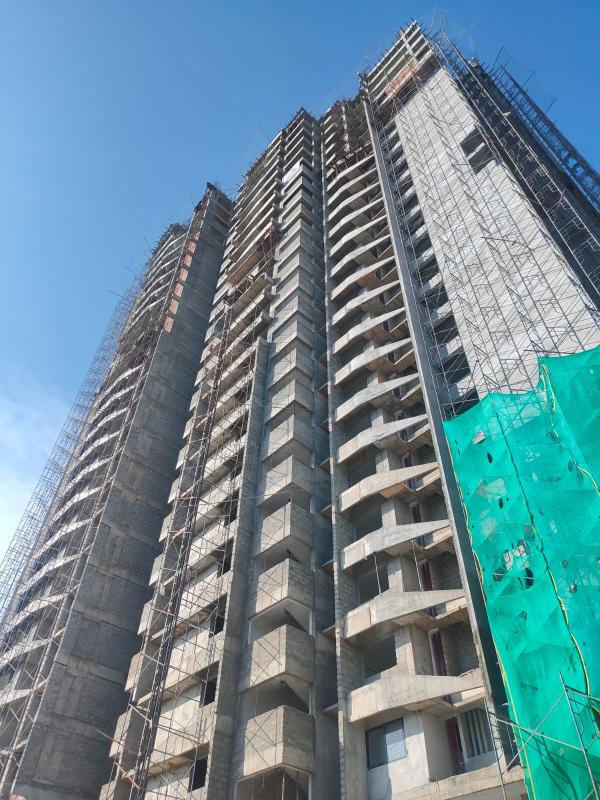

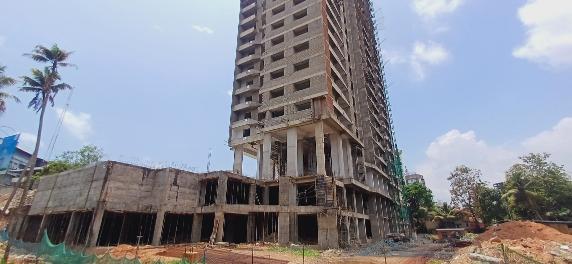

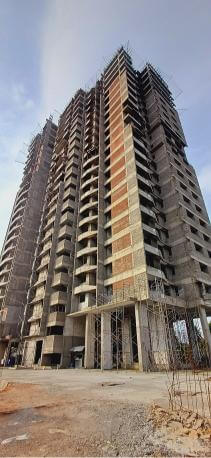

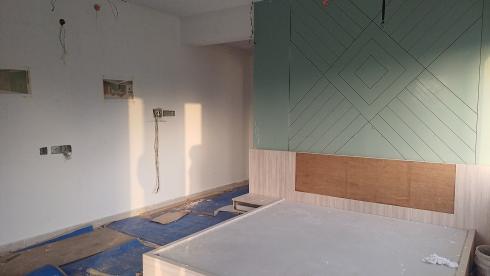

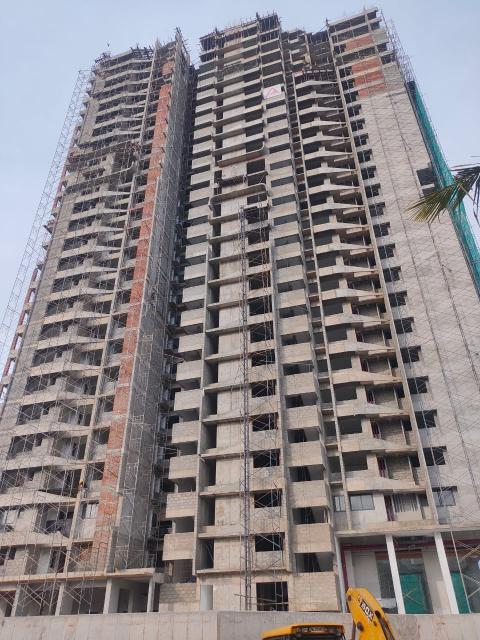

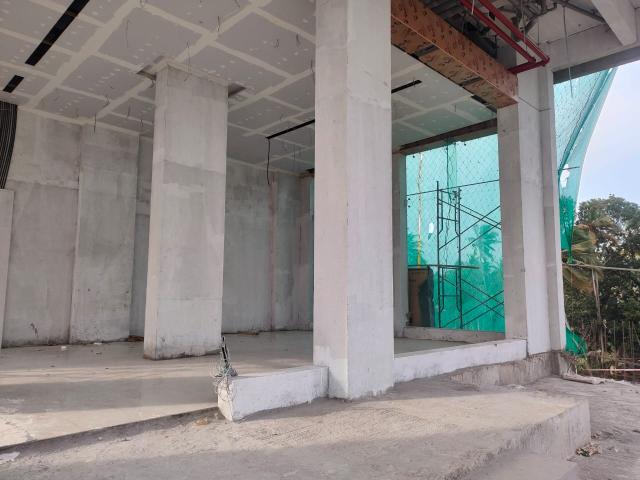

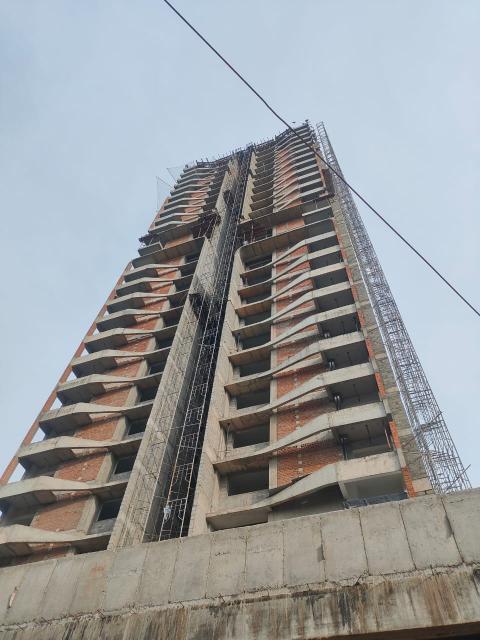

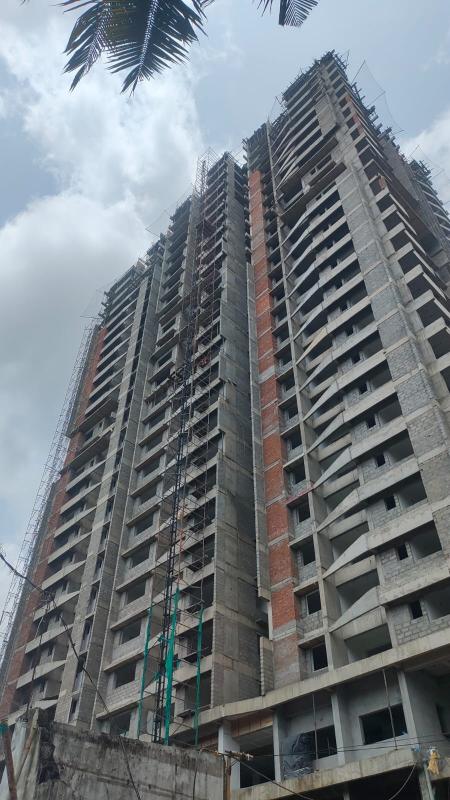

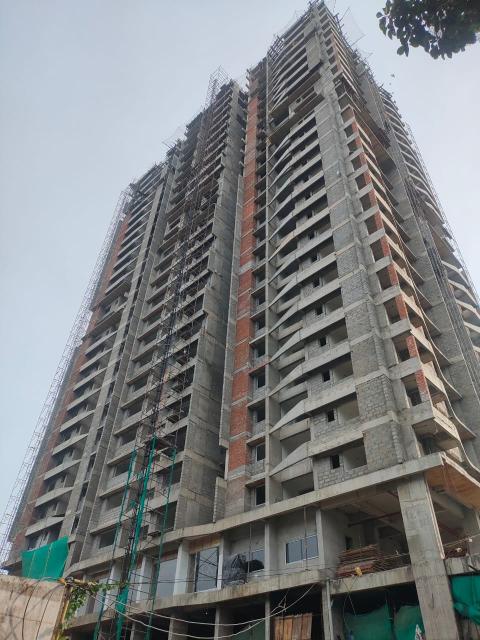

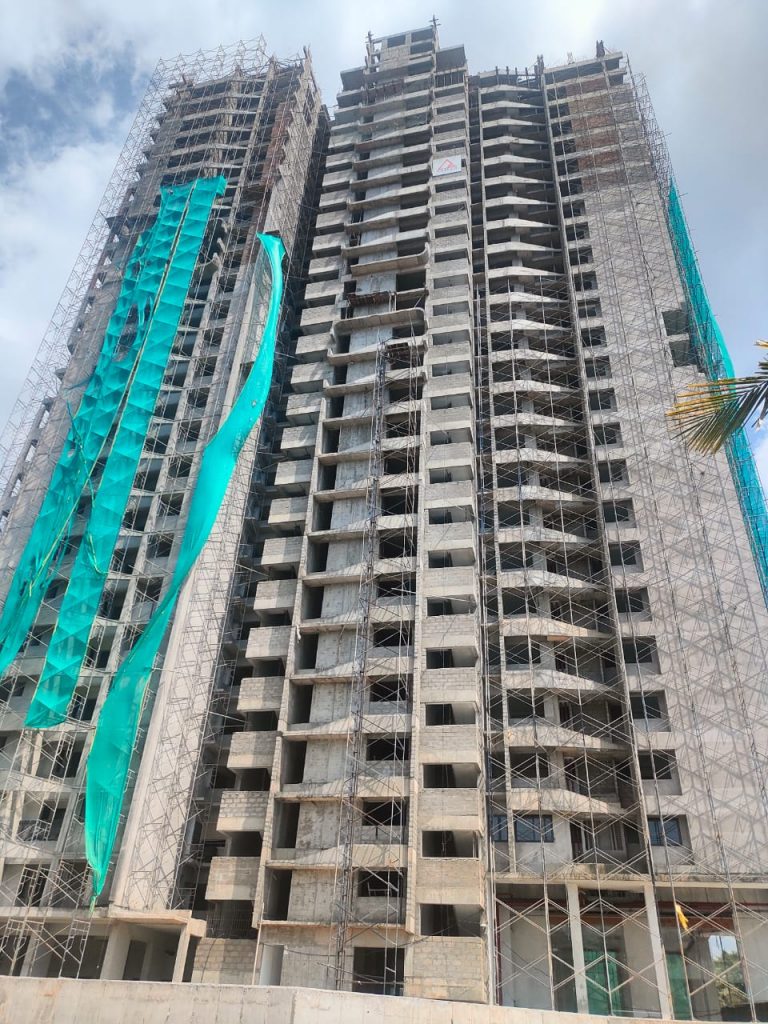

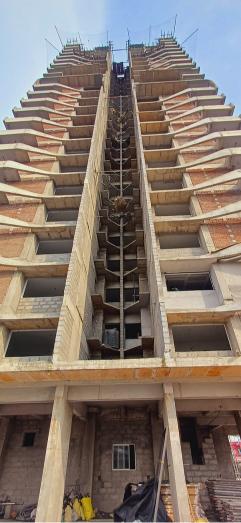

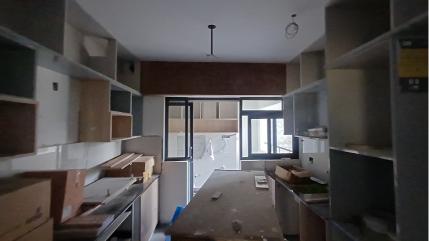

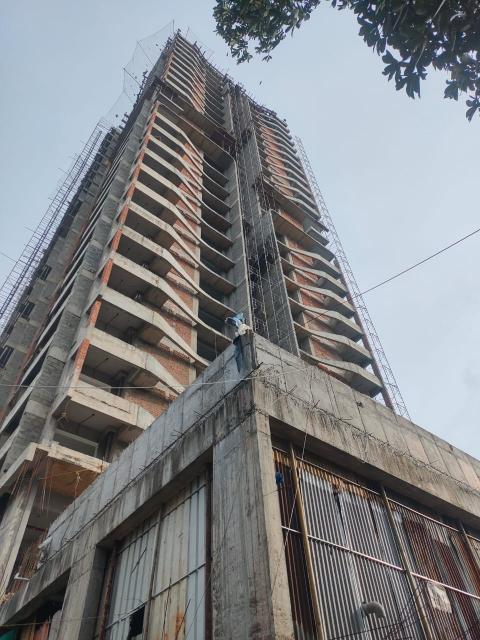

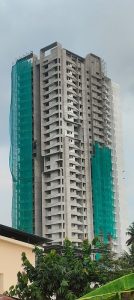

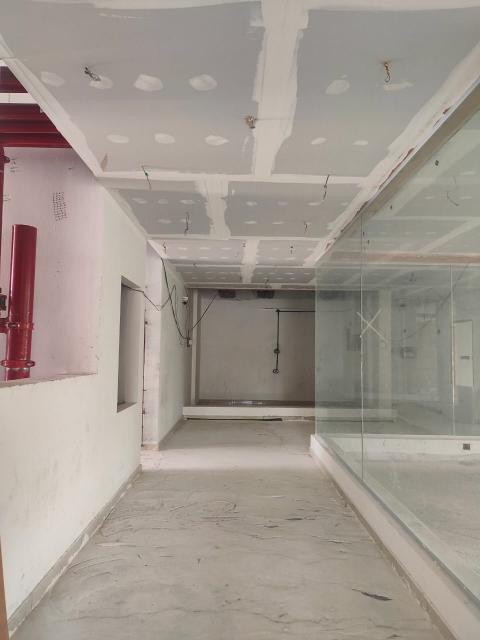

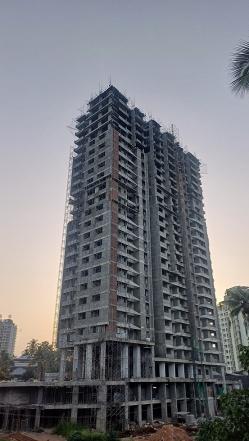

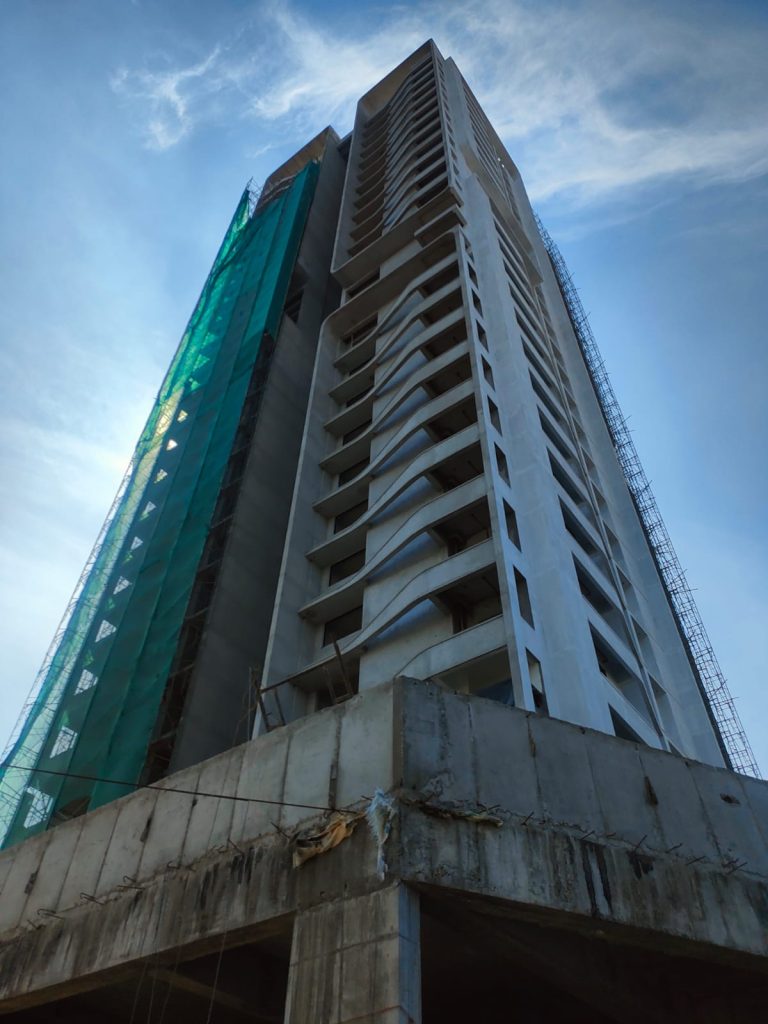

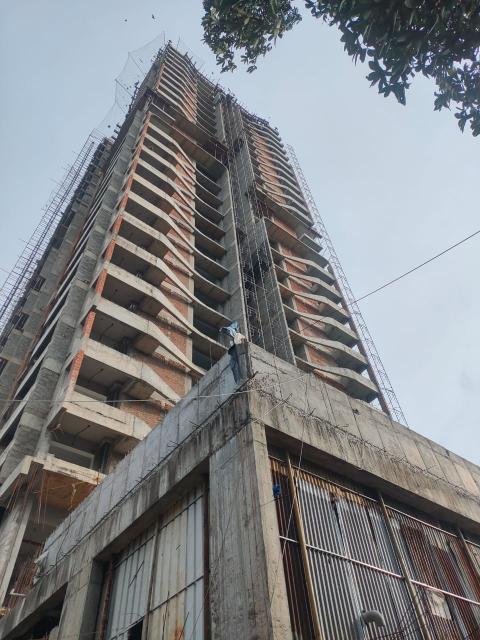

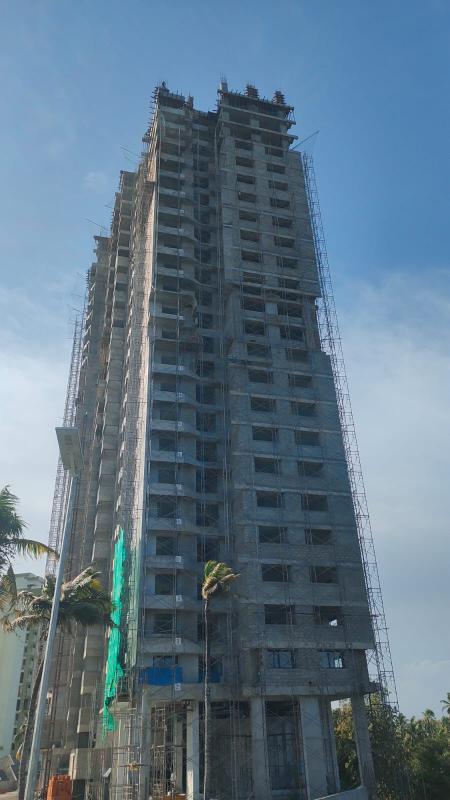

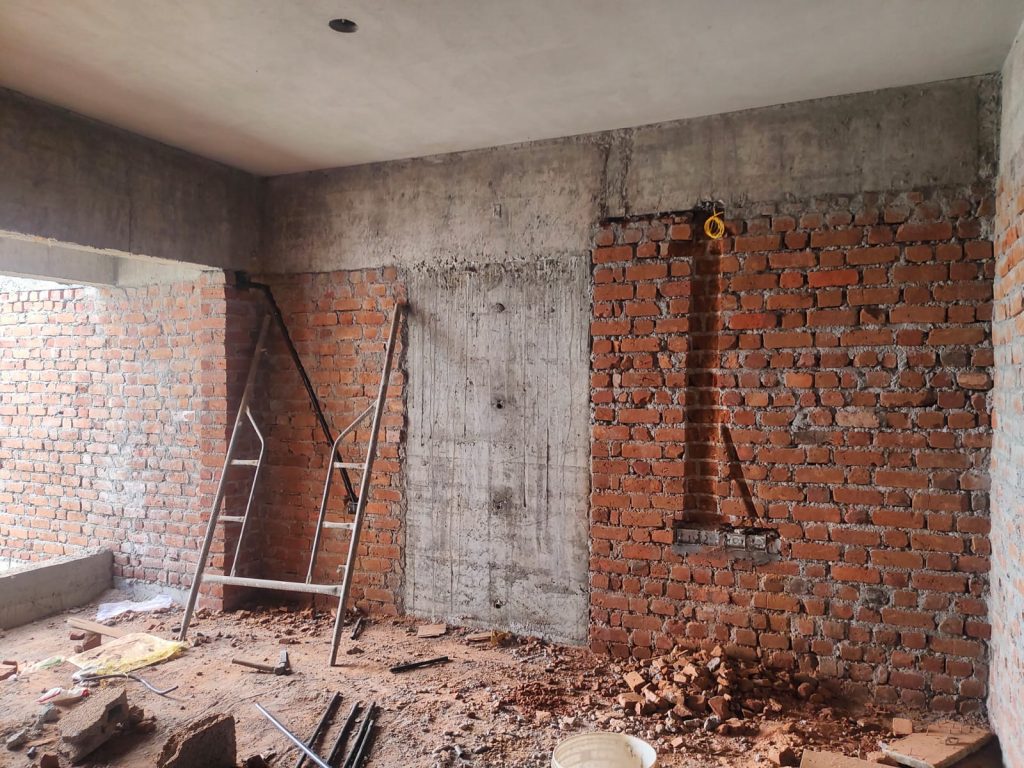

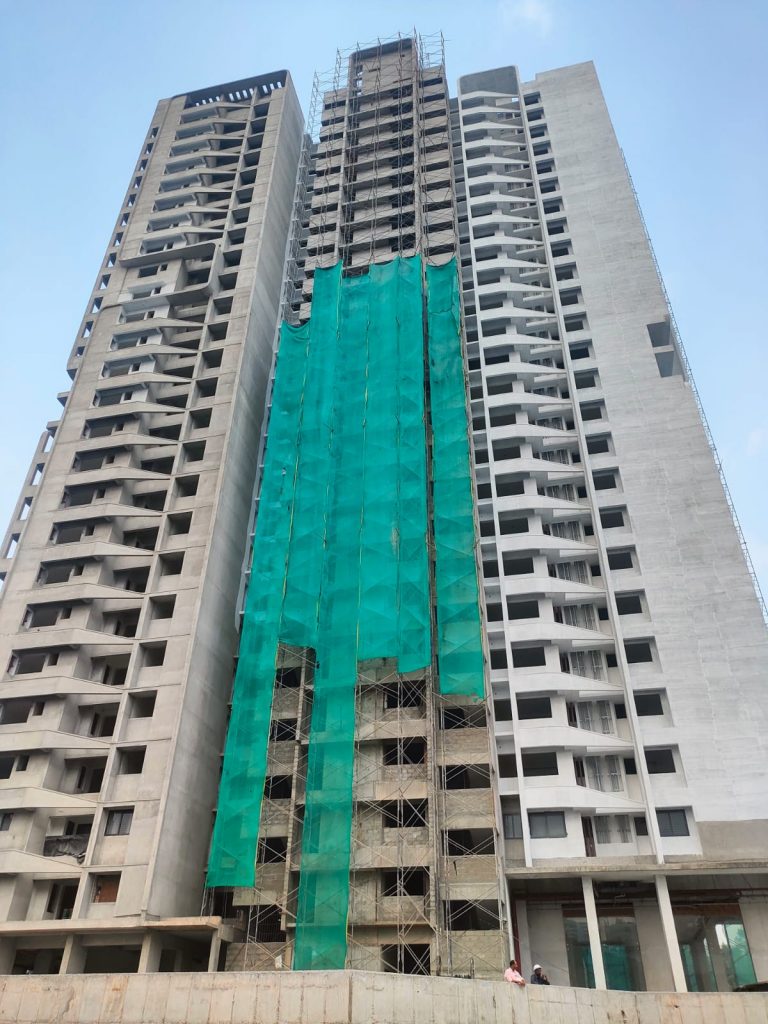

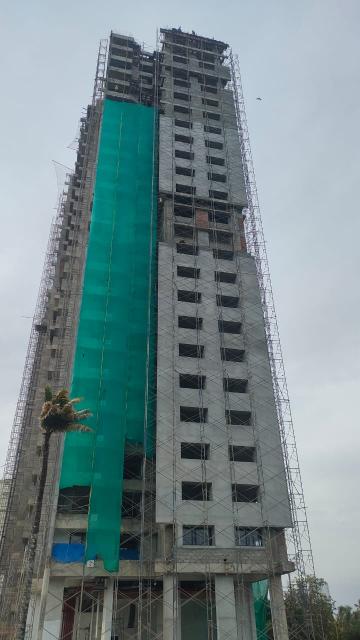

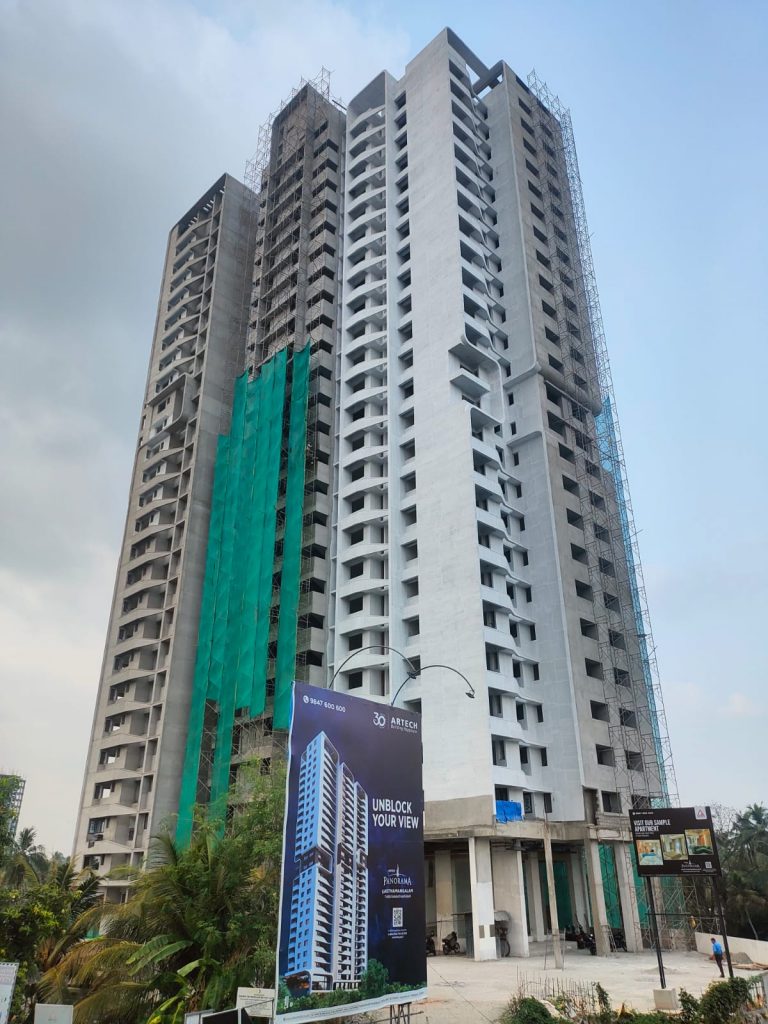

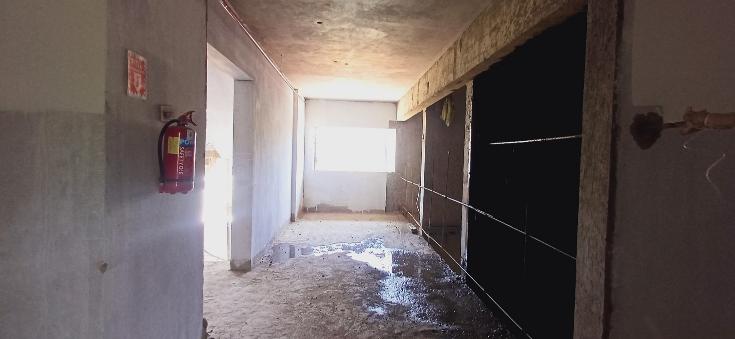

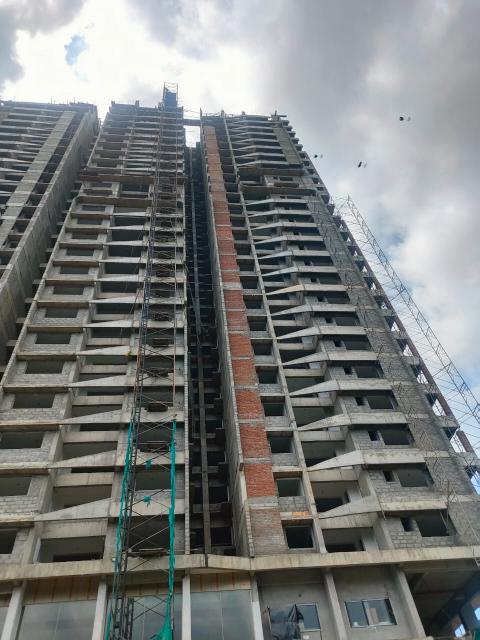

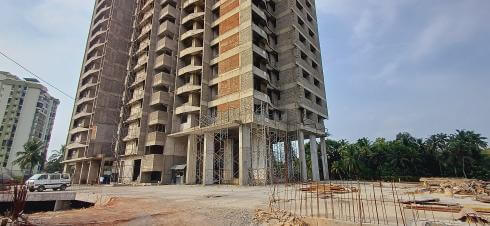

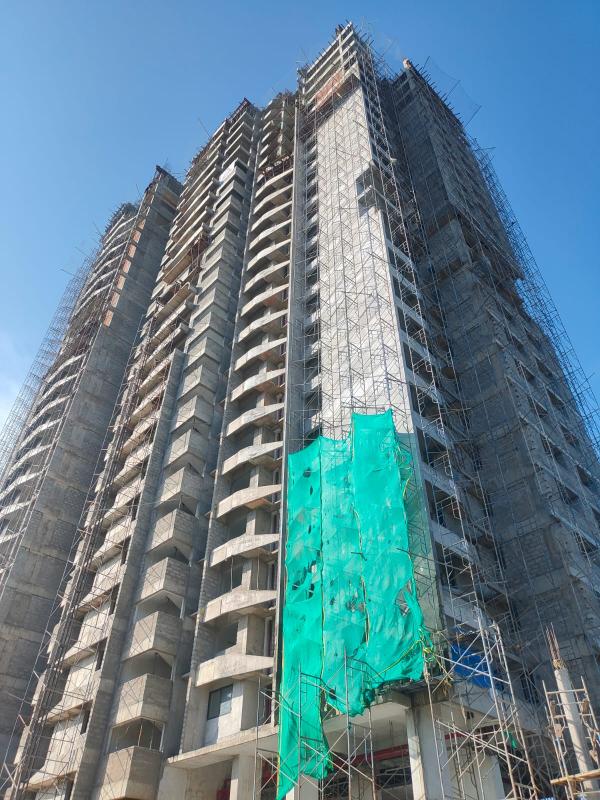

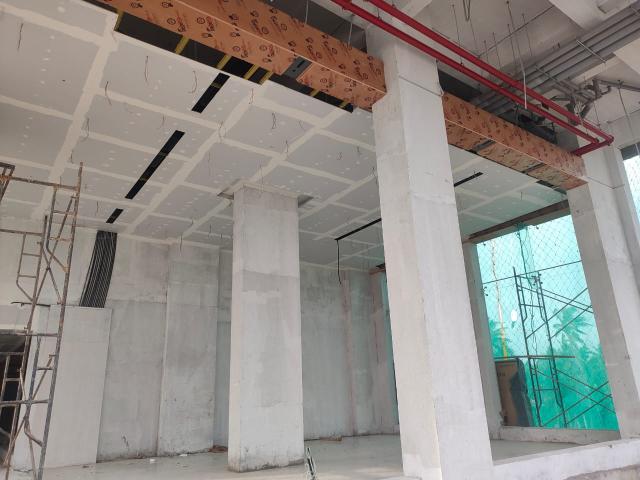

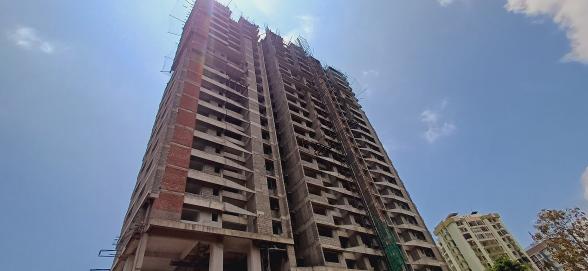

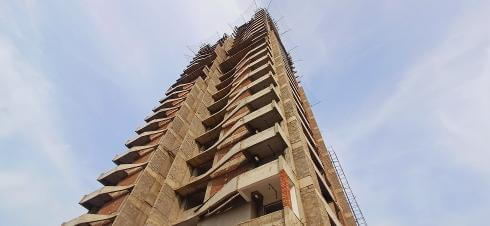

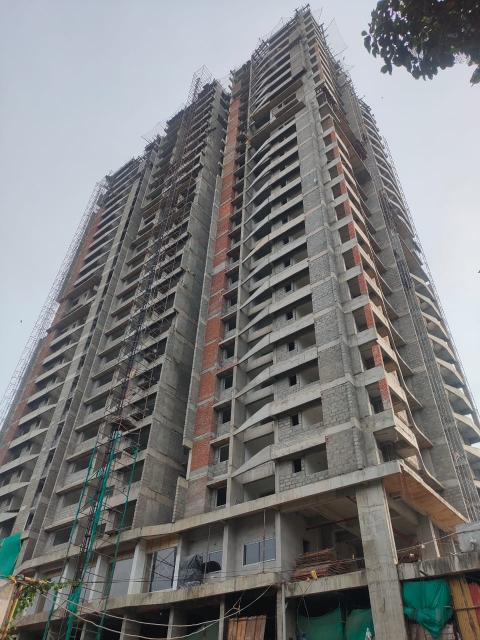

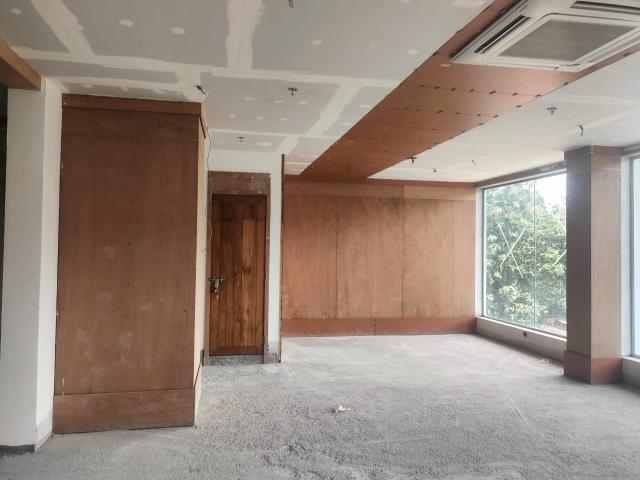

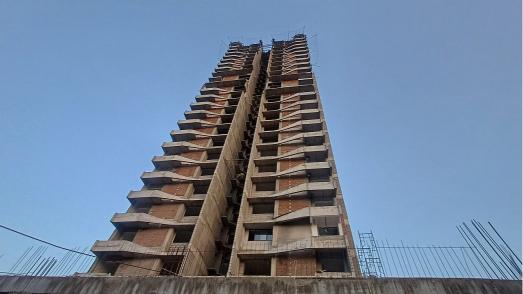

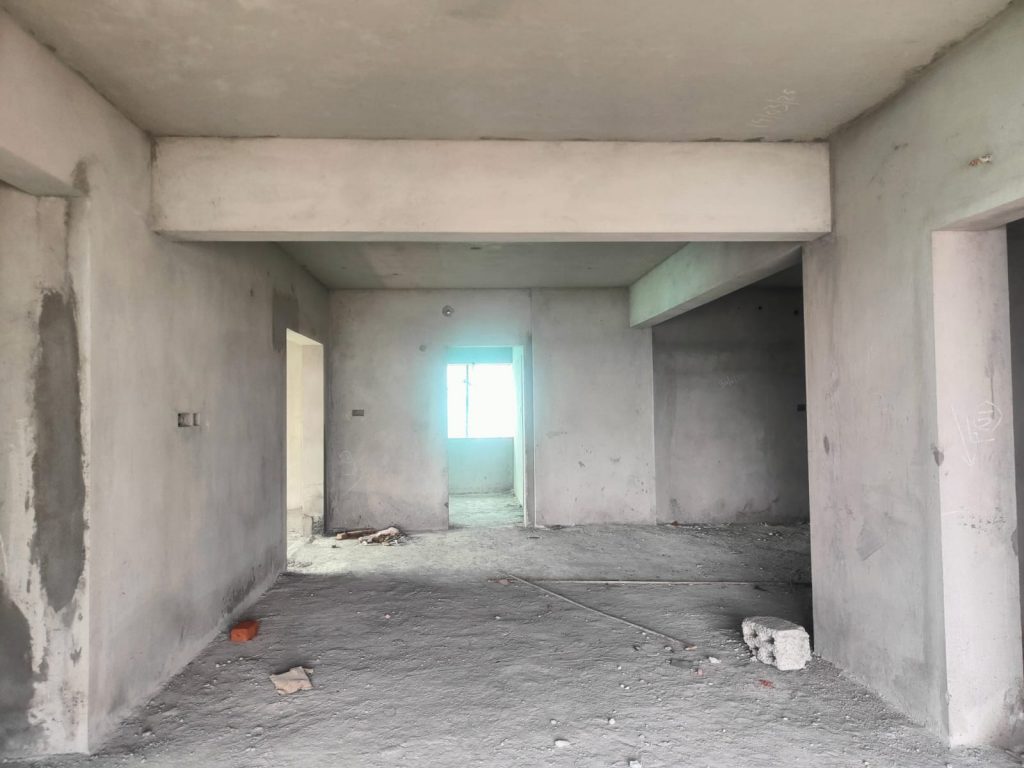

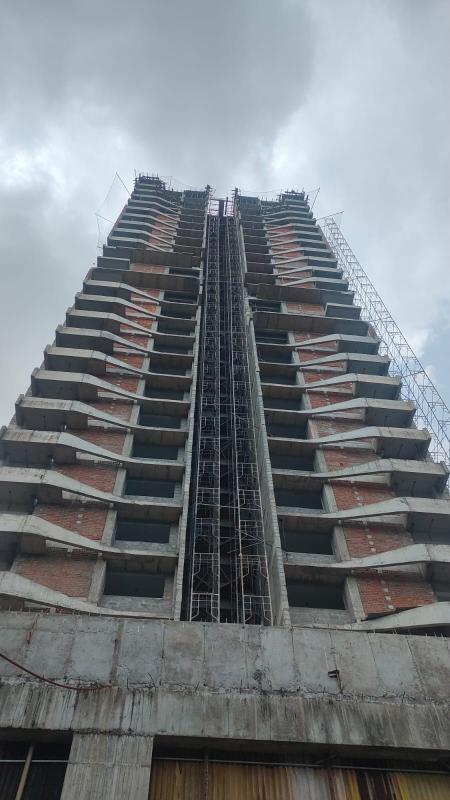

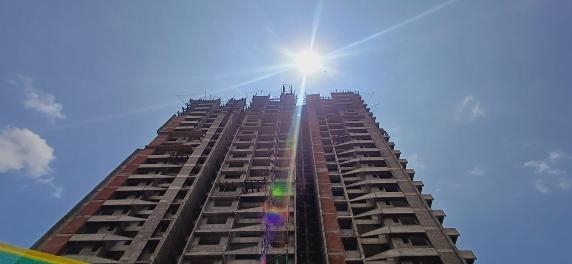

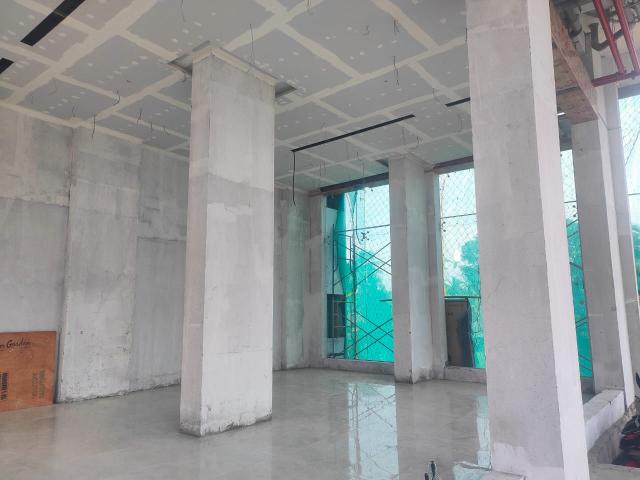

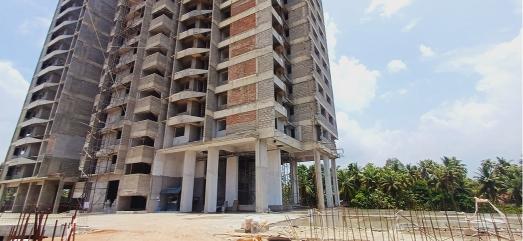

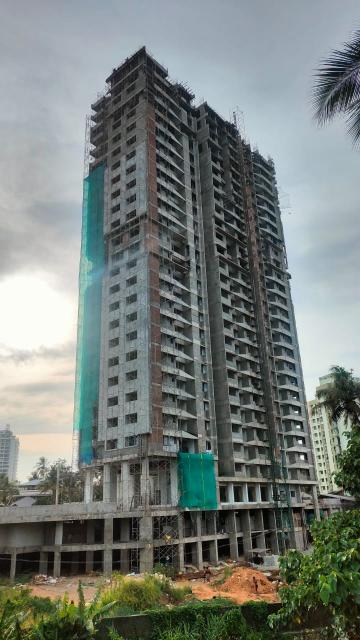

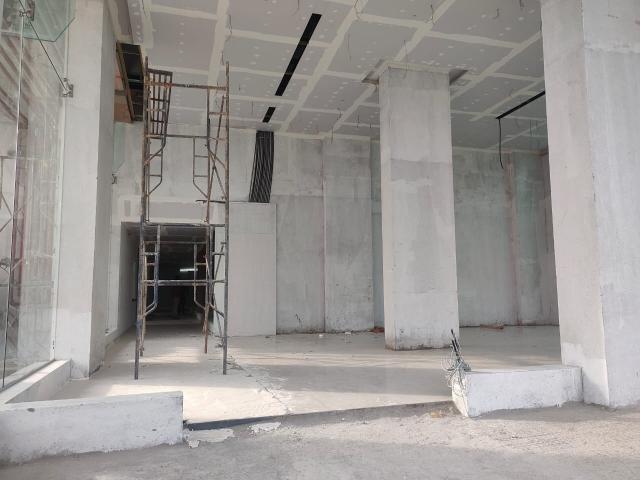

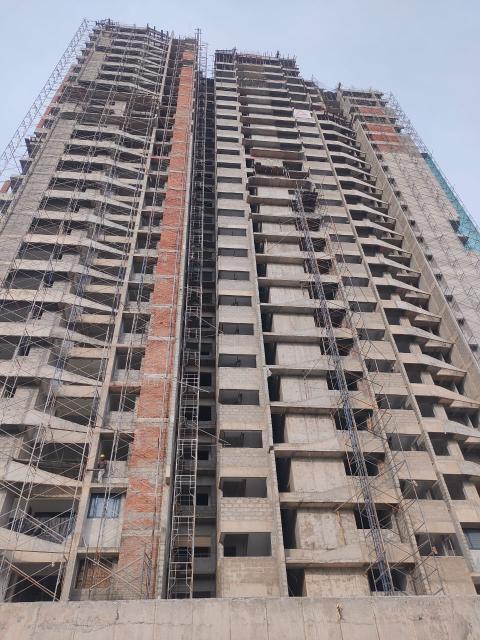

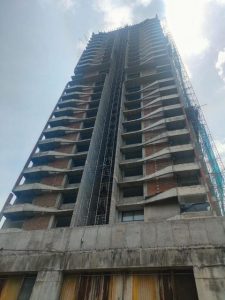

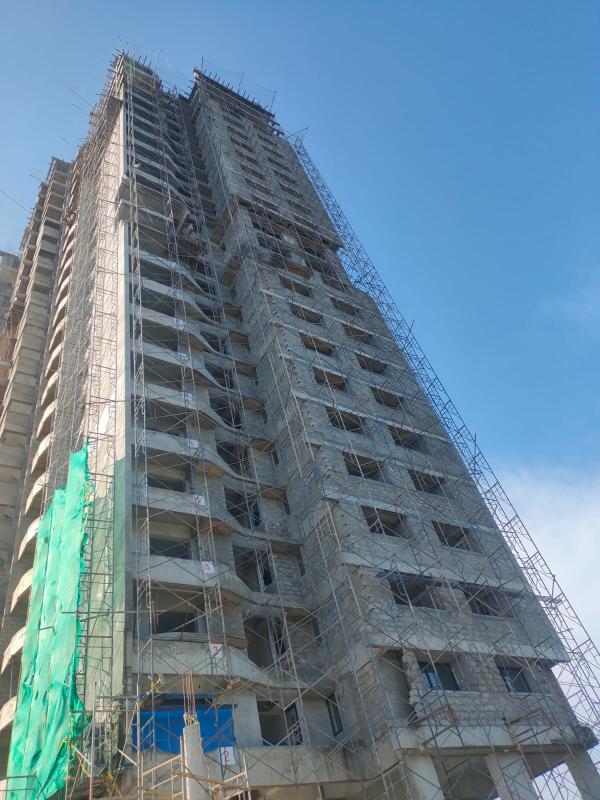

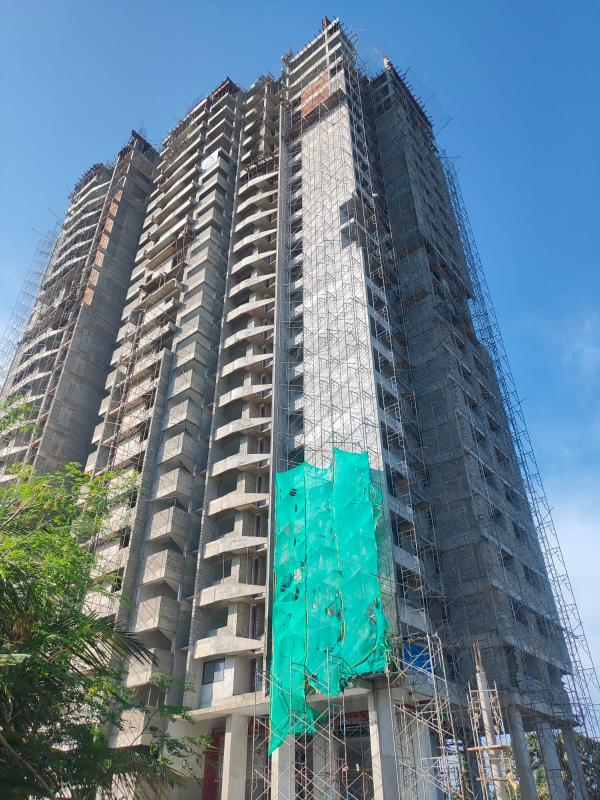

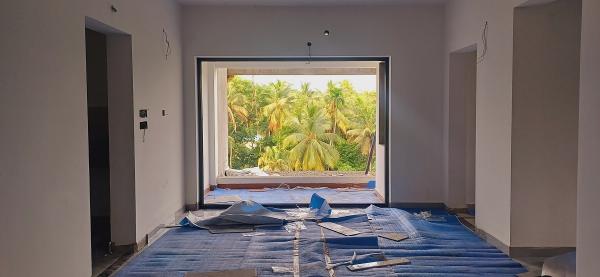

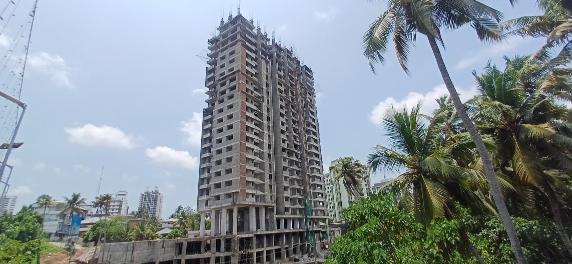

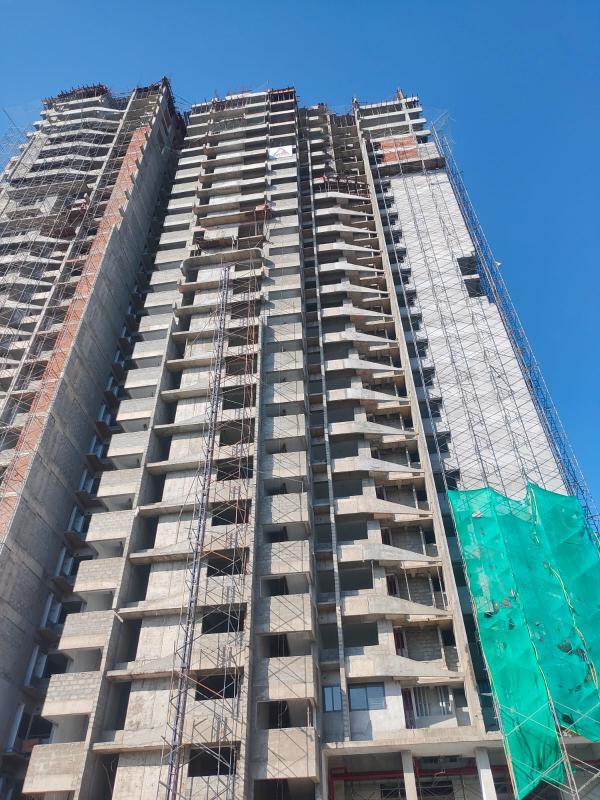

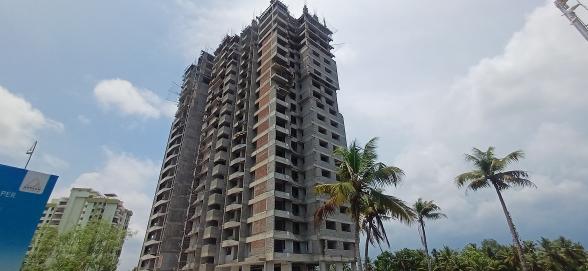

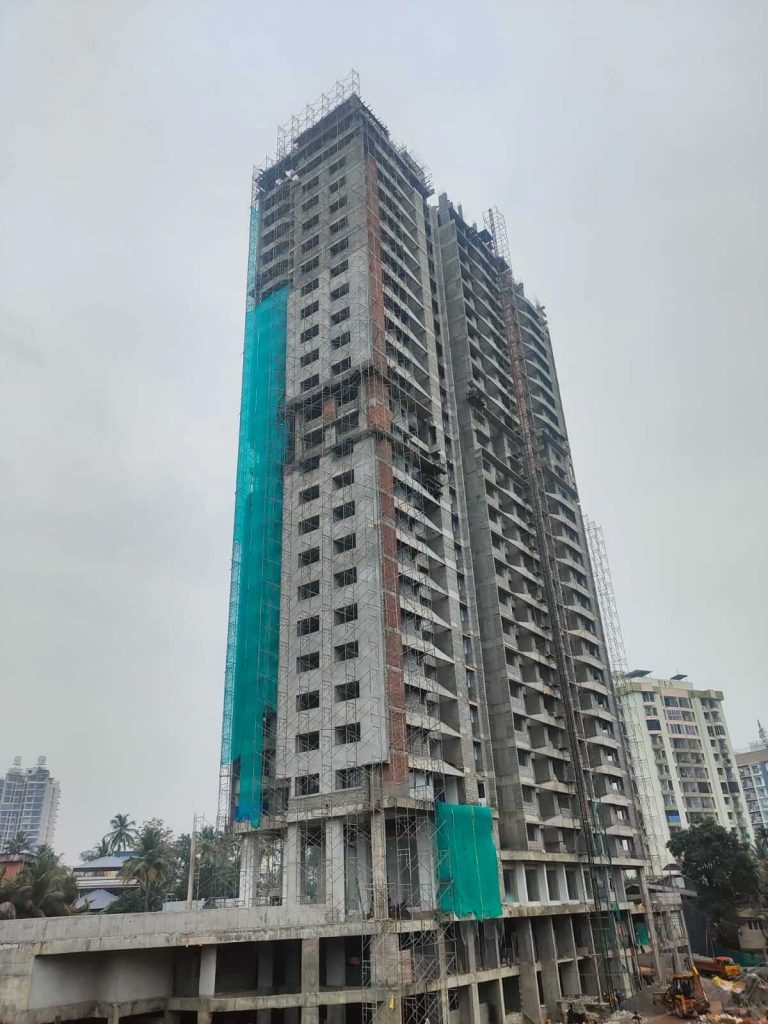

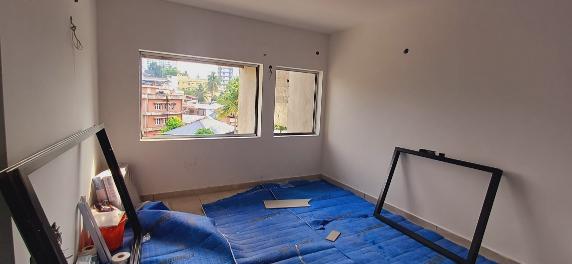

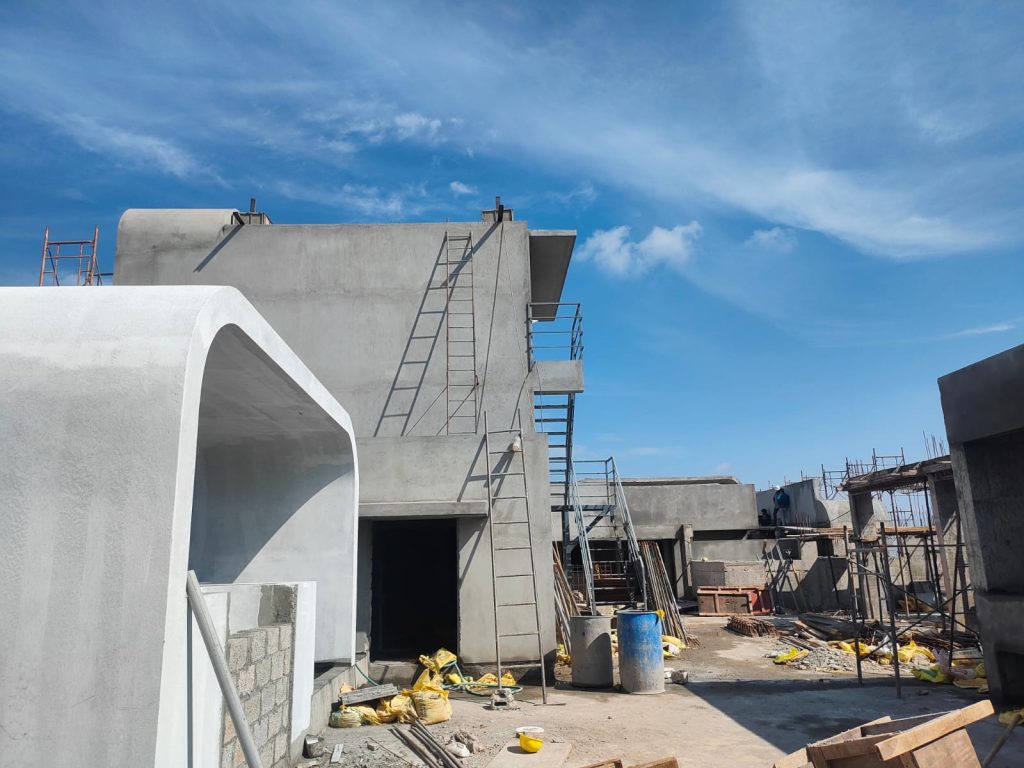

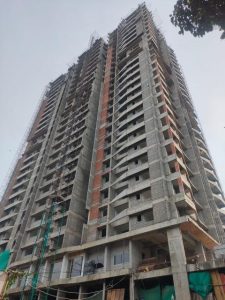

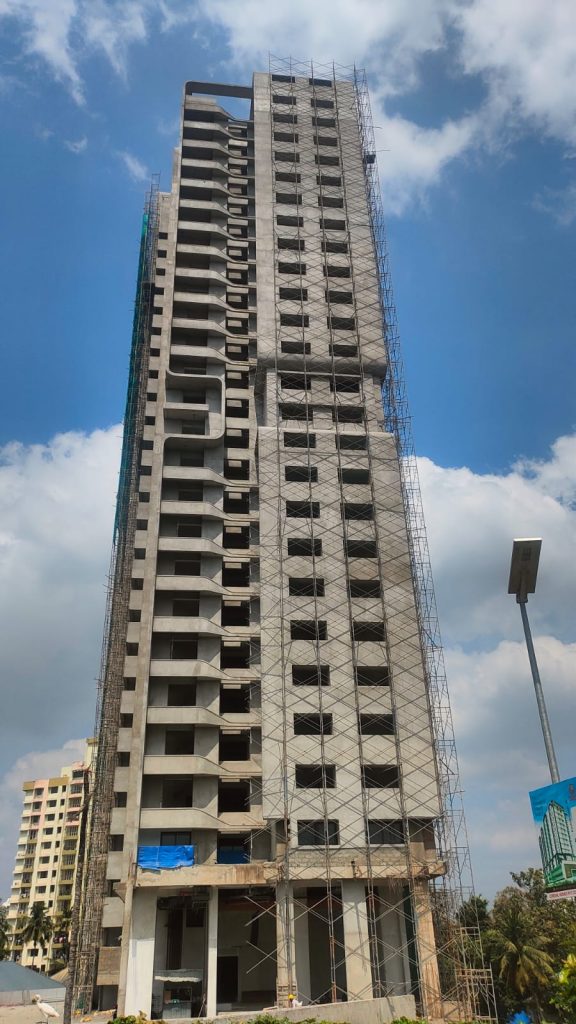

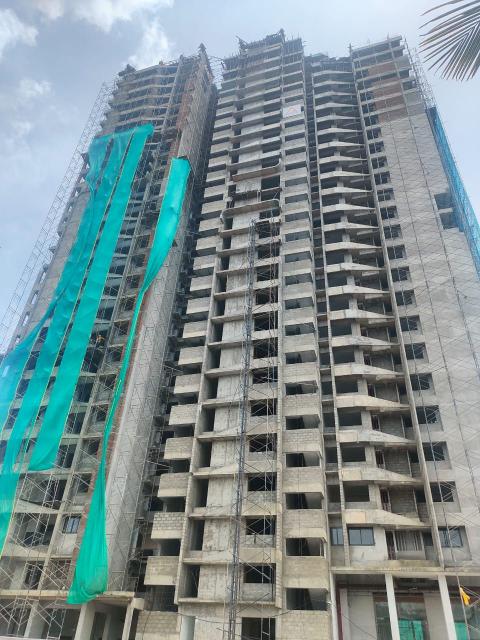

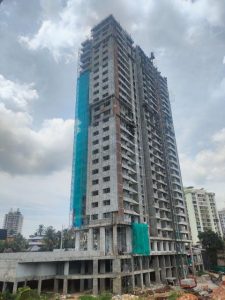

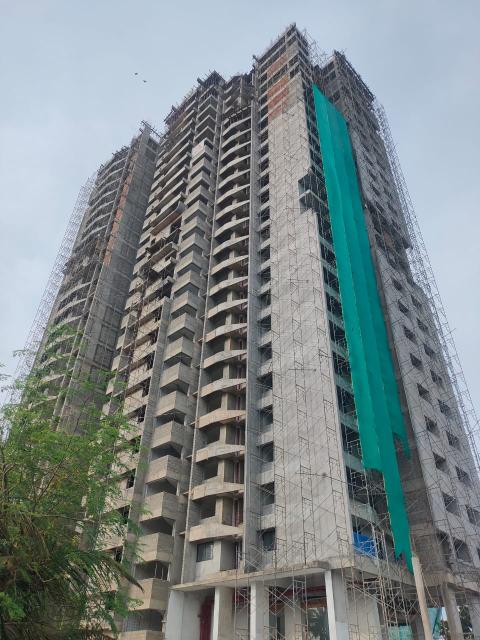

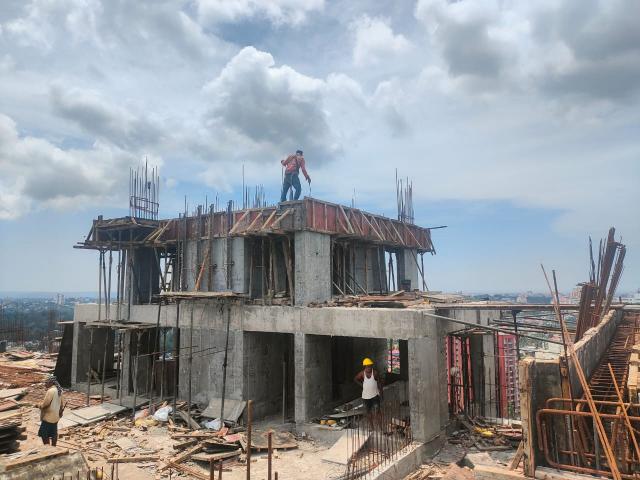

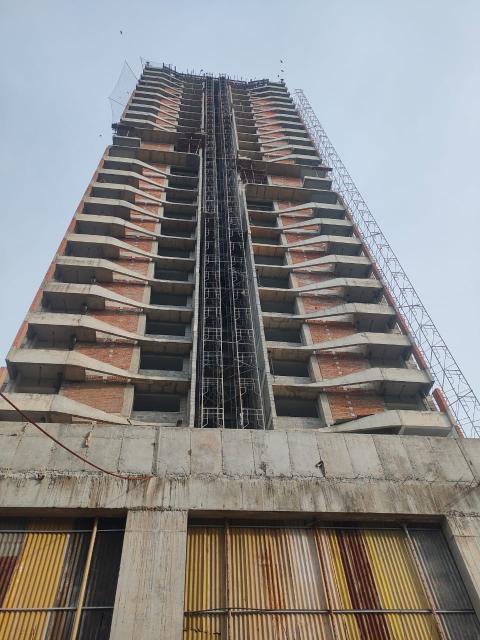

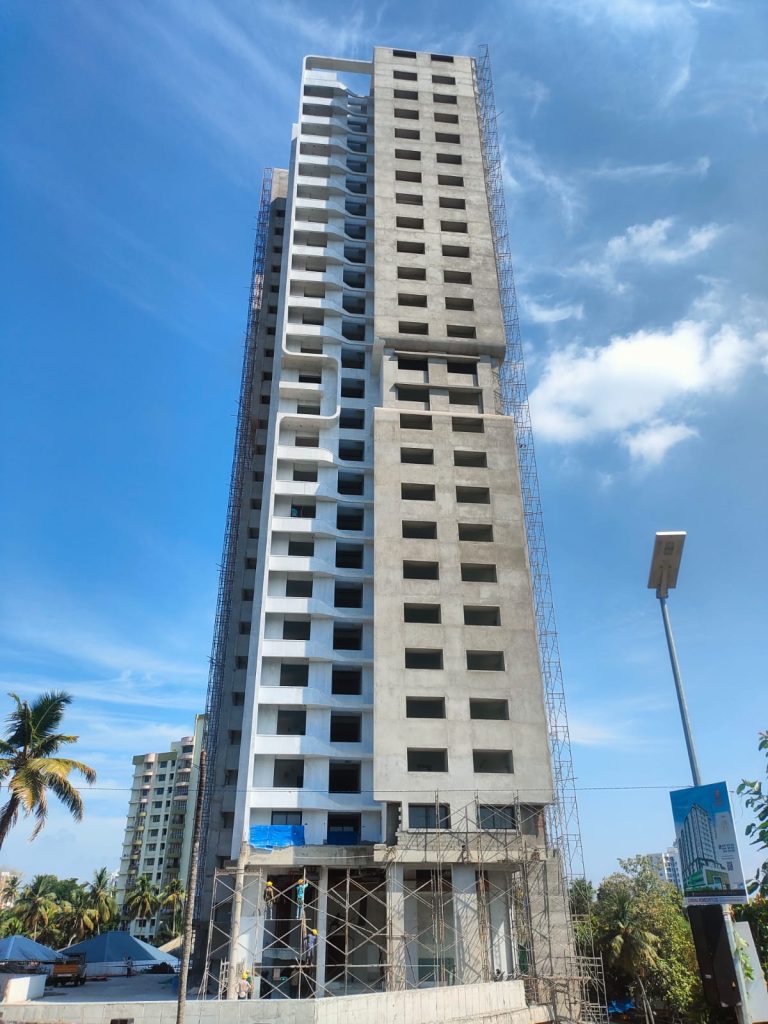

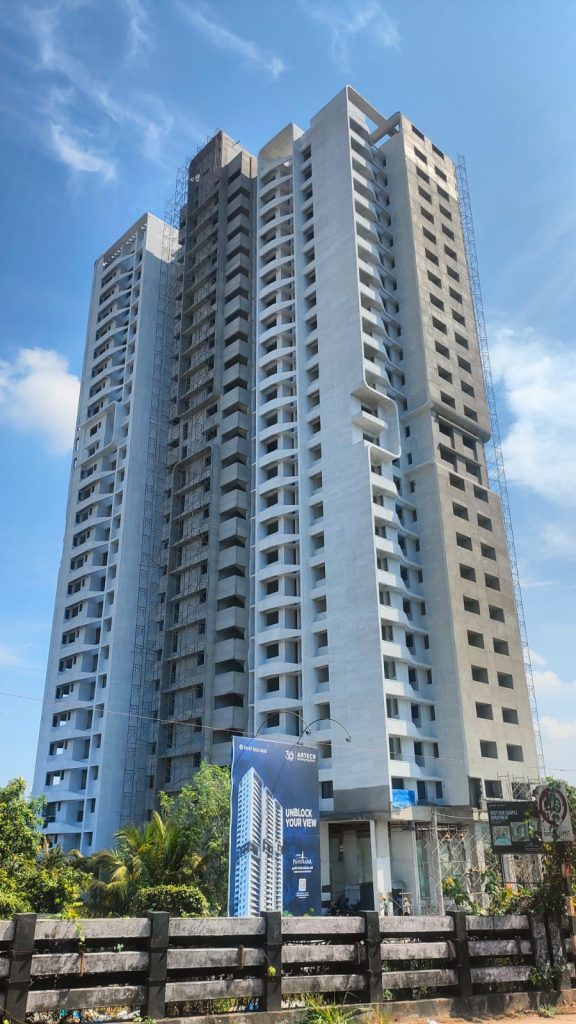

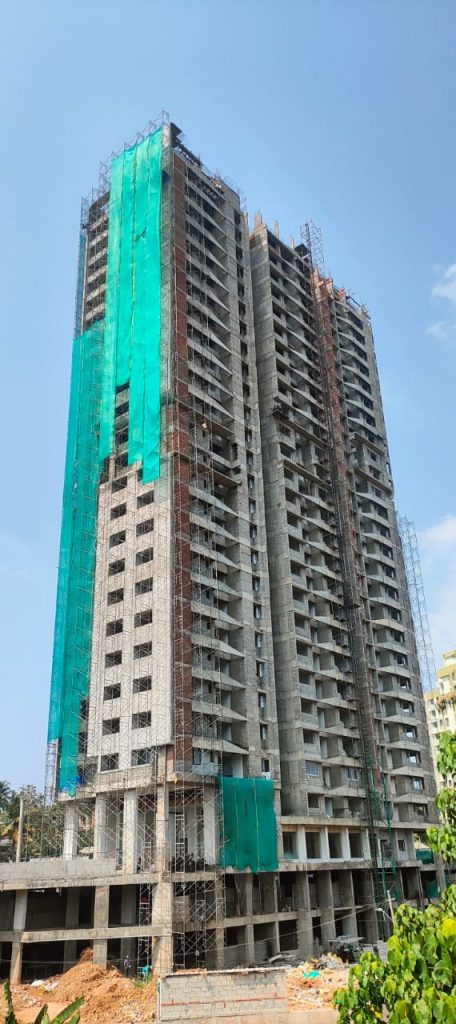

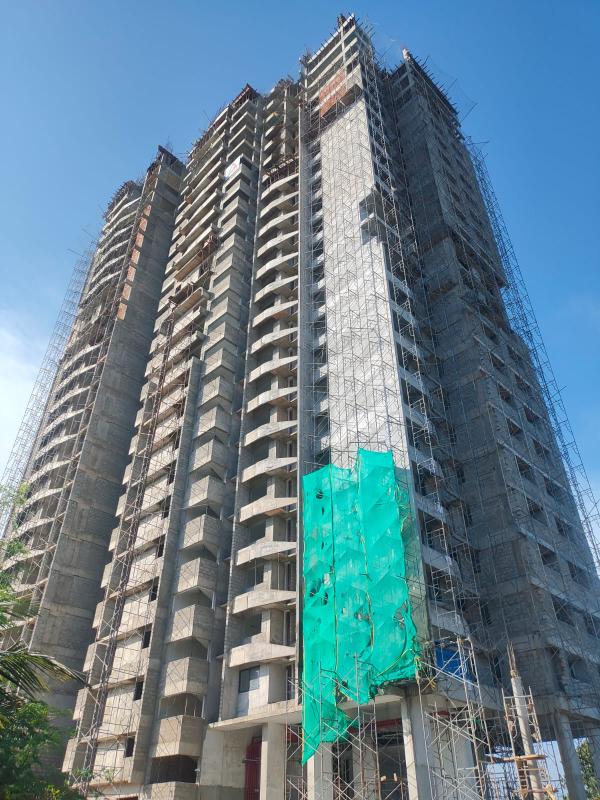

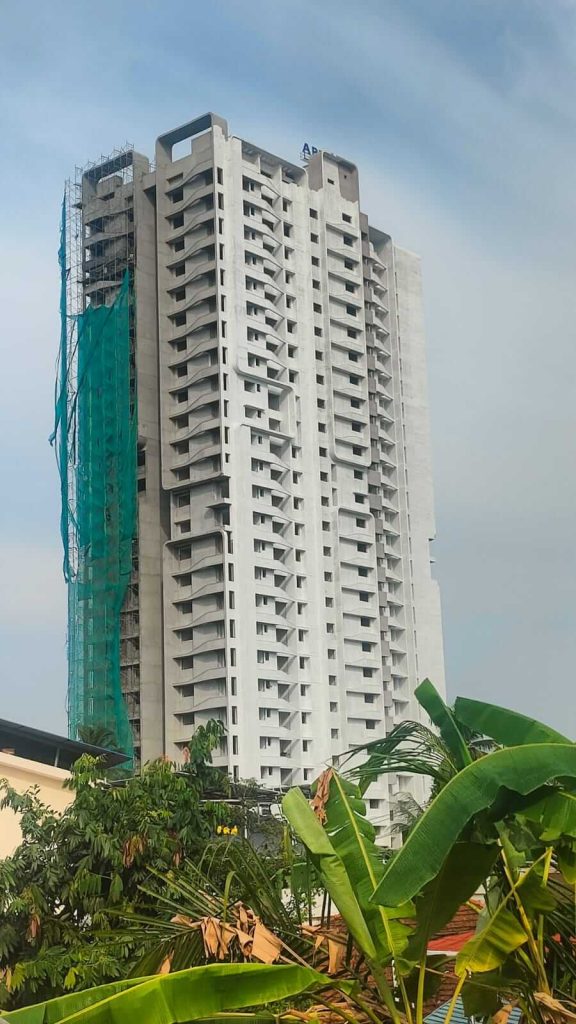

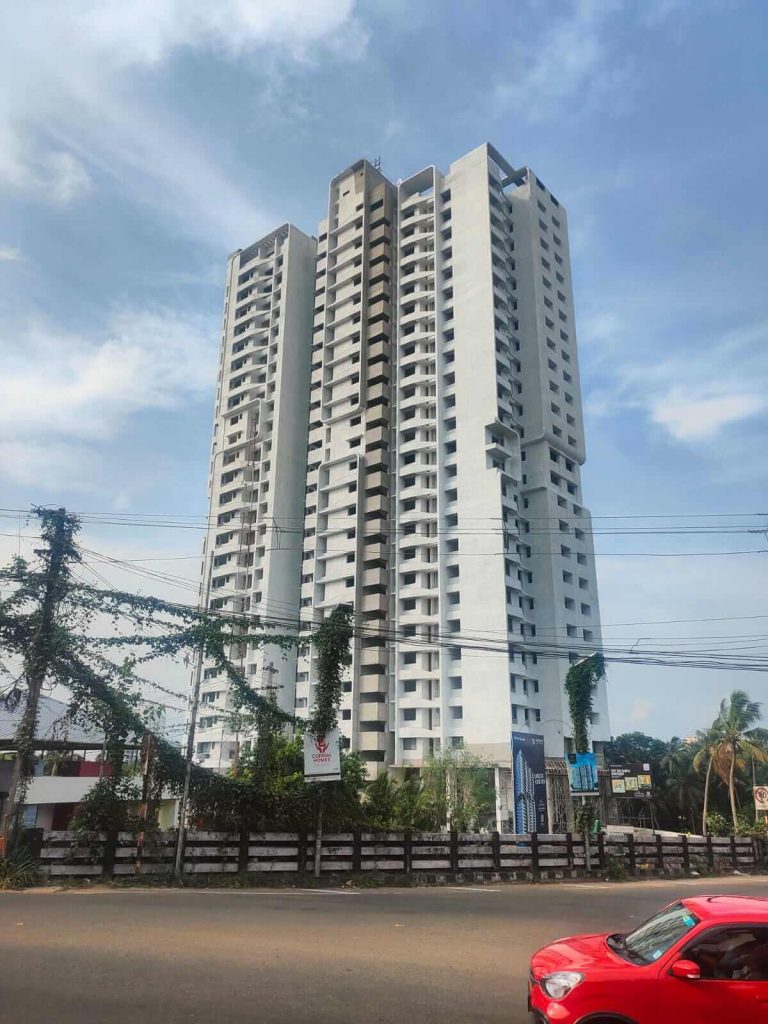

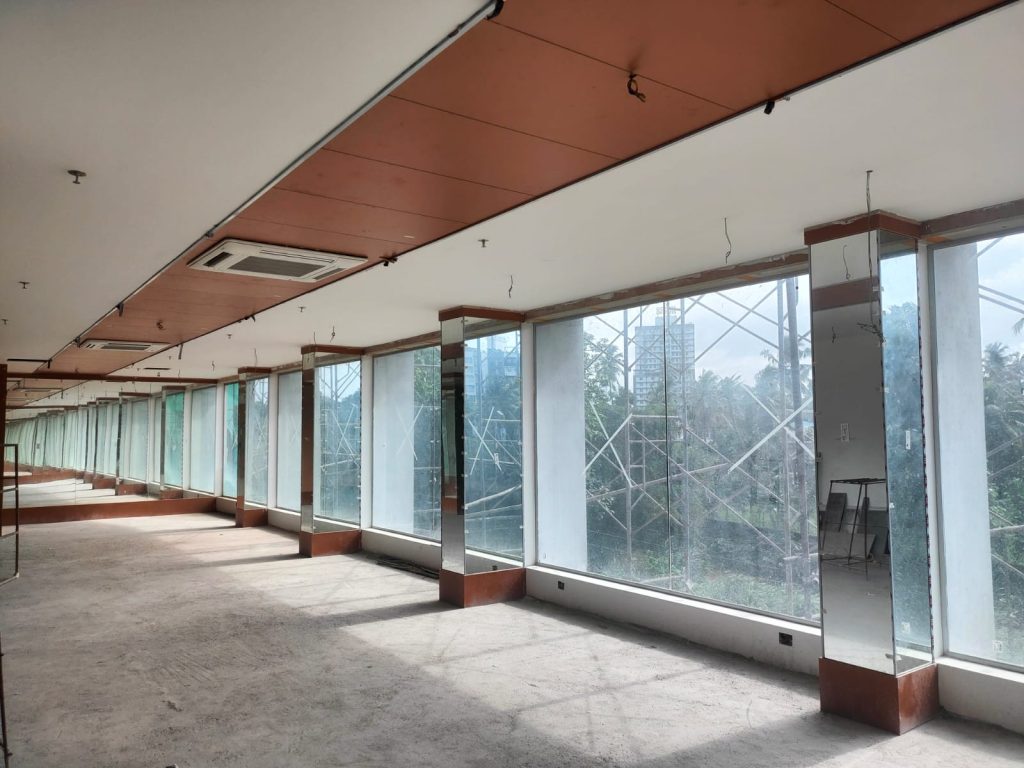

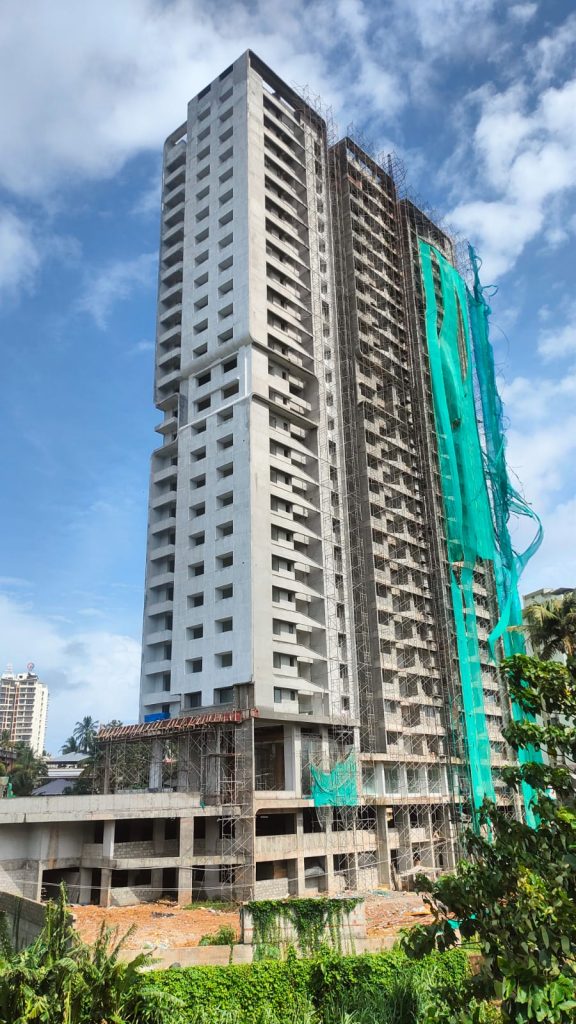

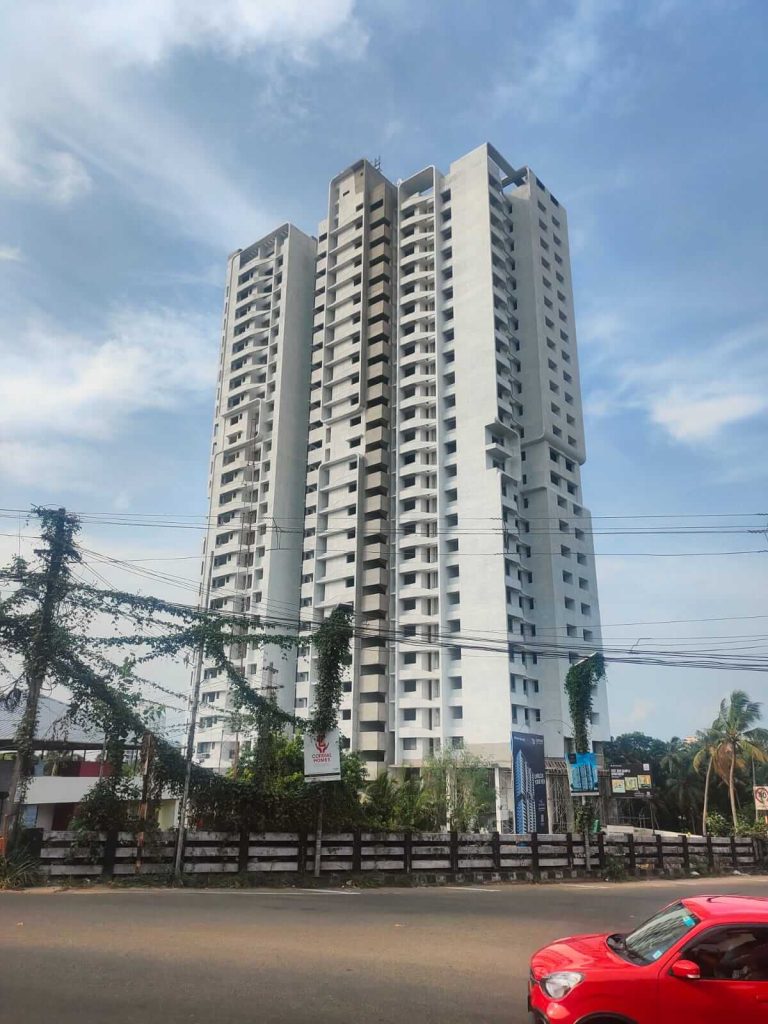

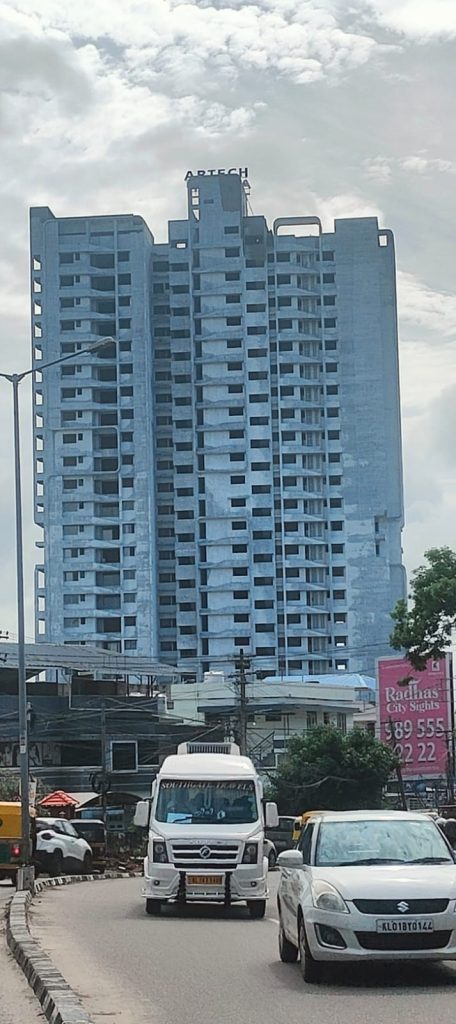

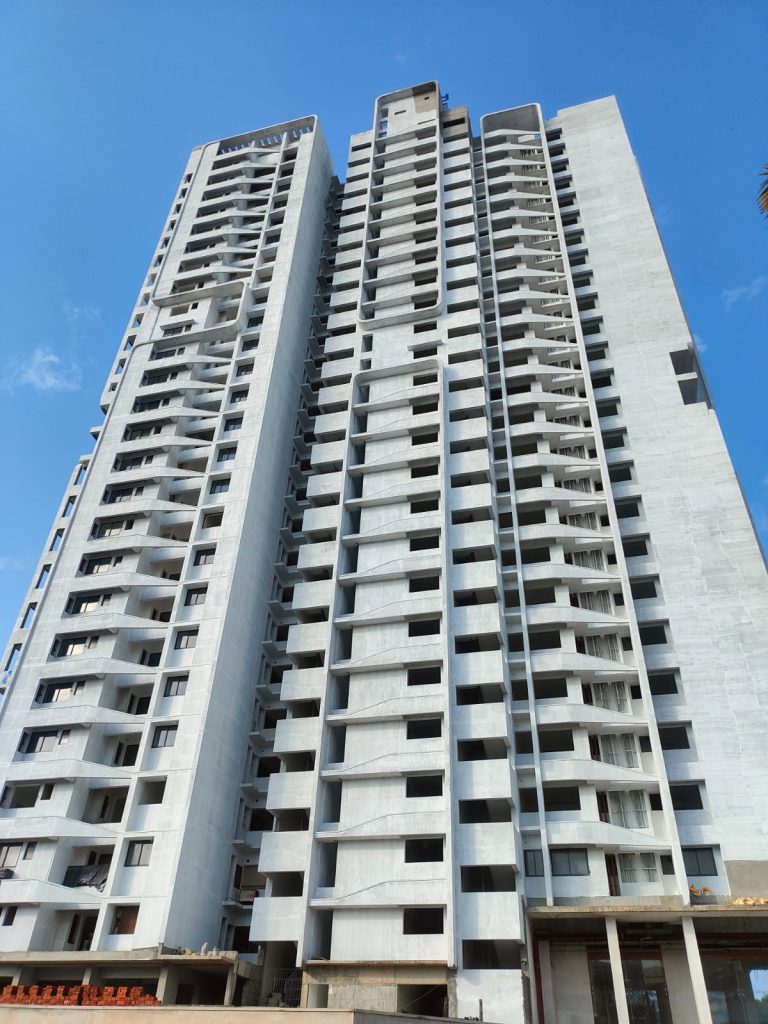

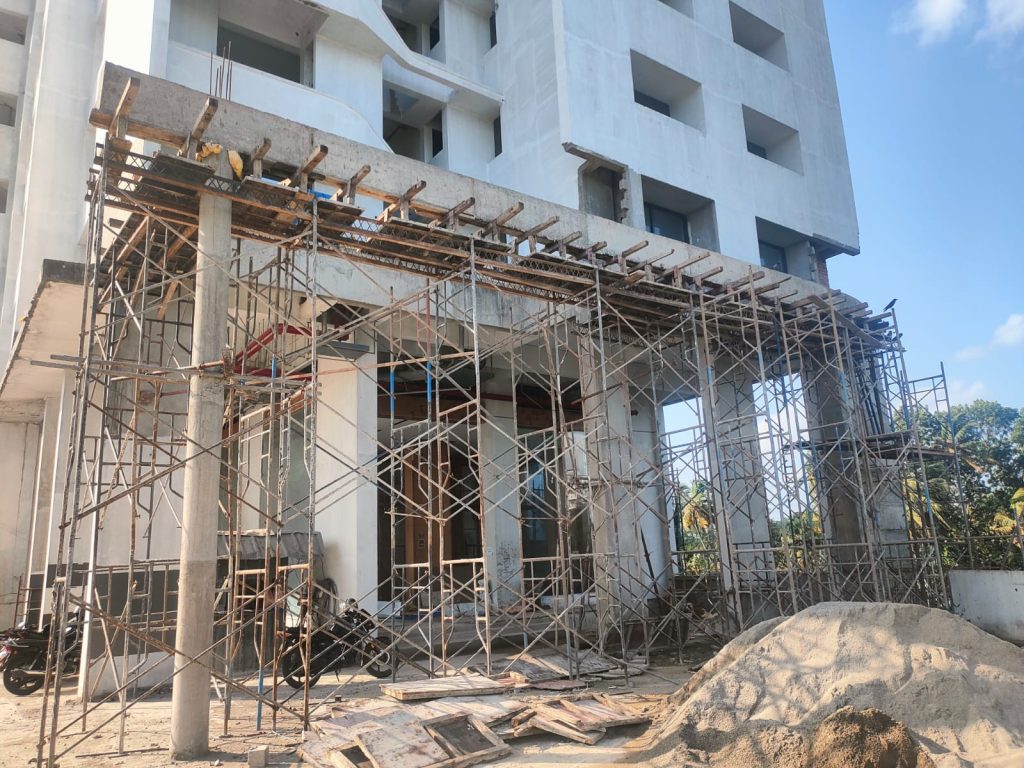

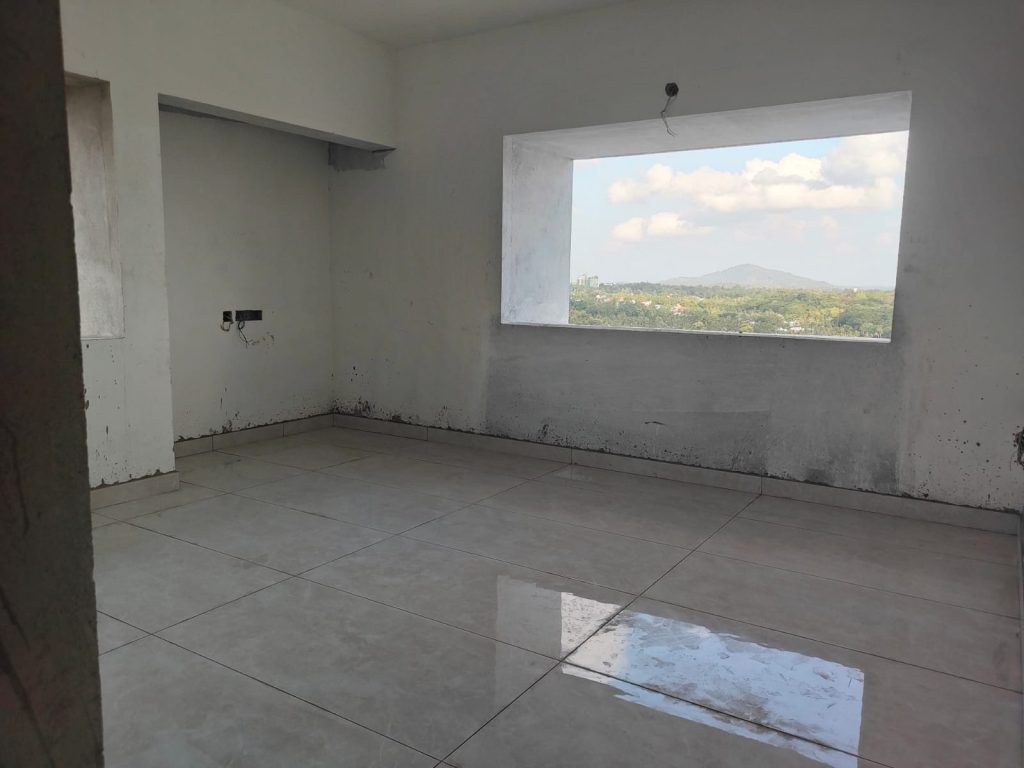

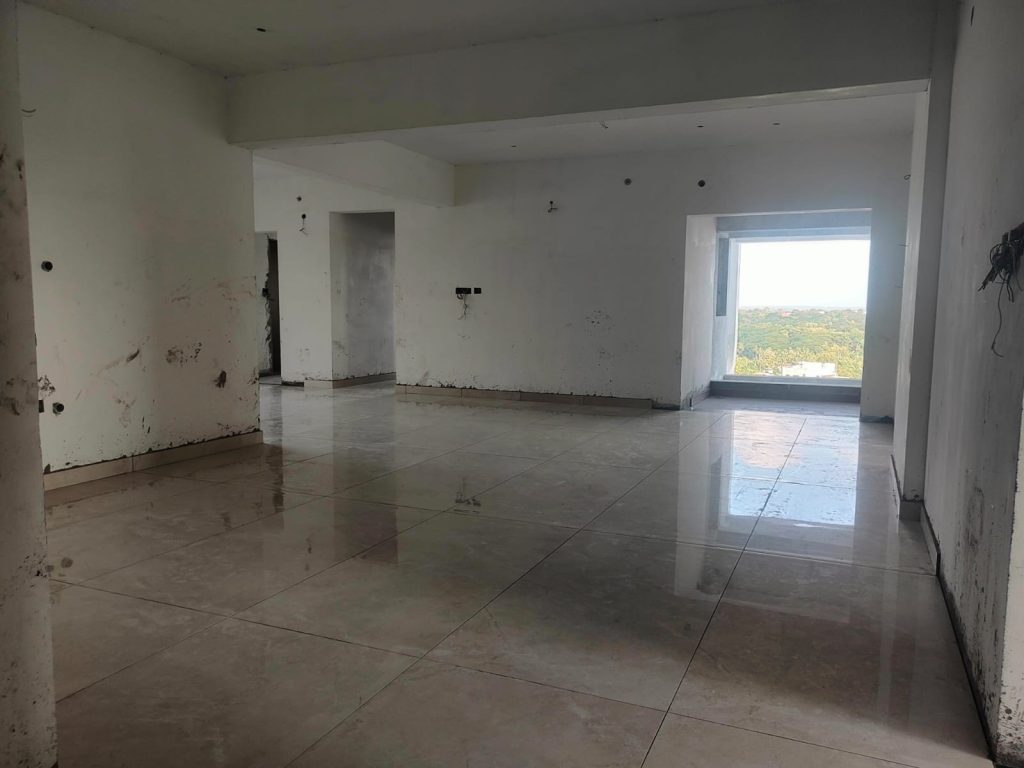

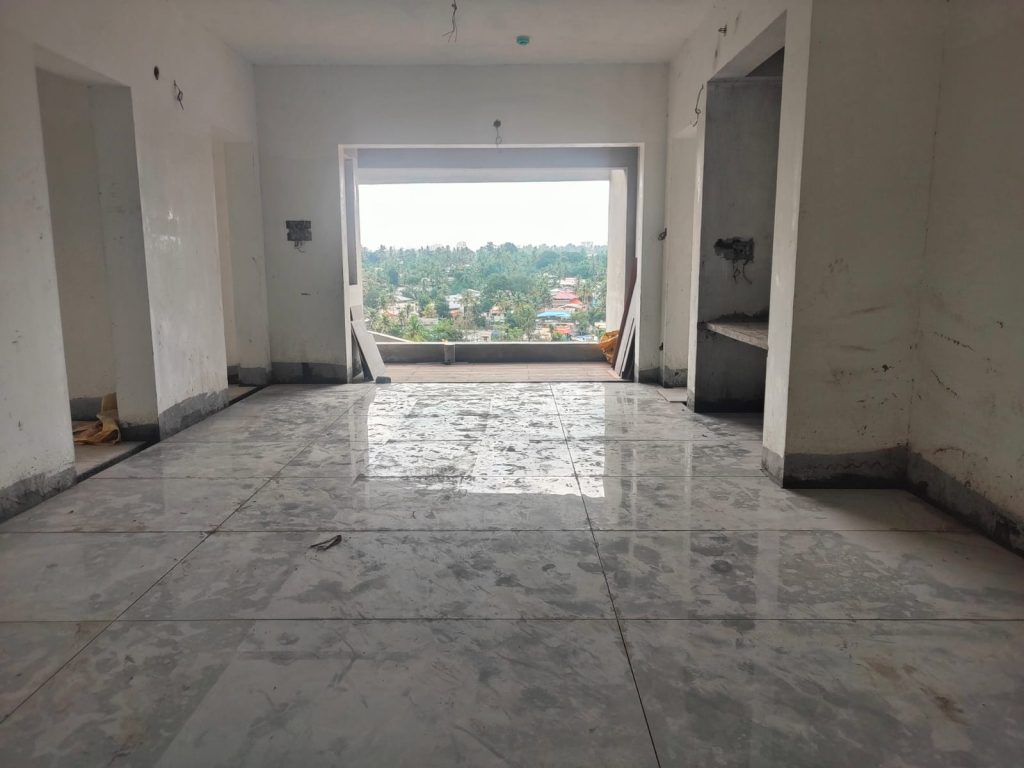

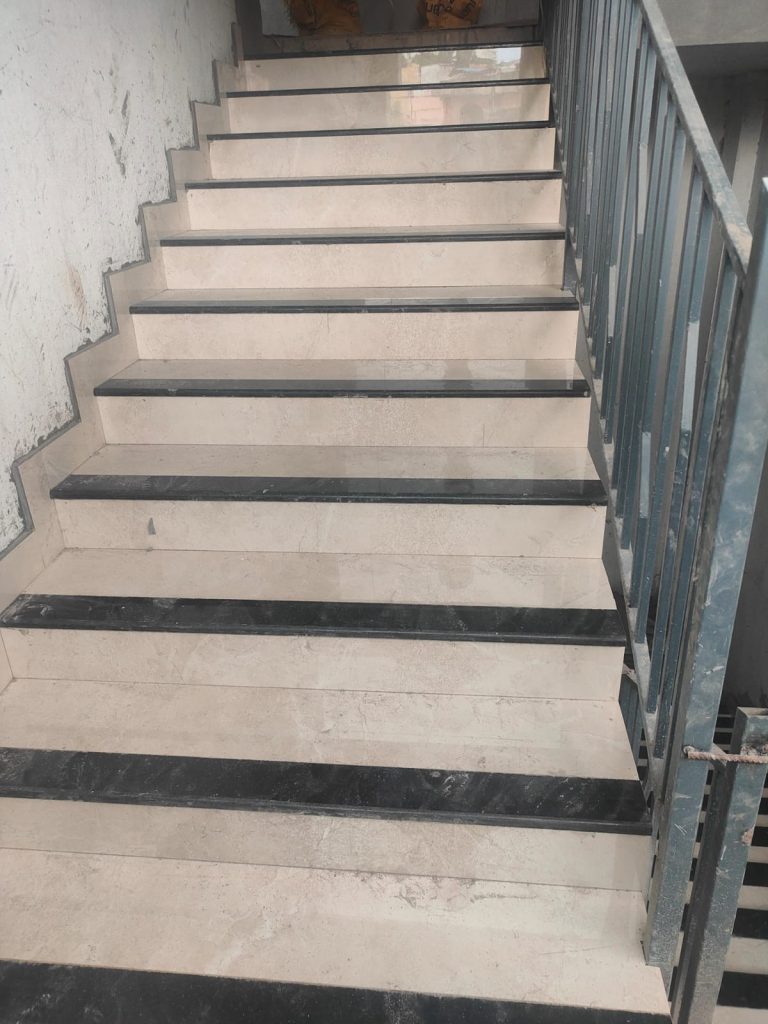

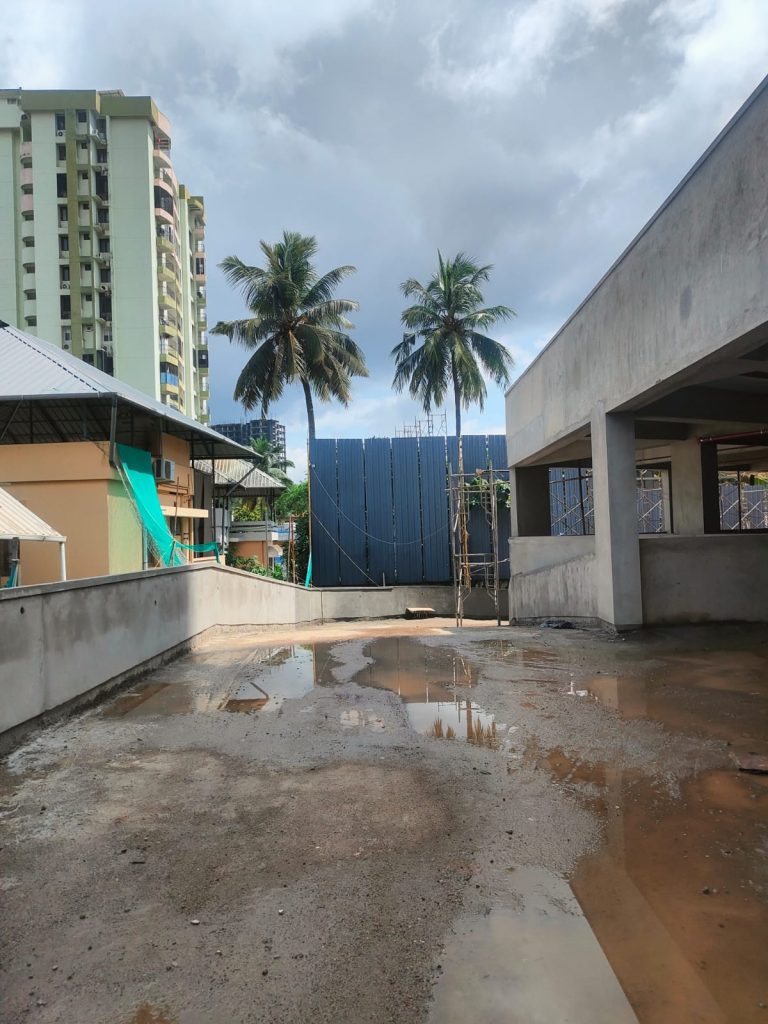

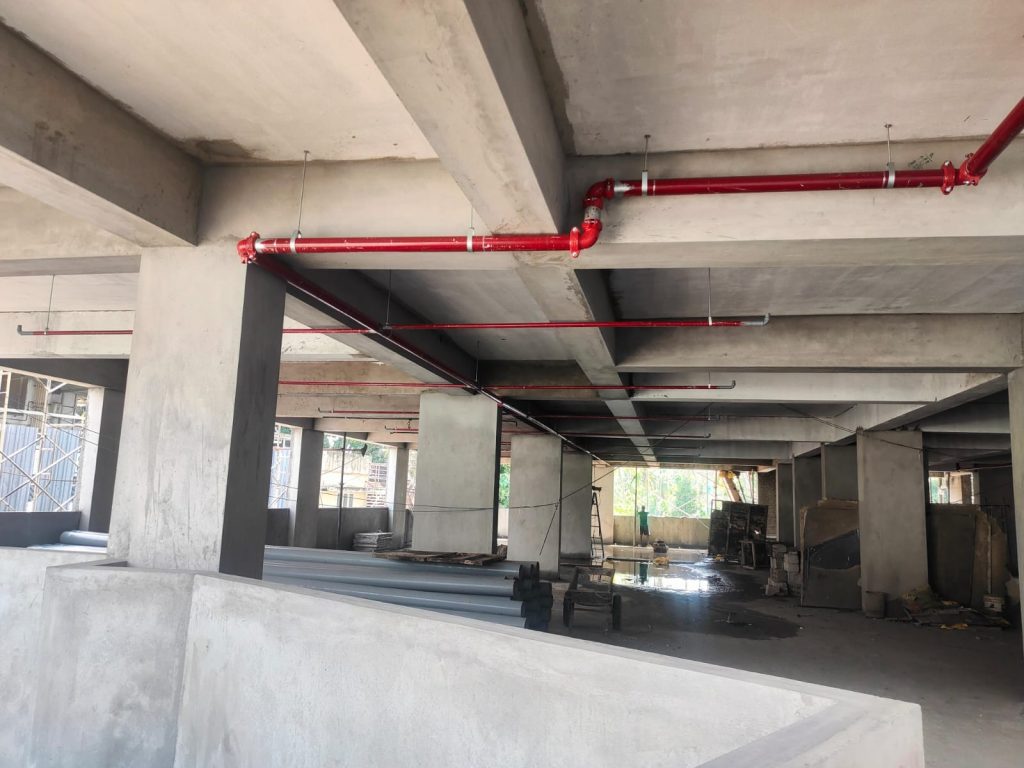

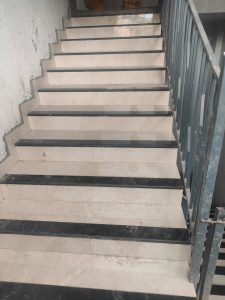

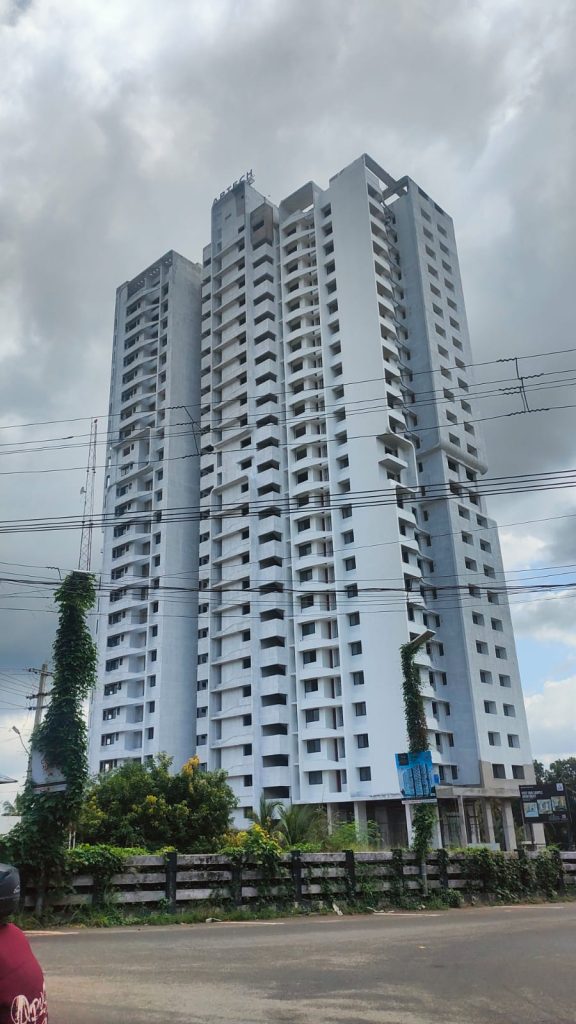

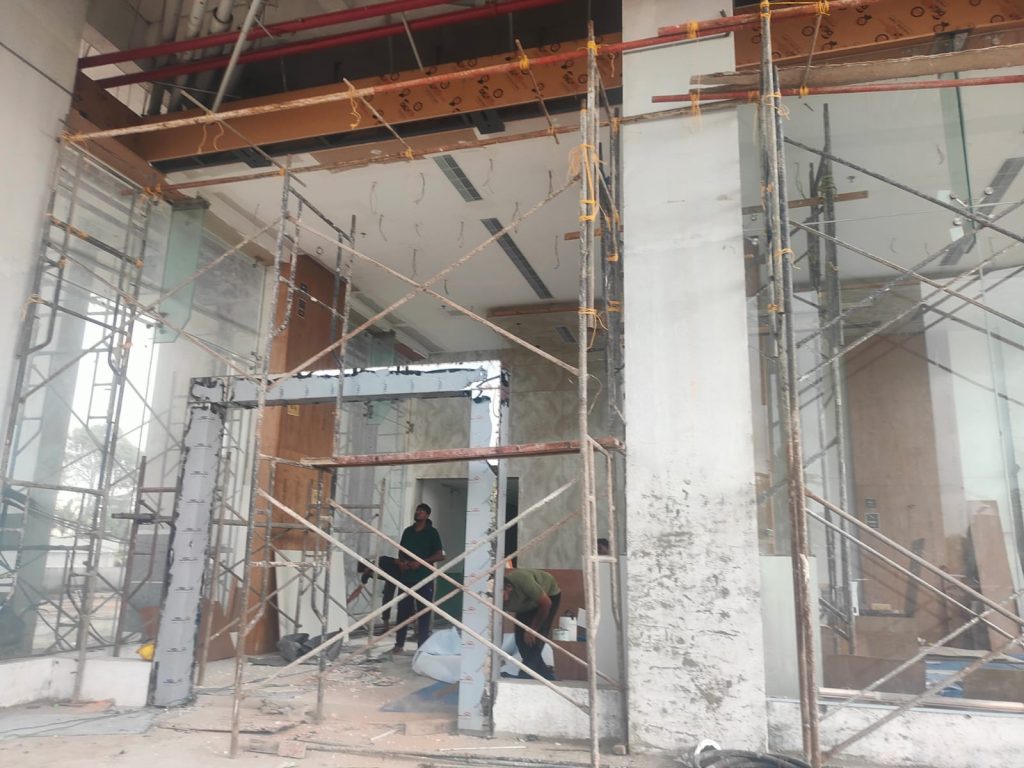

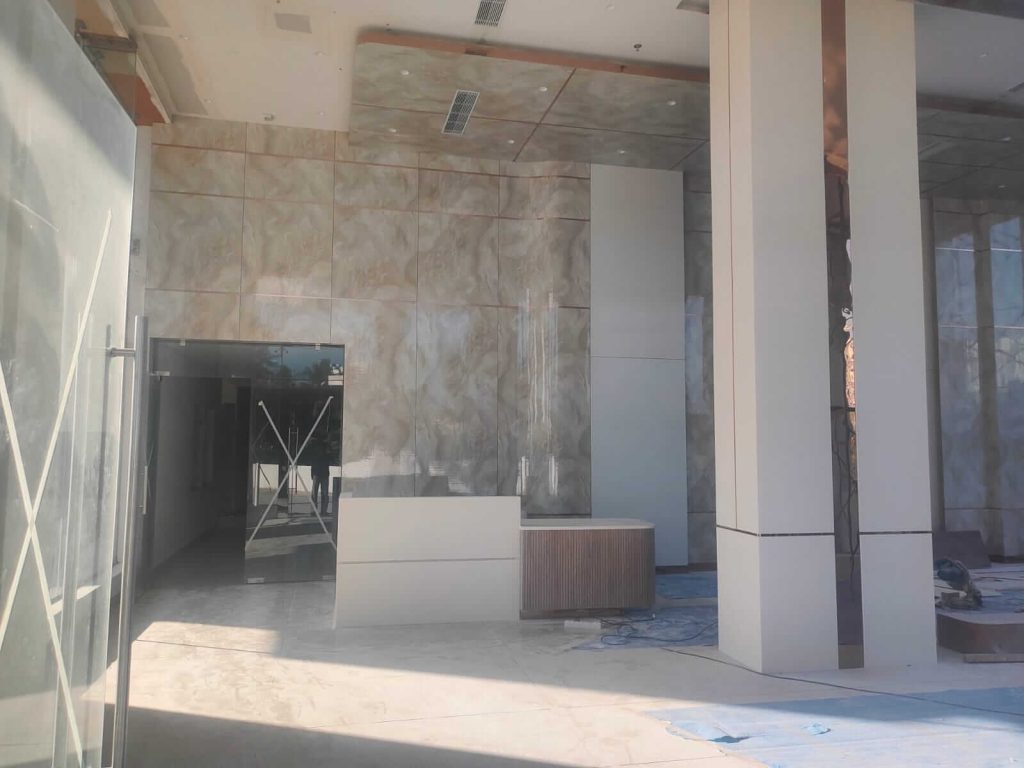

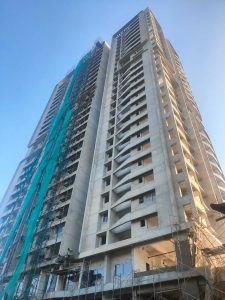

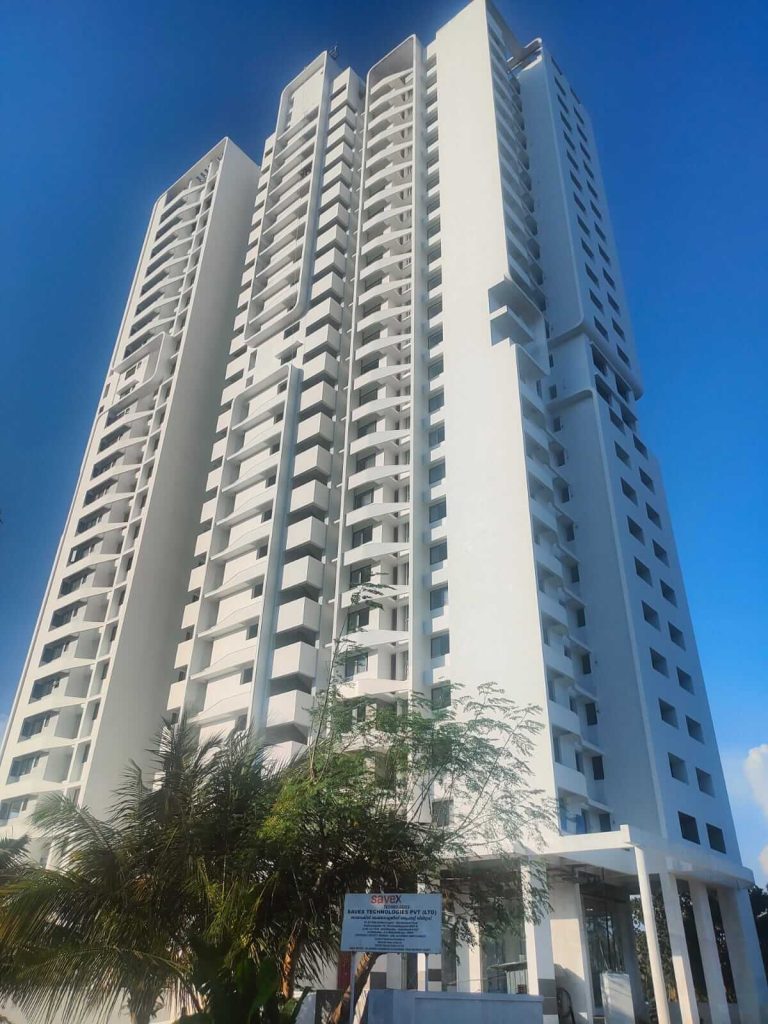

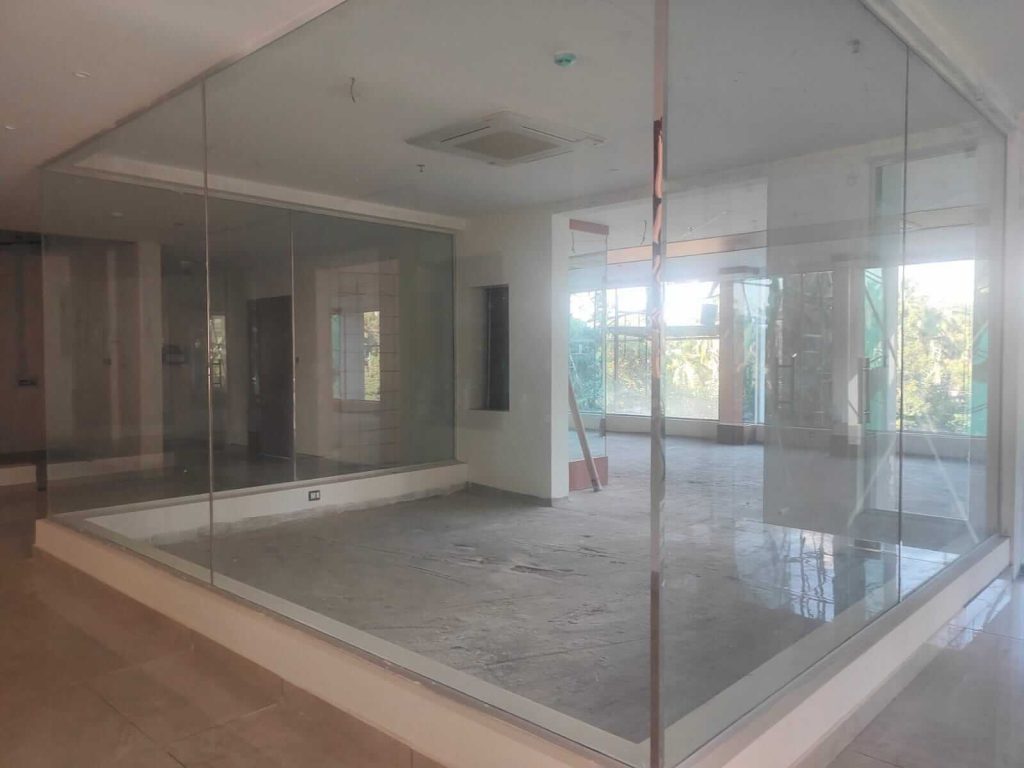

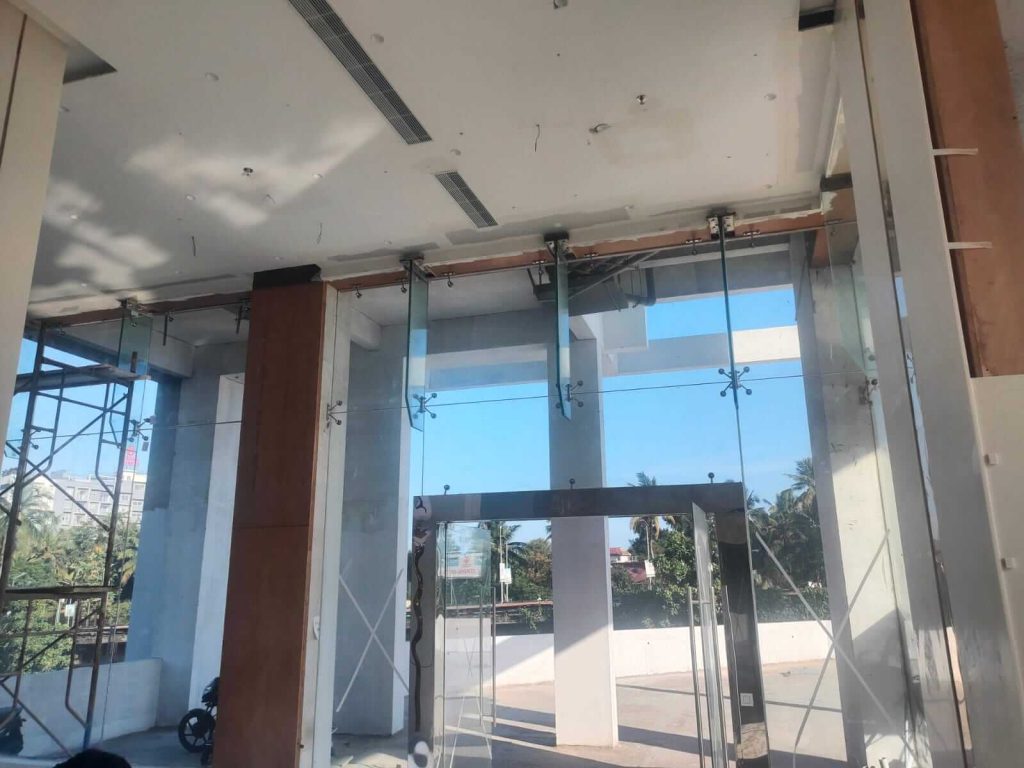

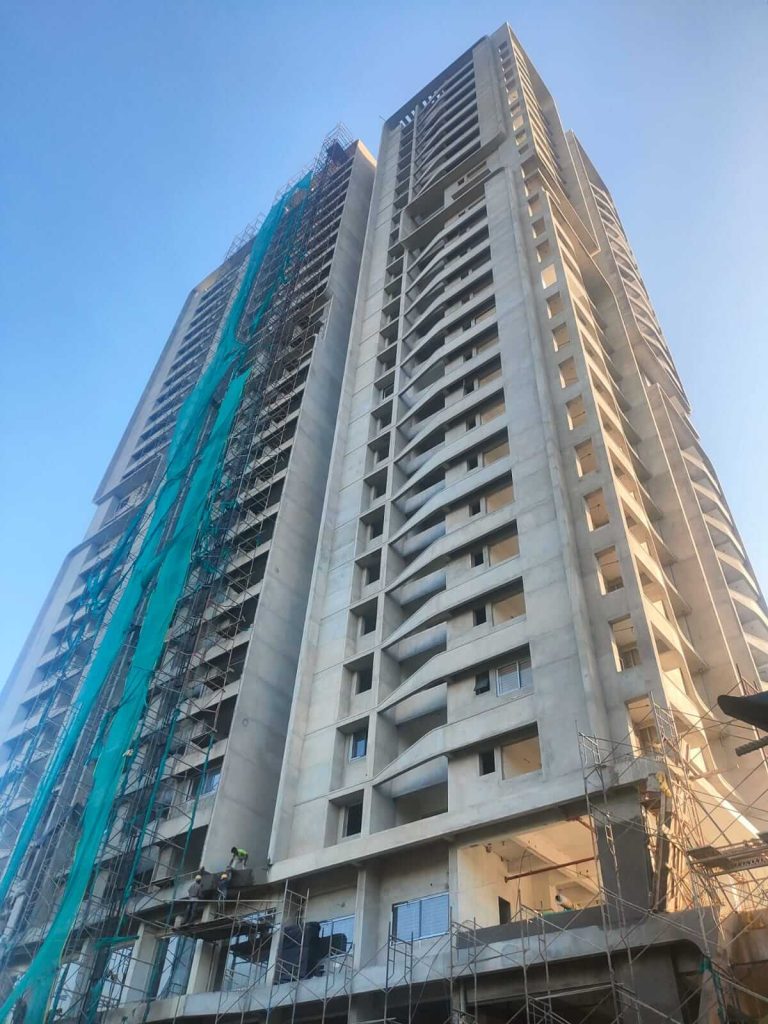

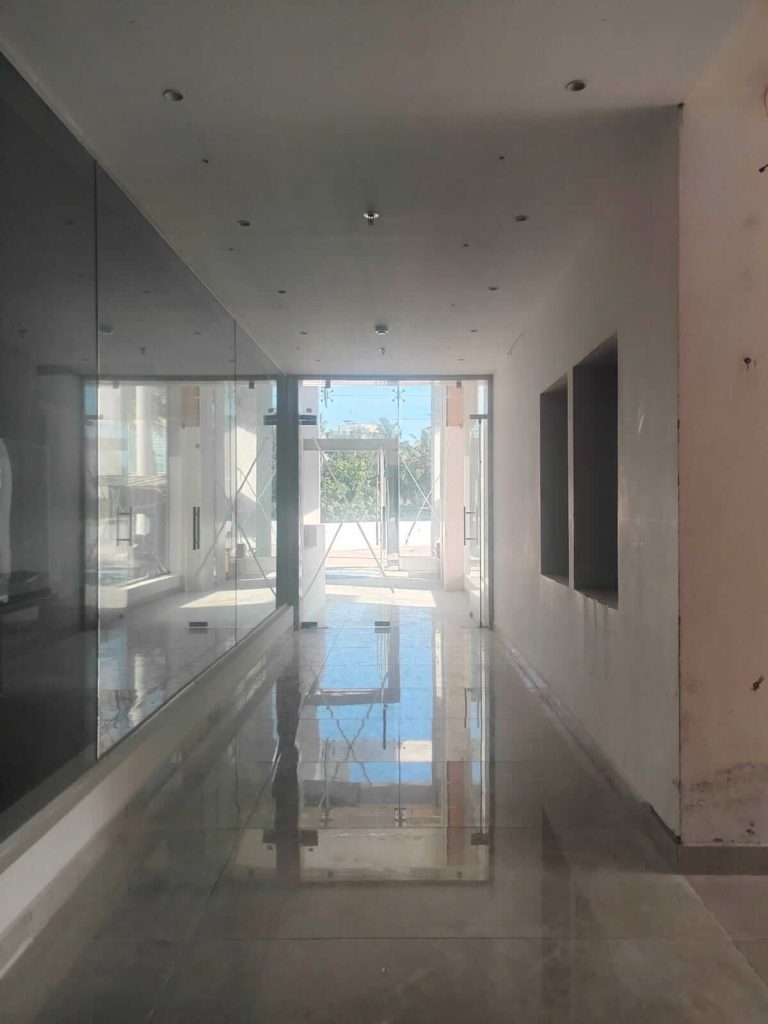

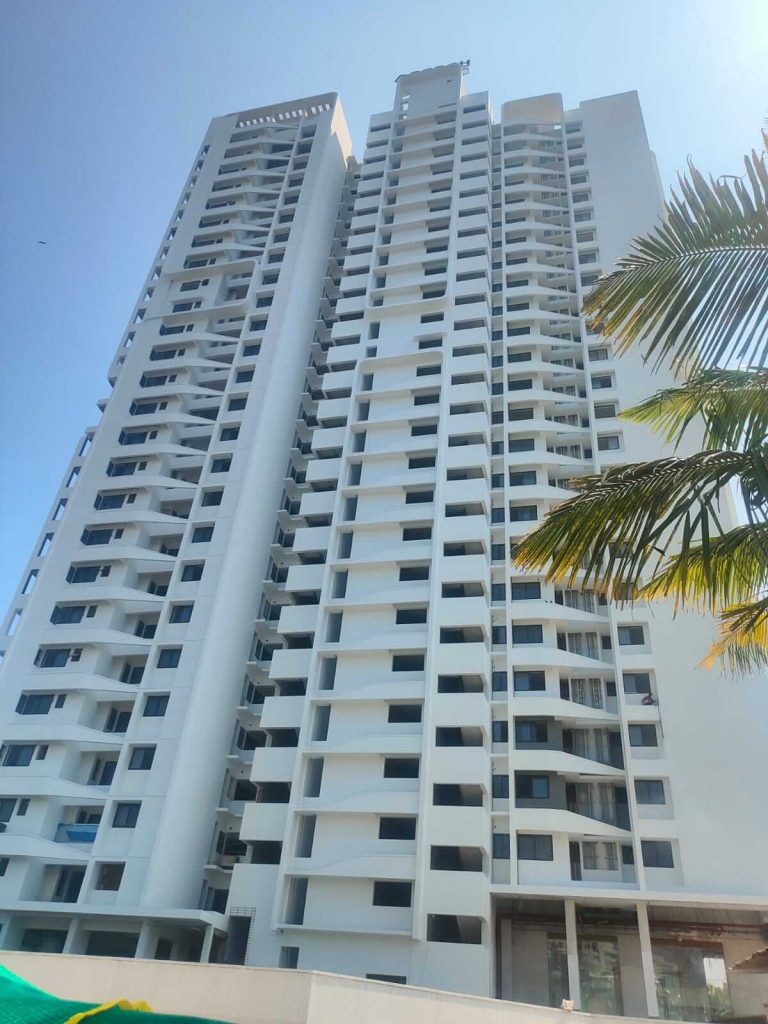

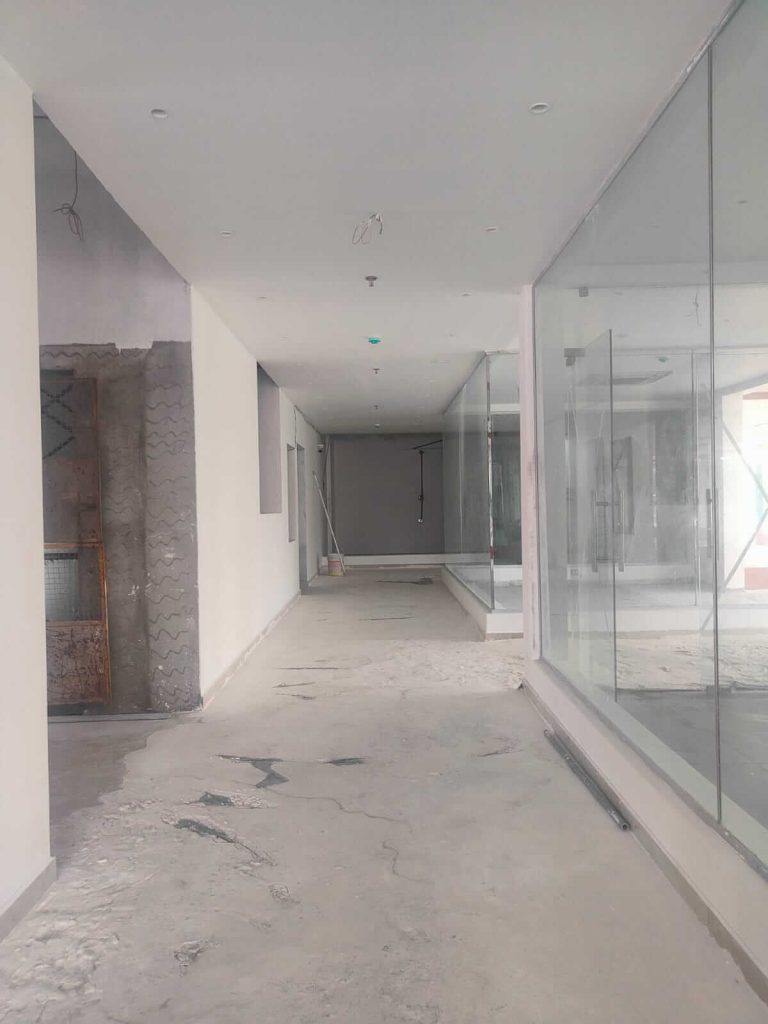

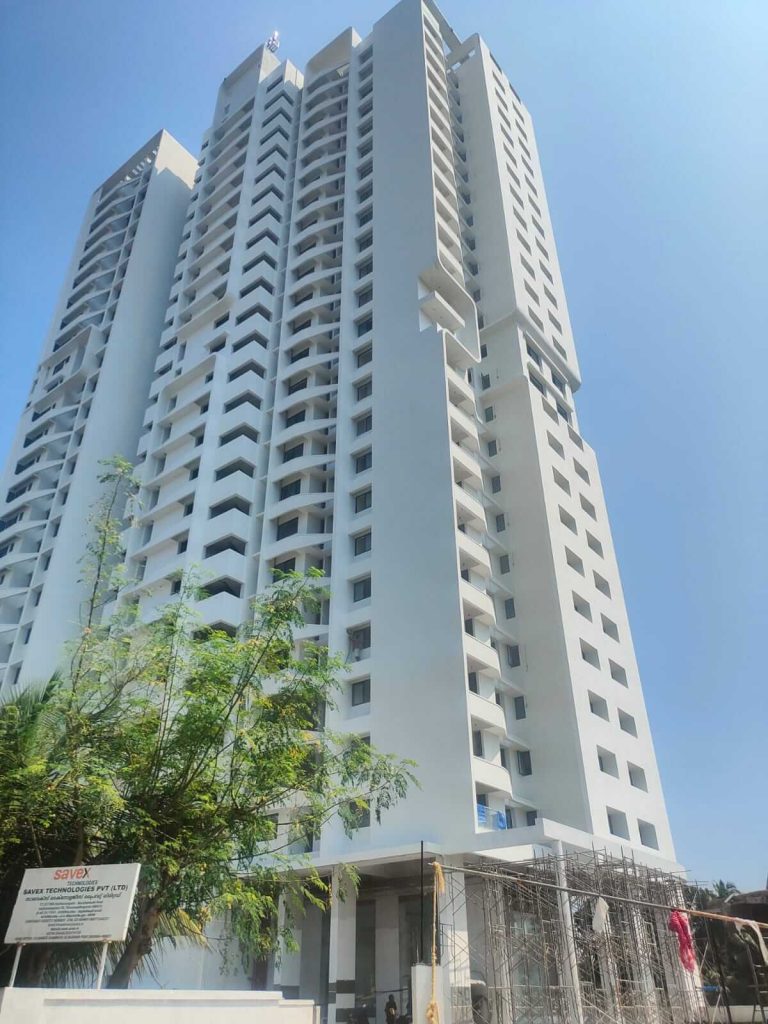

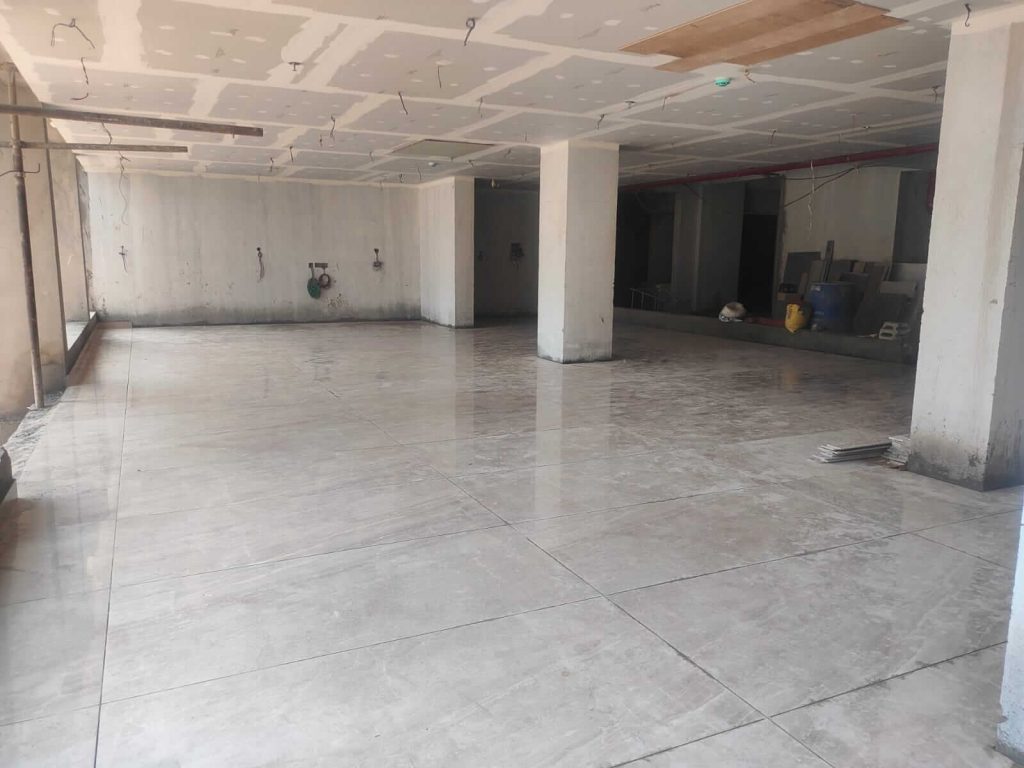

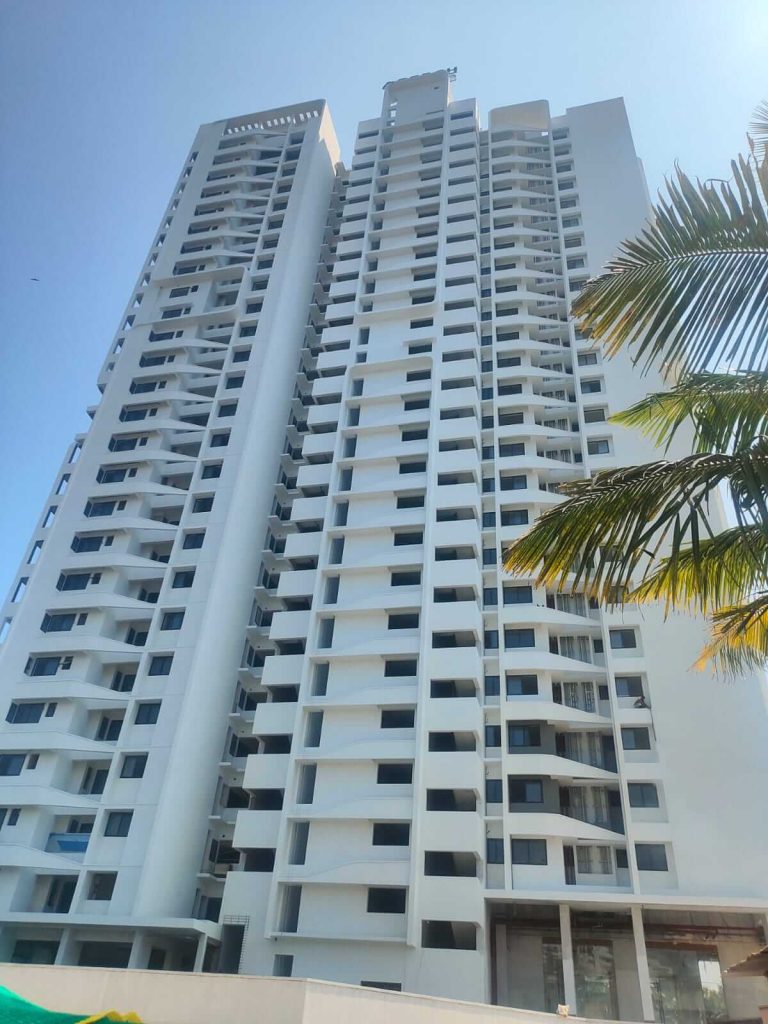

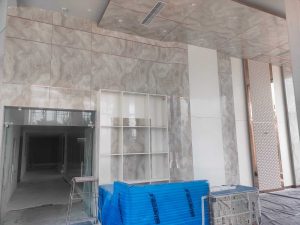

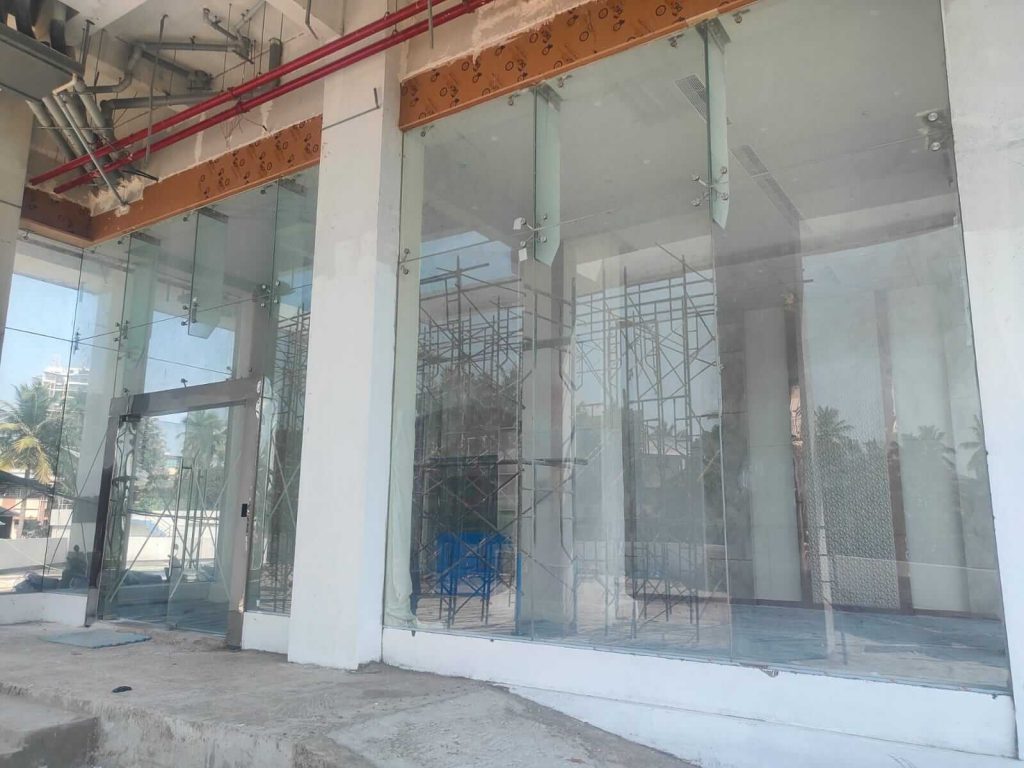

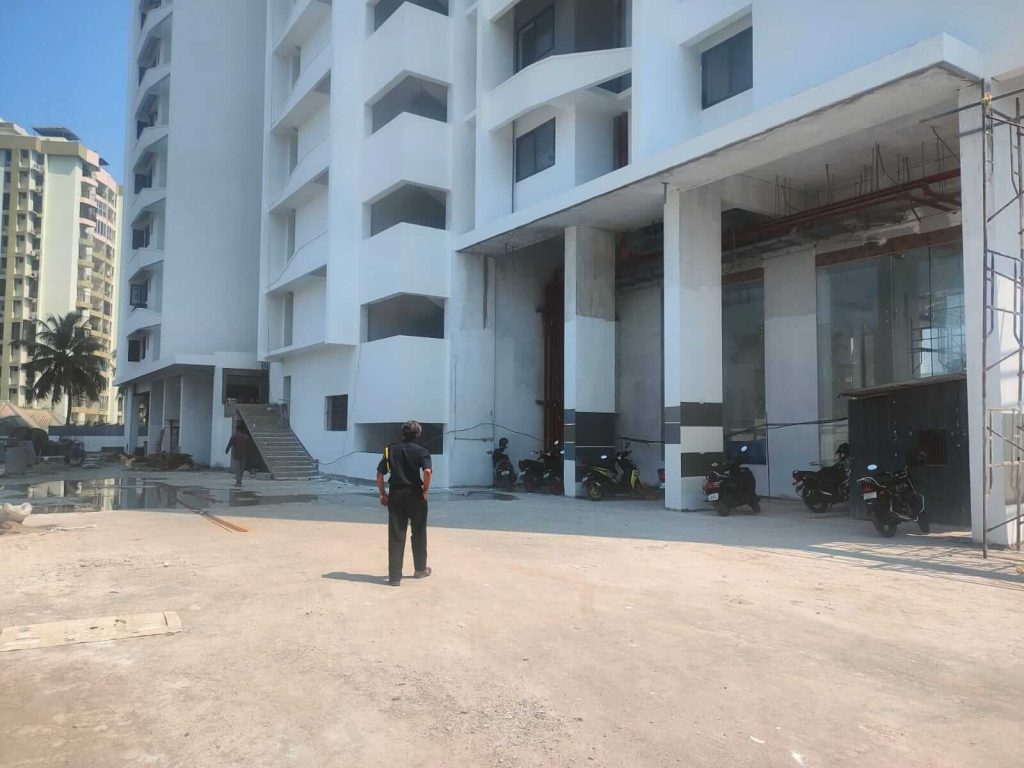

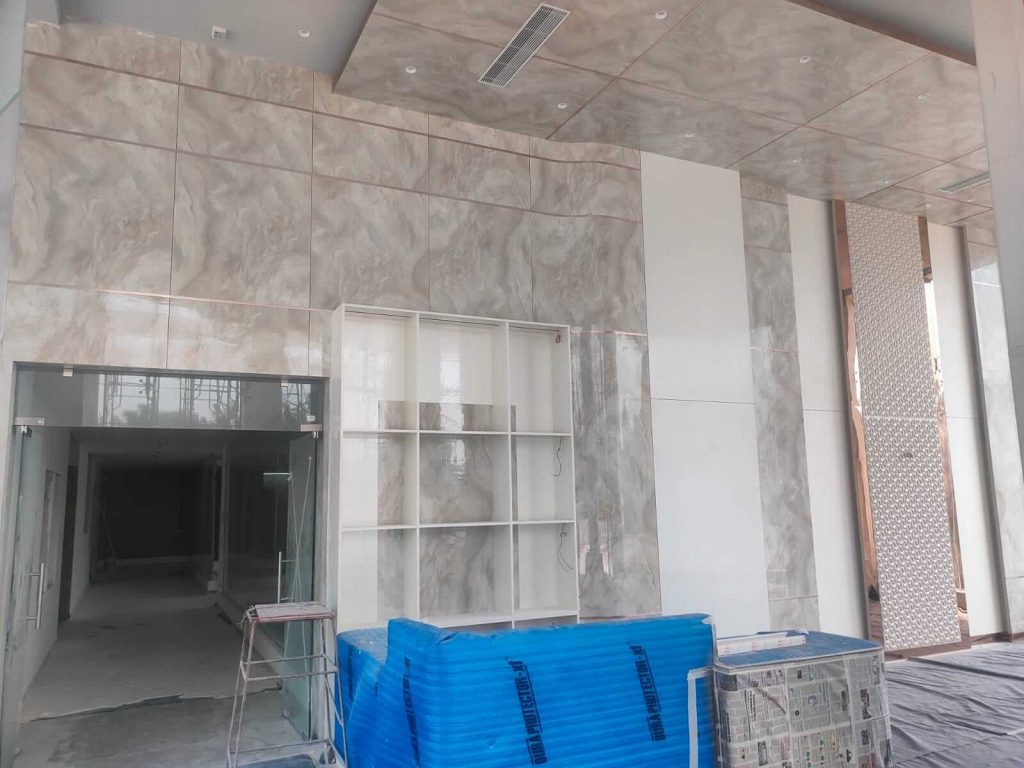

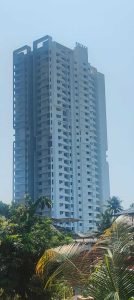

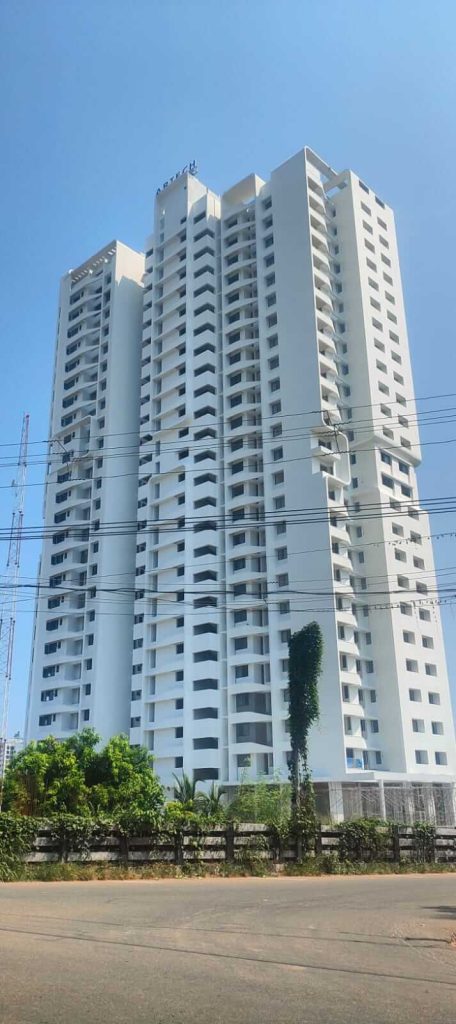

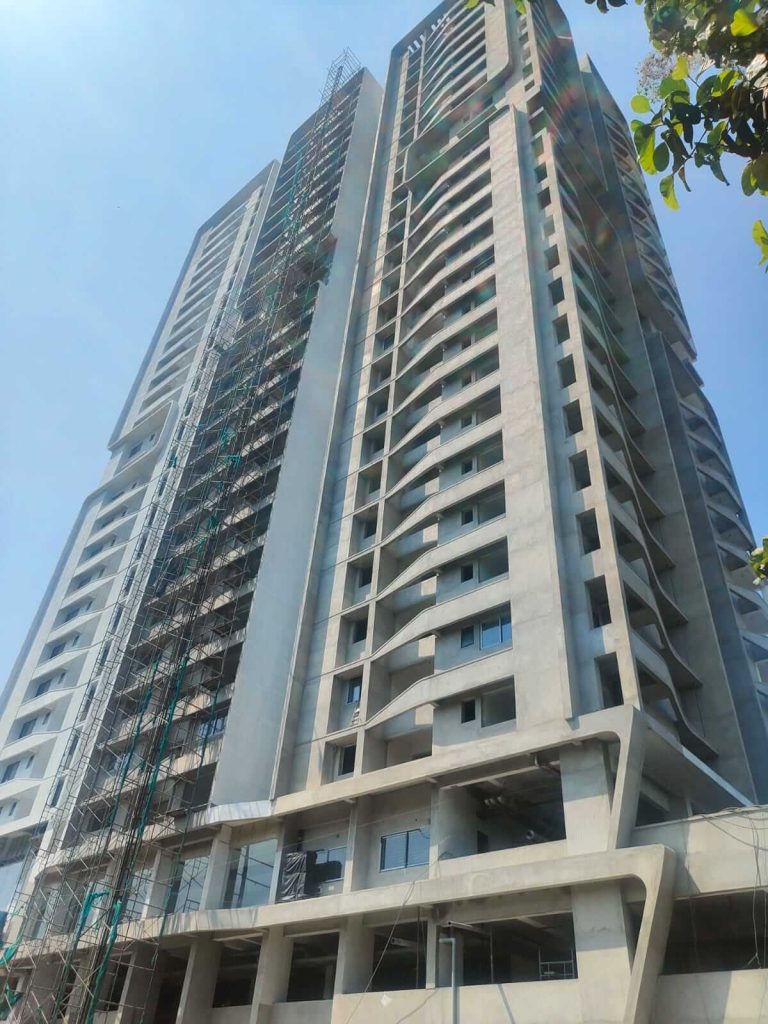

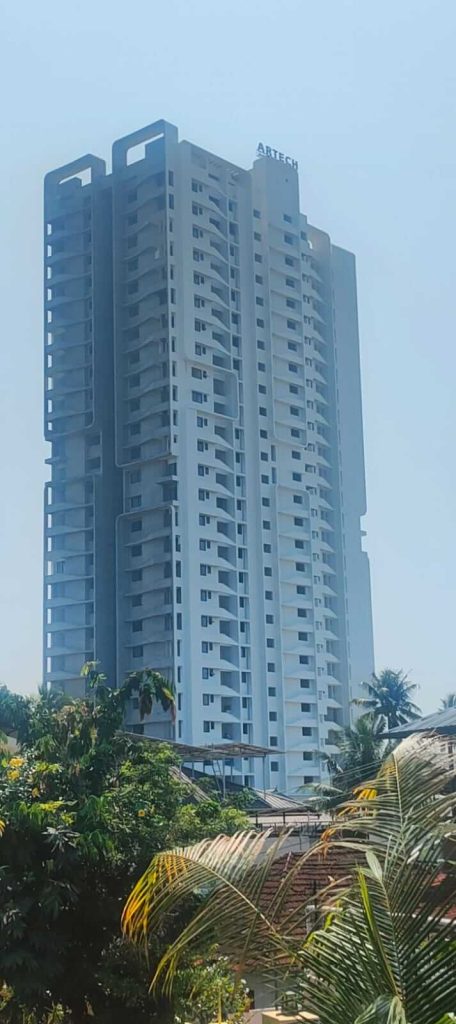

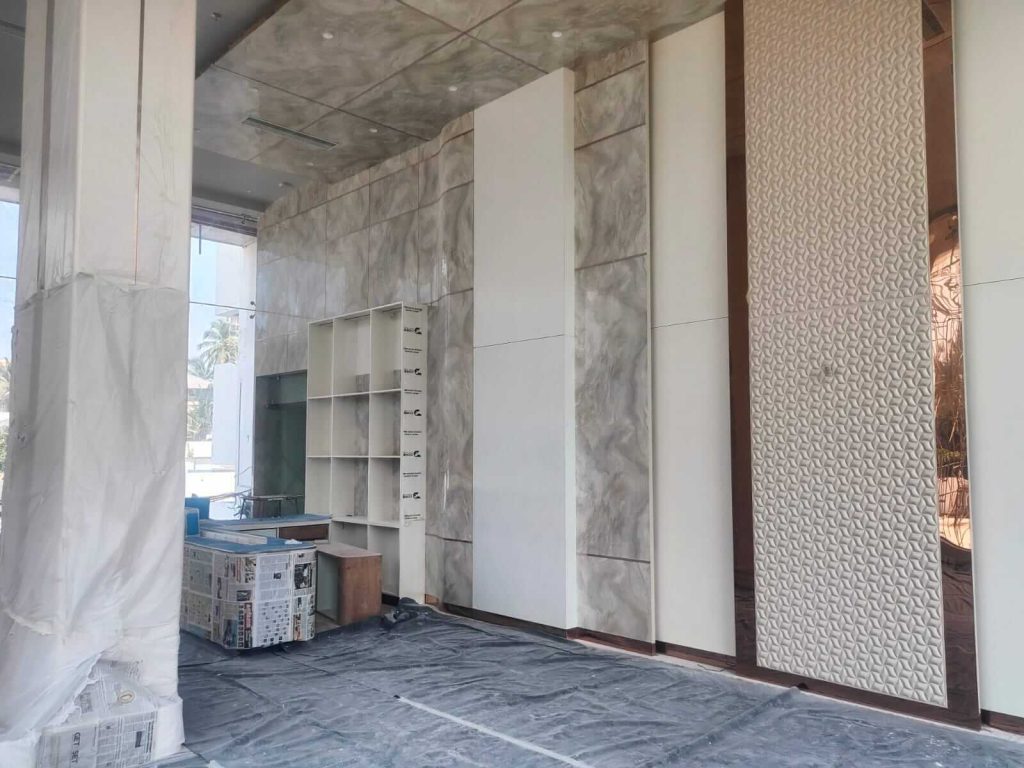

We are pleased to inform you the current work progress at our site Artech “Panorama”, Sasthamangalam, Few snaps of the work progress is attached for your reference.

  • Sub structural works – Pile concreting completed , pile chipping 66% completed (205 nos: completed out of 310 nos:), pile load test completed , pile integrity test completed
  • Building Area :- PCC for pile cap – completed , RCC for pile cap – completed , RCC pedestal column – completed , Plinth beam & Raft slab – completed, Lower Basement column RCC completed, Lower basement floor slab and beam – 1200 m2 completed out of 2016 m2, Upper basement slab concrete – 1050m2 completed out of 2400m2, RCC column upper basement – completed , Ground floor slab RCC – completed , GF to 1st floor column RCC completed , First floor slab – 892m2 completed out of 892m2 , Column First floor to second floor RCC completed, second floor slab RCC – 752m2 completed, Second floor to third floor column RCC 51nos: completed out of 51 nos:, 3rd floor slab – 752m2 completed, 3rd to 4th floor column RCC 51 nos: completed, 4th floor slab – 450m2 completed out of 752m2, 4th to 5th floor column RCC – 8nos: completed out of 51nos:

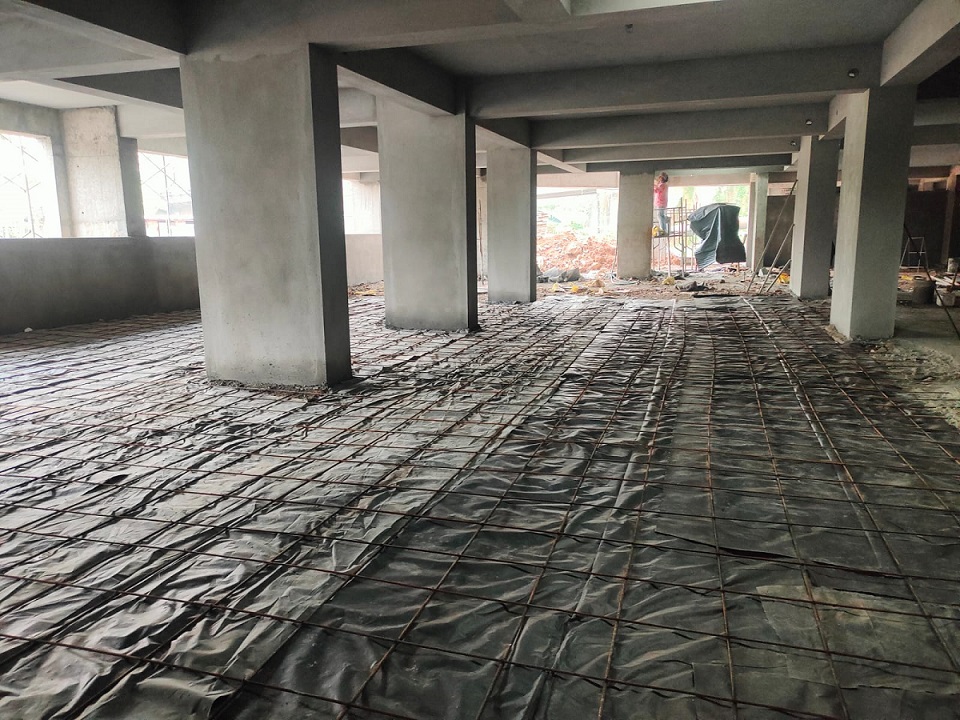

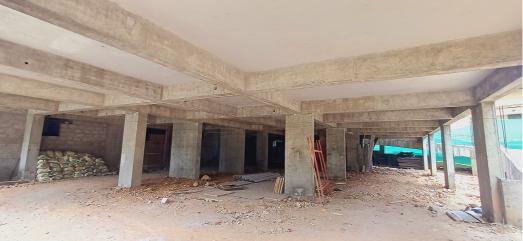

  • Podium Area:- PCC pile cap – 34 Nos: completed out of 58 Nos:, RCC pile cap – 34 Nos: completed out of 58 Nos:, RCC pile cap (STP) – completed, Lower basement column RCC – 23 Nos: completed out of 70 Nos:, Upper basement column RCC – 10 Nos: completed out of 52 Nos:, STP slab concrete – 46m2 completed
  • Boundary wall :- PCC pile cap – 6 Nos: completed out of 45 Nos:, RCC pile cap – 5 Nos: completed out of 45 Nos:, RCC wall – 40 Rm completed out of 250RM, Lower basement floor earth filling – 1350m2 completed out of 1750m2, Ramp concrete – 32Rm Completed out of 107Rm

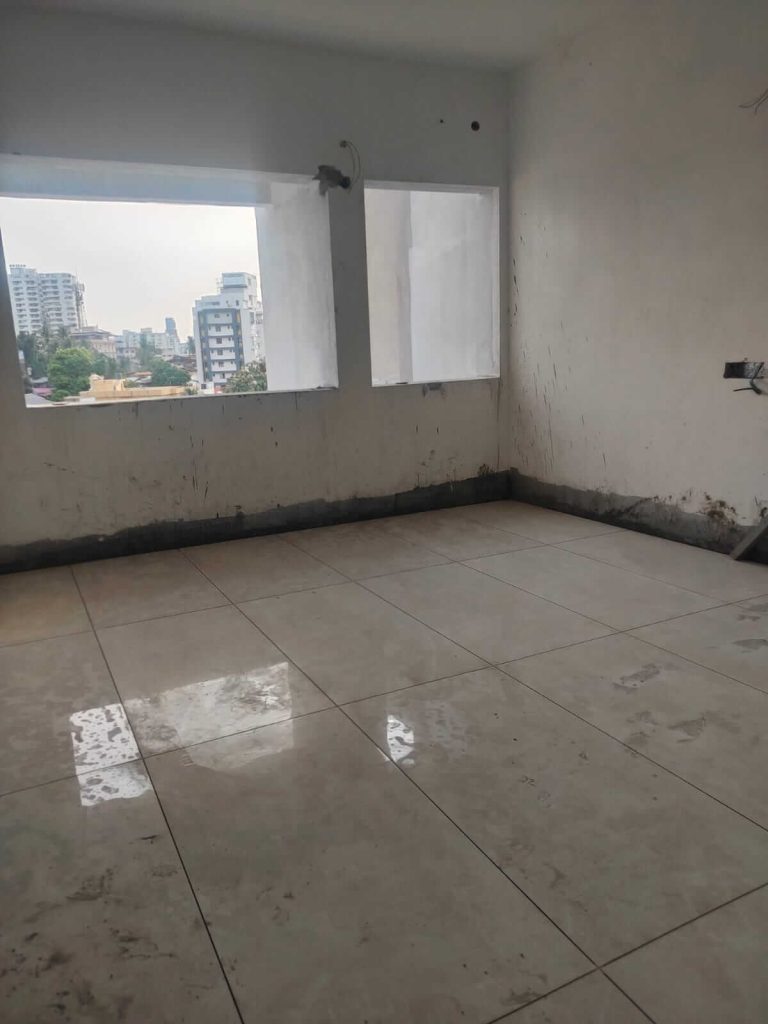

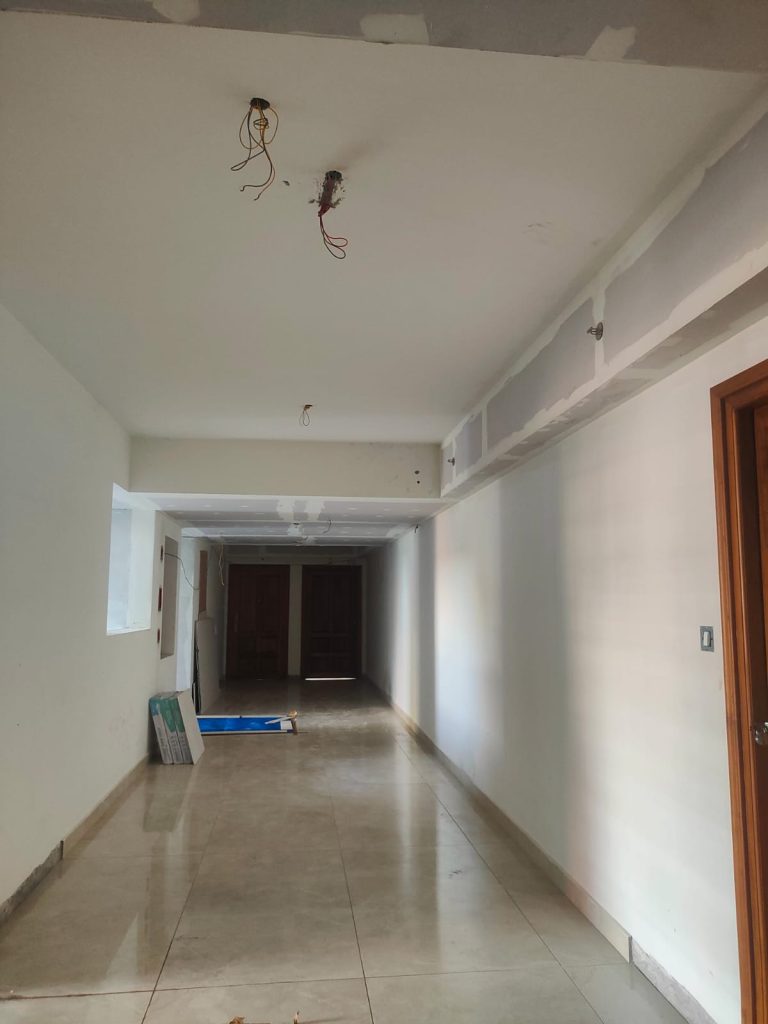

  • Ceiling plastering – Upper basement floor – 1000m2 completed out of 2400m2, Ground floor – 550m2 completed, First floor – 340m2 completed out of 892m2

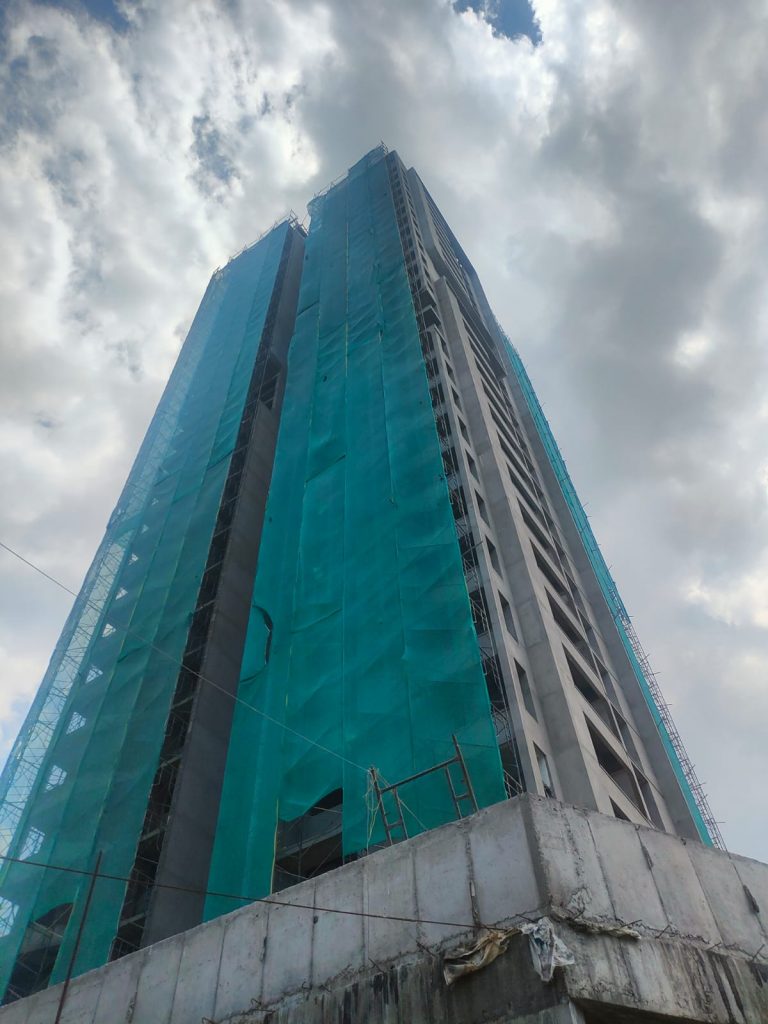

We are pleased to inform you the current work progress at our site Artech “Panorama”, Sasthamangalam, Few snaps of the work progress is attached for your reference.

  • Sub structural works – Pile concreting completed , pile chipping 66% completed (205 nos: completed out of 310 nos:), pile load test completed , pile integrity test completed
  • Building Area :- PCC for pile cap – completed , RCC for pile cap – completed , RCC pedestal column – completed , Plinth beam & Raft slab – completed, Lower Basement column RCC completed, Lower basement floor slab and beam – 1200 m2 completed out of 2016 m2, Upper basement slab concrete – 1050m2 completed out of 2400m2, RCC column upper basement – completed , Ground floor slab RCC – completed , GF to 1st floor column RCC completed , First floor slab – 530m2 completed out of 892m2 , Column First floor to second floor RCC completed, second floor slab RCC – 742m2 completed, Second floor to third floor column RCC 47nos: completed out of 51 nos:
  • Podium Area:- PCC pile cap – 34 Nos: completed out of 58 Nos:, RCC pile cap – 34 Nos: completed out of 58 Nos:, RCC pile cap (STP) – completed, Lower basement column RCC – 18 Nos: completed out of 70 Nos:, Upper basement column RCC – 10 Nos: completed out of 52 Nos:, STP slab concrete – 46m2 completed
  • Boundary wall :- PCC pile cap – 5 Nos: completed out of 45 Nos:, RCC pile cap – 5 Nos: completed out of 45 Nos:, RCC wall – 40 Rm completed out of 250RM, Lower basement floor earth filling – 750m2 completed out of 1750m2, Ramp concrete – 32Rm Completed out of 107Rm

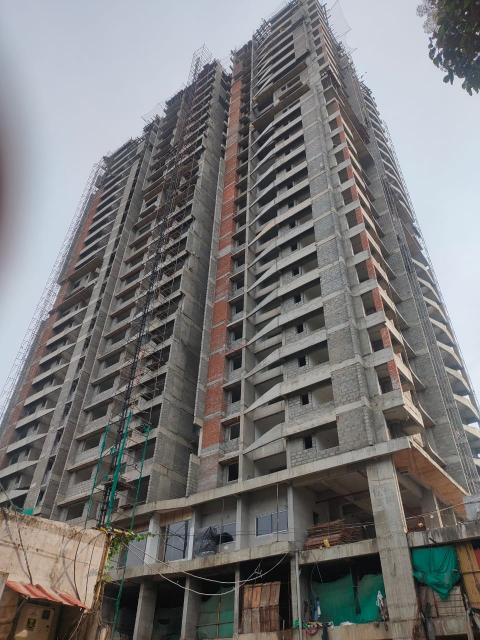

We are pleased to inform you the current work progress at our site Artech “Panorama”, Sasthamangalam, Few snaps of the work progress is attached for your reference.

  • Sub Structural Works – Sub structural works – Pile concreting completed , pile chipping 66% completed (205 nos: completed out of 310 nos:), pile load test completed , pile integrity test completed
  • Building Area :- PCC for pile cap – completed , RCC for pile cap – completed , RCC pedestal column – completed , Plinth beam & Raft slab – completed, Lower Basement column RCC completed, Lower basement floor slab and beam – 1200 m2 completed out of 2016 m2, Upper basement slab concrete – 1050m2 completed out of 2400m2, RCC column upper basement – completed , Ground floor slab RCC – completed , GF to 1st floor column 45 Nos: completed out of 51 Nos:, First floor slab – 530m2 completed out of 800m2
  • Podium Area:- PCC pile cap – 31 Nos: completed out of 58 Nos:, RCC pile cap – 31 Nos: completed out of 58 Nos:, RCC pile cap (STP) – completed, Lower basement column RCC – 18 Nos: completed out of 70 Nos:, Upper basement column RCC – 10 Nos: completed out of 52 Nos:, STP slab concrete – 46m2 completed
  • Boundary wall :- PCC pile cap – 5 Nos: completed out of 45 Nos:, RCC pile cap – 5 Nos: completed out of 45 Nos:, RCC wall – 40 Rm completed out of 250RM, Lower basement floor earth filling – 350m2 completed out of 1750m2, Ramp concrete – 32Rm Completed out of 107Rm

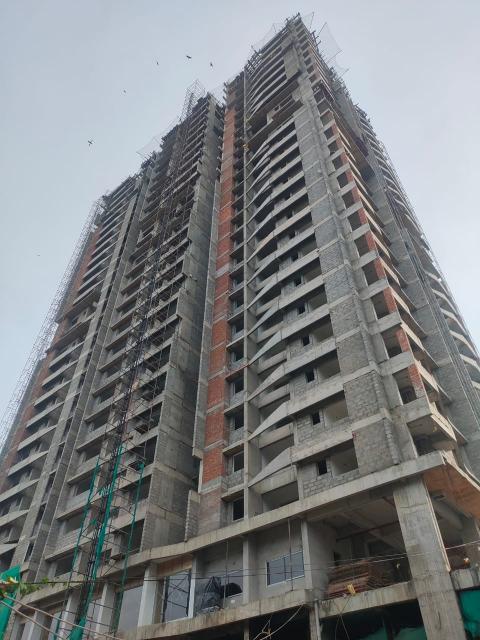

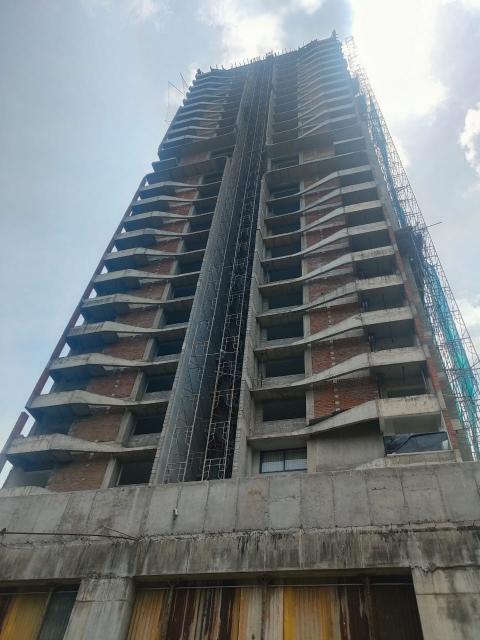

Work status as on 10-11-2023, we have completed the following.

  • Sub Structural Works – Sub structural works – Pile concreting completed , pile chipping 60% completed (190 nos: completed out of 310 nos:), pile load test completed , pile integrity test completed
  • Building Area :- PCC for pile cap – completed , RCC for pile cap – completed , RCC pedestal column – completed , Plinth beam & Raft slab – completed, Lower Basement column RCC completed, Lower basement floor slab and beam – 900 m2 completed out of 2016 m2, Upper basement slab concrete – 800m2 completed out of 2400m2, RCC column upper basement – 47 Nos: completed out of 51 Nos: , Ground floor slab RCC – 725 m2 completed out of 2000 m2, GF to 1st floor column 36 Nos: completed out of 51 Nos:, First floor slab – 530m2 completed out of 800m2
  • Podium Area:- PCC pile cap – 31 Nos: completed out of 58 Nos:, RCC pile cap – 31 Nos: completed out of 58 Nos:, RCC pile cap (STP) – completed, Lower basement column RCC – 18 Nos: completed out of 70 Nos:, Upper basement column RCC – 10 Nos: completed out of 52 Nos:, STP slab concrete – 46m2 completed
  • Boundary wall :- PCC pile cap – 5 Nos: completed out of 45 Nos:, RCC pile cap – 5 Nos: completed out of 45 Nos:, RCC wall – 40 Rm completed out of 250RM, Lower basement floor earth filling – 350m2 completed out of 1750m2

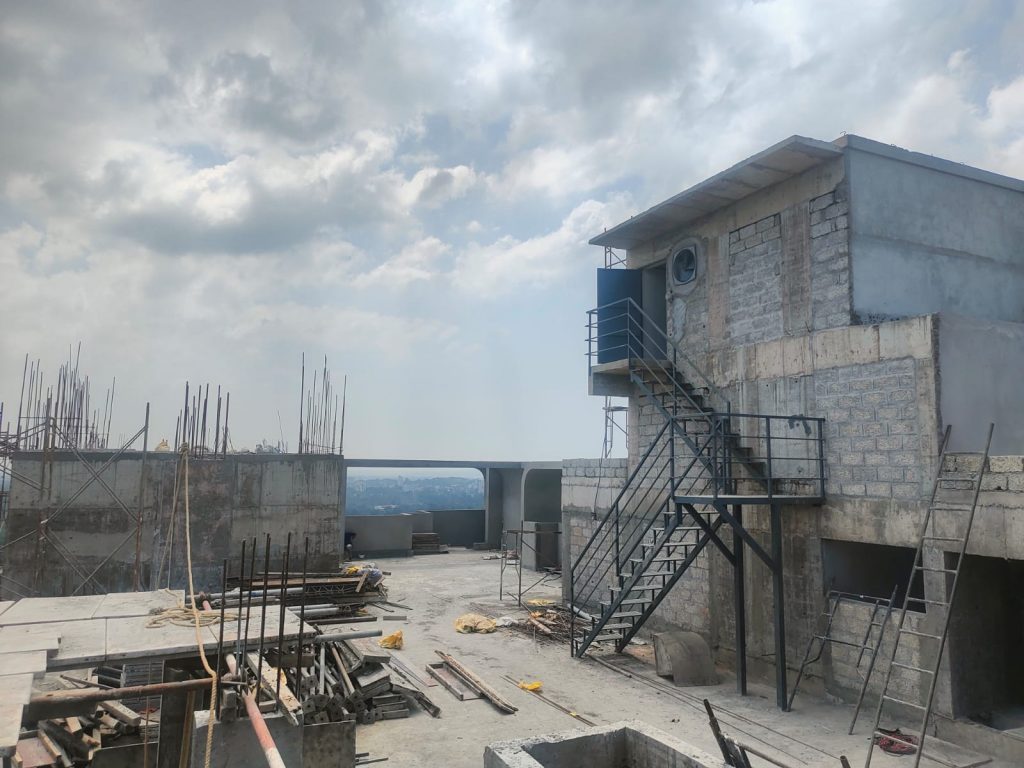

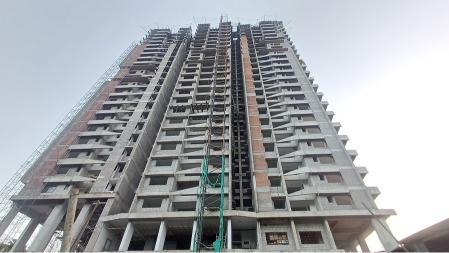

Work status as on 10-10-2023, we have completed the following.

  • Sub Structural Works – Sub structural works – Pile concreting completed , pile chipping 60% completed (190 nos: completed out of 310 nos:), pile load test completed , pile integrity test completed
  • Building Area :- PCC for pile cap – completed , RCC for pile cap – completed , RCC pedestal column – completed , Plinth beam & Raft slab – completed, Lower Basement column RCC completed, Lower basement floor slab and beam – 900 m2 completed out of 2016 m2, Upper basement slab concrete – 800m2 completed out of 2400m2, RCC column upper basement – 47 Nos: completed out of 51 Nos: , Ground floor slab RCC – 725 m2 completed out of 2000 m2, GF to 1st floor column 36 Nos: completed out of 51 Nos:
  • Podium Area:- PCC pile cap – 31 Nos: completed out of 58 Nos:, RCC pile cap – 31 Nos: completed out of 58 Nos:, RCC pile cap (STP) – completed, Lower basement column RCC – 18 Nos: completed out of 70 Nos:, Upper basement column RCC – 10 Nos: completed out of 52 Nos:, STP slab concrete – 46m2 completed
  • Boundary wall :- PCC pile cap – 5 Nos: completed out of 45 Nos:, RCC pile cap – 5 Nos: completed out of 45 Nos:, RCC wall – 40 Rm completed out of 250RM, Lower basement floor earth filling – 350m2 completed out of 1750m2

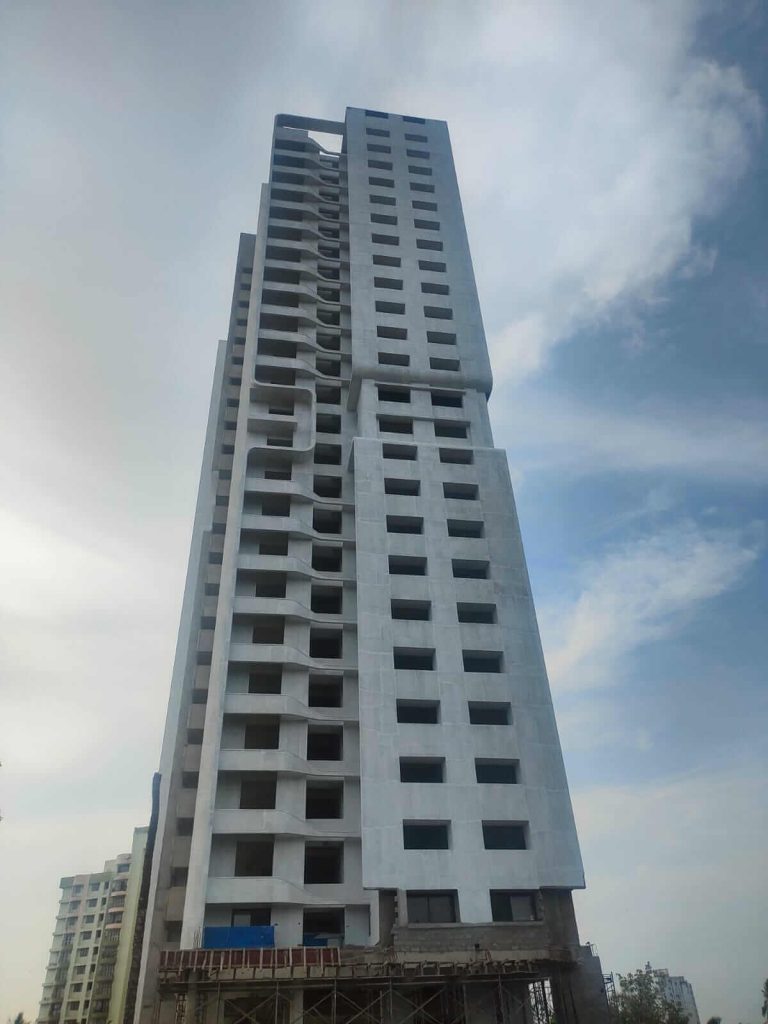

Work status as on 12-08-2023, we have completed the following.

  • Sub Structural Works – Sub structural works – Pile concreting completed , pile chipping 58% completed (181 nos: completed out of 310 nos:), pile load test completed , pile integrity test completed.
  • Building Area :- PCC for pile cap – completed , RCC for pile cap – completed , RCC pedestal column – completed , Plinth beam & Raft slab – 450m2 completed out of 500m2, Lower Basement column RCC 47 Nos: completed out of 51 Nos:, Upper basement slab concrete – 445m2 completed out of 2400m2, RCC column upper basement – 16 Nos: completed out of 51 Nos:
  • Podium Area:- PCC pile cap – 25 Nos: completed out of 58 Nos:, RCC pile cap – 21 Nos: completed out of 58 Nos:, RCC pile cap (STP) – completed, Lower basement column RCC – 12 Nos: completed out of 70 Nos:, STP slab concrete – 46m2 completed.
  • Boundary wall :- PCC pile cap – 5 Nos: completed out of 45 Nos:, RCC pile cap – 5 Nos: completed out of 45 Nos:, RCC wall – 33 Rm completed out of 250RM.

Work status as on 13-09-2023, we have completed the following.

  • Sub Structural Works – Sub structural works – Pile concreting completed , pile chipping 60% completed (190 nos: completed out of 310 nos:), pile load test completed , pile integrity test completed
  • Building Area :- PCC for pile cap – completed , RCC for pile cap – completed , RCC pedestal column – completed , Plinth beam & Raft slab – completed, Lower Basement column RCC 47 Nos: completed out of 51 Nos:, Lower basement floor slab and beam – 900 m2 completed out of 2016 m2, Upper basement slab concrete – 800m2 completed out of 2400m2, RCC column upper basement – 47 Nos: completed out of 51 Nos: , Ground floor slab RCC – 725 m2 completed out of 2000 m2
  • Podium Area:- PCC pile cap – 28 Nos: completed out of 58 Nos:, RCC pile cap – 22 Nos: completed out of 58 Nos:, RCC pile cap (STP) – completed, Lower basement column RCC – 18 Nos: completed out of 70 Nos:, Upper basement column RCC – 10 Nos: completed out of 52 Nos:, STP slab concrete – 46m2 completed
  • Boundary wall :- PCC pile cap – 5 Nos: completed out of 45 Nos:, RCC pile cap – 5 Nos: completed out of 45 Nos:, RCC wall – 40 Rm completed out of 250RM

Work status as on 12-08-2023, we have completed the following.

  • Sub Structural Works – Sub structural works – Pile concreting completed , pile chipping 58% completed (181 nos: completed out of 310 nos:), pile load test completed , pile integrity test completed.
  • Building Area :- PCC for pile cap – completed , RCC for pile cap – completed , RCC pedestal column – completed , Plinth beam & Raft slab – 450m2 completed out of 500m2, Lower Basement column RCC 47 Nos: completed out of 51 Nos:, Upper basement slab concrete – 445m2 completed out of 2400m2, RCC column upper basement – 16 Nos: completed out of 51 Nos:
  • Podium Area:- PCC pile cap – 25 Nos: completed out of 58 Nos:, RCC pile cap – 21 Nos: completed out of 58 Nos:, RCC pile cap (STP) – completed, Lower basement column RCC – 12 Nos: completed out of 70 Nos:, STP slab concrete – 46m2 completed.
  • Boundary wall :- PCC pile cap – 5 Nos: completed out of 45 Nos:, RCC pile cap – 5 Nos: completed out of 45 Nos:, RCC wall – 33 Rm completed out of 250RM.

Work status as on 12-07-2023, we have completed the following.

  • Sub Structural Works – Sub structural works – PBuilding Area :- PCC for pile cap – completed , RCC for pile cap – completed , RCC pedestal column – completed , Plinth beam & Raft slab – 450m2 completed out of 500m2, Lower Basement column RCC 47 Nos: completed out of 51 Nos:, Upper basement slab concrete – 445m2 completed out of 2400m2, RCC column upper basement – 16 Nos: completed out of 51 Nos:

Work status as on 06-06-2023, we have completed the following.

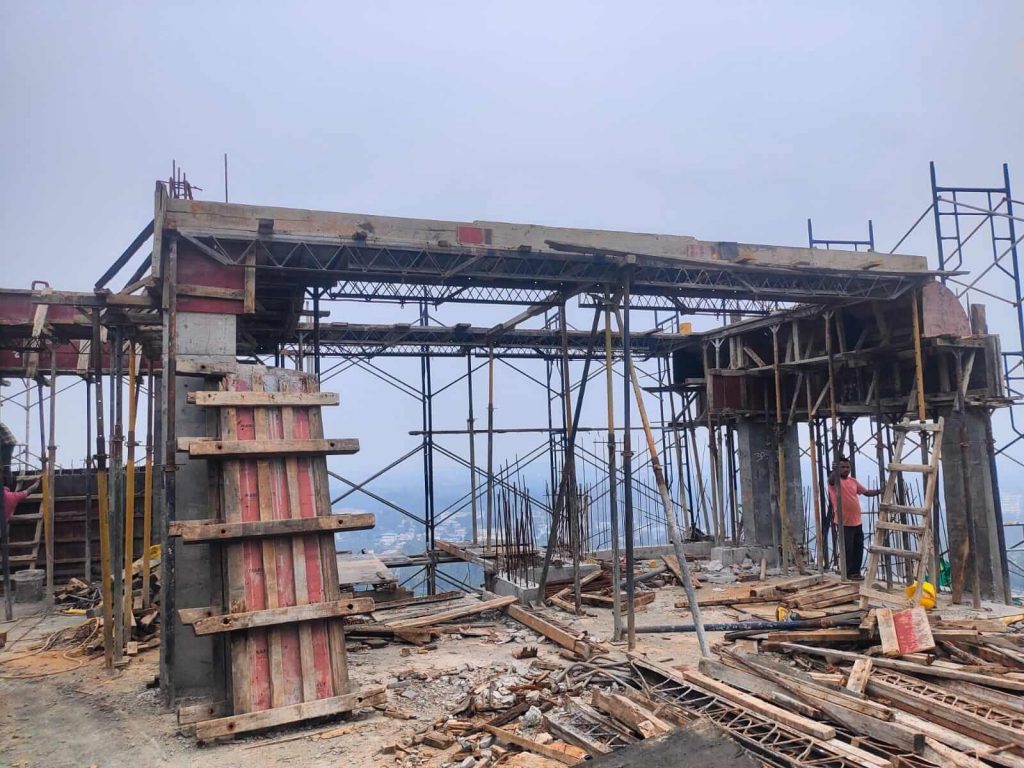

  • Sub Structural Works – Sub structural works – Pile concreting 100% completed (310 nos: completed out of 310 nos:), pile chipping 58% completed (180 nos: completed out of 310 nos:), pile load test completed (P179 – 100cm pile), pile integrity test first stage completed (48 nos: completed out of 48 nos:), excavation for pile cap foundation is progressing, PCC for pile cap 36% completed (47 nos: completed out of 128 nos:), pile cap concreting 36% completed (47 nos: completed out of 128 nos:)



Work status as on 05-05-2023, we have completed the following.

  • Sub Structural Works – Sub structural works – Pile concreting 100% completed (310 nos: completed out of 310 nos:), pile chipping 48% completed (150 nos: completed out of 310 nos:), excavation for pile cap foundation is progressing, PCC for pile cap 34% completed (44 nos: completed out of 128 nos:), pile cap concreting 27% completed (35 nos: completed out of 128 nos:), pile load test completed (P179 – 100cm pile), pile integrity test first stage completed (48 nos: completed out of 48 nos:)



Click here to see the previous work progress updates.

Are you on the lookout for a home loan? We can help you. We have tie-ups with prominent banks for this project. It will help you make the loan application process easier.

  • CANARA BANK
  • HDFC
  • SOUTH INDIAN BANK
  • SBI
  • UNION BANK OF INDIA
  • LIC HFL

  • Air-conditioned multi purpose hall
  • Air-conditioned unisex Gym
  • Guest Suite
  • Indoor Games Room
  • Rooftop Party Area
  • Swimming Pool and Toddler’s Pool
  • Children’s Play Area
  • Video door phone with intercom facility

  • Children’s play area.
  • Video door phone with intercom facility.
  • Driver’s restroom.
  • Common toilet for supporting staff.
  • Reticulated LPG supply.
  • Gas leakage detector.
  • Boom barrier.
  • Access control system
  • Surveillance camera system.
  • Common Electric car charging point.
  • Efficient waste disposable system.
  • Fire suppression system.
  • Car wash facility

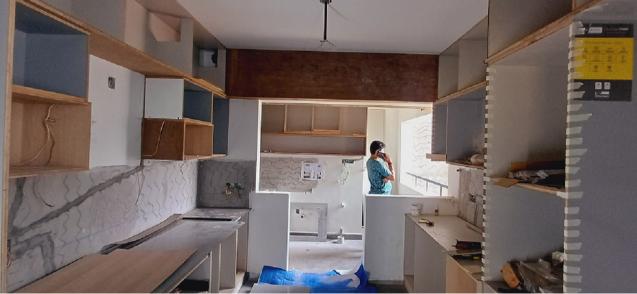

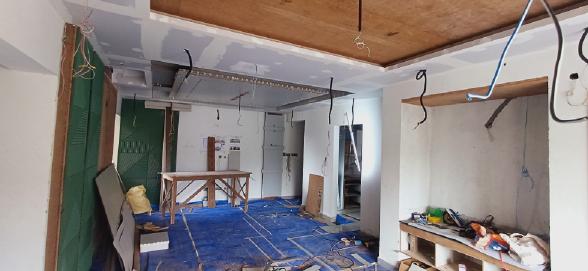

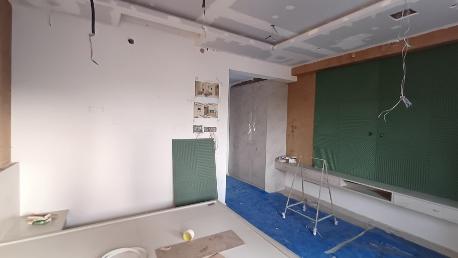

We are pleased to inform you the current work progress at our site Artech “Panorama”, Sasthamangalam, Few snaps of the work progress is attached for your reference.

  • Sub structural works – Pile concreting completed , pile chipping 66% completed (205 nos: completed out of 310 nos:), pile load test completed , pile integrity test completed
  • Building Area :- PCC for pile cap – completed , RCC for pile cap – completed , RCC pedestal column – completed , Plinth beam & Raft slab – completed, Lower Basement column RCC completed, Lower basement floor slab and beam – 1200 m2 completed out of 2016 m2, Upper basement slab concrete – 1050m2 completed out of 2400m2, RCC column upper basement – completed , Ground floor slab RCC – completed , GF to 1st floor column RCC completed , First floor slab – 892m2 completed out of 892m2 , Column First floor to second floor RCC completed, second floor slab RCC – 752m2 completed, Second floor to third floor column RCC 51nos: completed out of 51 nos:, 3rd floor slab – 752m2 completed, 3rd to 4th floor column RCC 51 nos: completed, 4th floor slab – 450m2 completed out of 752m2, 4th to 5th floor column RCC – 8nos: completed out of 51nos:
  • Podium Area:- PCC pile cap – 34 Nos: completed out of 58 Nos:, RCC pile cap – 34 Nos: completed out of 58 Nos:, RCC pile cap (STP) – completed, Lower basement column RCC – 23 Nos: completed out of 70 Nos:, Upper basement column RCC – 10 Nos: completed out of 52 Nos:, STP slab concrete – 46m2 completed
  • Boundary wall :- PCC pile cap – 6 Nos: completed out of 45 Nos:, RCC pile cap – 5 Nos: completed out of 45 Nos:, RCC wall – 40 Rm completed out of 250RM, Lower basement floor earth filling – 1350m2 completed out of 1750m2, Ramp concrete – 32Rm Completed out of 107Rm

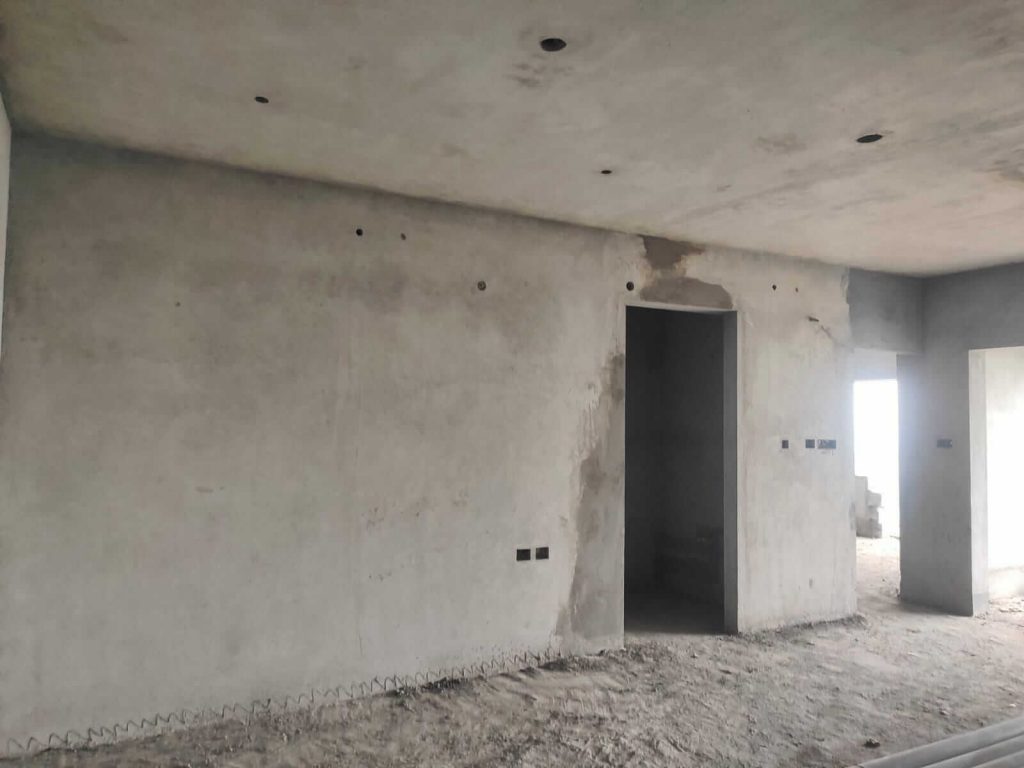

  • Ceiling plastering – Upper basement floor – 1000m2 completed out of 2400m2, Ground floor – 550m2 completed, First floor – 340m2 completed out of 892m2
