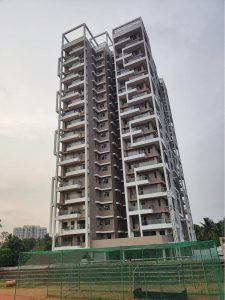

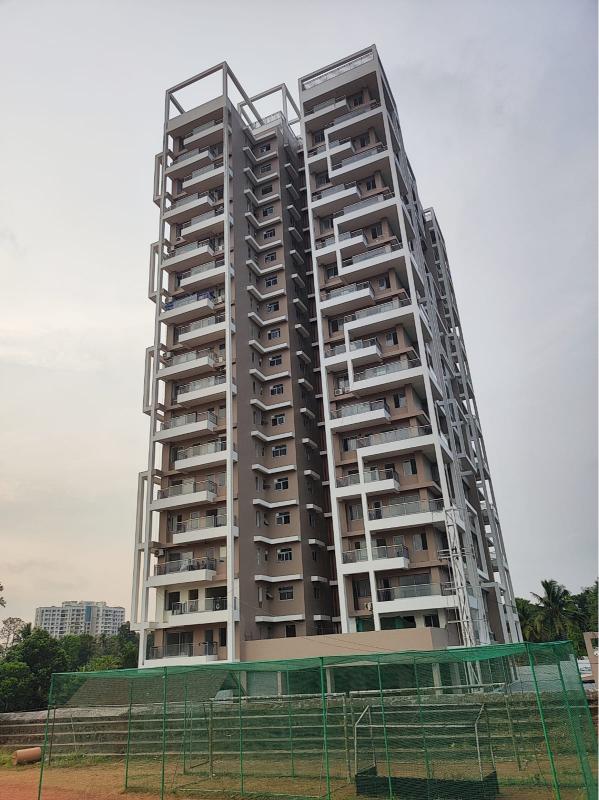

Work status as on 13-09-2023, we have completed the following.
- Structural Works – Pile cap – completed, slab – 95% completed, swimming pool base slab completed, swimming pool wall completed, ramp completed, retaining wall – 40% completed, compound wall – 60% completed (42m), LMR Base slab, roof completed, main and fire stair head room completed
- Civil Works – Ceiling plastering – 100% completed (till 1st – 20th floor), Basement floor – 80% completed, Ground floor – 70% completed, Masonry – Block/ brick – 98% completed (till 19th floor Completed), Internal plaster – 1st floor – completed, 94% completed (till 18th floor completed)
- Internal Finishes – Main door -sample flat only, Wall tiling – 3rd to 8th floor (toilets) – 90% completed, Flooring – 3rd floor completed, 4th, 5th, 6th, 7th, 8th, 9th floor (45% completed), putty works & Painting – putty 50% completed (till 11th floor 2 coat putty – completed, 10th to 16th floor one coat putty 90% completed, 17th floor – 90% completed, 18th floor – 80% completed, 1st Floor – 15% completed (2 coat primer, 2 coat putty), primer up to 18th floor completed, primer after two coat putty till 9th floor completed, Water proofing – 39% completed (till 12th floor bathrooms only, balcony – upto 12th floor 100% completed), Door frame fixtures – completed, Handrails – 20% completed (firestair handrail completed, Main stair – GF to 2nd floor, 17th to 19th floor completed, balcony handrail – frameonly – 70% completed)
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – 90% completed (till 15th floor completed,16th, 17th,18th floor – 40% completed), Corecutting – till 19th floor – 90% completed, Centralised Gas piping system- mock up only, Firefighting final fixtures – horizontal pipe line till 16th floor completed, vertical pipe line work – 60% completed, Electrical wire pulling – 3rd floor – 100% completed, 4th floor to 9th floor – 40% completed
- External Finishes – Windows & Sliding doors – 3rd floor – 90% completed, 4th floor – 90% completed, 5th floor,6th floor,7th floor – 75% completed, 8th, 9th, 10th – 30% completed , 11th to 18th floor – 20% completed, External Plastering – 98% completed (B flat outside), A Flat outside – 92% completed, E Flat outside – 97% completed, C Flat outside – 99% completed, D flat outside – 90% completed, External Painting – C,B,D outside area – 2 coat damp proof, 2 coat putty, one coat primer completed , E, A – 2 coat damp proof completed), plumbing duct line – 3rd to 9th floor floor completed
- Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer application 100% completed, First coat painting 100% completed, Final coat painting 100% completed
As per the current work status from our site, we are targeted to complete the following works by the end of SEPTEMBER 2023.
- Civil Works – Block work – Ground floor to be completed, Inside plastering – 19th floor 100% to be completed, GF to be completed
- Internal Finishes – Main door – 50% to be completed, wall tiling – 3rd to 13th floor 100% to be completed, Flooring – 4th to 10th floor 100% to be completed, Water proofing – 11th,12th – 50% to be completed, putty and painting – 10th to 16 th floor 2nd coat putty – 80% to be completed, primer after two coat putty till 14th floor to be completed, water proofing works – balcony and toilets – till 18th floors 100% to be completed, Handrails – Main stair 100% to be completed, balcony handrail 40% including glass portion to be completed
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – till 19th floor 100% to be completed, Firefighting final fixtures – 100% to be completed, Electrical wire pulling – 4th to 9th floor – 100% to be completed
- External Finishes – Windows & Sliding doors – 11th to 18th floor – 50% to be completed, External Plastering – 100% to be completed, External painting – E,A – 2 coat putty and one coat primer to be completed, plumbing duct line – till 19th floor to be completed
Work status as on 12-08-2023, we have completed the following.
- Structural Works – Pile cap – 82% completed, slab – 95% completed, swimming pool base slab completed, swimming pool wall completed, ramp completed, retaining wall – 40% completed, compound wall – 60% completed (42m), LMR Base slab completed
- Civil Works – Ceiling plastering – 100% completed (till 1st – 20th floor), Basement floor – 80% completed, Ground floor – 70% completed, Masonry – Block/ brick – 98% completed (till 19th floor Completed), Internal plaster – 1st floor – completed, 94% completed (till 18th floor completed)
- Internal Finishes – Main door -sample flat only, Wall tiling – 3rd to 8th floor (toilets) – 60% completed, Flooring – 3rd floor (A,B,C,D,E – 82% completed), 4th, 5th, 6th, 7th, 8th, 9th floor (25% completed), putty works & Painting – putty 50% completed (till 9th floor 2 coat putty – completed, 10th to 16th floor one coat putty 90% completed, 17th floor – 90% completed, 18th floor – 80% completed, 1st Floor – 15% completed (2 coat primer, 2 coat putty), primer up to 18th floor completed, Water proofing – 39% completed (till 12th floor bathrooms only, balcony – upto 12th floor 100% completed), Door frame fixtures -completed, Handrails – 20% completed (firestair handrail GF to 14th floor completed, Main stair – GF to 2nd floor, 17th to 19th floor completed, balcony handrail – frameonly – 70% completed)
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – 90% completed (till 12th floor, 13th floor – 60% completed , 14th,15th,16th floor – 20% completed, Corecutting – till 19th floor – 90% completed, Centralised Gas piping system- mock up only, Firefighting final fixtures – horizontal pipe line till 16th floor completed, vertical pipe line work – 50% completed, Electrical wire pulling – 3rd floor – 100% completed, 4th floor to 9th floor – 20% completed
- External Finishes – Windows & Sliding doors – 3rd floor – 90% completed, 4th floor – 90% completed, 5th floor,6th floor,7th floor – 75% completed, 8th, 9th, 10th – 30% completed External Plastering – 98% completed (B flat outside), A Flat outside – 92% completed, E Flat outside – 97% completed, C Flat outside – 99% completed, D flat outside – 90% completed, External Painting – primer – 60% completed, damp proof – 70% completed, one putty – 30% completed, 2nd coat – 15% completed)
- Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer application 100% completed, First coat painting 100% completed, Final coat painting 100% completed
As per the current work status from our site, we are targeted to complete the following works by the end of AUGUST 2023.
- Structural Works – LMR roof to be completed, main and fire stair head room to be completed
- Civil Works – Block work – Ground floor to be completed, Inside plastering – 19th floor 100% to be completed, GF to be completed
- Internal Finishes – Main door – 50% to be completed, wall tiling – 3rd to 13th floor 100% to be completed, Flooring – 3rd to 10th floor 100% to be completed, Water proofing – 11th,12th – 50% to be completed, putty and painting – 10th to 18 th floor 2nd coat putty – 80% to be completed, water proofing works – balcony and toilets – till 18th floors 100% to be completed, Haindrails – Main stair and Fire stair 100% to be completed
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – till 17th floor – 100% to be completed, Firefighting final fixtures – 100% to be completed, Electrical wire pulling – 4th to 9th floor – 50% to be completed
- External Finishes – External Plastering – 100% to be completed, External painting – Damp proof – 90% to be completed, one putty – 50% to be completed, 2nd coat – 50% to be completed, plumbing duct line – 50% to be completed
Work status as on 12-07-2023, we have completed the following.
- Structural Works – Pile cap – 82% completed, slab – 95% completed, swimming pool base slab completed, swimming pool wall – 60% completed, ramp completed, retaining wall – 30% completed, compound wall – 40% completed (42m), LMR – 30% Completed
- Civil Works – Ceiling plastering – 100% completed (till 1st – 20th floor), Basement floor – 80% completed, Ground floor – 50% completed, Masonry – Block/ brick – 98% completed (till 19th floor Completed), Internal plaster – 1st floor – 96% completed, 94% completed (till 18th floor completed)
- Internal Finishes – Main door -sample flat only, Wall tiling – 3rd to 8th floor (toilets) – 15% completed, Flooring – 3rd floor (A,B,C,D,E – 82% completed), 4th, 5th, 6th, 7th, 8th, 9th floor (25% completed), putty works & Painting – putty 50% completed (till 9th floor 2 coat putty – completed, 10th to 16th floor one coat putty 90% completed, 17th floor – 90% completed, 18th floor – 80% completed, 1st Floor – 15% completed (2 coat primer, 2 coat putty), 3rd,4th,5th floor 2nd coat putty completed, primer up to 18th floor completed, Water proofing – 39% completed (till 12th floor bathrooms only, balcony – upto 10th floor 75% completed), Door frame fixtures – 97% completed (18th floor – completed), Handrails – 20% completed (firestair handrail GF to 14th floor completed, balcony handrail – frameonly – 70% completed)
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – 58% completed (till 12th floor, 13th floor – 25% completed), Corecutting – till 19th floor – 90% completed, Centralised Gas piping system- mock up only, Firefighting final fixtures – horizontal pipe line till 16th floor completed, vertical pipe line work – 20% completed
- External Finishes – Windows & Sliding doors – 3rd floor – 90% completed, 4th floor – 90% completed, 5th floor,6th floor,7th floor – 75% completed, 8th, 9th, 10th – 30% completed External Plastering – 98% completed (B flat outside), A Flat outside – 92% completed, E Flat outside – 97% completed, C Flat outside – 99% completed, D flat outside – 90% completed, External Painting – primer – 60% completed, damp proof – 50% completed)
- Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer application 100% completed, First coat painting 100% completed, Final coat painting 100% completed
As per the current work status from our site, we are targeted to complete the following works by the end of JULY 2023.
- Structural Works – Amenities : Swimming pool wall – 80% to be completed, childrens play area, SHR, LMR to be completed
- Civil Works – Block work – Ground floor to be completed, Inside plastering – 1st floor – 100% to be completed, 19th floor 100% to be completed
- Internal Finishes – Water proofing – 11th,12th – 50% to be completed
Work status as on 06-06-2023, we have completed the following.
- Structural Works – Pile cap – 82% completed, slab – 95% completed, swimming pool base slab completed, swimming pool wall – 60% completed, ramp completed, retaining wall – 25% completed, compound wall – 40% completed (42m), LMR – 30% Completed
- Civil Works – Ceiling plastering – 100% completed (till 1st – 20th floor), Basement floor – 70% completed, Ground floor – 25% completed, Masonry – Block/ brick – 98% completed (till 19th floor Completed), Internal plaster – 1st floor – 96% completed, 94% completed (till 18th floor completed)
- Internal Finishes – Main door -sample flat only, Wall tiling – 3rd to 7th floor (toilets) – 15% completed, Flooring – 3rd floor (A,B,C,D,E – 82% completed), 4th, 5th, 6th, 7th, 8th, 9th floor (23% completed), putty works & Painting – putty 50% completed (till 9th floor 2 coat putty – completed, 10th to 16th floor one coat putty 90% completed, 17th floor – 80% completed, 18th floor – 50% completed, 1st Floor – 15% completed (2 coat primer, 2 coat putty), 3rd,4th,5th floor 2nd coat putty completed, primer up to 18th floor completed, Water proofing – 39% completed (till 12th floor bathrooms only, balcony – upto 10th floor 75% completed), Door frame fixtures – 97% completed (18th floor – completed), Handrails – 20% completed (firestair handrail GF to 14th floor completed, balcony handrail – frameonly – 70% completed))
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – 58% completed (till 11th floor), Corecutting – till 18th floor completed, 19th floor – 50% completed, Centralised Gas piping system- mock up only, Firefighting final fixtures – horizontal pipe line till 16th floor completed, vertical pipe line work – 15% completed
- External Finishes – Windows & Sliding doors – 3rd floor – 75% completed, 4th floor – 75% completed, 5th floor,6th floor,7th floor – 75% completed, 8th, 9th, 10th – 30% completed External Plastering – 98% completed (B flat outside), A Flat outside – 92% completed, E Flat outside – 97% completed, C Flat outside – 99% completed, D flat outside – 90% completed, External Painting – primer – 60% completed, damp proof – 50% completed)
- Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer application 100% completed, First coat painting 100% completed, Final coat painting 100% completed
As per the current work status from our site, we are targeted to complete the following works by the end of JUNE 2023.
- Structural Works – Amenities : Swimming pool wall – 80% to be completed, childrens play area, SHR, LMR to be completed
- Civil Works – Block work – Ground floor to be completed, Inside plastering – 1st floor – 100% to be completed, 19th floor 100% to be completed
- Internal Finishes – Water proofing – 11th,12th – 50% to be completed
Work status as on 05-05-2023, we have completed the following.
- Structural Works – Pile cap – 82% completed, slab – 95% completed, swimming pool base slab completed, swimming pool wall – 60% completed, ramp completed, retaining wall – 25% completed
- Civil Works – Ceiling plastering – 100% completed (till 1st – 20th floor), Masonry – Block/ brick – 98% completed (till 19th floor Completed), Internal plaster – 1st floor – 95% completed, 94% completed (till 18th floor completed)
- Internal Finishes – Main door -sample flat only, Wall tiling – 3rd to 7th floor (toilets) – 15% completed, Flooring – 3rd floor (A,B,C,D,E – 80% completed), 4th, 5th, 6th, 7th, 8th, 9th floor (20% completed), putty works & Painting – putty 50% completed (till 9th floor 2 coat putty – completed, 10th to 16th floor one coat putty 90% completed, 17th floor – 80% completed, 18th floor – 50% completed, 1st Floor – 15% completed (2 coat primer, 2 coat putty), primer up to 18th floor completed, Water proofing – 37% completed (till 12th floor bathrooms only, balcony – upto 8th floor 75% completed), Door frame fixtures – 95% completed (18th floor – completed), Handrails – 20% completed (firestair handrail GF to 14th floor completed, balcony handrail – frameonly – 70% completed))
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – 56% completed (till 10th floor), Corecutting – till 18th floor completed, Centralised Gas piping system- mock up only, Firefighting final fixtures – horizontal pipe line till 15th floor completed, fire alarm work started
- External Finishes – Windows & Sliding doors – 3rd floor – 75% completed, 4th floor – 75% completed, 5th floor,6th floor,7th floor – 50% completed, 8th, 9th, 10th – 20% completed External Plastering – 98% completed (B flat outside), A Flat outside – 92% completed, E Flat outside – 97% completed, C Flat outside – 99% completed, D flat outside – 90% completed, External Painting – primer – 60% completed, damp proof – 50% completed)
- Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer application 100% completed, First coat painting 100% completed, Final coat painting 100% completed
As per the current work status from our site, we are targeted to complete the following works by the end of MAY 2023.
- Structural Works – Amenities : Swimming pool wall – 80% to be completed, childrens play area, SHR, LMR to be completed
- Civil Works – Block work – 19th floor 100% to be completed, Inside plastering – 1st floor – 100% to be completed, 19th floor to be completed
- Internal Finishes – Wall tiling – 8th, 9th floor 50% to be completed, Waterproofing – balcony 9th, 10th – 80% to be completed
- Electrical, Plumbing & Firefighting works – Concealed plumbing work – 60% to be completed
- External Finishes – Windows & Sliding doors – up to 10th floor 80% to be completed
Work status as on 08-04-2023, we have completed the following.
- Structural Works – Pile cap – 82% completed, slab – 95% completed, swimming pool base slab completed, swimming pool wall – 60% completed, ramp completed, retaining wall – 25% completed
- Civil Works – Ceiling plastering – 100% completed (till 1st – 20th floor), Masonry – Block/ brick – 98% completed (till 19th floor Completed), Internal plaster – 1st floor – 90% completed, 94% completed (till 18th floor completed)
- Internal Finishes – Main door -sample flat only, Wall tiling – 3rd to 7th floor (toilets) – 14% completed, Flooring – 3rd floor (A,B,C,D,E – 80% completed), 4th, 5th, 6th, 7th, 8th, 9th floor (18% completed), putty works & Painting – putty 50% completed (till 9th floor 2 coat putty – completed, 10th to 16th floor one coat putty 90% completed, 17th floor – 80% completed, 18th floor – 50% completed, 1st Floor – 15% completed (2 coat primer, 2 coat putty), primer up to 18th floor completed, Water proofing – 37% completed (till 12th floor bathrooms only, balcony – upto 8th floor 75% completed), Door frame fixtures – 95% completed (18th floor – 80% completed), Handrails – 20% completed (firestair handrail GF to 14th floor completed, balcony handrail – frameonly – 70% completed))
- Electrical, Plumbing & Firefighting works – Concealed plumbing works – 56% completed (till 10th floor), Corecutting – till 16th floor completed, Centralised Gas piping system- mock up only, Firefighting final fixtures – horizontal pipe line till 15th floor completed, fire alarm work started
- External Finishes – Windows & Sliding doors – 3rd floor – 75% completed, 4th floor – 75% completed, External Plastering – 98% completed (B flat outside), A Flat outside – 92% completed, E Flat outside – 97% completed, C Flat outside – 99% completed, D flat outside – 90% completed, External Painting – primer – 60% completed, damp proof – 50% completed)
- Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer application 100% completed, First coat painting 100% completed, Final coat painting 100% completed
As per the current work status from our site, we are targeted to complete the following works by the end of APRIL 2023.
- Structural Works – Amenities : Swimming pool wall – 80% to be completed, childrens play area, SHR, LMR to be completed
- Civil Works – Block work – 19th floor 100% to be completed, Inside plastering – 1st floor – 100% to be completed, 19th floor to be completed
- Internal Finishes – Wall tiling – 8th, 9th floor 50% to be completed, Waterproofing – balcony 9th, 10th – 80% to be completed
- Electrical, Plumbing & Firefighting works – Concealed plumbing work – 60% to be completed
- External Finishes – Windows & Sliding doors – up to 7th floor 80% to be completed
