ArtechRainforest

3 BHK Flats in Trivandrum , 4 BHK Flats in Trivandrum , Builders in Trivandrum , Luxury apartments in trivandrum , Ongoing , Residential , Trivandrum
Jawahar Nagar | Trivandrum

RERA Number: K-RERA/PRJ/270/2020

Project Description

Rainforest a joint venture between Artech & B’ Canti is Kerala’s Greenest Apartment Complex and a project that is nothing like what you have seen before. With 78 ultra-luxurious Apartments, Rainforest is set in one of Trivandrum’s most prestigious locations – Jawahar Nagar, where the ‘crème de la crème’ of the city reside. The unique aspects about Rainforest are the forest inspired ground floor landscape, the tree filled void spaces and the multi-level green community.

At the Rainforest, every apartment window opens onto green vistas.The complex offers 3 & 4 BHK Apartments in 25 different layout options, measuring 2000 sq.ft. to 3840 sq.ft. Some of the select amenities offered at the Rainforest are Health Club, Concierge Service, Guest Suites, Sauna, Spa, Rain water harvesting, Pool, Party Space and so much more to make living here a hearty & serene experience. In the Rainforest you are near to it all and yet so far!

QUICK
ENQUIRE

Take your first few steps towards finding the ultimate happiness of the Perfect Home.
  • Health Club
  • Sauna Bath/Steam bath
  • Swimming Pool
  • Association Hall
  • AV Room
  • Guest suite
  • Drivers Rest Room.
  • Party space
  • Children’s Play Area
  • WIFI Lobby
  • Spa
  • Indoor Games Room
  • Video Door Phone
  • F.T.T.H
  • Rain Water Harvesting
  • Reticulated Gas System
  • Incinerator

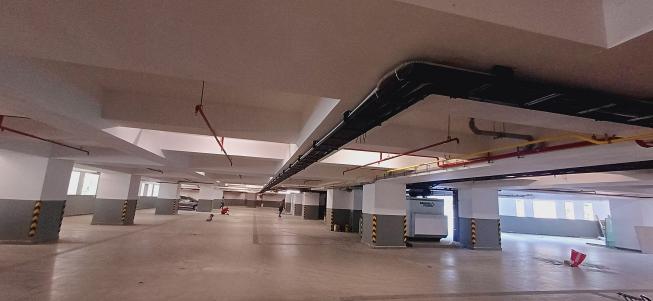

Work status as on 10-02-2024, we have completed the following.

  • Structural Works – Swimming pool wall – completed, basement 2 level parapet -completed, Ground floor parapet – completed, GF Landscape structure work – 60% completed
  • Civil Works – Ceiling and wall plastering 85% completed, Masonry – Block/ brick- Basement 1 floor 100% completed, basement 2 floor – 100% completed, Ground floor – completed, GF duct brick work – completed, Inside plastering – Basement 2 inside wall plastering completed, water tank plastering completed
  • Internal Finishes – Main door – 82 apartments completed, Waterproofing – terrace – 90% completed, GF landscape area – 50% completed, wall tiling – 74 apartments completed, flooring – 74 apartments completed, putty works – 100% completed, Door frame fixtures- 100% completed, Handrails – fire stair handrail – 100% Completed, Main stair handrail – 60% completed, Balcony handrails – 75% completed, parapet GI railing – 85% completed
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 81 nos: completed, Centralised gas piping system – 58 apartments completed, fire fighting work – 1st to 12th floor – 100% completed, BF 1 – 60% Completed, Electrical LT work – wire pulling – 79 apartments completed, HT work – 72 apartments completed, HVAC work – 21 apartments completed
  • Final Finishes – Door shutters & ironmongery – 6 apartments completed, Plumbing and Sanitary wares – sample flat, 6G, 2D completed, Electrical final fixtures – sample flat, 6G, 2D completed, fire final fixtures – sample flat, 6G, 2D completed
  • External Finishes – Windows and sliding doors – 75% completed, duct door – 75% completed, External plastering – B2 & B1 floor – 90% completed. External painting – primer 95% completed
  • Landscape Work – Landscape work – 10% completed
  • Mockup – Completed.

As per the current work status from our site, we are targeted to complete the following works by the end of FEBRUARY 2024.

  • Structural Works – Ground floor Landscape structure work – 75% to be completed
  • Internal Finishes – Waterproofing – terrace 100% to be completed, GF landscape area 70% to be completed, Flooring – 2 more apartments to be completed, Wall tiling – 2 more apartments to be completed, Balcony handrail – 80% to be completed, Main stair handrail – 100% to be completed, parapet GI railing – 100% to be completed
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 1 no more to be completed, Centralised gas piping system – 60 apartments to be completed, fire fighting work – BF 1 100% to be completed, Electrical LT work – wire pulling 2 more apartments to be completed, HVAC work – 23 more apartments to be completed
  • Final Finishes – Plumbing and Sanitary wares – 10B to be completed, Electrical final fixtures – 10B to be completed , fire final fixtures – 10B to be completed
  • External Finishes – Windows and sliding doors – 85% to be completed, Duct door – 100% to be completed, External plastering B2 & B1 floor – 100% to be completed, Painting – primer 100% to be completed
  • Landscape Work – Landscape work – 20% to be completed

Work status as on 13-01-2024, we have completed the following.

  • Structural Works – Swimming pool wall – completed, basement 2 level parapet -completed, Ground floor parapet – completed, GF Landscape structure work – 50% completed
  • Civil Works Ceiling and wall plastering 85% completed, Masonry – Block/ brick- Basement 1 floor 100% completed, basement 2 floor – 99% completed, Ground floor – completed, GF duct brick work – completed, Inside plastering – Basement 2 inside wall plastering completed, water tank plastering completed
  • Internal Finishes – Main door – 82 apartments completed, Waterproofing – terrace – 85% completed, GF landscape area – 40% completed, wall tiling – 72 apartments completed, flooring – 72 apartments completed, putty works – 100% completed, Door frame fixtures- 100% completed, Handrails – fire stair handrail – 100% Completed, Main stair handrail – 60% completed, Balcony handrails – 70% completed, parapet GI railing – 50% completed
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 81 nos: completed, Centralised gas piping system – 58 apartments completed, fire fighting work – 1st to 12th floor – 100% completed, Electrical LT work – wire pulling – 79 apartments completed, HT work – 72 apartments completed, HVAC work – 19 apartments completed
  • Final Finishes – Door shutters & ironmongery – sample flat, 6G completed, Plumbing and Sanitary wares – sample flat, 6G, 2D completed, Electrical final fixtures – sample flat, 6G, 2D completed
  • External Finishes – Windows and sliding doors – 75% completed, duct door – 66% completed, External plastering – B2 & B1 floor – 60% completed. External painting – primer 95% completed
  • Mockup Completed.

As per the current work status from our site, we are targeted to complete the following works by the end of JANUARY 2024.

  • Structural Works – Ground floor Landscape structure work – 75% to be completed
  • Civil Works Masonry – Block/Brick – basement 2 floor – 100% to be completed
  • Internal Finishes – Waterproofing – terrace 100% to be completed, GF landscape area 60% to be completed, Flooring – 2 more apartments to be completed, Wall tiling – 2 more apartments to be completed, Balcony handrail – 80% to be completed, Main stair handrail – 100% to be completed, parapet GI railing – 100% to be completed
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 1 no more to be completed, Centralised gas piping system – 60 apartments to be completed, Electrical LT work – wire pulling 2 more apartments to be completed
  • External Finishes – Windows and sliding doors – 85% to be completed, Duct door – 75% to be completed, External plastering B2 & B1 floor – 80% to be completed, Painting – primer 100% to be completed

Work status as on 08-12-2023, we have completed the following.

  • Structural Works – Swimming pool wall – completed, basement 2 level parapet -completed, Ground floor parapet – completed, GF Landscape structure work – 50% completed
  • Civil Works – Ceiling and wall plastering 85% completed, Masonry – Block/ brick- Basement 1 floor 100% completed, basement 2 floor – 99% completed, Ground floor – completed, GF duct brick work – 20% completed, Inside plastering – Basement 2 inside wall plastering completed, water tank plastering completed
  • Internal Finishes – Main door – 82 apartments completed, Waterproofing – terrace – 85% completed, wall tiling – 72 apartments completed, flooring – 72 apartments completed, putty works – 100% completed, Door frame fixtures- 100% completed, Handrails – fire stair handrail – 100% Completed, Main stair handrail – 60% completed, Balcony handrails – 60% completed
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 79 nos: completed, Centralised gas piping system – 46 apartments completed, fire fighting work – 1st to 11th floor – 100% completed, Electrical LT work – wire pulling – 79 apartments completed, HT work – 72 apartments completed, HVAC work – 14 apartments completed
  • Final Finishes – Door shutters & ironmongery – sample flat, 6G completed, Plumbing and Sanitary wares – sample flat, 6G, 2D completed, Electrical final fixtures – sample flat, 6G, 2D completed
  • External Finishes – Windows and sliding doors – 75% completed, duct door – 66% completed, External plastering – B2 & B1 floor – 40% completed. External painting – primer 95% completed
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer 100% completed, HVAC -100% completed, Flooring – 100% completed, balcony handrail – 100% completed, duct door – 100% completed.

As per the current work status from our site, we are targeted to complete the following works by the end of DECEMBER 2023.

  • Structural Works – Ground floor Landscape structure work – 75% to be completed
  • Civil Works – Masonry – Block/Brick – basement 2 floor – 100% to be completed, GF duct brick work – 100% to be completed
  • Internal Finishes – Waterproofing – terrace 100% to be completed, Flooring – 2 more apartments to be completed, Wall tiling – 2 more apartments to be completed, Balcony handrail – 75% to be completed, Main stair handrail – 100% to be completed
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 2 nos more to be completed, Centralised gas piping system – 60 apartments to be completed, fire fighting work – 12th floor to be completed, Electrical LT work – wire pulling 2 more apartments to be completed
  • External Finishes – Windows and sliding doors – 85% to be completed, Duct door – 75% to be completed, External plastering B2 & B1 floor – 80% to be completed, Painting – primer 100% to be completed

Work status as on 10-11-2023, we have completed the following.

  • Structural Works – Swimming pool wall – completed, basement 2 level parapet – 100% completed, Ground floor parapet – completed, GF Landscape structure work – 25% completed
  • Civil Works – Ceiling and wall plastering 85% completed, Masonry – Block/ brick- Basement 1 floor 100% completed, basement 2 floor – 99% completed, Ground floor – completed, Basement 2 inside wall plastering completed
  • Internal Finishes – Main door – 82 apartments completed, Waterproofing – terrace – 85% completed, wall tiling – 63 apartments completed, flooring – 62 apartments completed, putty works – 100% completed, Door frame fixtures- 100% completed, Handrails – fire stair handrail – 100% Completed, Main stair handrail – 60% completed, Balcony handrails – 40% completed
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 76 nos: completed, , Centralised gas piping system – 17 apartments completed, fire fighting work – 1st to 11th floor – 100% completed, Electrical LT work – wire pulling – 68 apartments completed, HT work – 72 apartments completed, HVAC work – 14 apartments completed
  • External Finishes – Windows and sliding doors – 65% completed, duct door – 66% completed, External plastering – B2 & B1 floor – 40% completed. External painting – primer 95% completed
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer 100% completed, HVAC -100% completed, Flooring – 100% completed, balcony handrail – 100% completed, duct door – 100% completed.

As per the current work status from our site, we are targeted to complete the following works by the end of NOVEMBER 2023.

  • Structural Works – Ground floor Landscape structure work – 75% to be completed
  • Civil Works – Masonry – Block/Brick – basement 2 floor – 100% to be completed.
  • Internal Finishes – Waterproofing – terrace 100% to be completed, Flooring – 2 more apartments to be completed, Wall tiling – 2 more apartments to be completed, Balcony handrail – 60% to be completed. Main stair handrail – 100% to be completed
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 4 nos more to be completed, fire fighting work – 12th floor to be completed, Electrical LT work – wire pulling 2 more apartments to be completed
  • External Finishes – Windows and sliding doors – 75% to be completed, Duct door – 75% to be completed, External plastering B2 & B1 floor – 60% to be completed. Painting – primer 100% to be completed

Work status as on 10-10-2023, we have completed the following.

  • Structural Works – Swimming pool wall – completed, basement 2 level parapet – 100% completed, Ground floor parapet – 75% completed
  • Civil Works – Ceiling and wall plastering 85% completed, Masonry – Block/ brick- Basement 1 floor 100% completed, basement 2 floor – 95% completed, Ground floor – completed, water tank plastering – 100% completed
  • Internal Finishes – Main door – 82 apartments completed, Waterproofing – terrace – 85% completed, Sump tank – completed, OHT – Completed, wall tiling – 62 apartments completed, flooring – 62 apartments completed, putty works – 100% completed, Door frame fixtures- 100% completed, Handrails – fire stair handrail – 100% Completed, Balcony handrails – 40% completed
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 76 nos: completed, Corridor handrail works – 95% completed, Centralised gas piping system – mockup only, fire fighting work – 1st to 11th floor – 100% completed, Electrical LT work – wire pulling – 68 apartments completed, HT work – 72 apartments completed, HVAC work – 14 apartments completed
  • External Finishes – Windows and sliding doors – 65% completed, duct door – 66% completed, External plastering – B2 & B1 floor – 25% completed. External painting – primer 95% completed
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer 100% completed, HVAC -100% completed, Flooring – 100% completed, balcony handrail – 100% completed, duct door – 100% completed.

As per the current work status from our site, we are targeted to complete the following works by the end of OCTOBER 2023.

  • Structural Works – Ground floor parapet – 100% to be completed
  • Civil Works – Masonry – Block/Brick – basement 2 floor – 100% to be completed. Basement 2 inside wall plastering 100% to be completed
  • Internal Finishes – Waterproofing – terrace 100% to be completed, Flooring – 4 more apartments to be completed, Wall tiling – 4 more apartments to be completed, Balcony handrail – 60% to be completed. Main stair handrail – 100% to be completed
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 4 nos more to be completed, Corridor handrail works – 100% to be completed, fire fighting work – 12th floor to be completed, Electrical LT work – wire pulling 5 more apartments to be completed
  • External Finishes – Windows and sliding doors – 75% to be completed, Duct door – 75% to be completed, External plastering B2 & B1 floor – 50% to be completed. Painting – primer 100% to be completed

Work status as on 13-09-2023, we have completed the following.

  • Structural Works – Swimming pool wall – completed, basement 2 level parapet – 99% completed, Ground floor parapet – 50% completed
  • Civil Works – Ceiling and wall plastering 85% completed, Masonry – Block/ brick- Basement 1 floor 100% completed, basement 2 floor – 85% completed, Ground floor – completed, water tank plastering – 100% completed
  • Internal Finishes – Main door – 82 apartments completed, Waterproofing – terrace – 85% completed, Sump tank – completed, OHT – Completed, wall tiling – 57 apartments completed, flooring – 56 apartments completed, putty works – 100% completed, Door frame fixtures- 100% completed, Handrails – fire stair handrail – 100% Completed, Balcony handrails – 25% completed
  • Electrical, Plumbing & Firefighting works – Main door – 82 apartments completed, Waterproofing – terrace – 85% completed, Sump tank – completed, OHT – Completed, wall tiling – 57 apartments completed, flooring – 56 apartments completed, putty works – 100% completed, Door frame fixtures- 100% completed, Handrails – fire stair handrail – 100% Completed, Balcony handrails – 25% completed
  • External Finishes – Windows and sliding doors – 50% completed, duct door – 66% completed, External plastering – 95% completed, External painting – primer 95% completed
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer 100% completed, HVAC -100% completed, Flooring – 100% completed, balcony handrail – 100% completed, duct door – 100% completed.

As per the current work status from our site, we are targeted to complete the following works by the end of SEPTEMBER 2023.

  • Structural Works – basement 2 level parapet – 100% to be completed, Ground floor parapet – 75% to be completed
  • Civil Works – basement 2 level parapet – 100% to be completed, Ground floor parapet – 75% to be completed
  • Internal Finishes – Waterproofing – terrace 100% to be completed, Flooring – 4 more apartments to be completed, Wall tiling – 4 more apartments to be completed, Balcony handrail – 35% to be completed
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 6 nos: more to be completed, Corridor handrail works – 100% to be completed, fire fighting work – 12th floor to be completed, Electrical LT work – wire pulling 7 more apartments to be completed, HVAC work – 7 more apartments to be completed
  • External Finishes – Concealed plumbing works – 6 nos: more to be completed, Corridor handrail works – 100% to be completed, fire fighting work – 12th floor to be completed, Electrical LT work – wire pulling 7 more apartments to be completed, HVAC work – 7 more apartments to be completed

Work status as on 12-08-2023, we have completed the following.

  • Structural Works – Swimming pool wall – completed, basement 2 level parapet – 95% completed, Ground floor parapet – 35% completed
  • Civil Works – Ceiling and wall plastering 85% completed, Masonry – Block/ brick- Basement 1 floor 100% completed, basement 2 floor – 75% completed, Ground floor – 95% completed, water tank plastering – 100% completed
  • Internal Finishes – Main door – 80 apartments completed, Waterproofing – terrace – 85% completed, Sump tank – completed, OHT – Completed, wall tiling – 53 apartments completed, flooring – 51 apartments completed, putty works – 100% completed, Door frame fixtures- 100% completed, Handrails – fire stair handrail – 100% Completed, Balcony handrails – 15% completed
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 72 nos: completed, Corridor handrail works – 95% completed, Centralised gas piping system – mockup only, fire fighting work – 1st to 10th floor – 100% completed, Electrical LT work – wire pulling – 60 apartments completed, HT work – 66 apartments completed, HVAC work – 14 apartments completed
  • External Finishes – Windows and sliding doors – 40% completed, duct door – 65% completed, External plastering – 95% completed, External painting – primer 95% completed
  • Mockup – Blockwork, Internal plaster – 100% completed, Firefighting – 100% completed, Concealed plumbing – 100% completed, Waterproofing – 100% completed, Electrical wall services – 100% completed, Reticulated gas piping – 100% completed, Painting – Primer 100% completed, HVAC -100% completed, Flooring – 100% completed, balcony handrail – 100% completed, duct door – 100% completed.

As per the current work status from our site, we are targeted to complete the following works by the end of AUGUST 2023.

  • Structural Works – basement 2 level parapet – 100% to be completed, Ground floor parapet – 50% to be completed
  • Civil Works – Masonry – Block/Brick – basement 2 floor – 100% to be completed, Ground floor – 100% to be completed
  • Internal Finishes – Waterproofing – terrace 100% to be completed, Flooring – 4 more apartments to be completed, Wall tiling – 4 more apartments to be completed, Balcony handrail – 25% to be completed
  • Electrical, Plumbing & Firefighting works – Concealed plumbing works – 6 nos: more to be completed, Corridor handrail works – 100% to be completed, fire fighting work – 11th floor to be completed, Electrical LT work – wire pulling 7 more apartments to be completed, HVAC work – 7 more apartments to be completed
  • External Finishes – Windows and sliding doors – 50% to be completed, Duct door – 75% to be completedExternal plastering – 100% to be completed, Painting – primer 100% to be completed
