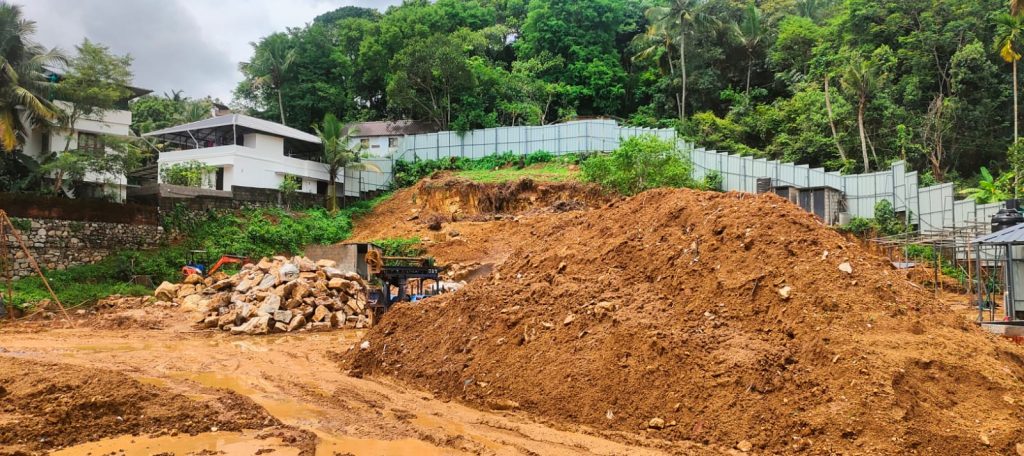

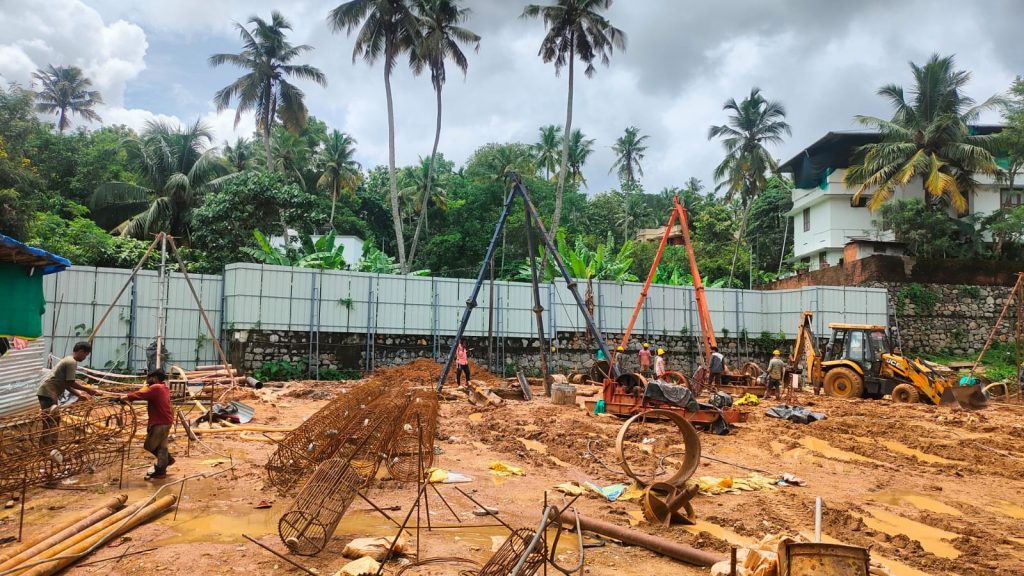

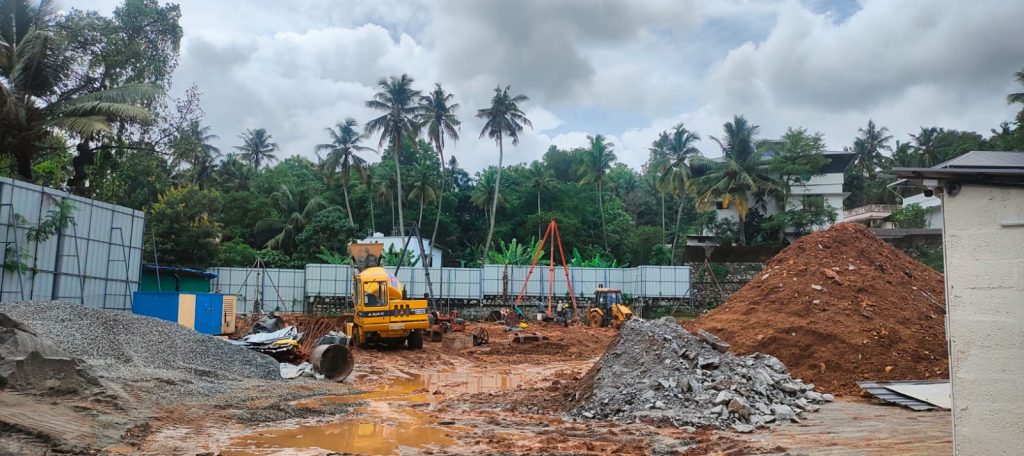

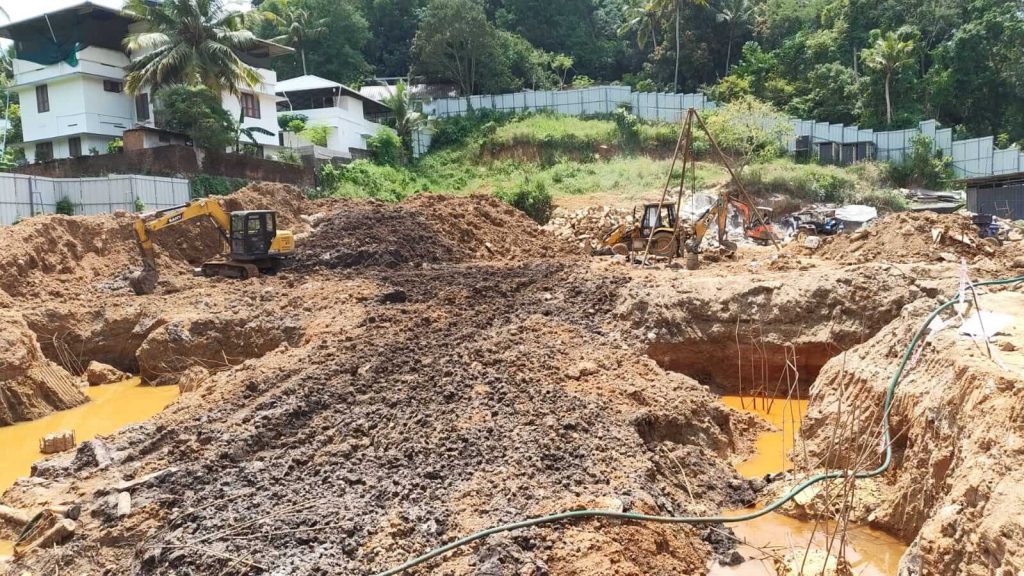

Work status as of 07-11-2026, We have completed the following

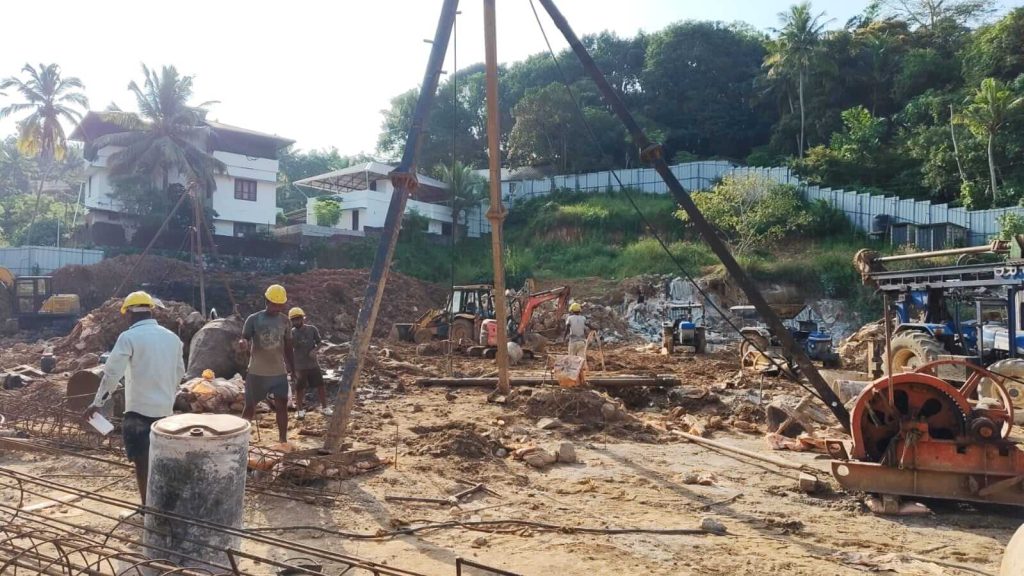

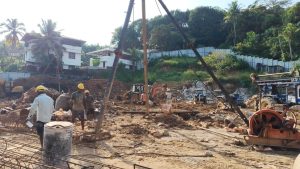

- Sub Structural Works :Piling Works : 100% Completed 109 Piles
- Pile Integrety Test : Completed (26 no of piles)

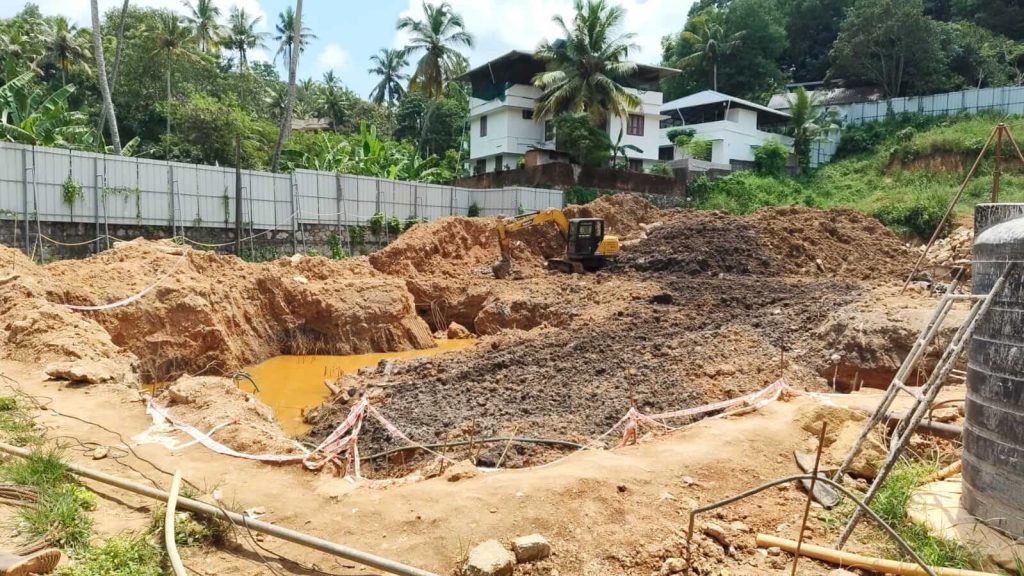

- Pile Cap Excavation : Work Ongoing

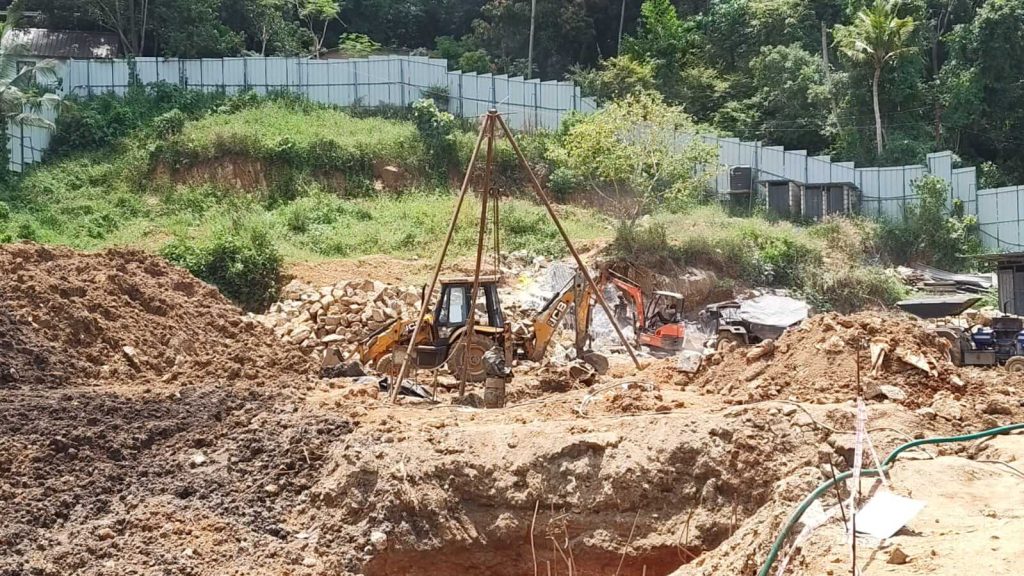

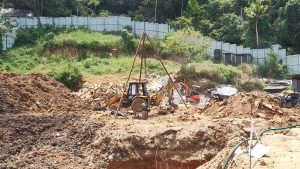

- Pile Chipping : Work Continuing at STP portion

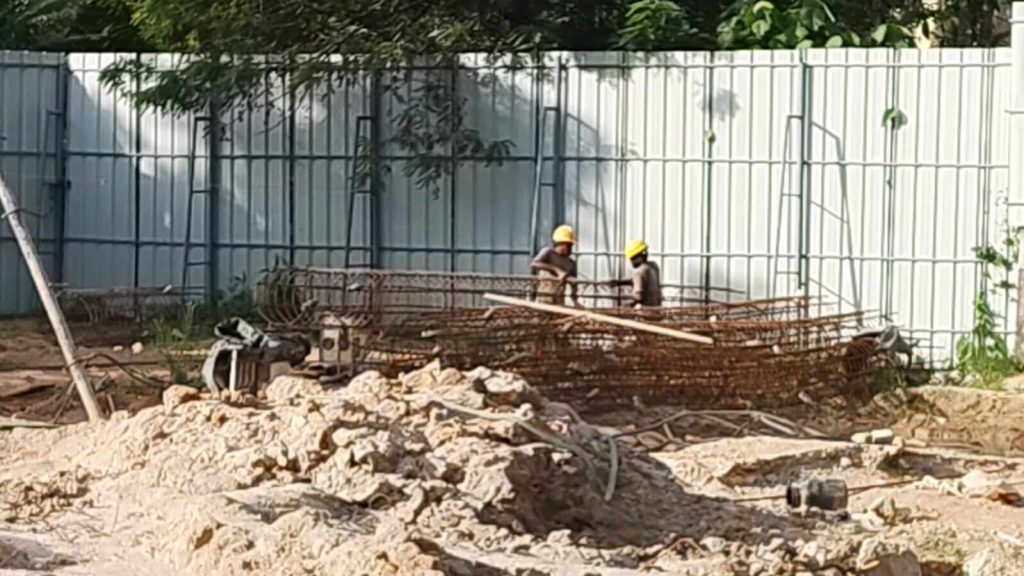

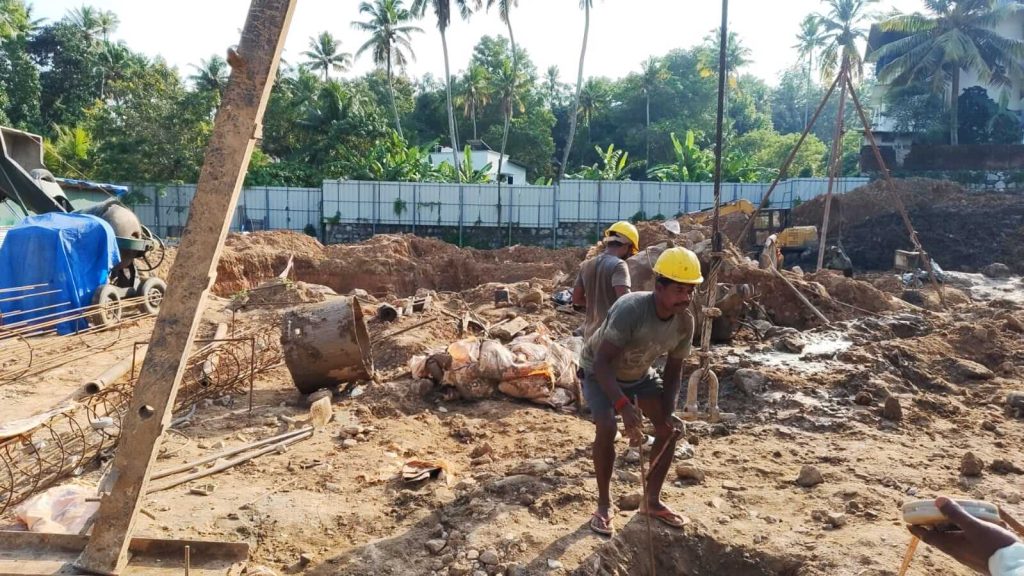

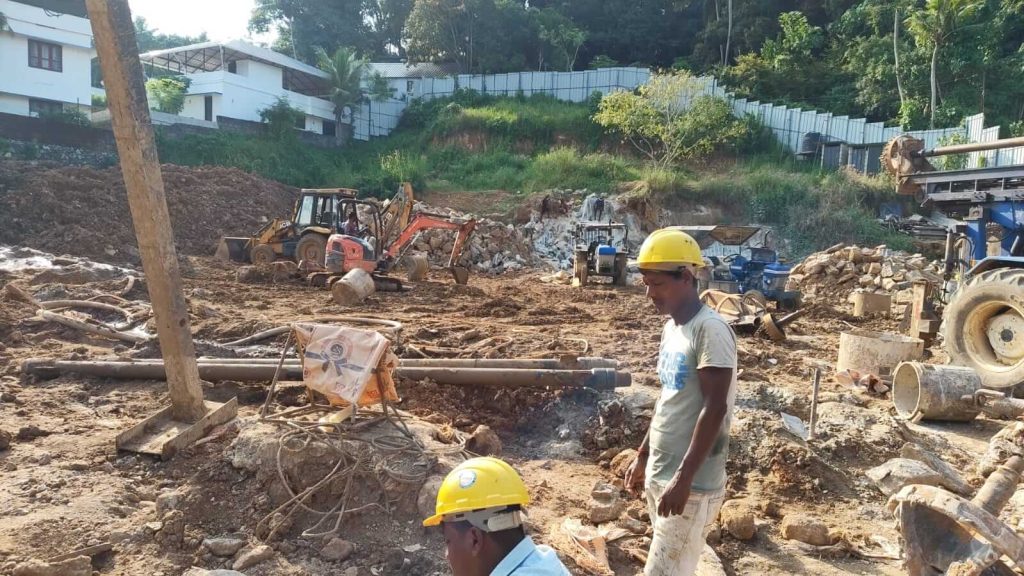

- Pile Cap RCC : Works Started

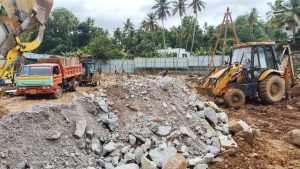

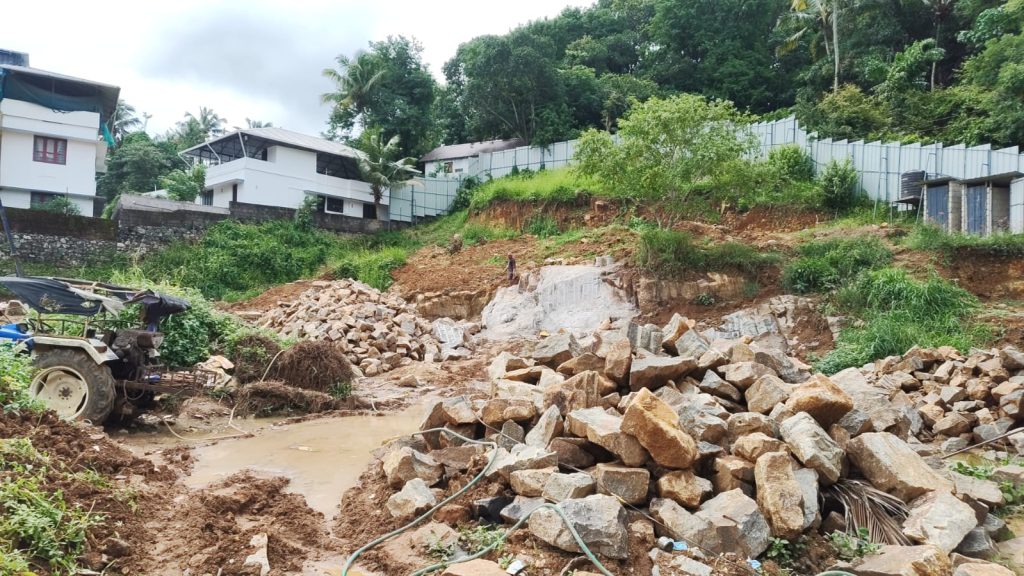

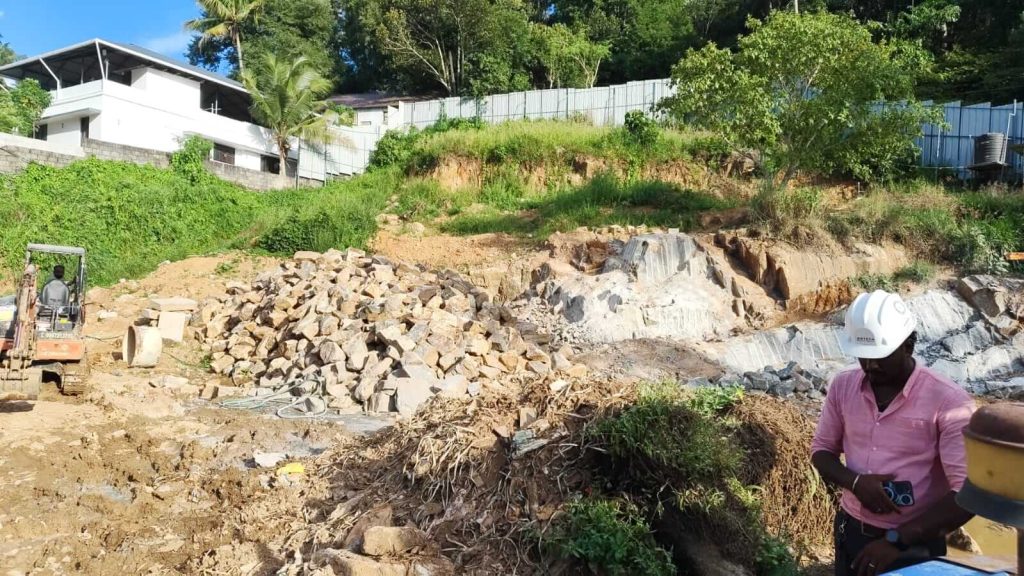

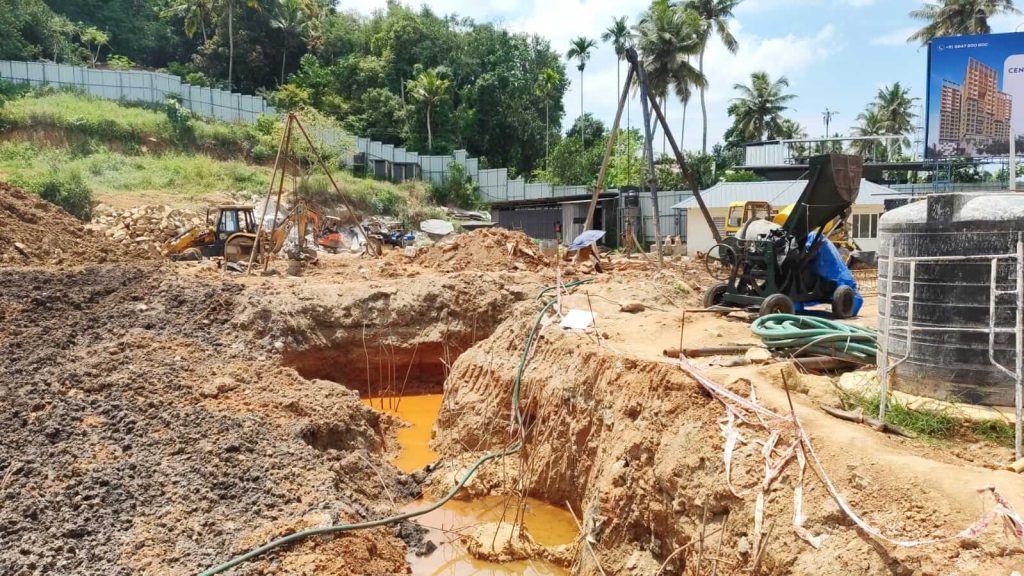

- Rock Breaking : 55% of the Rock Breaking Works Completed
As per the current site work status, we are targeted to complete the following work by the end of NOV 2026.

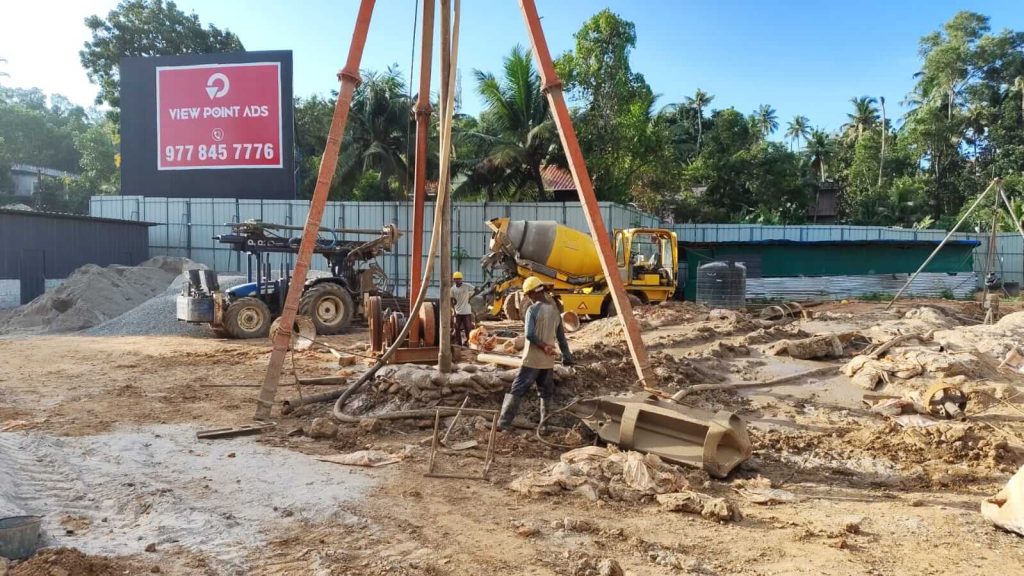

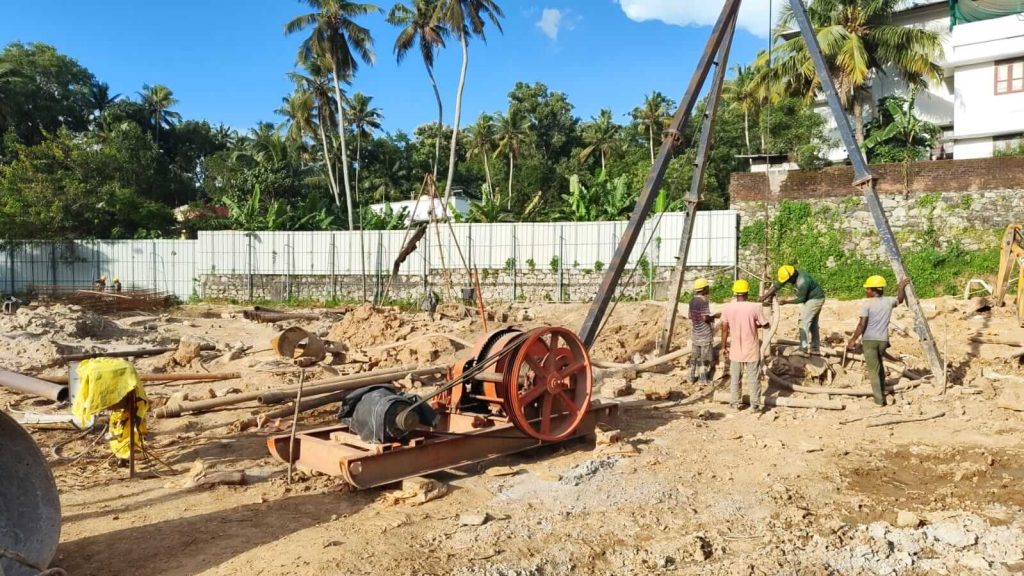

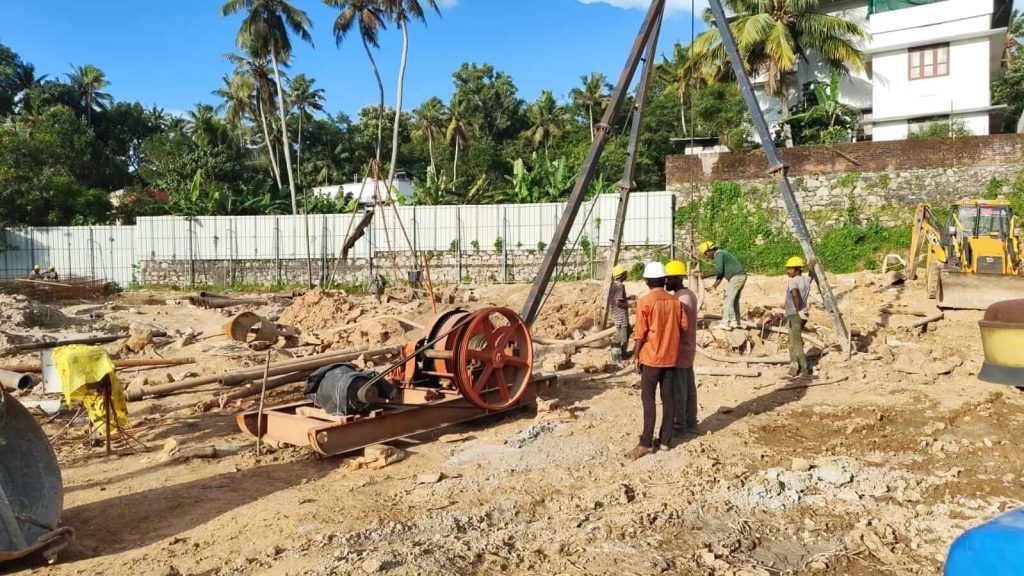

- Sub Structural Works :Pile Load Test : 1 Pile Load Test will be carried out.
- Pile Cap Excavation : 27 No’s out of 58 Pile Caps to be Completed
- Pile Chipping : 25 No’s out of 109 No’s to be completed
- Pile Cap RCC : 20 No’s to be completed out of 58 Pile Caps
- Rock Breaking : 100m3 of Rock will be removed.
Work status as of 07-10-2026, We have completed the following
- Sub Structural Works – Piling work – Out of 109 pile ,99nos completed
- Rock breaking -approximately 100 m3 of rocks were removed
- Pile excavation at STP area started.
- Pile chipping-26 no of pile chipping started at STP area.
As per the current site work status, we are targeted to complete the following work by the end of OCT 2026.
- Pile work-Total completion
- Rock breaking- approximate 100m3 of rock will be removed
- Pile excavation -70% excavation to be complete.
- Pile chipping-60% pile chipping to be complete.
Work status as of 09-09-2026, We have completed the following
- Sub Structural Works – Piling work – Out of 109 pile ,78nos completed
- Rock breaking – approximately 65 m3 of rocks were removed
As per the current site work status, we are targeted to complete the following work by the end of Sep 2026.
- Sub Structural Works – Piling work – 31nos pile will be completed
- Rock breaking – approximate 100m3 of rock will be removed

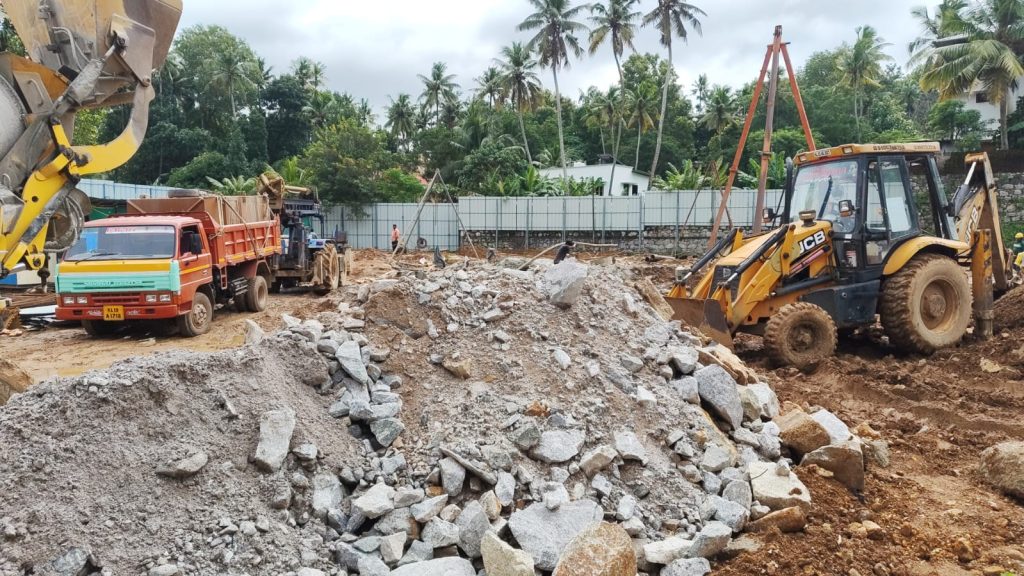

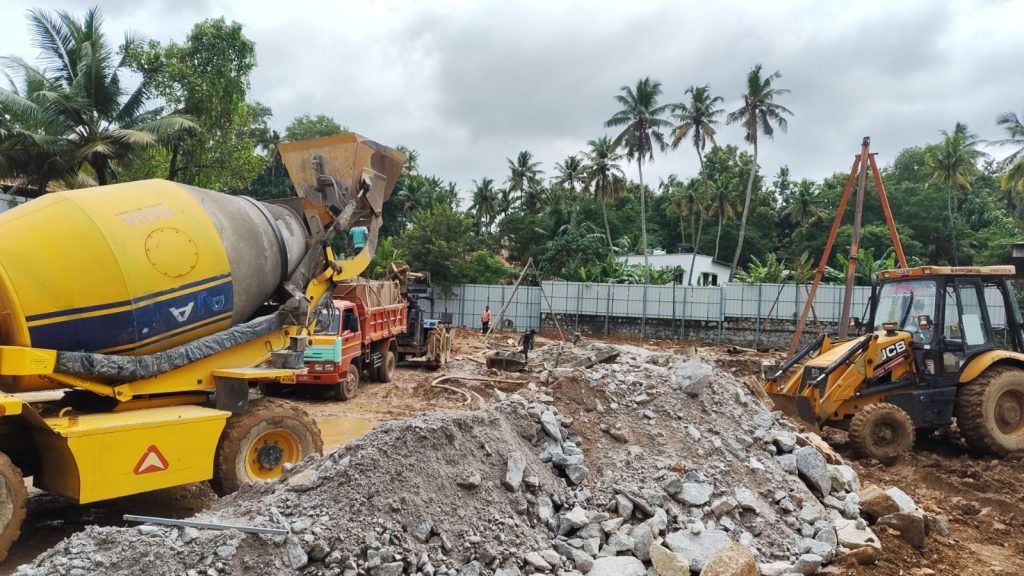

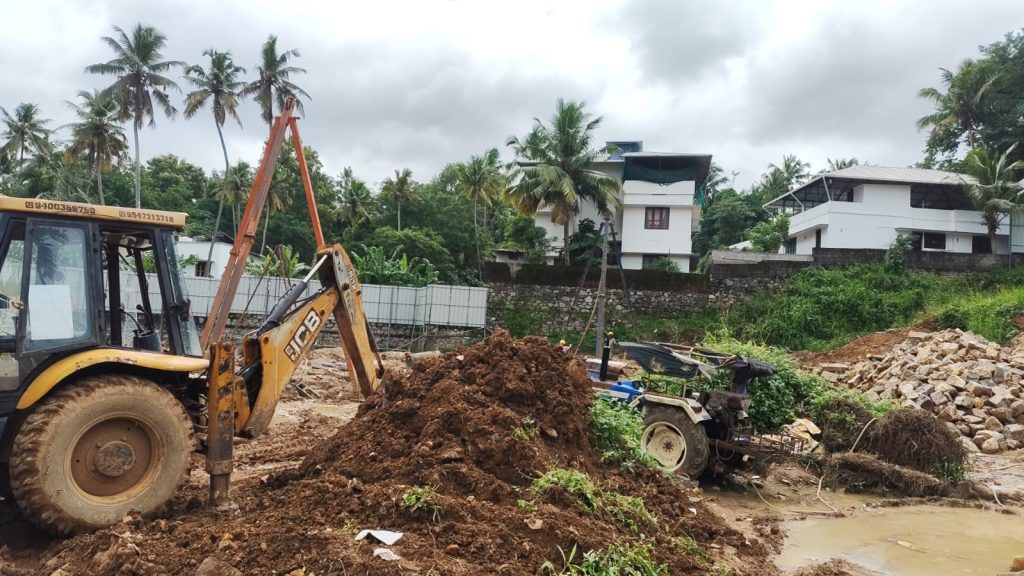

Work status as of 10-08-2026,, We have completed the following
- Sub Structural Works – Piling work – Out of 109 pile ,55nos completed
- Rock breaking -approximately 100 m3 of rocks were removed
As per the current site work status, we are targeted to complete the following work by the end of Aug 2026.
- Sub Structural Works- Piling work -30nos pile will be completed
- Rock breaking- approximate 100m3 of rock will be removed
Work status as of 09-06-2026, We have completed the following
- Sub Structural Works – Piling work – Out of 108 pile ,5nos completed
As per the current site work status, we are targeted to complete the following work by the end of June 2026.
- Sub Structural Works- Rock breaking -approximately 100 m3 of rocks were removed site levelling and clearing using JCB and hitachi
