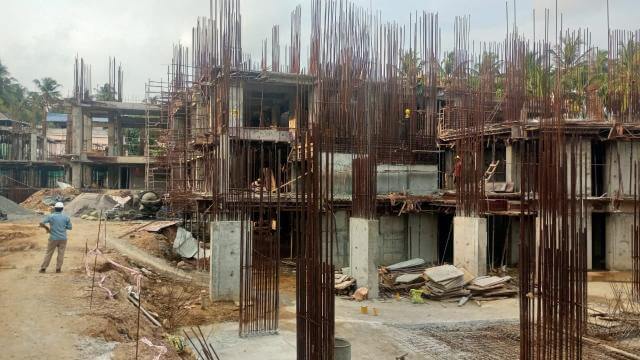

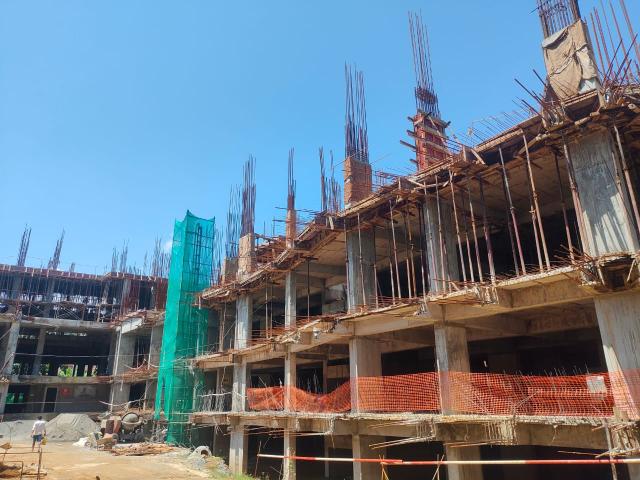

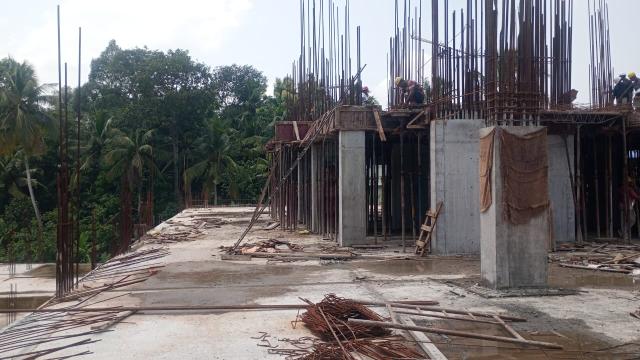

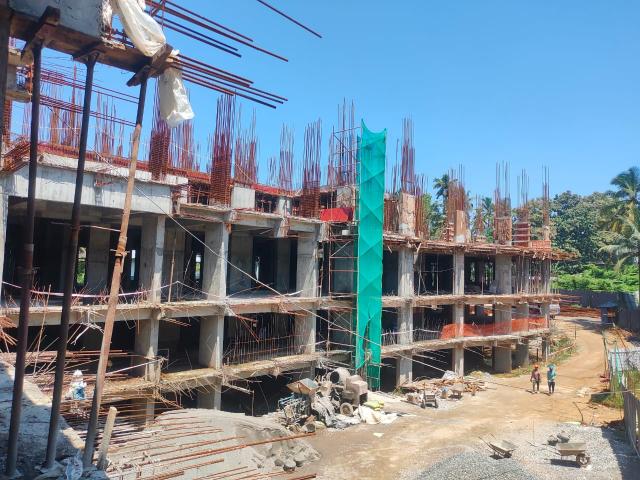

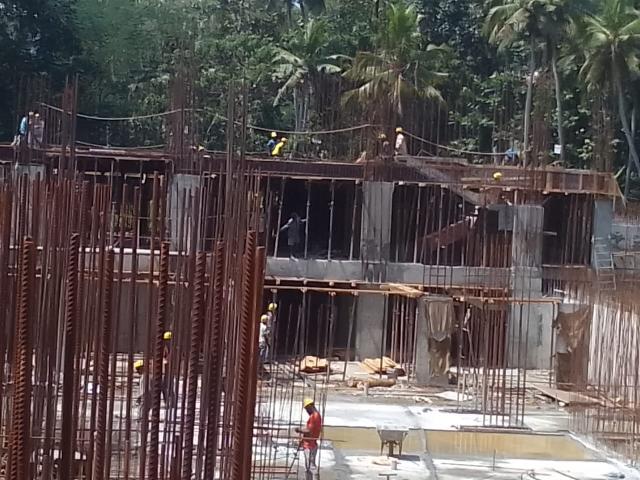

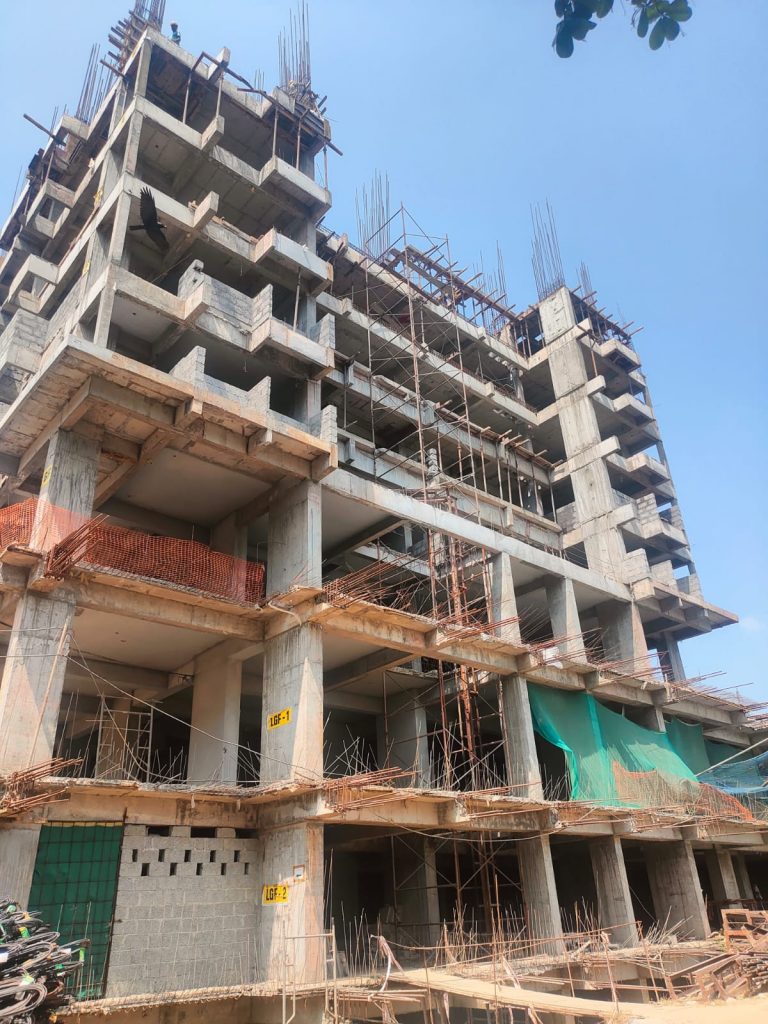

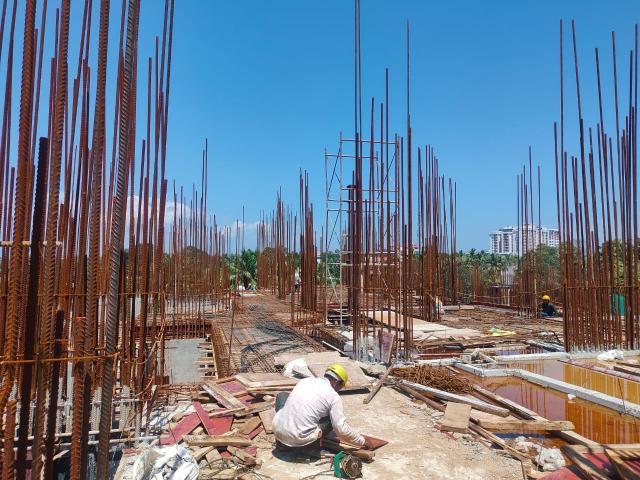

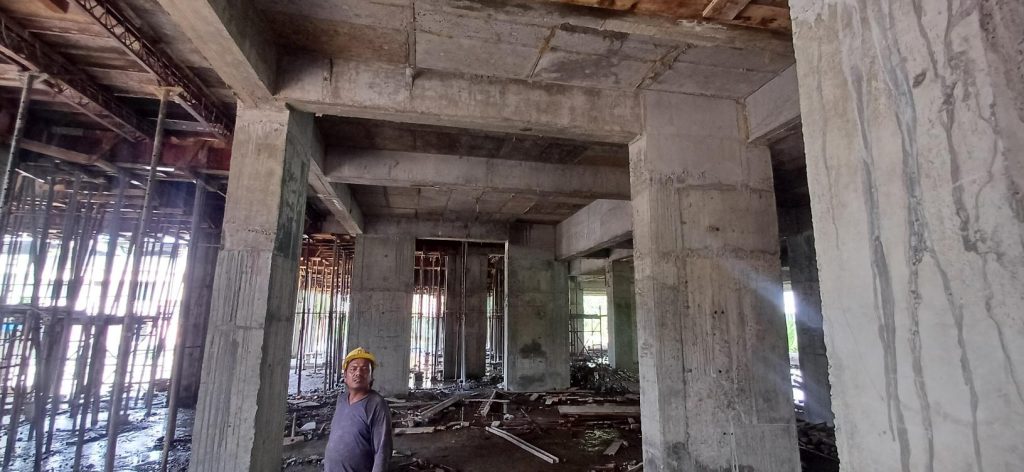

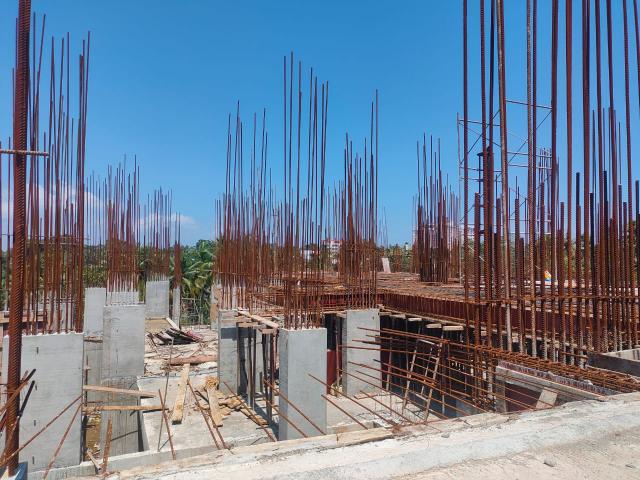

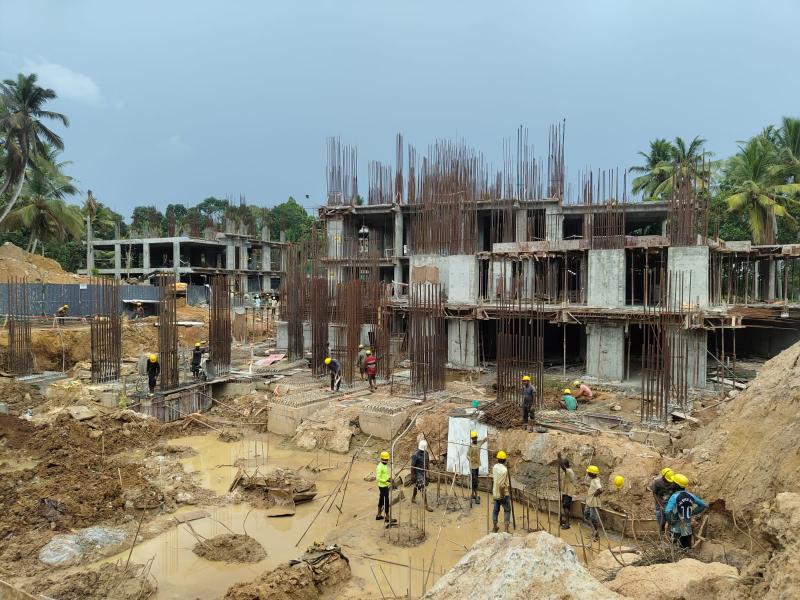

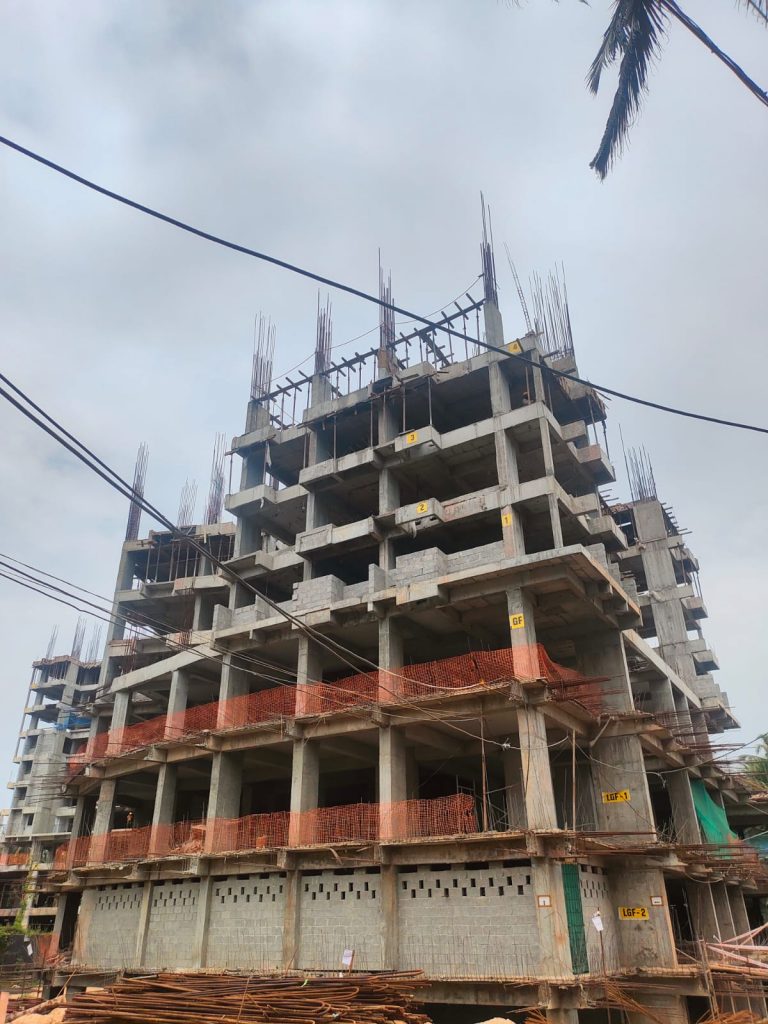

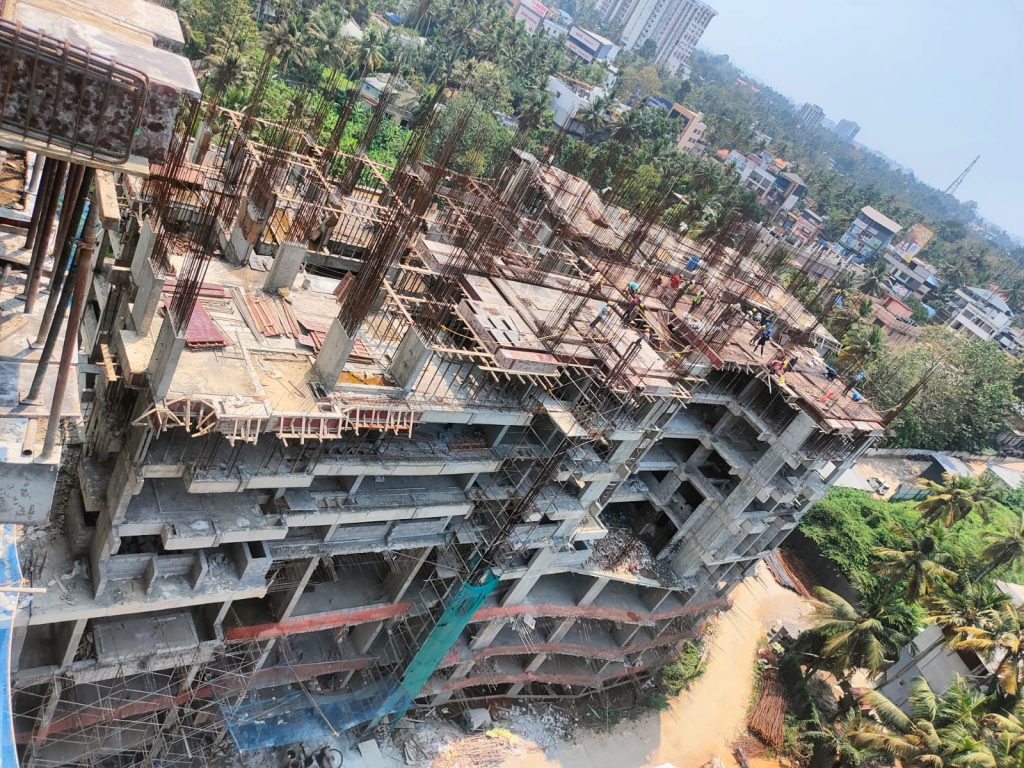

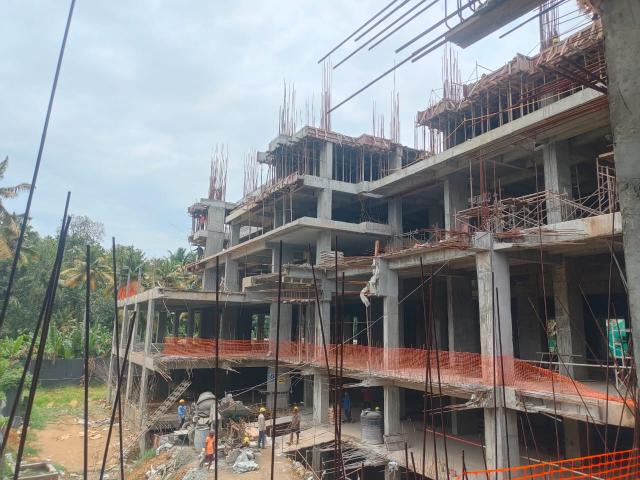

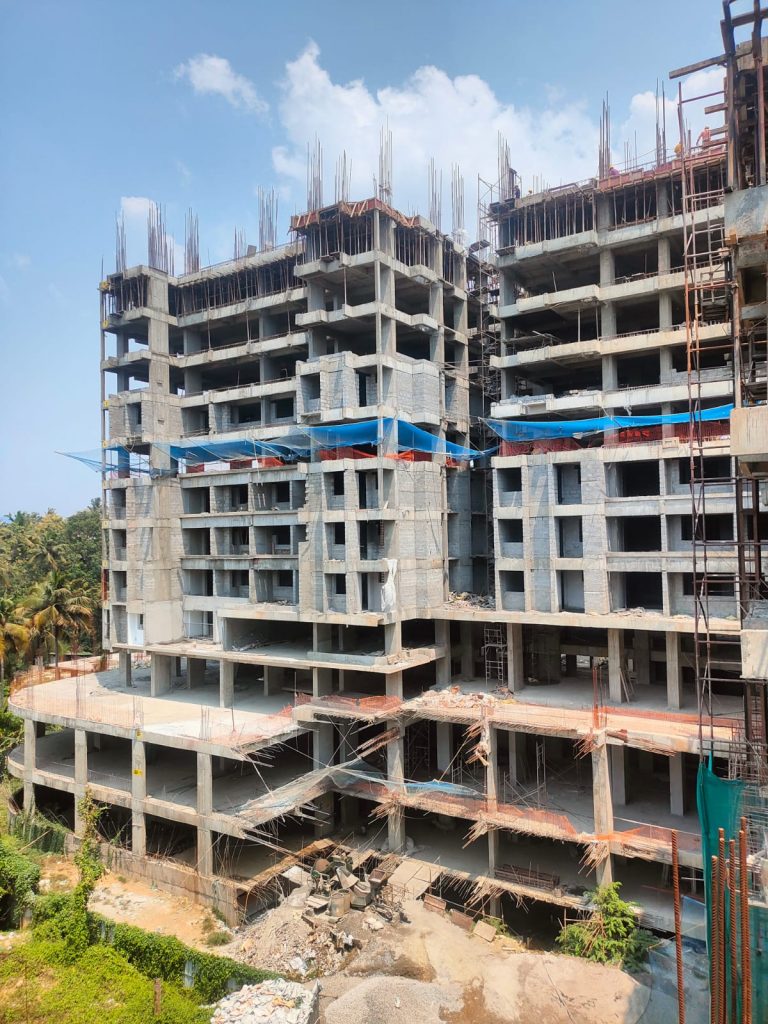

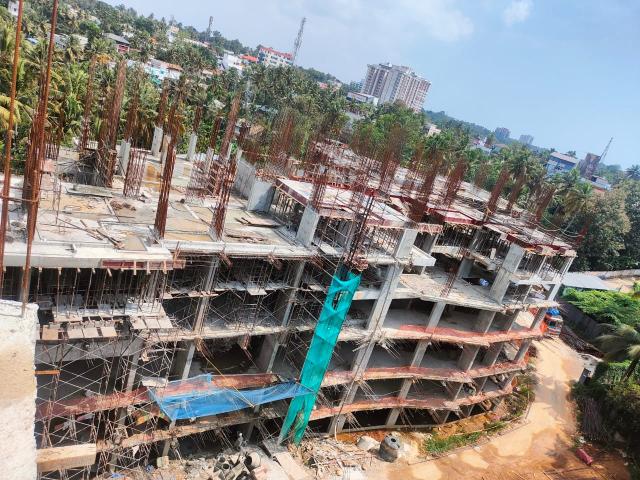

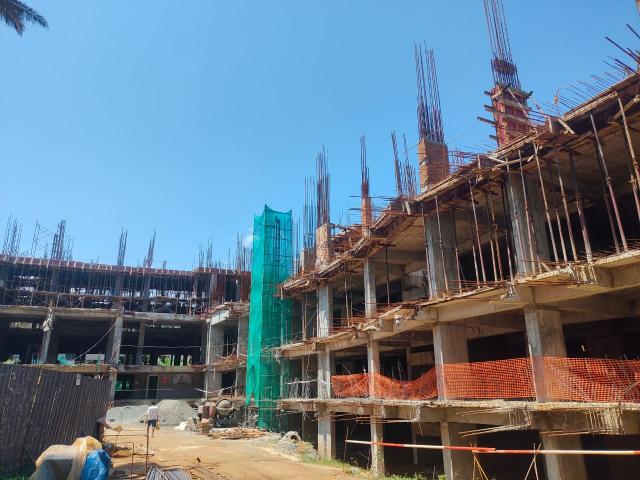

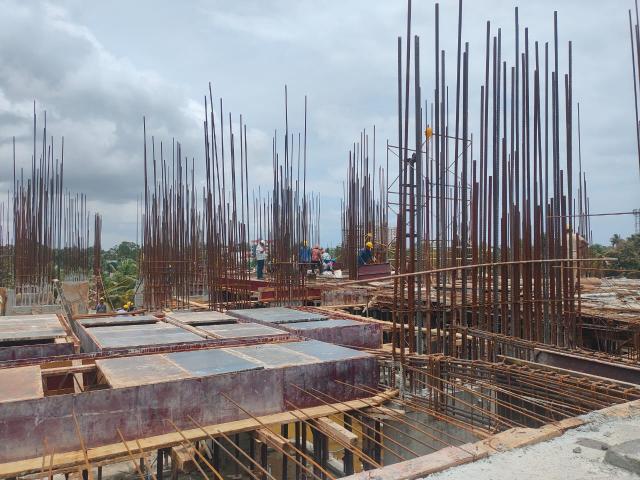

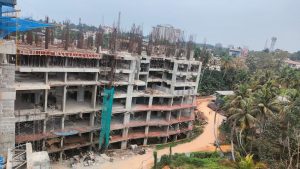

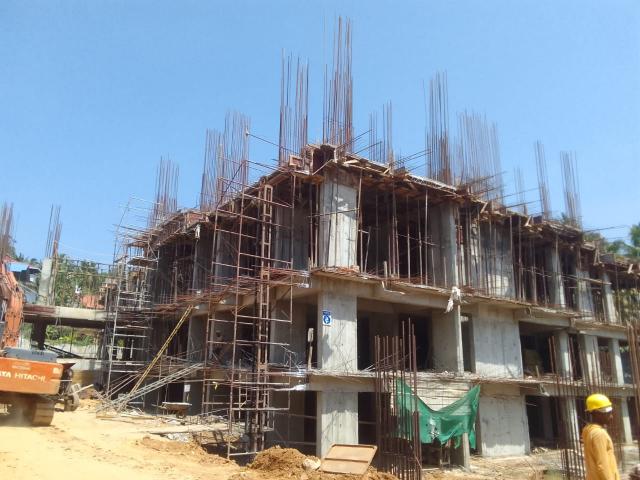

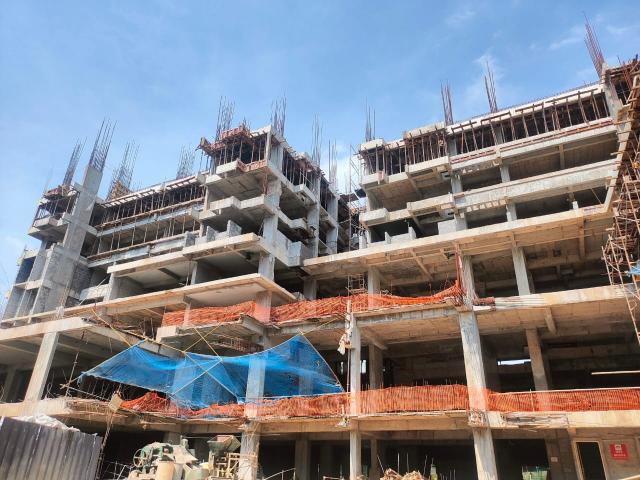

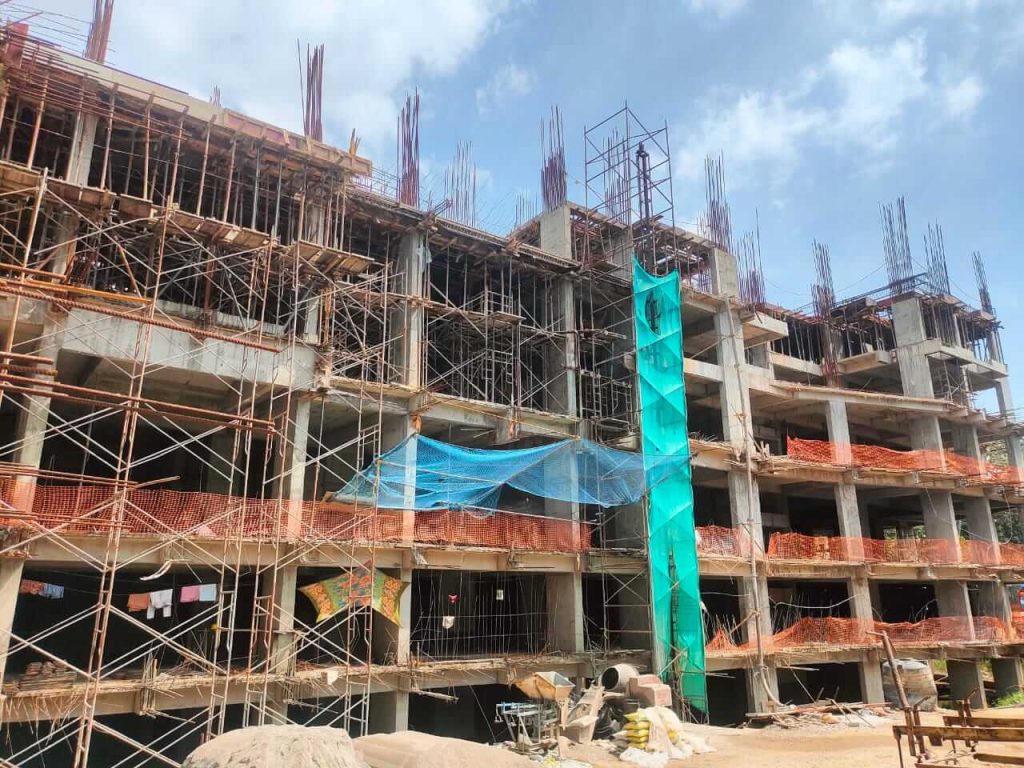

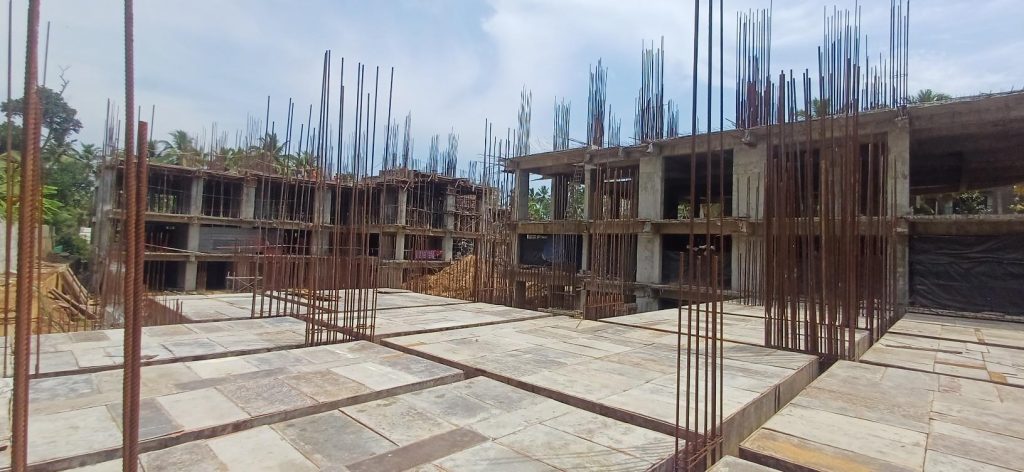

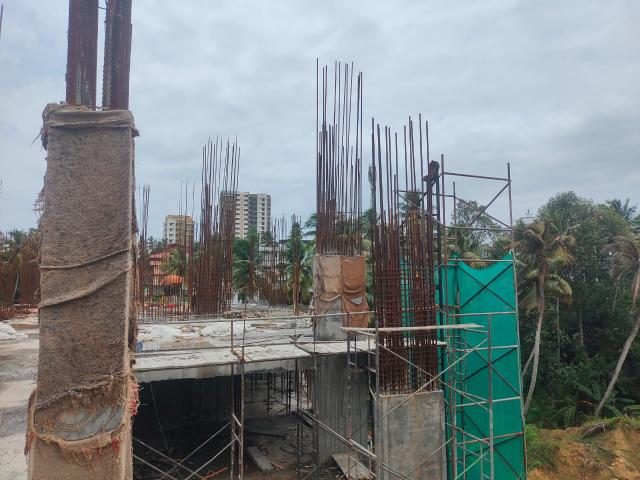

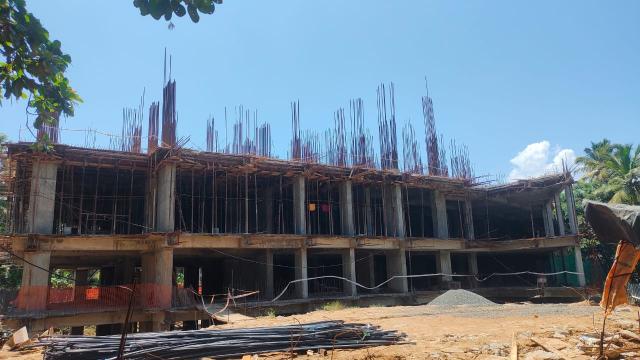

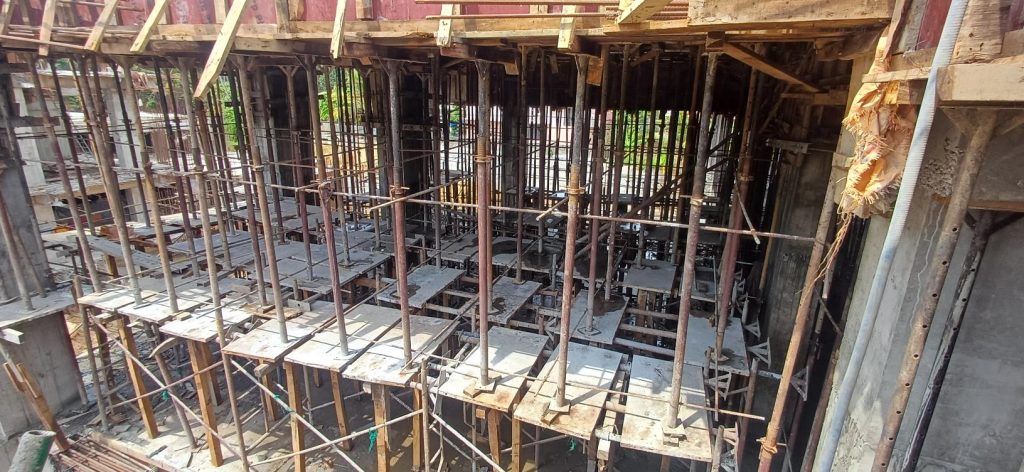

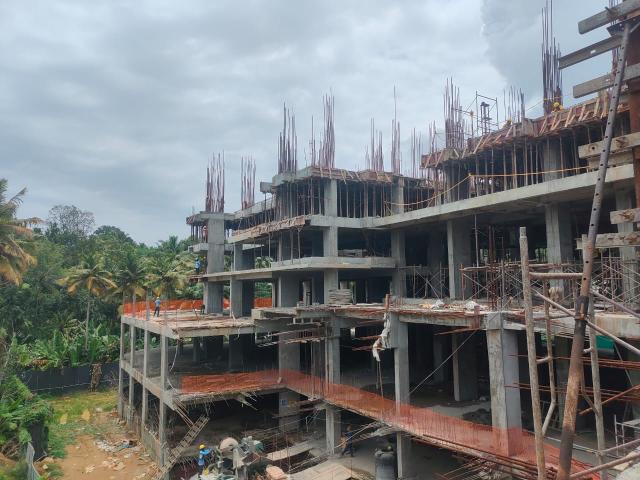

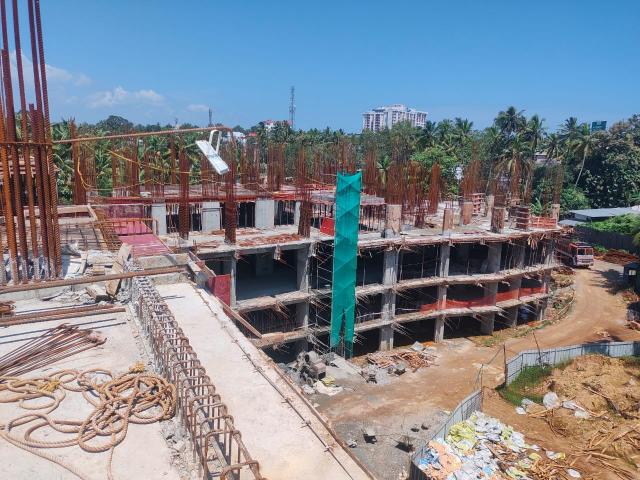

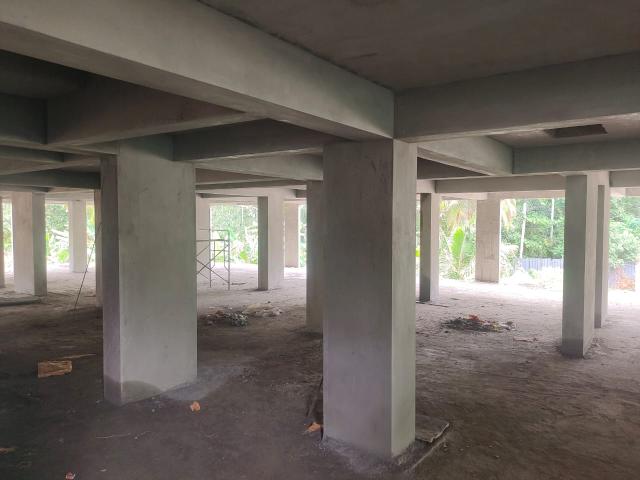

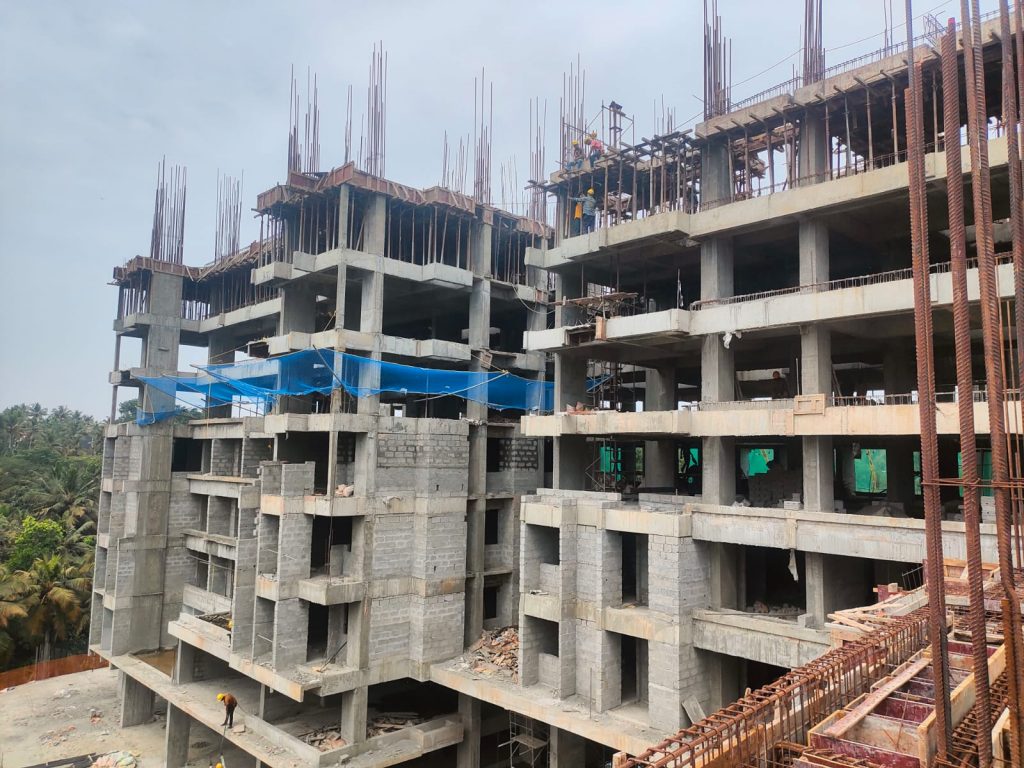

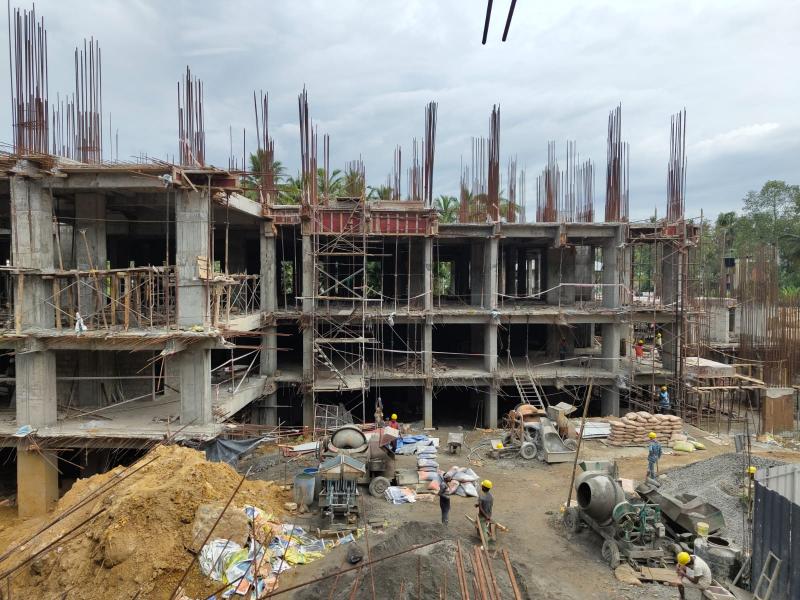

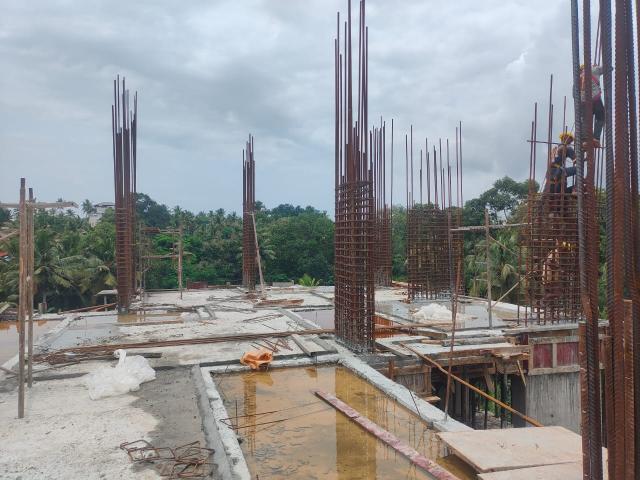

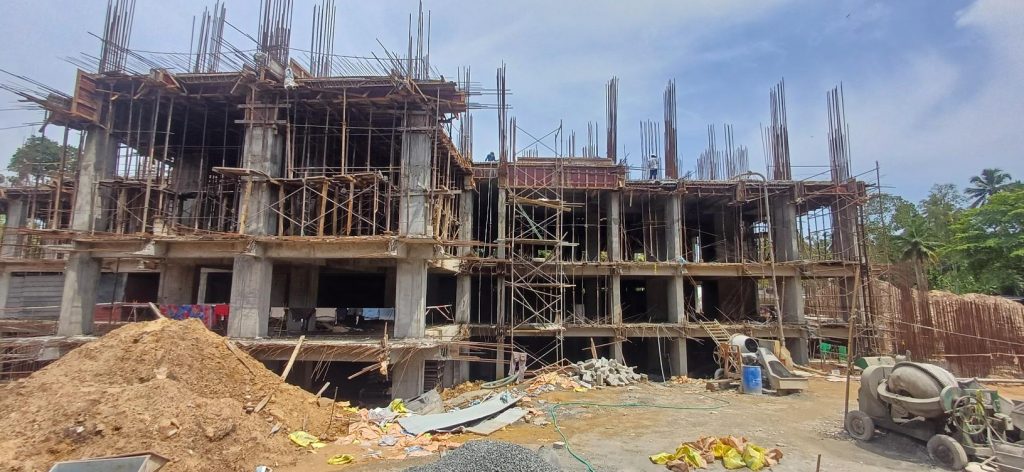

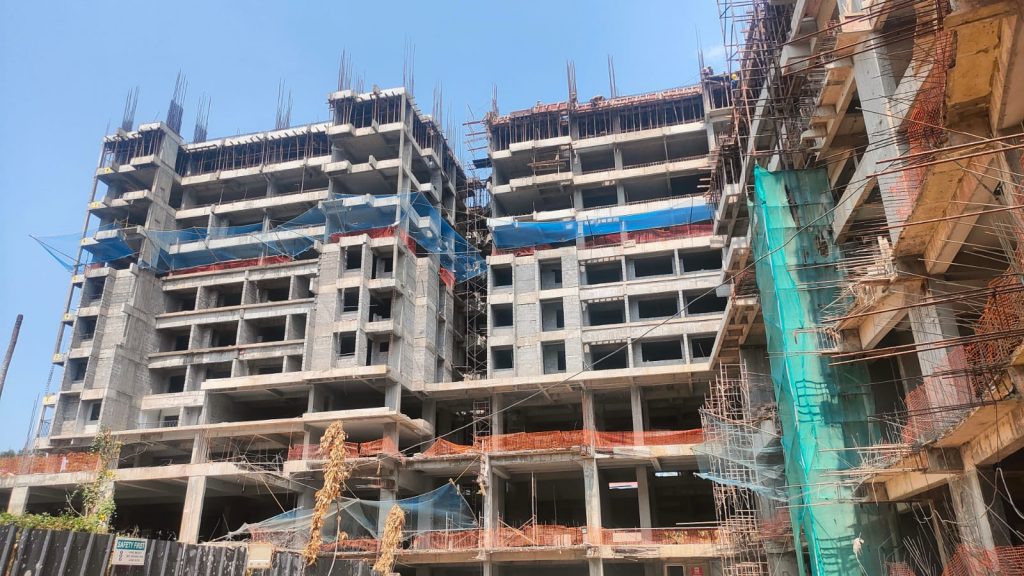

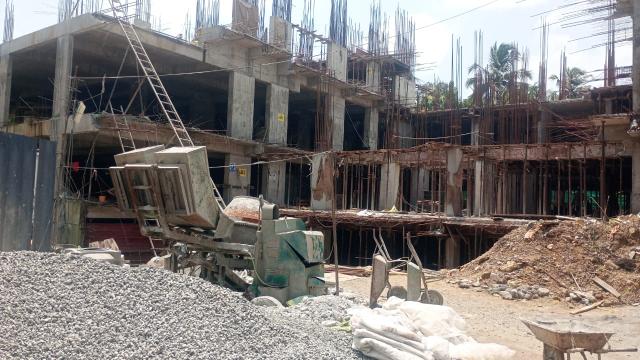

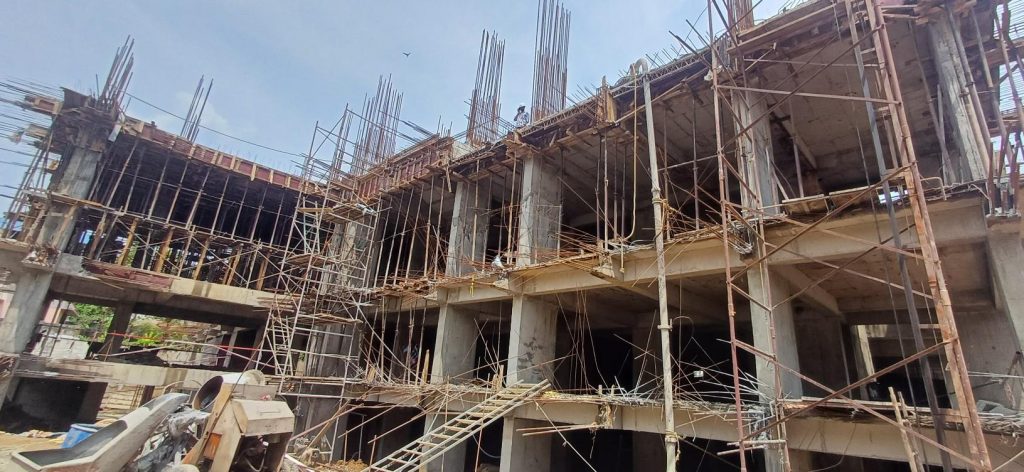

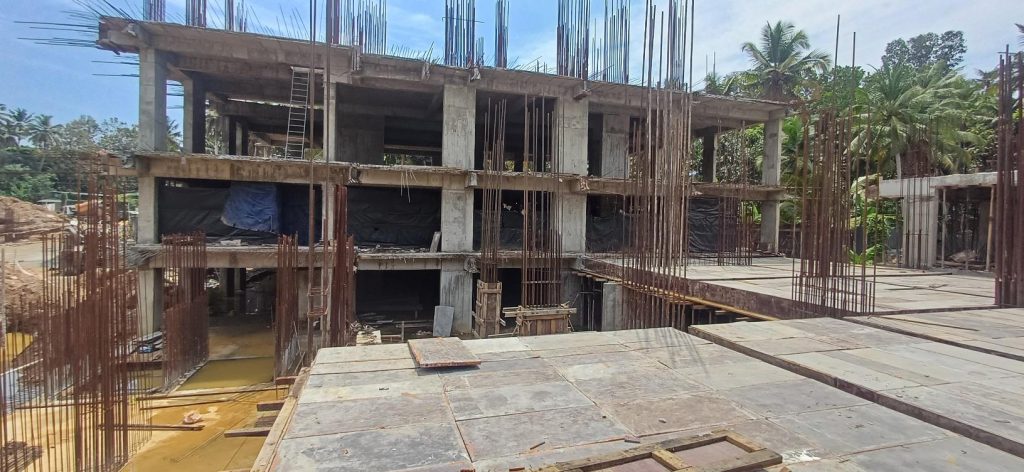

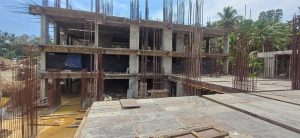

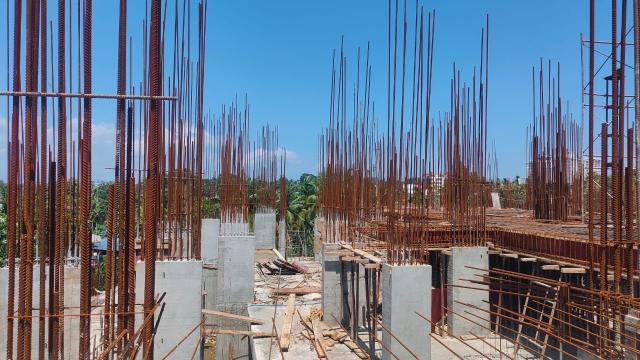

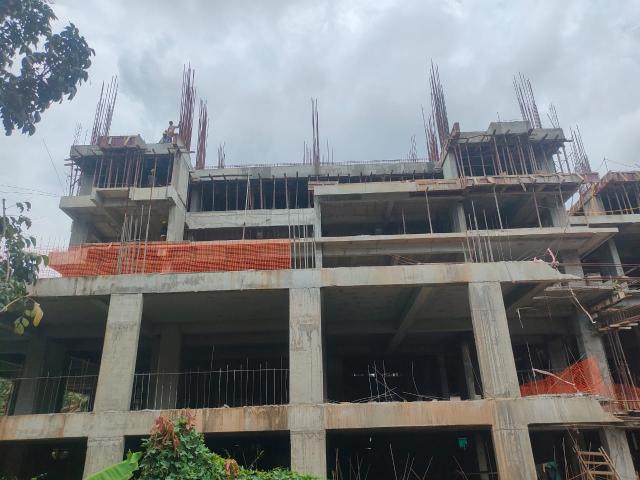

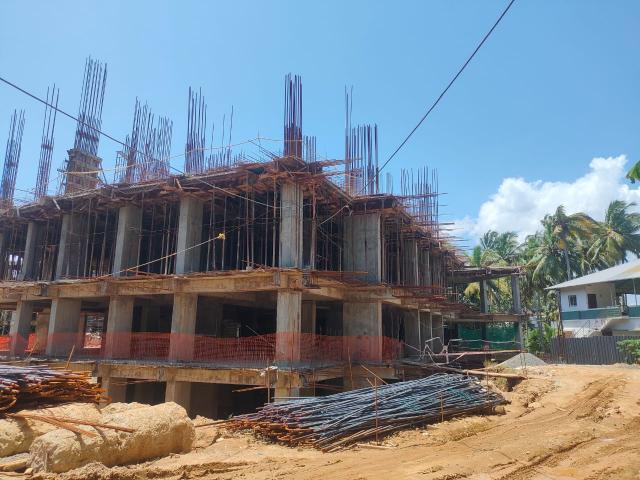

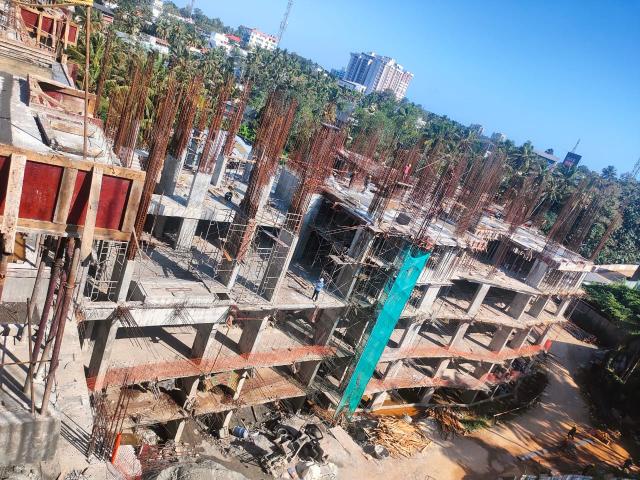

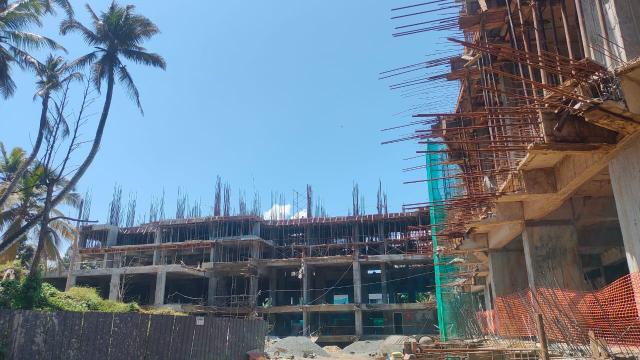

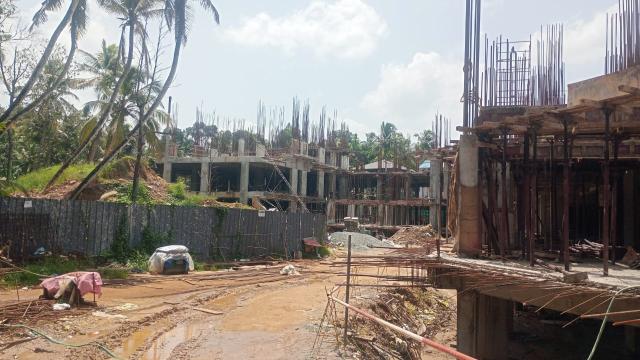

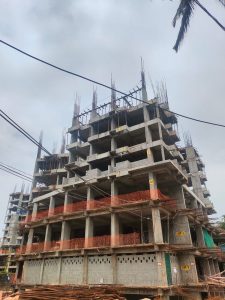

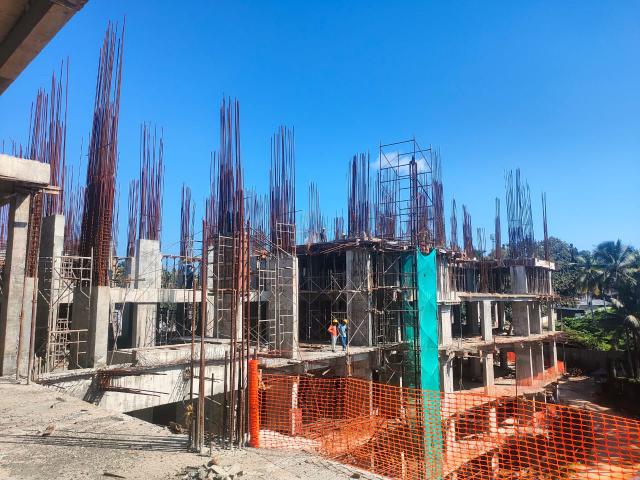

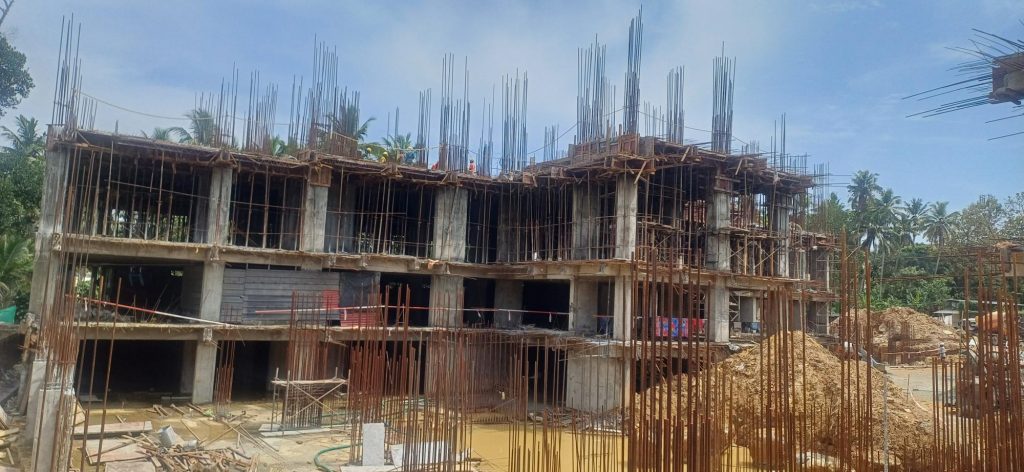

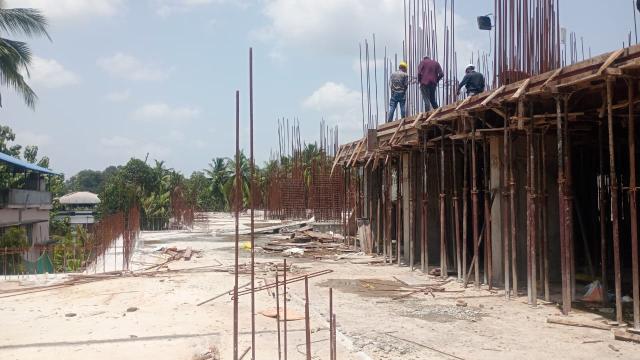

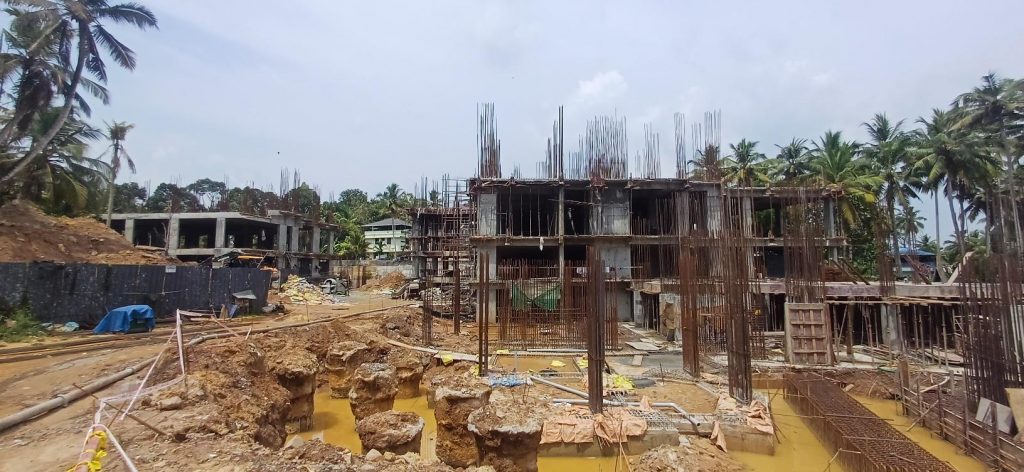

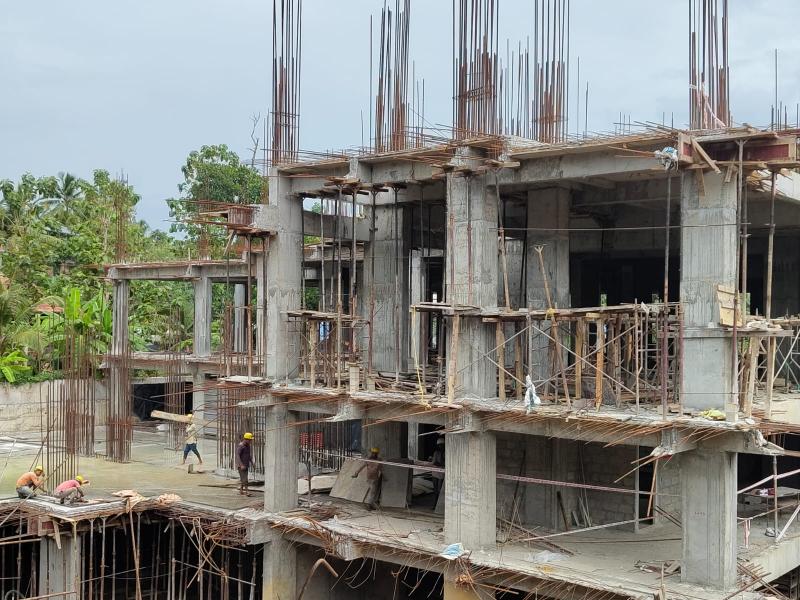

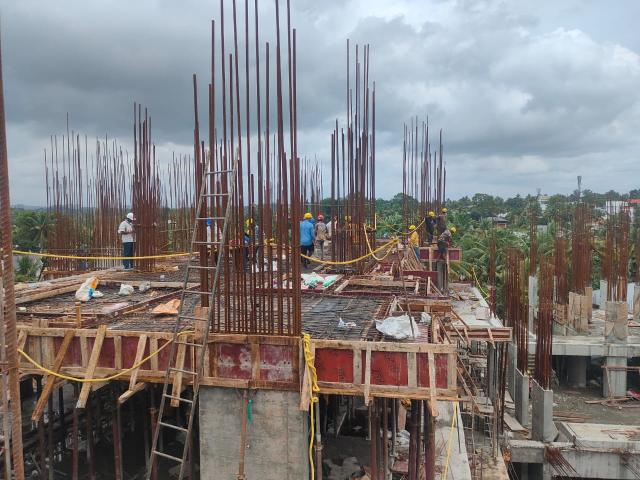

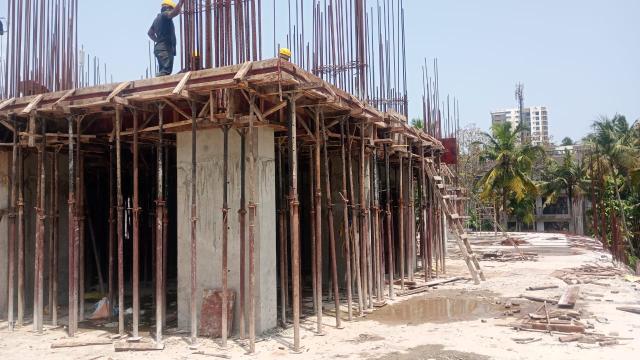

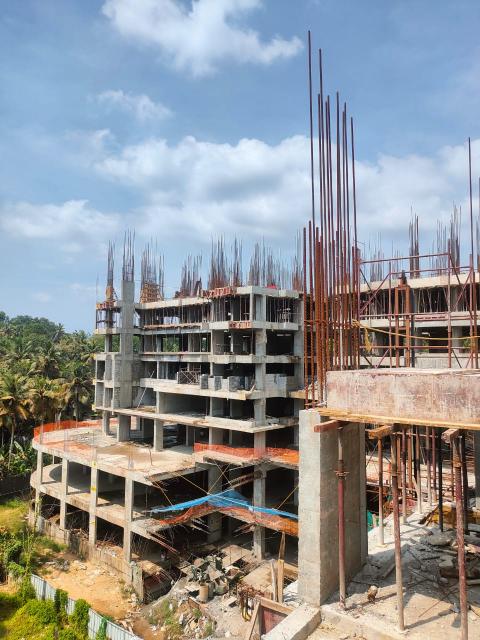

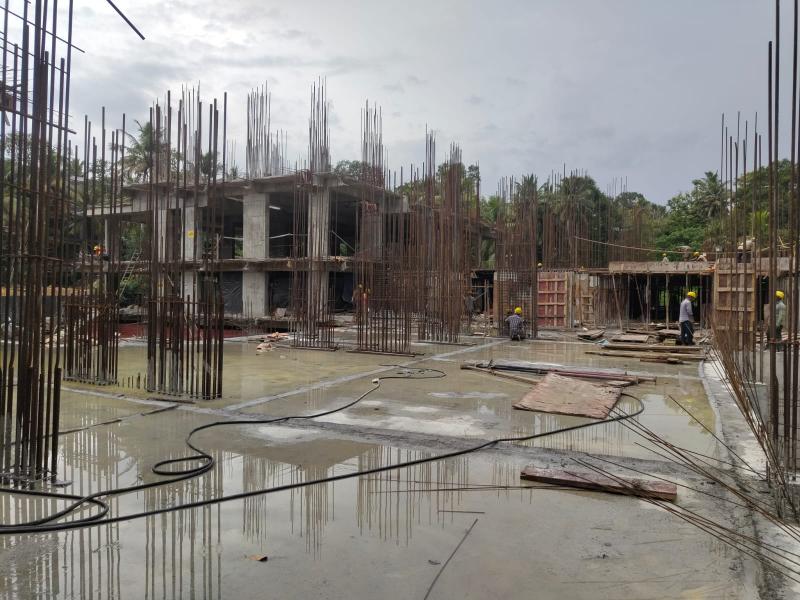

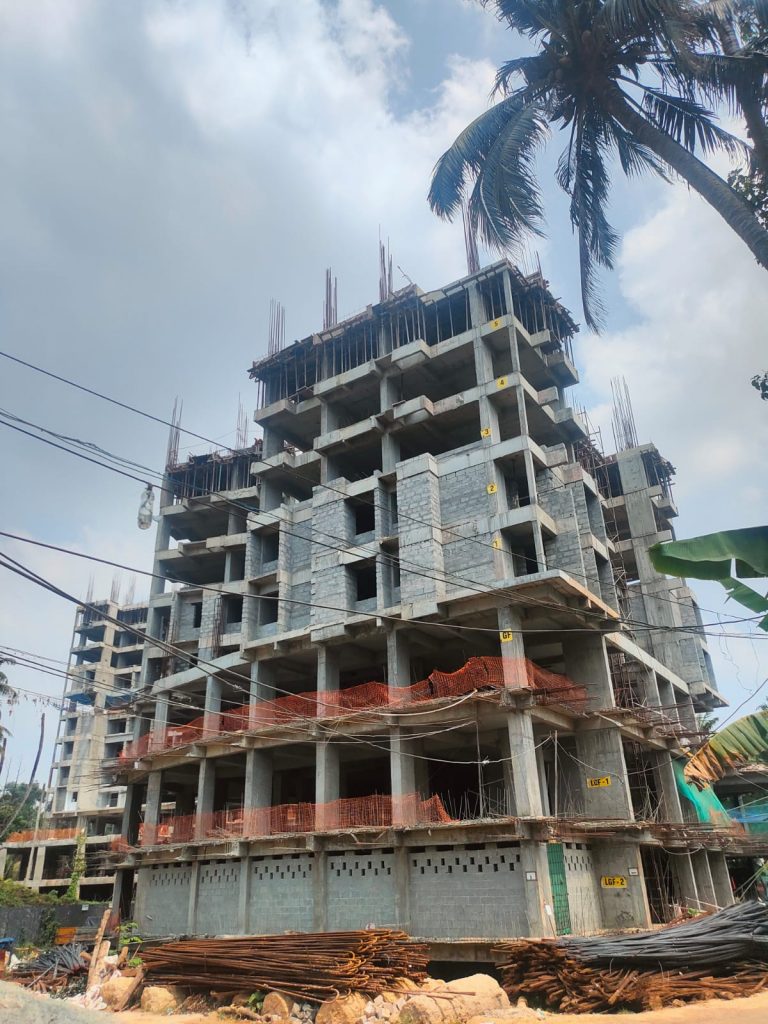

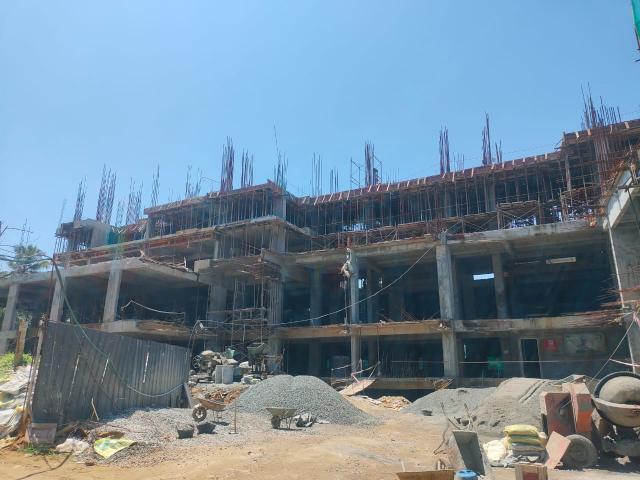

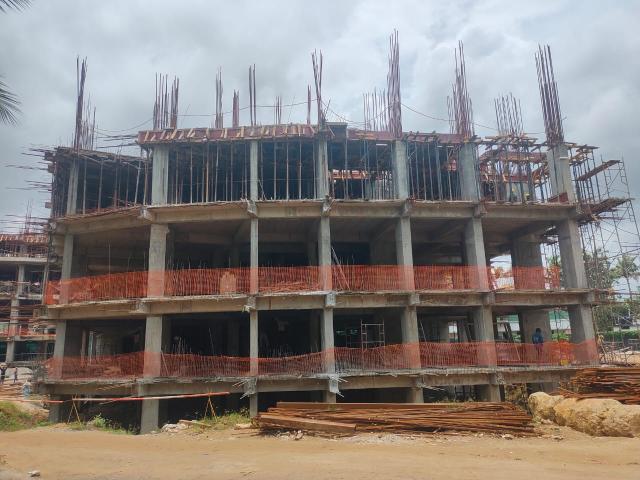

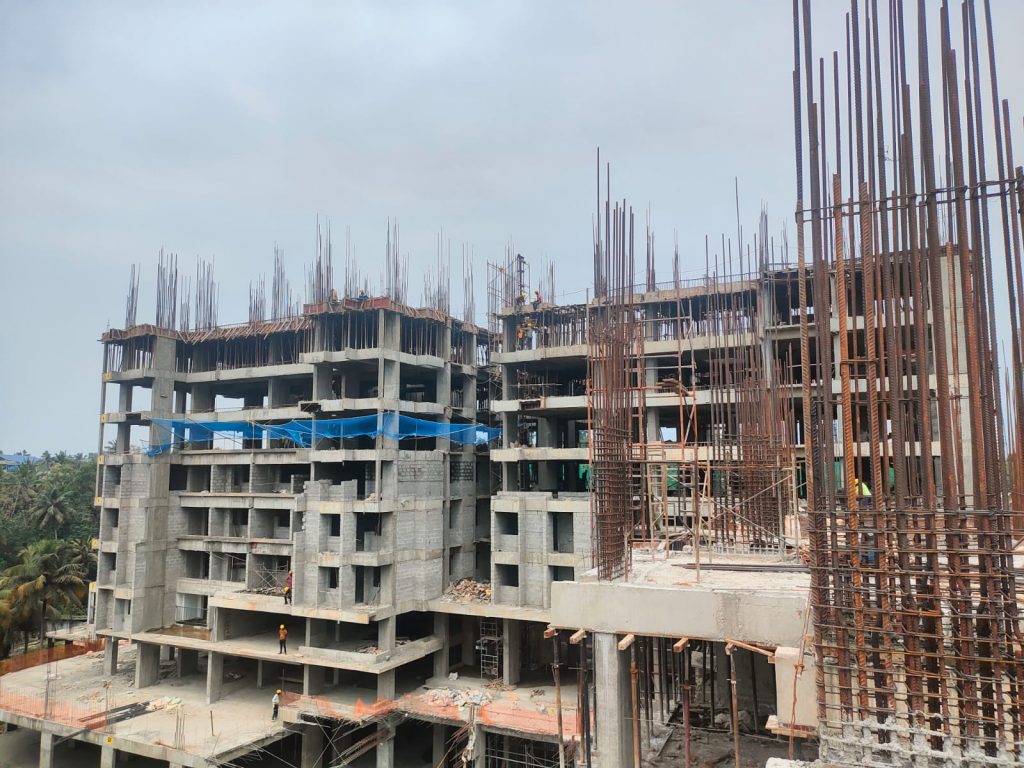

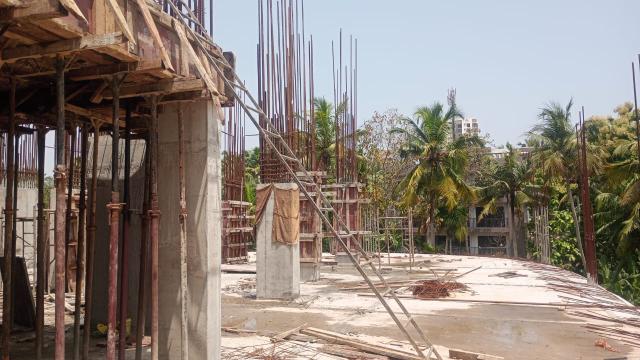

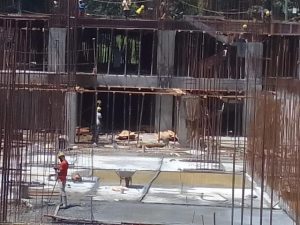

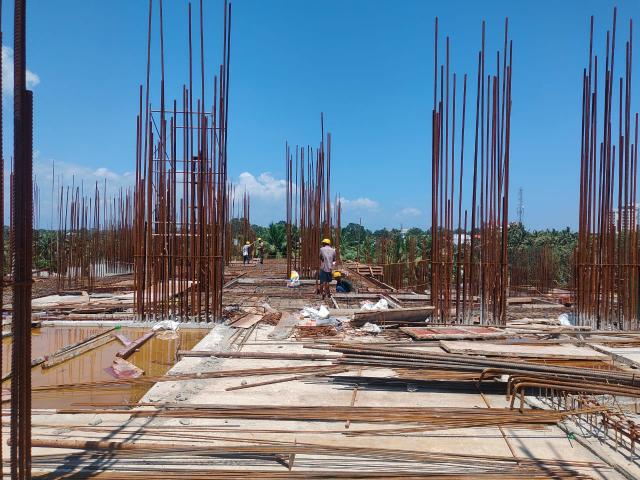

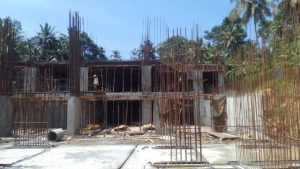

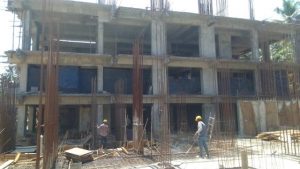

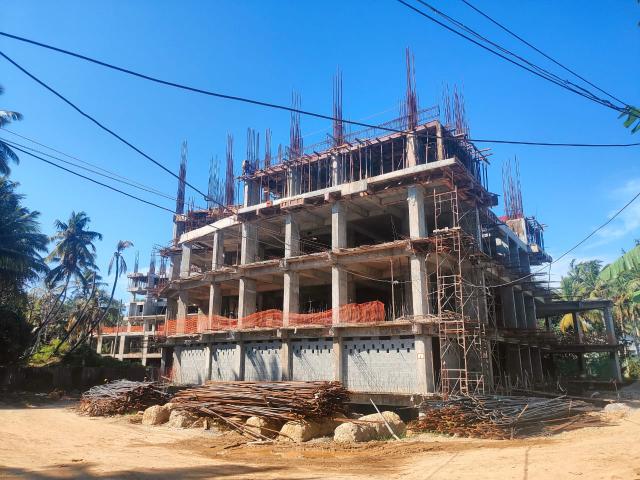

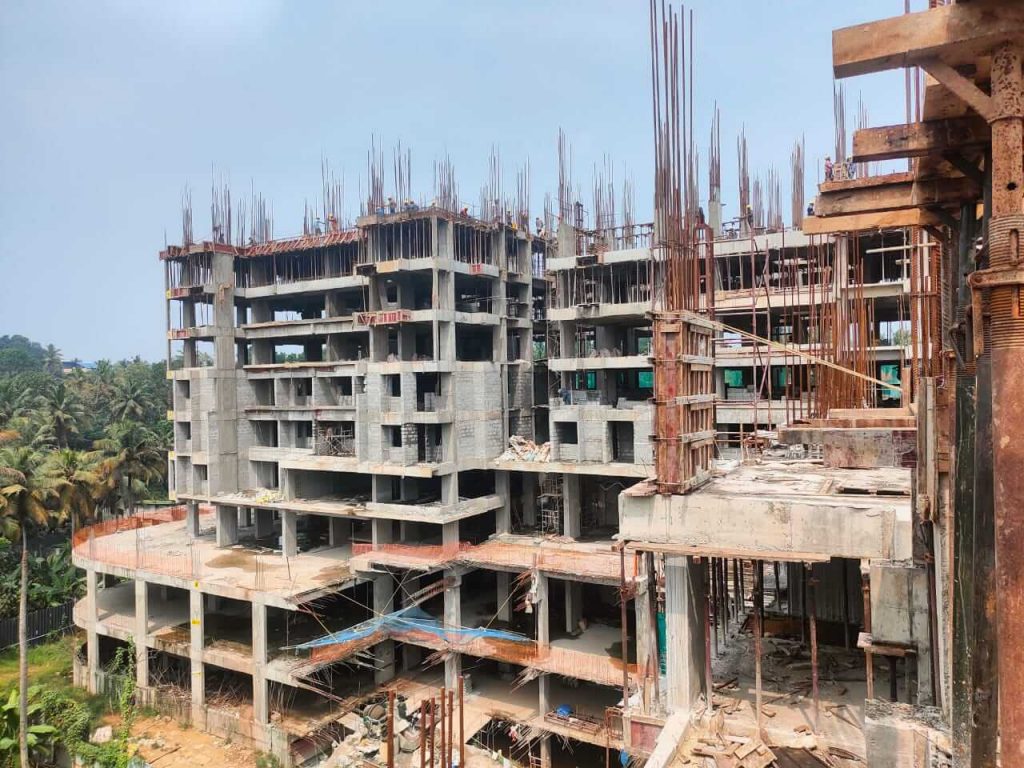

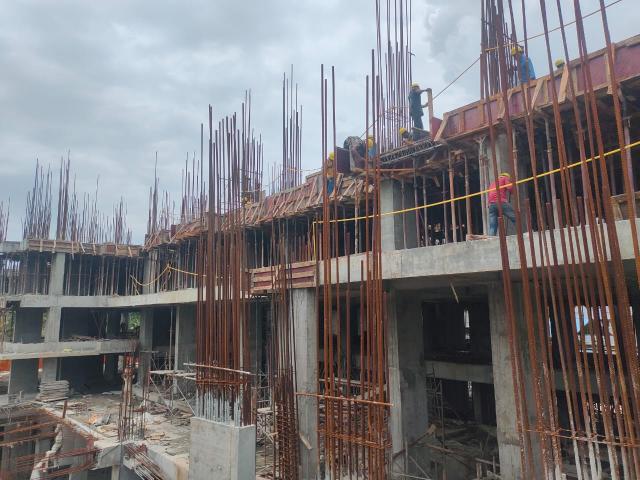

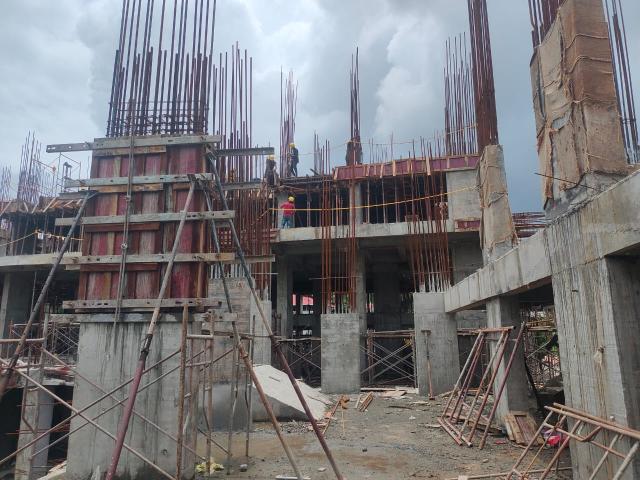

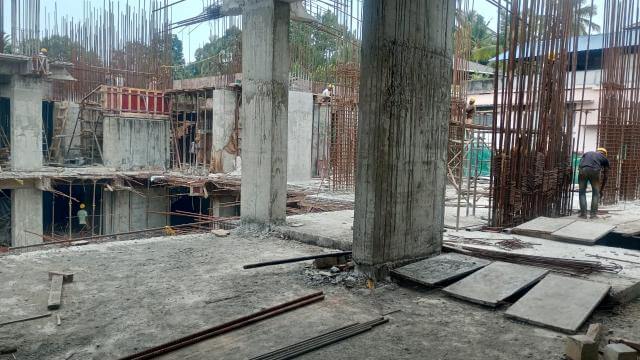

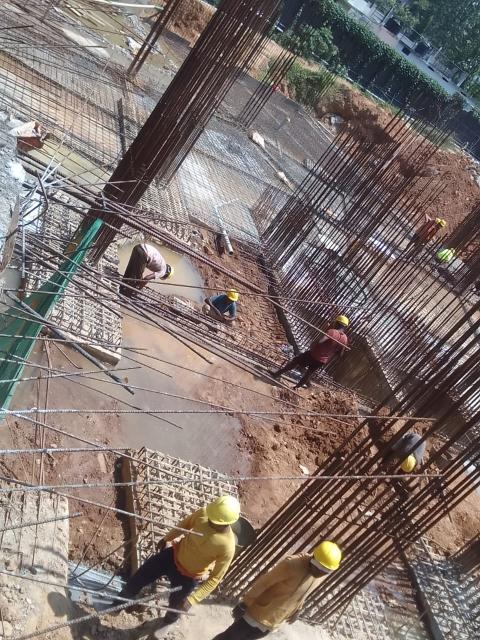

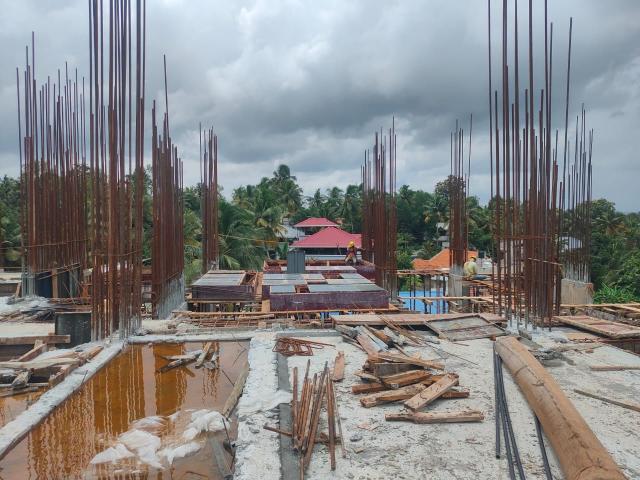

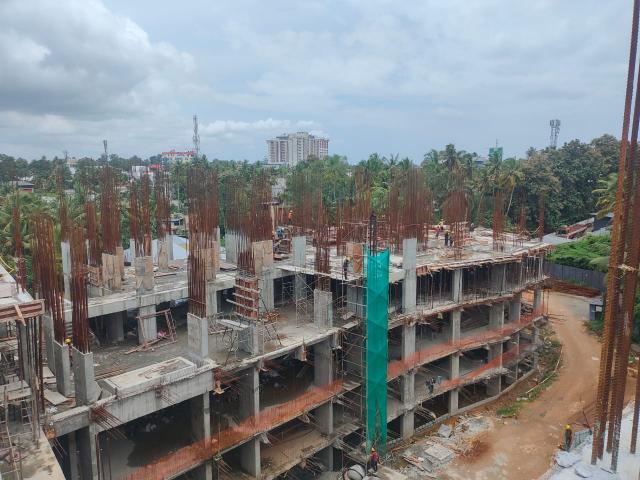

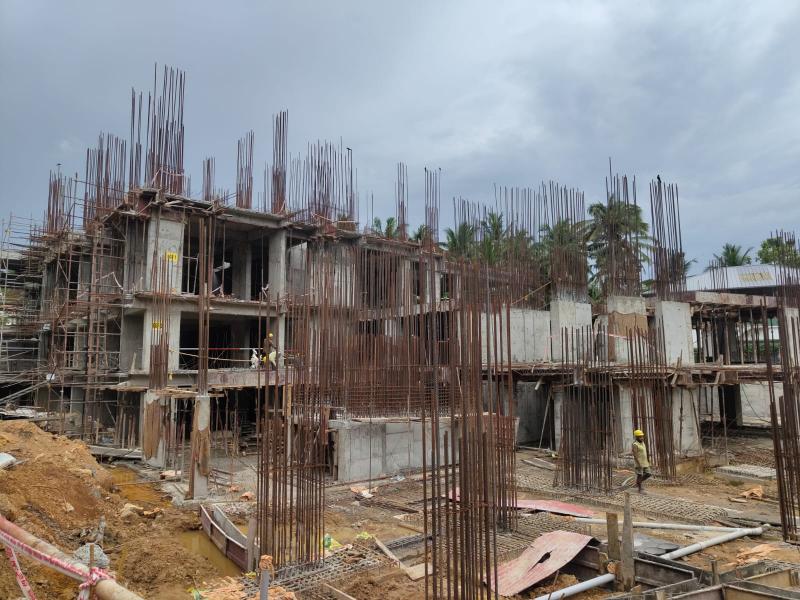

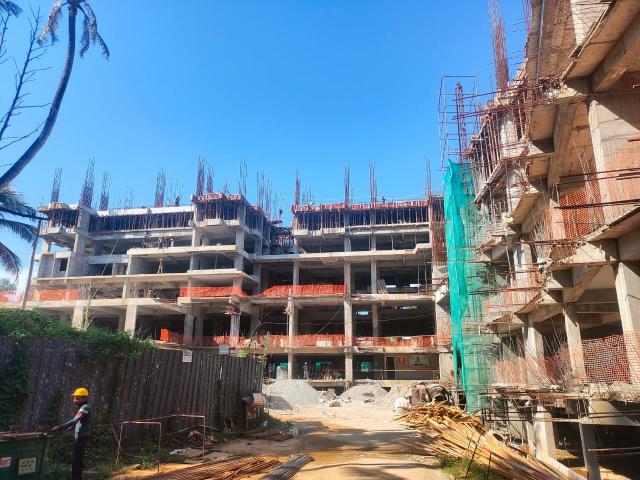

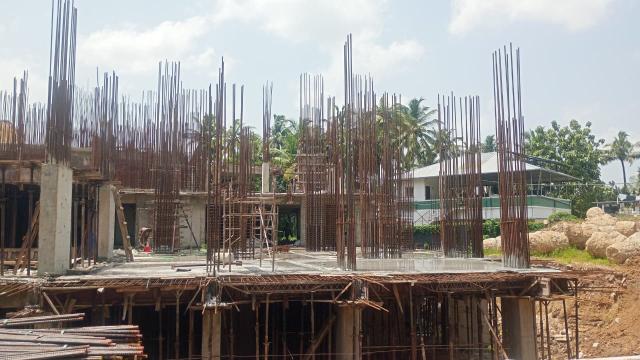

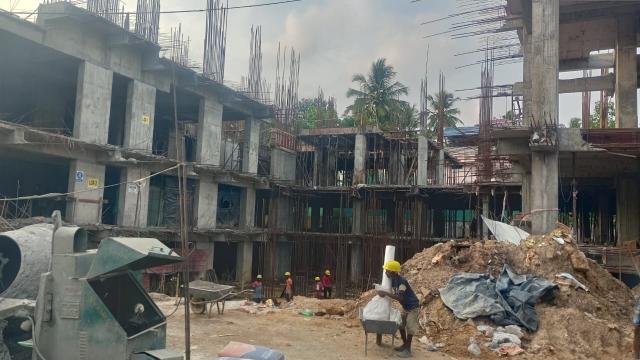

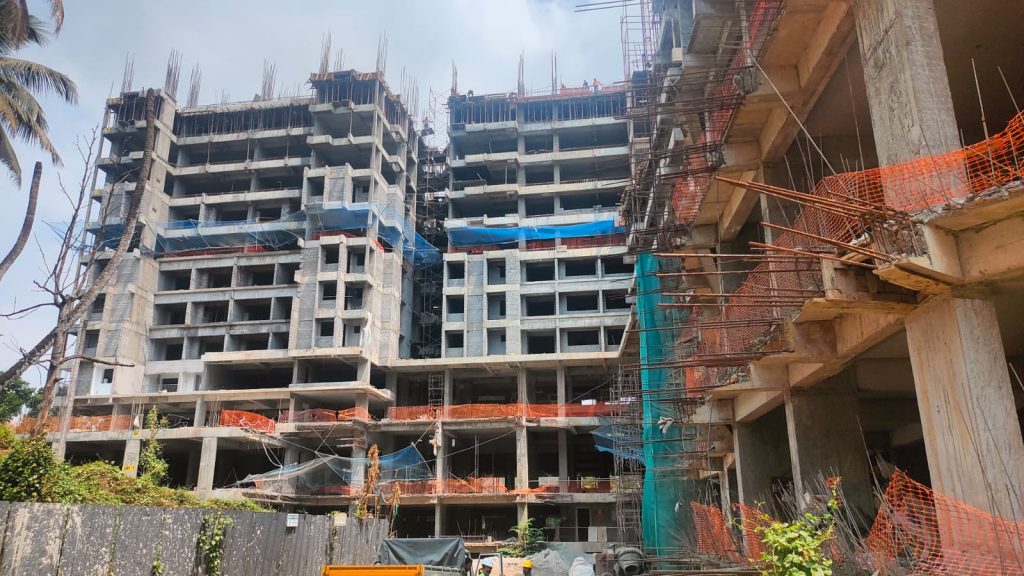

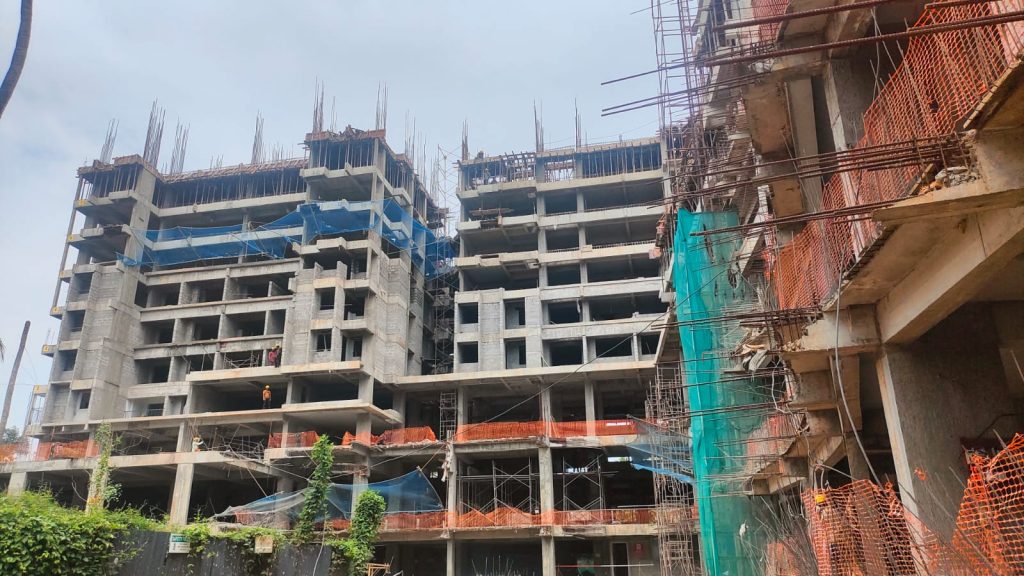

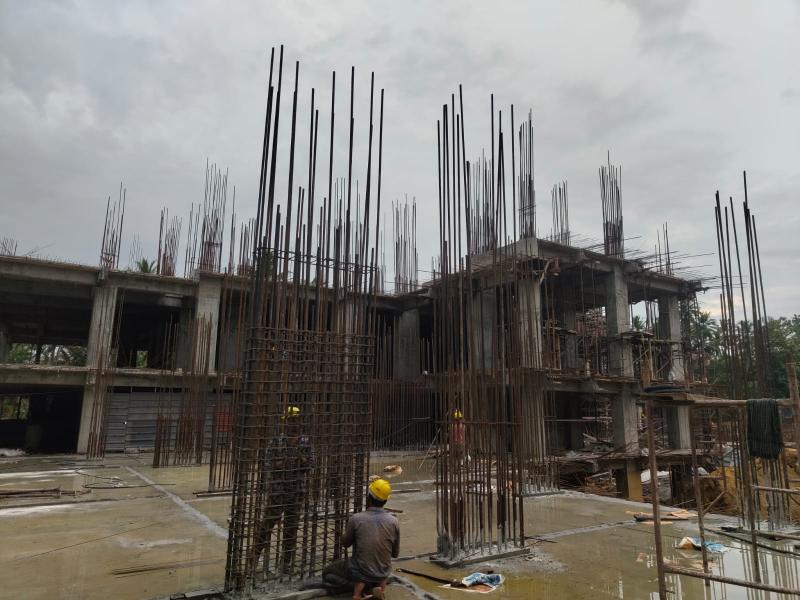

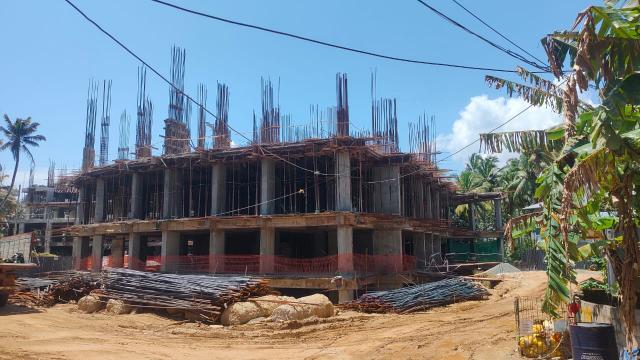

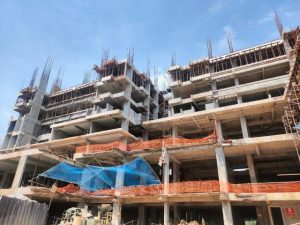

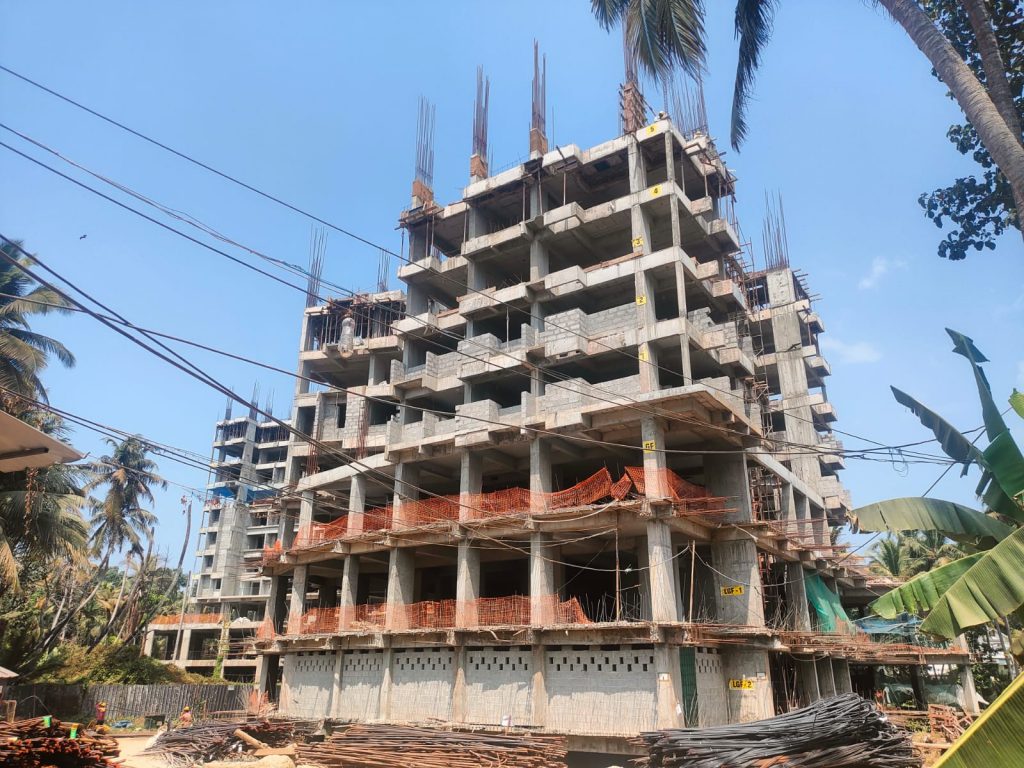

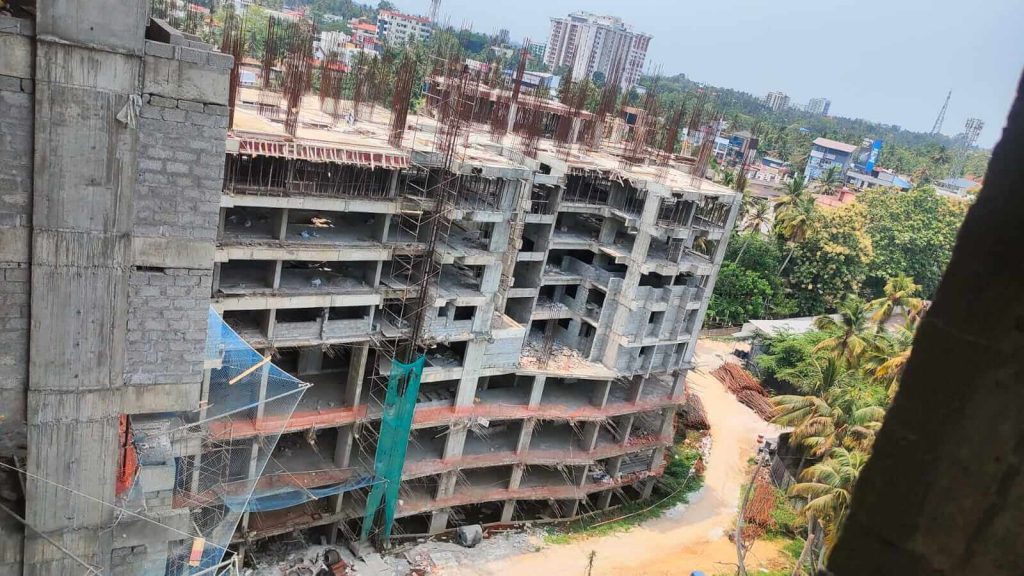

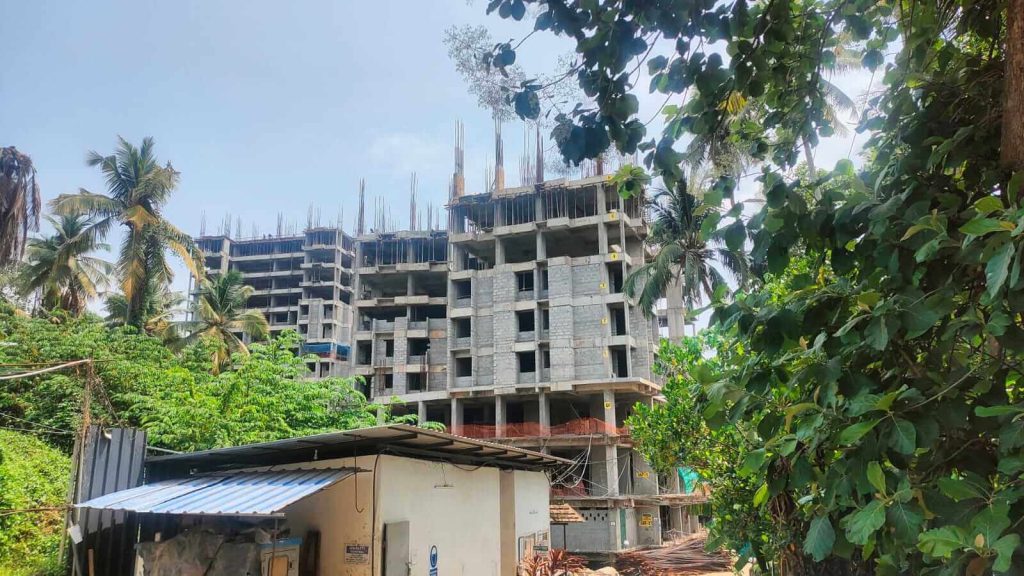

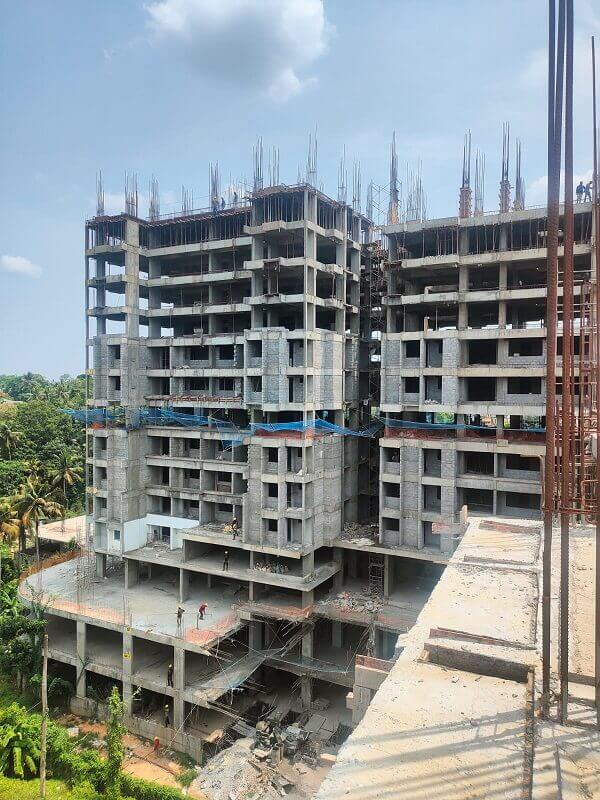

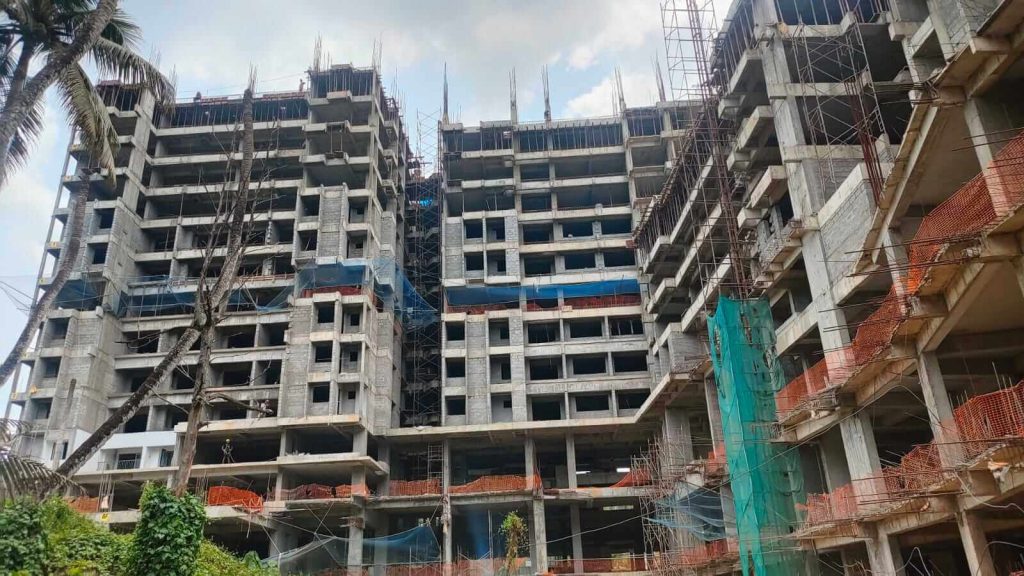

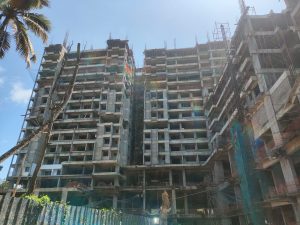

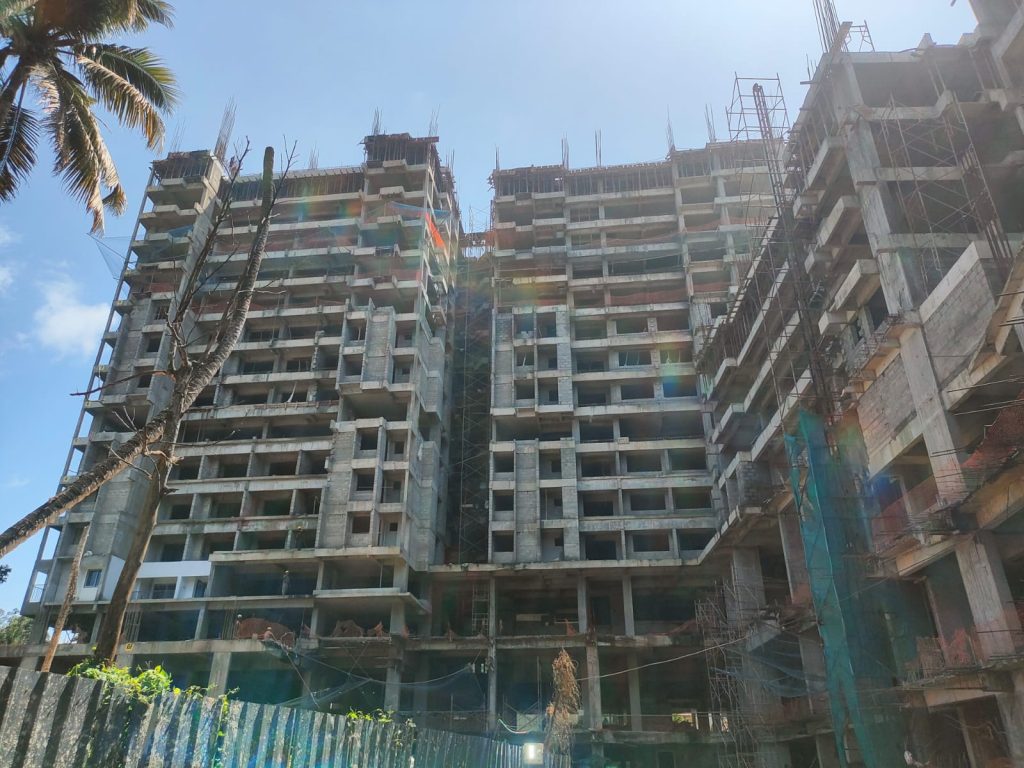

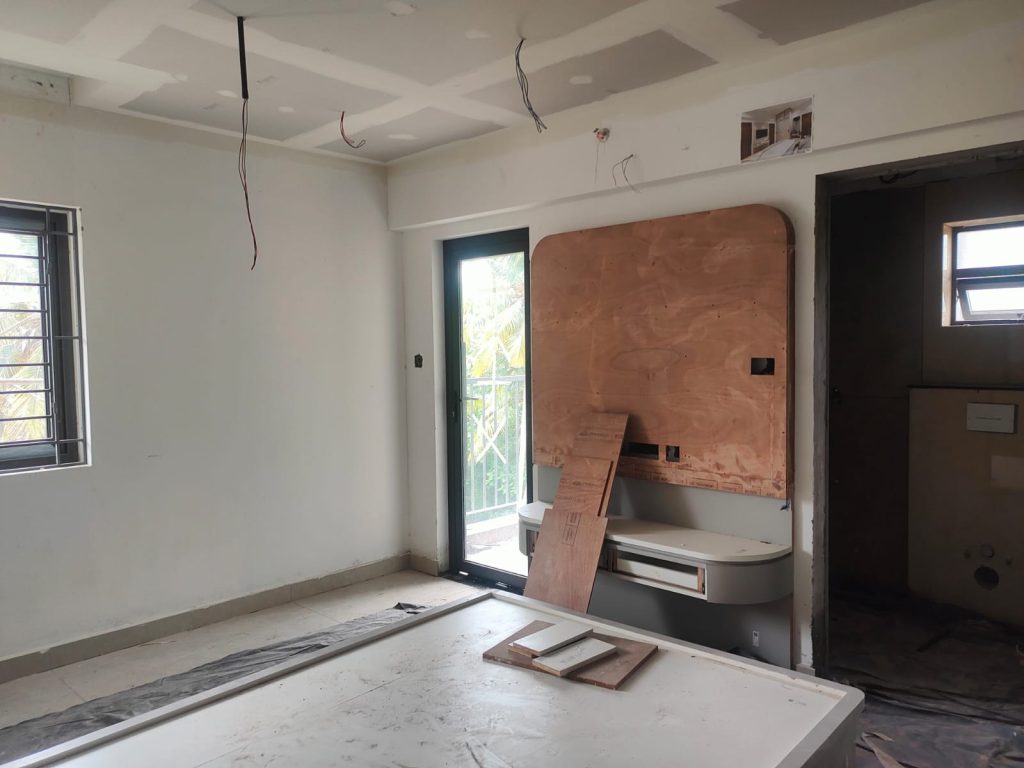

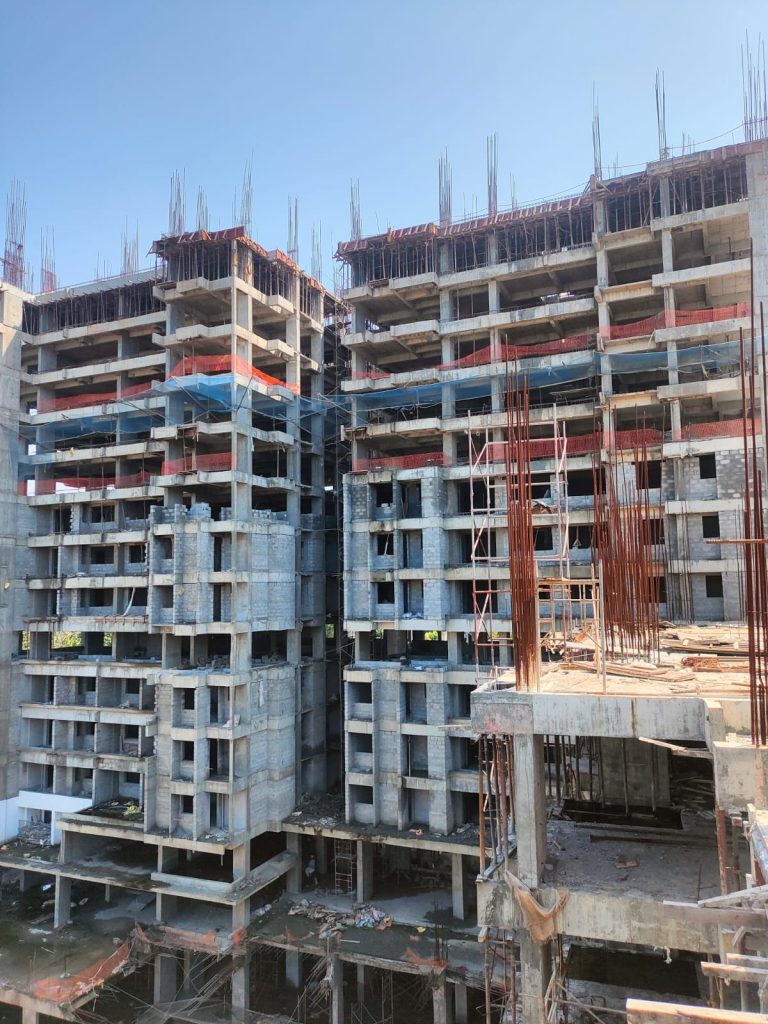

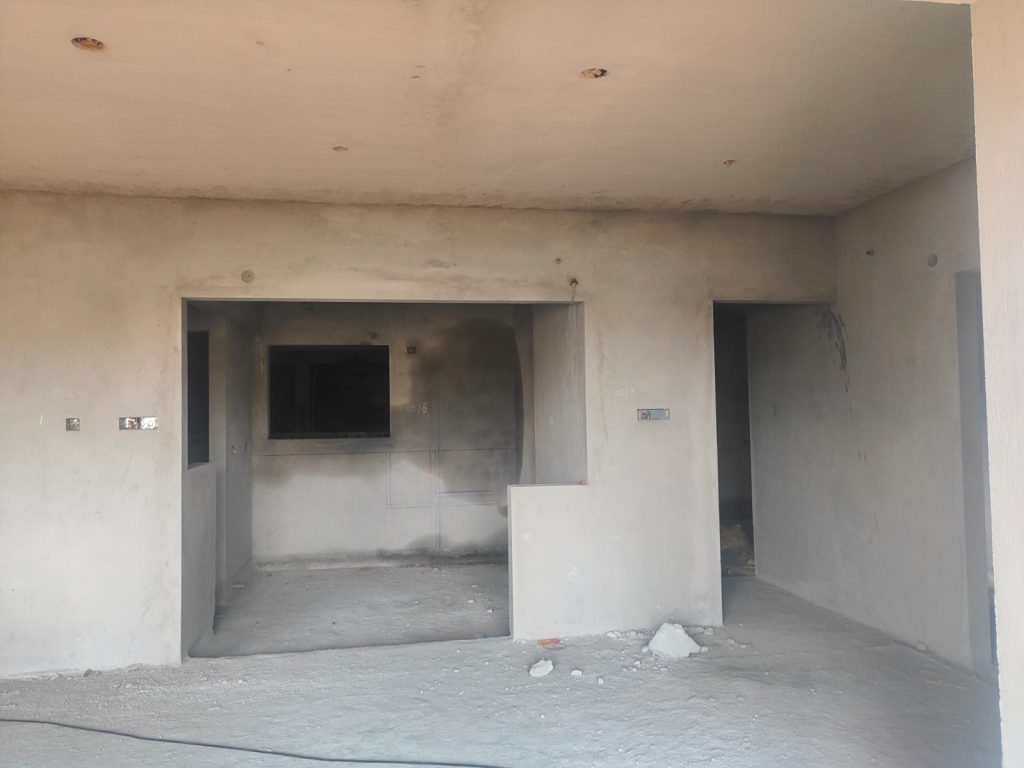

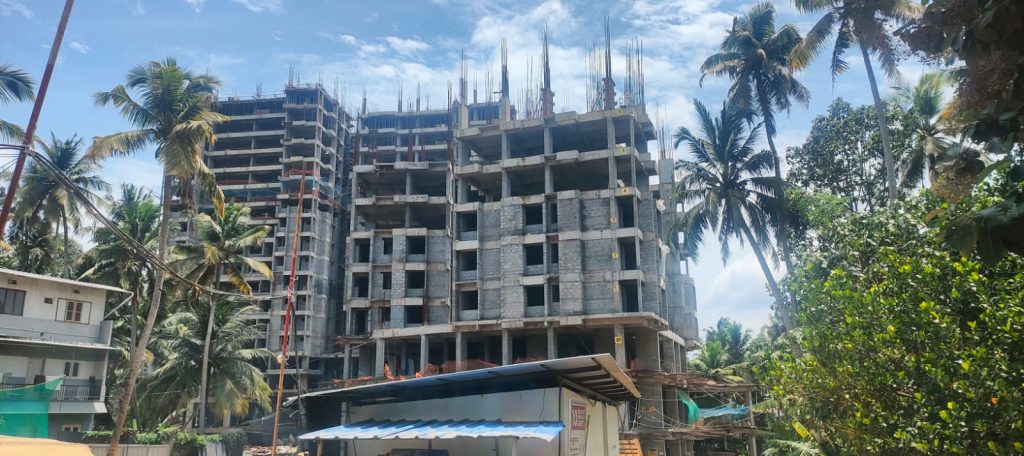

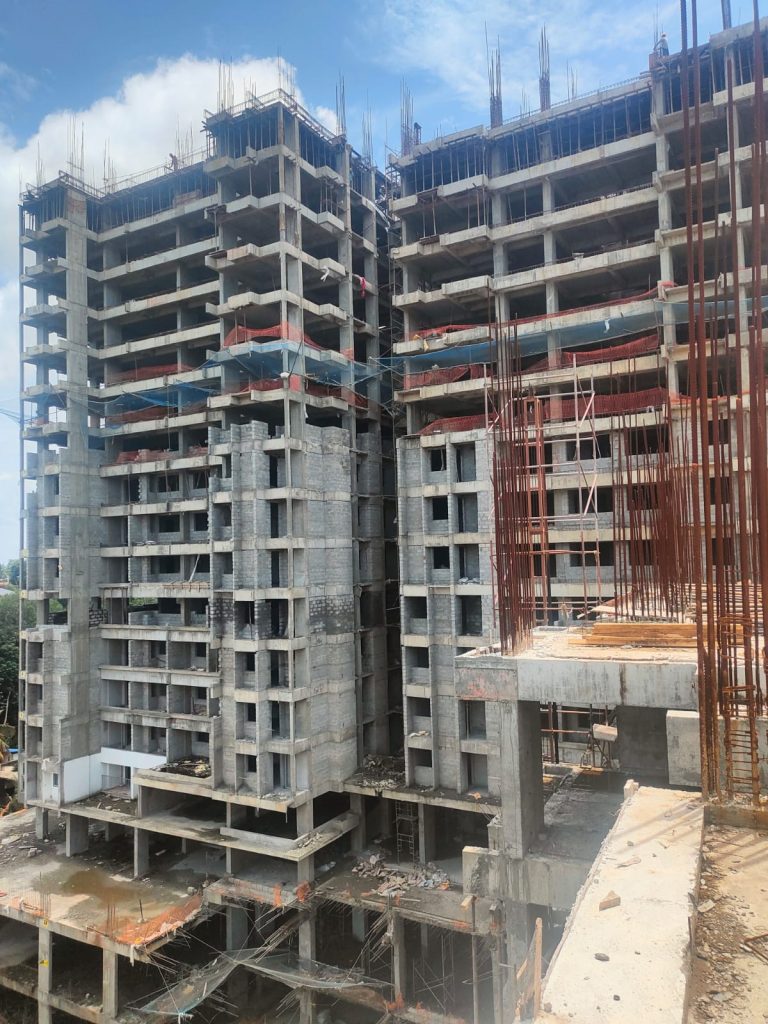

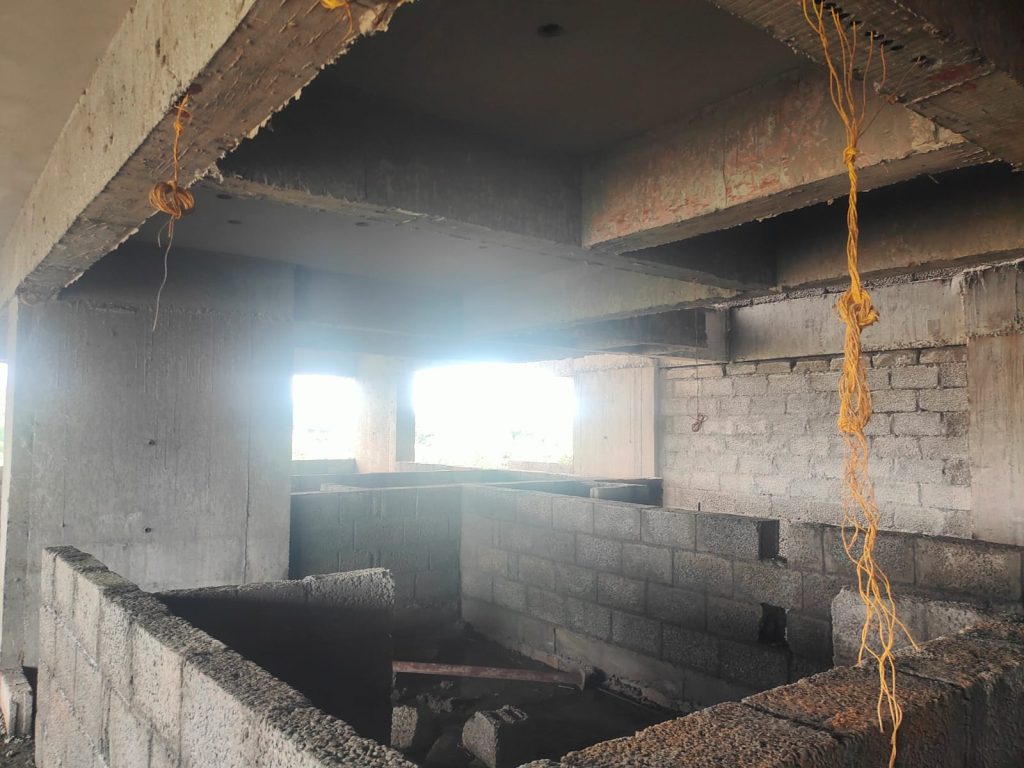

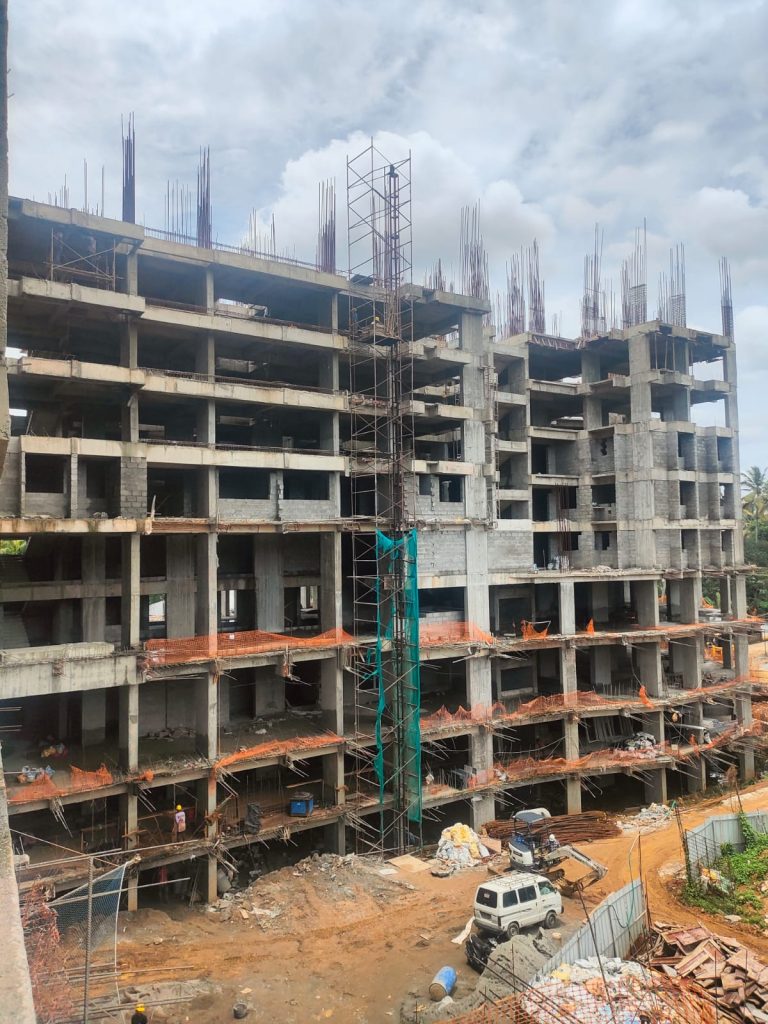

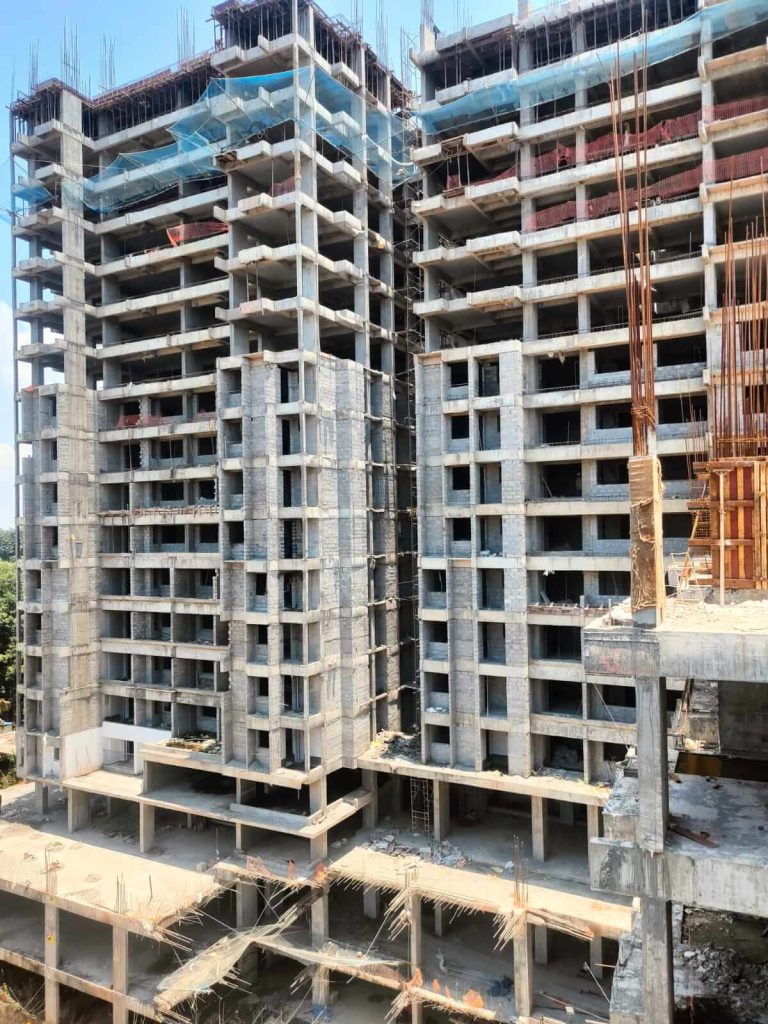

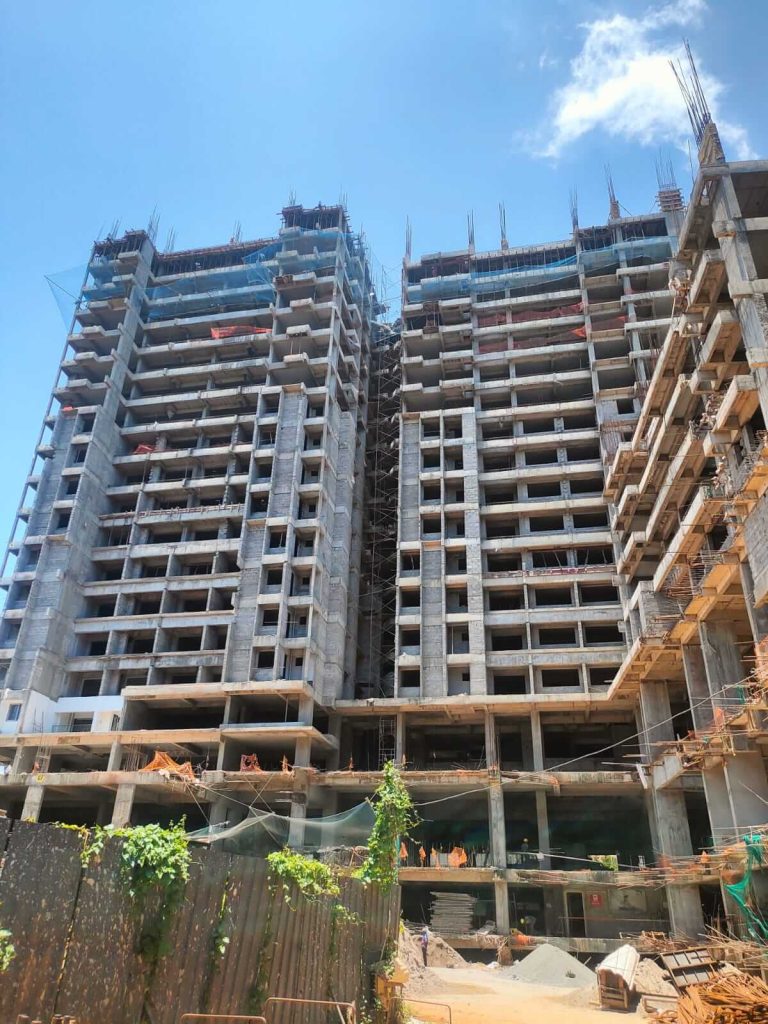

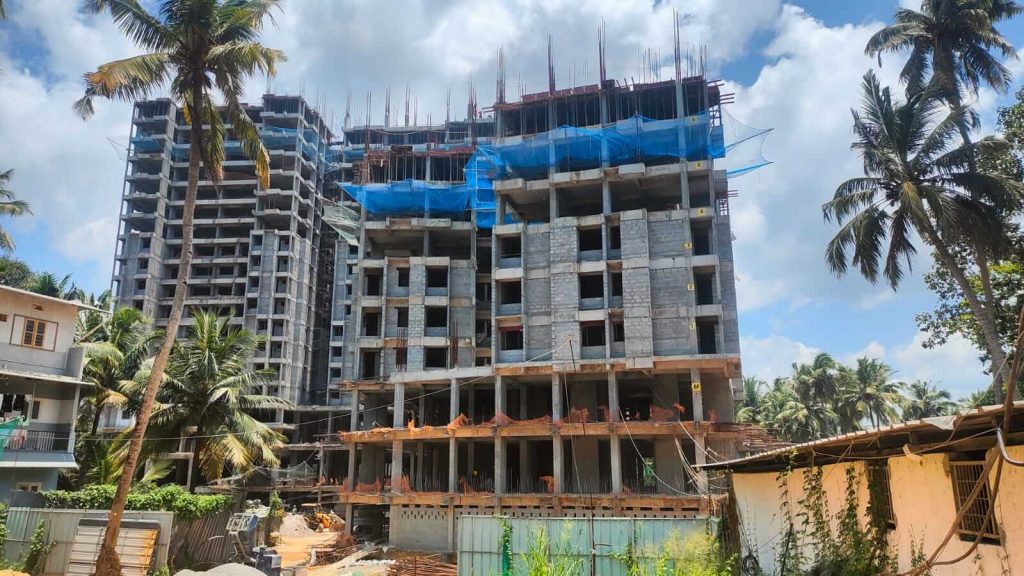

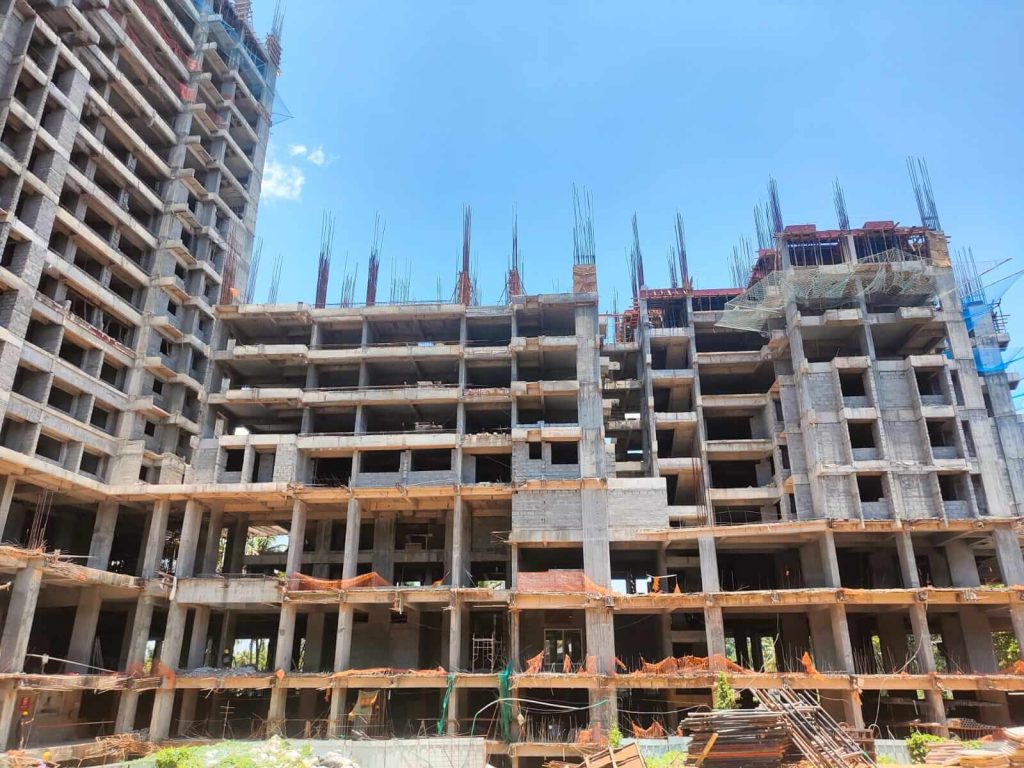

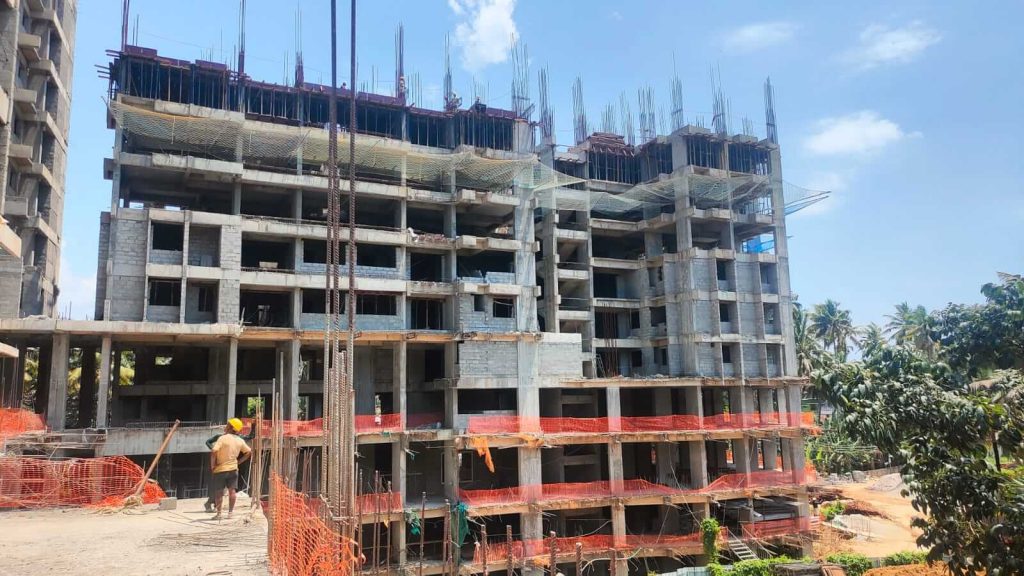

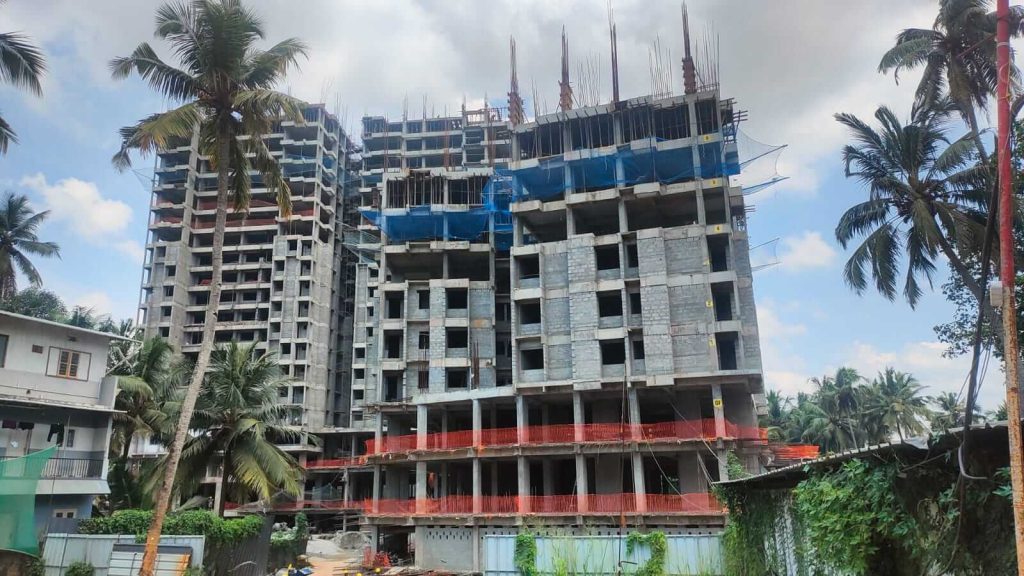

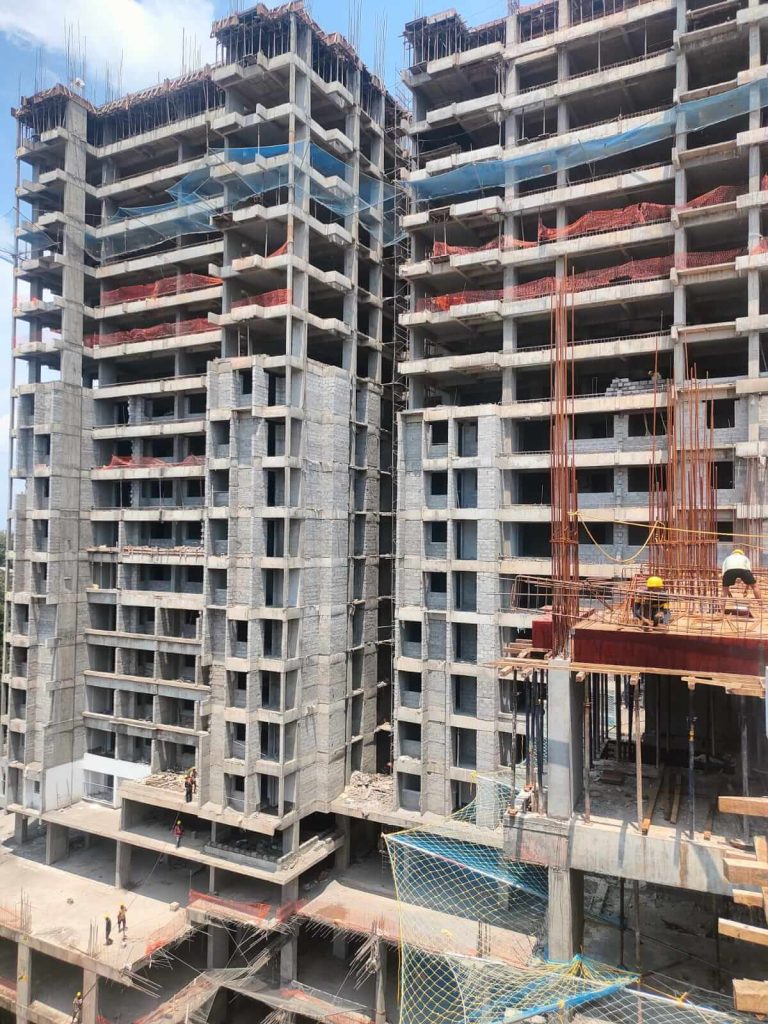

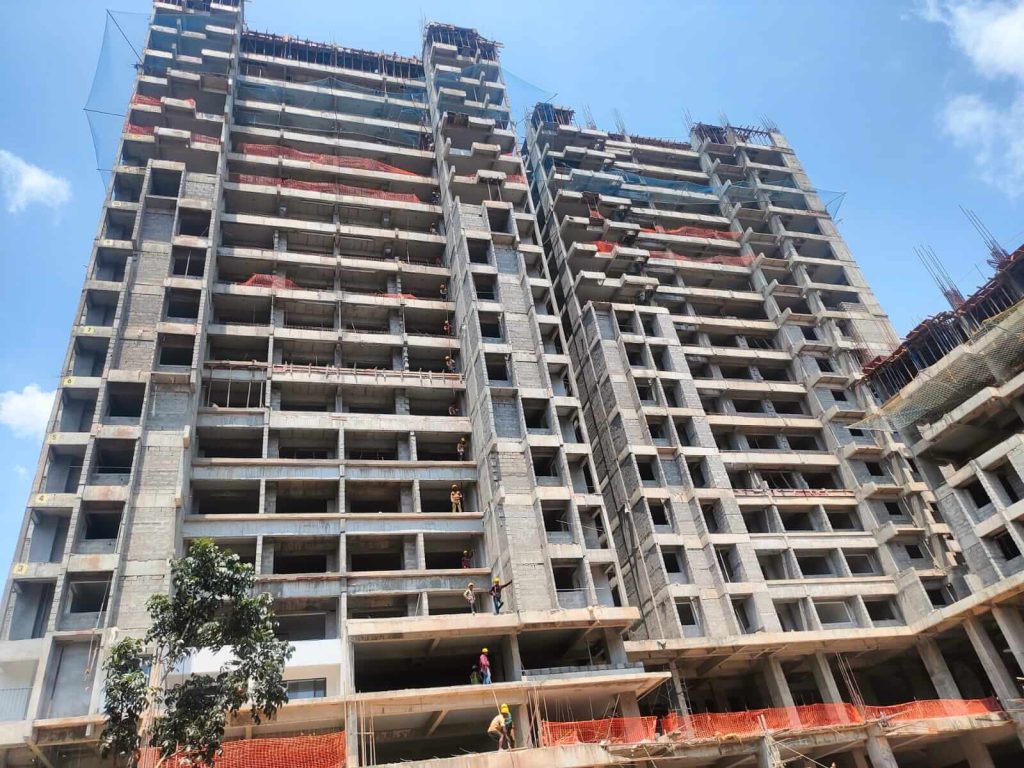

Work status as of 07-03-2026, we have completed the following.
ARTECH L’ATTITUDE (TOWER 1)
- CIVIL WORKS – Column and Shear wall RCC- 10th Floor 40% completed Staircase RCC -Basement – 1 Nos, Lower Ground Floor 2- 1Nos, Lower Ground Floor 1- 1 Nos, Ground Floor 2 Nos, FF 2 Nos, Second Floor 2 Nos, Third Floor 2 Nos completed, Fourth Floor 2nos ,Fifth Floor 2nos ,Six Floor 2nos ,7th Floor 2 Nos completed. 8th Floor 2 Nos completed. 9th Floor 100 % Completed . Ceiling plastering LG1 in progress, First Floor Flat inside completed, second Floor Flats inside completed ,Third Floor Flats inside completed. Fourth Floor 100% completed. 5th Floor ceiling plastering 100% completed. 6th Floor ceiling polastering 100% completed . 7th Floor 25% completed.
Block Work – First Floor Flats completed, Second Floor Flats 100% completed .Third Floor 100% completed ,Fourth Floor 100% completed , 6th Floor 80% completed. 7th Floor 10% Completed. 5th Floor hold. Inside Wall Plastering : F.Floor 1H and 1A Completed . 2nd Floor 2A, 2G,2H,2F, and 2B completed. Total 62.5% completed
ARTECH L’ATTITUDE (TOWER 2)

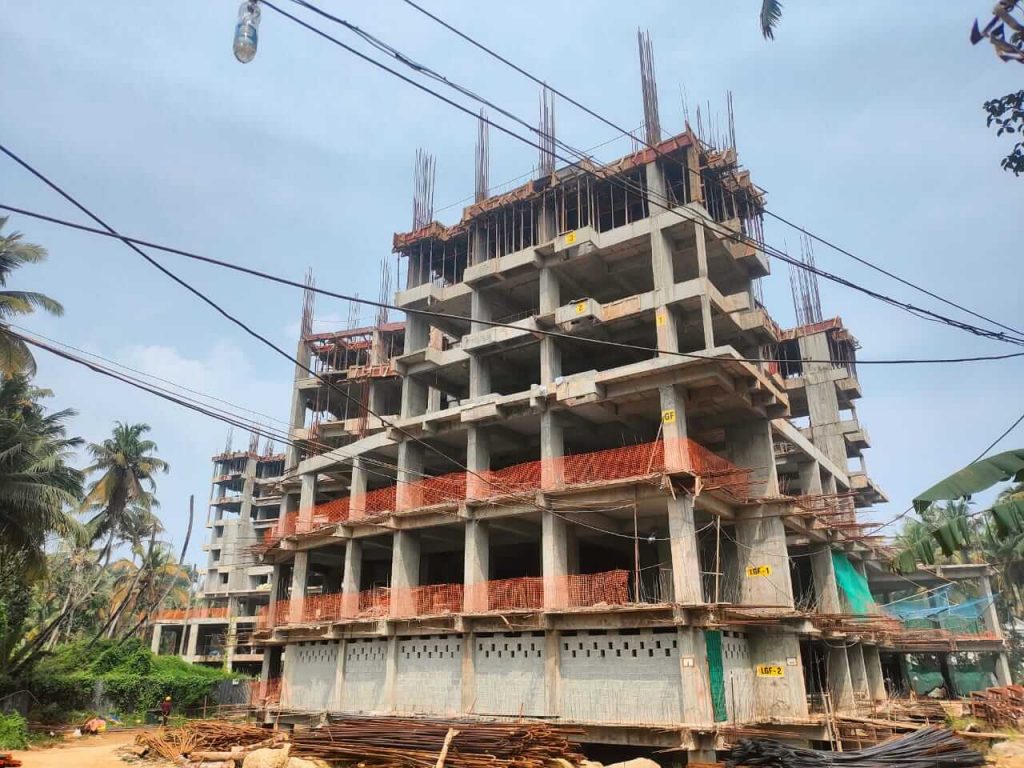

- CIVIL WORKS – Column and Shear wall RCC- 5th Floor 90% completed.
Slab RCC- 6th Floor slab 35% Completed.Staircase RCC -Basement – 1 Nos, LGF2 – 1Nos, Lower Ground 1- 1Nos, Ground Floor – 2 Nos, First Floor 2 Nos .Third Floor 2Nos,Fourth Floor -2nos .5th Floor -2nos completed. Block work : Tower 2 G.Floor – 20% completed. F.Floor 45% completed .2nd Floor 50% Completed. Ceiling Plastering : G.Floor 20% comleted .F.Floor 35% completed.
As per the current site work status, we are targeted to complete the following works by the end of March 2026.
ARTECH L’ATTITUDE (TOWER 1)
- CIVIL WORKS – Column and Shear wall RCC- 9th Floor balance 20% and 10tth Floor balance 100 % planned .Slab RCC- 10th Floor balance 60% Planned , 11th floor 50% planned. Staircase RCC -10th floor 2 Nos, palnned , 10th floor 1no planned .Ceiling plastering: 7th Floor 75%, planned 8th Floor 25% planned . Block Work -Sixth Floor Balance 20%, planned. Saventh Floor 50% planned . Inside wall Plastering : 2nd Floor balance 37.5% planned
ARTECH L’ATTITUDE (TOWER 2)
- CIVIL WORKS – 5th floor balance 10% balance planned .6th Floor 50% planned
- SLAB RCC – 6th floor Slab Balance 65% planned . 7th Floor 50% planned.
- Staircase RCC – 5th floor – 2 No. 6th Floor 2nos planned.
- Block Work -G.Floor balacne 80% and FirsFloor Flats 80% planned . Second Floor 65% Planned.

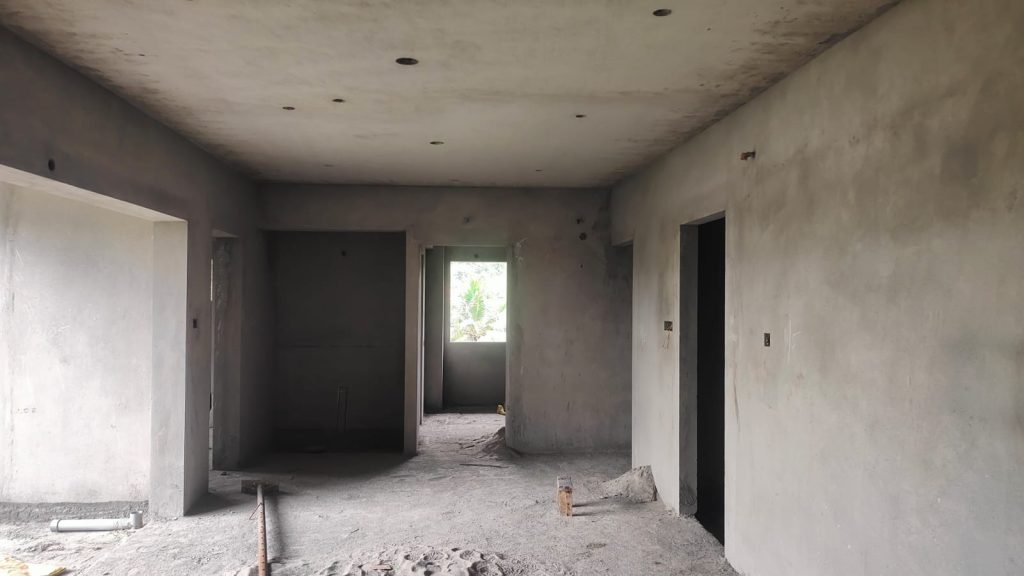

- Ceiling Plastering -First Floor Flats inside 55% ,Second Floor Flat inside 50% planned.
Work status as on 06-02-2026, we have completed the following.
ARTECH L’ATTITUDE (TOWER A)
- CIVIL WORKS – Column and Shear wall RCC- Basement- 100%, Lower Ground 2 100%, Lower Ground 1-100% ,Ground Floor 100% completed, First Floor- 100%, Second floor 100% completed, Third Floor 100% completed. Fourth Floor 100% completed, Fifth Floor 100% completed .Sixth Floor 100% completed, 7th Floor 100% completed . 8th Floor 100% completed Slab RCC- Basement- 100%, Lower Ground 2 100%, Lower Ground 1-100% ,Ground Floor 100% completed, First Floor – 100%, Second floor 100% completed, Third Floor 100% completed, Fourth Floor 100% completed. Fifth Floor 100% completed ,Sixth Floor 100% completed, Seventh floor 100 % Completed, 8th Floor 100% completed. 9th Floor 50% completed Staircase RCC -Basement – 1 Nos, Lower Ground Floor 2- 1Nos, Lower Ground Floor 1- 1 Nos, Ground Floor 2 Nos, First Floor 2 Nos, Second Floor 2 Nos, Third Floor 2 Nos completed, Fourth Floor 2nos ,Fifth Floor 2nos ,Six Floor 2nos ,7th Floor 2 Nos completed. 8th Floor 2 Nos completed. 9th Floor 50% Completed Ceiling plastering Lower Ground 1 in progress, First Floor Flat inside completed, second Floor Flats inside completed ,Third Floor Flats inside completed. Fourth Floor 100% completed. 5th Floor ceiling plastering 100% completed Block Work – First Floor Flats completed, Second Floor Flats 100% completed .Third Floor 100% completed ,Fourth Floor 100% completed , 5th floor 70%, 6th Floor 30% completed
ARTECH L’ATTITUDE (TOWER B)
- CIVIL WORKS – Column and Shear wall RCC- Basement- 100%, Lower Ground 2 100%, Lower Ground 1-100% ,Ground Floor 100%, First Floor 100% completed.Second Floor 100% completed .Third Floor 100% Completed , Fourth Floor 100 % Completed. 5th Floor 50% completed.Slab RCC- Basement- 100%, Lower Ground 2 100%, Lower Ground 1-100% ,Ground Floor 100%, First Floor 100% completed, Second Floor 100% completed. Third Floor 100% completed ,Fourth Floor 100 %completed .Fifth Floor 50% completed Staircase RCC -Basement – 1 Nos, Lower Ground Floor 2 – 1Nos, Lower Ground 1- 1Nos, Ground Floor – 2 Nos, First Floor 2 Nos .Third Floor 2Nos ,Fourth Floor progress
As per the current work status from our site, we are targeted to complete the following works by the end of February 2026.
ARTECH L’ATTITUDE (TOWER A)
- CIVIL WORKS – Column and Shear wall RCC- 9th Floor balance 100 % planned , 10th Floor Column 50% Planned Slab RCC- 10th Floor 100% Planned , 11th floor 50% planned.Staircase RCC -9th floor 2 Nos, planned , 10th floor 1no planned .Ceiling plastering: Sixth Floor 100%, Seventh Floor 100% planned .
- Block Work – Sixth Floor Balance 70%, planned. Seventh Floor 100% planned
ARTECH L’ATTITUDE (TOWER B)
- CIVIL WORKS – Column and Shear wall RCC- 5th floor 100% balance planned .6th Floor 50% planned
- SLAB RCC – Fifth floor Balance 50% planned . Sixth Floor 100% planned
- Staircase RCC – Fourth floor – 2 No.Fifth Floor 2nos planned.
- Block Work – FirsFloor Flats 100% planned . Second Floor 50% Planned.
- Ceiling Plastering – First Floor Flats inside 100% ,Second Floor Flat inside 50% planned.
Work status as on 08-01-2026, we have completed the following.
ARTECH L’ATTITUDE (TOWER A)
- CIVIL WORKS – Column and Shear wall RCC- Basement- 100%, LG2 100%, LG1-100% ,GF 100% completed, FF- 100%, Second floor 100% completed, Third Floor 100% completed. Fourth Floor 100% completed, Fifth Floor 100% completed .Sixth Floor 100% completed, 7th Floor 75% completed Slab RCC- Basement- 100%, LG2 100%, LG1-100% ,GF 100% completed, FF- 100%, Second floor 100% completed, Third Floor 100% completed, Fourth Floor 100% completed. Fifth Floor 100% completed ,Sixth Floor 100% completed, Seventh floor 50 % Completed, Staircase RCC -Basement – 1 Nos, LGF2- 1Nos, LGF1- 1 Nos, GF 2 Nos, FF 2 Nos, Second Floor 2 Nos, Third Floor 2 Nos completed Fourth Floor 2nos ,Fifth Floor 2nos ,Six Floor 2nos ,7th Floor progress .Ceiling plastering LG1 in progress, First Floor Flat inside completed, second Floor Flats inside completed ,Third Floor Flats inside completed. Fourth Floor 50% completed. Block Work – First Floor Flats completed, Second Floor Flats 100% completed .Third Floor 100% completed ,Fourth Floor 50% completed
- Podium Area – Column and Shear wall RCC- Basement- 95%, LG2 95%, LG1-95% ,GF 95% completed. Slab RCC- Basement- 95%, LG2 95%, LG1-95% ,GF 95% completed. Staircase RCC- Basement – 1 No, LGF2 – 1 No completed.
ARTECH L’ATTITUDE (TOWER B)
- CIVIL WORKS – Column and Shear wall RCC- Basement- 100%, LG2 100%, LG1-100% ,GF 100%, First Floor 100% completed.Second Floor 100% completed .Third Floor 100% Completed , Fourth Floor 50 % Completed. Slab RCC- Basement- 100%, LG2 100%, LG1-100% ,GF 100%, First Floor 100% completed, Second Floor 100% completed. Third Floor 100% completed ,Fourth Floor 100 % completed . Staircase RCC -Basement – 1 Nos, LGF2 – 1 Nos, LG1- 1 No, GF – 2 Nos, FF 2 Nos .Third Floor 2Nos ,Fourth Floor in progress
- Podium Area – Column and Shear wall RCC- Basement- 80%, LG2 80%, LG1-80% ,GF 85% completed. Slab RCC- Basement- 95%, LG2 95%, LG1-95% ,GF 95% completed.
As per the current work status from our site, we are targeted to complete the following works by the end of January 2026
ARTECH L’ATTITUDE (TOWER A)
- CIVIL WORKS – Column and Shear wall RCC- 7th Floor balance 50 % planned , 8th Floor Column 100% Planned ; Slab RCC- 8th Floor 100% Planned , 9th floor 50% planned Staircase RCC -7th floor 2 Nos, planned , 8th floor 1no planned .Ceiling plastering: LG1 75% planned Fourth Floor 50%, planned Sixth Floor 100% planned to be completed.
- Block Work – Fourth Floor 50%, planned. Sixth Floor 100% planned .
ARTECH L’ATTITUDE (TOWER B)
- CIVIL WORKS – Column and Shear wall RCC- 4th floor 50% balance planned .5th Floor 100% planned to be completed.
- SLAB RCC – Fifth floor 100% planned to be completed. Sixth Floor 50% planned Staircase RCC – Fourth floor – 2 No.Fifth Floor 2nos planned to be completed .Block Work : FirsFloor FLats 50% balance to be planned . Second Floor 50% Planned to be completed.
- CEILING PLASTERING – First Floor FLats inside 100% ,Second Floor Flat inside 50% planned to be completed
Work status as on 08-12-2025, we have completed the following.
ARTECH L’ATTITUDE (Tower 1)
- CIVIL WORKS – Building Area – Column and Shear wall RCC- Basement- 100%, Lower Ground 2 100%, Lower Ground 1-100% ,Ground Floor 100% completed, First Floor- 100%, Second floor 100% completed, Third Floor 100% completed, Fourth Floor 100% completed, 6th floor in progress. Slab RCC- Basement- 100%, Lower Ground 2 100%, Lower Ground 1-100% ,Ground Floor 100% completed, First Floor- 100%, Second floor 100% completed, Third Floor 100% completed, Fourth Floor 100% completed, Fifth Floor 100% completed,Fifth Floor 100% completed Seventh Floor in progress. Staircase RCC -Basement – 1 Nos, Lower Ground Floor 2- 1Nos, Lower Ground Floor 1- 1 Nos, Ground Floor 2 Nos, First Floor 2 Nos, Second Floor 2 Nos, Third Floor 2 Nos completed, Fourth Floor 2 Nos completed. Ceiling plastering Lower Ground 1 in progress, First Floor 60% completed, Second Floor in Progress. Block Work – First Floor in Progress, Second Floor in progress.
ARTECH L’ATTITUDE (Tower 2)
- CIVIL WORKS – Column and Shear wall RCC- Basement- 100%, LG2 100%, Lower Ground 1-100% ,Ground Floor 100%, First Floor 100% completed, Second Floor 100% completed, Third Floor 70% completed.
Slab RCC- Basement- 100%, Lower Ground 2 100%, Lower Ground 1-100% ,Ground Floor 100%, First Floor 100% completed, Second Floor 100% completed, Third Floor 100% completed.
Staircase RCC -Basement – 1 Nos, Lower Ground Floor 2 – 1 Nos, Lower Ground 1- 1 No, Ground Floor – 2 Nos, FF 2 Nos completed.second 2 nos completed.Third floor 25% completed
ceiling plastering – Lower Ground Floor 2 -10% Completed,Lower Ground Floor -2 60% Completed,Ground Floor work in progress
Blockwork-Lower Ground Floor -1 10% Completed,First Floor in Progress
ARTECH L’ATTITUDE (Tower A)
- CIVIL WORKS – Podium Area – Column and Shear wall RCC- Basement- 95%, Lower Ground 2 95%, Lower Ground 1-95% ,Ground Floor 95% completed. Slab RCC- Basement- 95%, Lower Ground 2 95%, Lower Ground 1-95% ,Ground Floor 95% completed. Staircase RCC- Basement – 1 No, Lower Ground Floor 2 – 1 No completed.
ARTECH L’ATTITUDE (Tower B)
- CIVIL WORKS – Column and Shear wall RCC- Basement- 80%, Lower Ground 2 80%, Lower Ground 1-80% ,Ground Floor 85% completed. Slab RCC- Basement- 95%, Lower Ground 2 95%, Lower Ground 1-95% ,Ground Floor 95% completed.
As per the current work status from our site, we are targeted to complete the following works by the end of DECEMBER 2025.
- CIVIL WORKS – Column and Shear wall RCC-Third Floor to be completed. Slab RCC- 4th Floor to be completed, Staircase RCC-4th Floor to be completed, Ceiling Plastering- GF to be completed,Blockwork-FF to be completed
Work status as on 06-11-2025, we have completed the following.
ARTECH L’ATTITUDE (TOWER A)
- CIVIL WORKS –
Column and Shear wall RCC- Basement- 100%, LG2 100%, LG1-100% ,GF 100% completed, FF- 100%, Second floor 100% completed, Third Floor 100% completed, Fourth Floor 100% completed, 5th floor in progress. Slab RCC- Basement- 100%, LG2 100%, LG1-100% ,GF 100% completed, FF- 100%, Second floor 100% completed, Third Floor 100% completed, Fourth Floor 100% completed, Fifth Floor 100% completed, Sixth Floor in progress. Staircase RCC -Basement – 1 Nos, LGF2- 1Nos, LGF1- 1 Nos, GF 2 Nos, FF 2 Nos, Second Floor 2 Nos, Third Floor 2 Nos completed, Fourth Floor 2 Nos completed. Ceiling plastering LG1 in progress, First Floor 60% completed, Second Floor in Progress. Block Work – First Floor in Progress, Second Floor in progress.
- Podium Area – Column and Shear wall RCC- Basement- 95%, LG2 95%, LG1-95% ,GF 95% completed. Slab RCC- Basement- 95%, LG2 95%, LG1-95% ,GF 95% completed. Staircase RCC- Basement – 1 No, LGF2 – 1 No completed.
ARTECH L’ATTITUDE (TOWER B)
- CIVIL WORKS – Column and Shear wall RCC- Basement- 100%, LG2 100%, LG1-100% ,GF 100%, First Floor 100% completed, Second Floor 100% completed, Third Floor in progress. Slab RCC- Basement- 100%, LG2 100%, LG1-100% ,GF 100%, First Floor 100% completed, Second Floor 100% completed, Third Floor in progress. Staircase RCC -Basement – 1 Nos, LGF2 – 1 Nos, LG1- 1 No, GF – 2 Nos, FF 2 Nos completed.
- Podium Area – Column and Shear wall RCC- Basement- 80%, LG2 80%, LG1-80% ,GF 85% completed. Slab RCC- Basement- 95%, LG2 95%, LG1-95% ,GF 95% completed.
As per the current work status from our site, we are targeted to complete the following works by the end of NOVEMBER 2025.
ARTECH L’ATTITUDE (TOWER A)
- CIVIL WORKS – Column and Shear wall RCC- Fifth Floor- 100% to be completed ; Sixth Floor 50% to be completed. Slab RCC- Sixth Floor- 100%, Seventh Floor 50% to be completed ; Staircase RCC -Fifth Floor 2 Nos, Sixth Floor 1 Nos to be completed. Ceiling plastering LG1 in progres, First Floor 100%, Second Floor 100% to be completed, Third Floor 100% to be completed. Block Work – First Floor 100%, Second Floor 100% to be completed, Third Floor 100% to be completed. Internal Plastering – First Floor 50% to be completed.
ARTECH L’ATTITUDE (TOWER B)
- CIVIL WORKS – Column and Shear wall RCC- Third Floor 100% to be completed. Slab RCC- Third Floor 100% to be completed, Fourth Floor 50% to be completed. Staircase RCC – 3F- 2 No. to be completed. Cieling Plastering- LG1 100% to be completed, Ground Floor 50% to be completed.
Work status as on 07-10-2025, we have completed the following.
- Sub Structural Works – Piling Work-83 % completed, Pile cap RCC 83% completed
ARTECH L’ATTITUDE (TOWER A)
- CIVIL WORKS – Building Area – Column and Shear wall RCC- Basement- 100%, LG2 100%, LG1-100% ,GF 100% completed, FF- 100%, Second floor 100% completed, Third Floor 100% completed. Slab RCC- Basement- 100%, LG2 100%, LG1-100% ,GF 100% completed, FF- 100%, Second floor 100% completed, Third Floor 100% completed, Fourth Floor 70% completed. Staircase RCC -Basement – 1 Nos, LGF2- 1Nos, LGF1- 1 Nos, GF 2 Nos, FF 2 Nos, Second Floor 2 Nos, Third Floor 2 Nos completed. Ceiling plastering LG1 in progress, First Floor in Progress. Block Work – First Floor in Progress
- Podium Area- Basement- 95%, LG2 95%, LG1-95% ,GF 95% completed. Slab RCC- Basement- 95%, LG2 95%, LG1-95% ,GF 95% completed. Staircase RCC- Basement – 1 No, LGF2 – 1 No completed.
ARTECH L’ATTITUDE (TOWER B)
- CIVIL WORKS – Building Area – Column and Shear wall RCC-Basement- 100%, LG2 100%, LG1-100% ,GF 100%, First Floor 90% completed. Slab RCC- Basement- 100%, LG2 100%, LG1-100% ,GF 100%, First Floor 100% completed, Second Floor 40% completed. Staircase RCC -Basement – 1 Nos, LGF2 – 1 Nos, LG1- 1 No, GF – 2 Nos, FF 2 Nos completed
- Podium Area- Column and Shear wall RCC- Basement- 80%, LG2 80%, LG1-80% ,GF 85% completed. Slab RCC- Basement- 95%, LG2 95%, LG1-95% ,GF 95% completed.
As per the current work status from our site, we are targeted to complete the following works by the end of OCTOBER 2025
ARTECH L’ATTITUDE (TOWER A)
- CIVIL WORKS – Column and Shear wall RCC- Fourth Floor- 100% to be completed ; Slab RCC- Fourth Floor- 100%, Fifth Floor 75% to be completed ; Staircase RCC -Fourth Floor 2 Nos, Fifth Floor 1 Nos to be completed. Ceiling plastering LG1 in progres, First Floor 100%, Second Floor 70% to be completed. Block Work – First Floor 100%, Second Floor 30% to be completed.
ARTECH L’ATTITUDE (TOWER B)
- CIVIL WORKS – Column and Shear wall RCC- FF 100%, Second Floor 100% to be completed. Slab RCC- Second Floor Slab 100% completed, Third Floor 20% to be completed. Staircase RCC – 2F- 2 No. to be completed
Work status as on 09-09-2025, we have completed the following.
- Sub Structural Works – Piling Work-83 % completed, Pile cap RCC 83% completed
ARTECH L’ATTITUDE (TOWER A)
- CIVIL WORKS – Building Area – Column and Shear wall RCC- Basement- 100%, LG2 100%, LG1-100% ,GF 100% completed, FF- 100%, Second floor 100% completed. Slab RCC- Basement- 100%, LG2 100%, LG1-100% ,GF 100% completed, FF- 100%, Second floor 100% completed, Third Floor 50% completed. Staircase RCC -Basement – 1 Nos, LGF2- 1Nos, LGF1- 1 Nos, GF 2 Nos, FF 2 Nos, Second Floor 2 Nos completed. Ceiling plastering LG1 in progress. Block Work – First Floor in Progress
- Podium Area- Column and Shear wall RCC- Basement- 95%, LG2 95%, LG1-95% ,GF 95% completed. Slab RCC- Basement- 95%, LG2 95%, LG1-95% ,GF 95% completed. Staircase RCC- Basement – 1 No, LGF2 – 1 No completed.
ARTECH L’ATTITUDE (TOWER B)
- CIVIL WORKS – Building Area – Column and Shear wall RCC- Basement- 100%, LG2 100%, LG1-100% ,GF 100%, First Floor 50% completed. Slab RCC- Basement- 100%, LG2 100%, LG1-100% ,GF 100%, First Floor 50% completed. Staircase RCC -Basement – 1 Nos, LGF2 – 1 Nos, LG1- 1 No, GF – 2 Nos completed
- Podium Area- Column and Shear wall RCC- Basement- 80%, LG2 80%, LG1-80% ,GF 85% completed. Slab RCC- Basement- 95%, LG2 95%, LG1-95% ,GF 95% completed./li>
As per the current work status from our site, we are targeted to complete the following works by the end of SEPTEMBER 2025.
ARTECH L’ATTITUDE (TOWER A)
- CIVIL WORKS – Column and Shear wall RCC- Third Floor- 100% to be completed ; Slab RCC- Third Floor- 100%, Fourth Floor 75% to be completed ; Staircase RCC -Third Floor 2 Nos, Fourth Floor 1 Nos to be completed. Ceiling plastering LG1 in progress. Block Work – First Floor in Progress
ARTECH L’ATTITUDE (TOWER B)
- CIVIL WORKS – Column and Shear wall RCC- FF 100%, Second Floor 50% to be completed. Slab RCC- FF Slab 100% complete, Second Floor 50% to be completed. Staircase RCC -FF- 2 No. to be completed
Work status as on 06-08-2025, we have completed the following.
- Sub Structural Works – Piling Work-83 % completed
ARTECH L’ATTITUDE (TOWER A)
- CIVIL WORKS – Building Area – Column and Shear wall RCC- Basement- 100%, LG2 100%, LG1-100% ,GF 100% completed, FF- 100%, Second floor 10% completed. Slab RCC- Basement- 100%, LG2 100%, LG1-100% ,GF 100% completed, FF- 100%, Second floor 70% Completed. Staircase RCC -GF 2 Nos, FF 1 Nos. completed. Ceiling plastering LG1 in progress.
ARTECH L’ATTITUDE (TOWER B)
- CIVIL WORKS – Building Area – Column and Shear wall RCC- Basement- 100%, LG2 100%, LG1-100% ,GF 85% completed. Slab RCC- Basement- 100%, LG2 100%, LG1-100% ,GF 100% completed. Staircase RCC -LG1- 1 No. completed
As per the current work status from our site, we are targeted to complete the following works by the end of AUGUST 2025.
ARTECH L’ATTITUDE (TOWER A)
- CIVIL WORKS – Building Area – Footing RCC- 47cum, Column RCC-34cum, Raft Slab RCC- 140 cum, Excavation-112 cum, Backfilling-180 cum, PCC- 29 cum, GF Slab RCC- 195 cum, LGF1,LGF2 Slab RCC- 370 cum, Staircase RCC-22 cum, Retaining Wall RCC- 14 cum, Lift Wall RCC- 21cum, Backfilling-85 cum, Excavation-125 cum
ARTECH L’ATTITUDE (TOWER B)
- CIVIL WORKS – Building Area Column and Shear wall RCC- GF 100% to be completed, FF 25% to be comp;eted. Slab RCC- FF Slab 100% completed, Staircase RCC -GF- 2 No. to be completed
Work status as on 09-06-2025, we have completed the following.
ARTECH L’ATTITUDE (TOWER A)
- Sub Structural Works – Column RCC- 64.974 cum, Slab RCC- 280.73cum, Excavation-40 cum, Backfilling-24 cum, PCC- 9.5cum, Shear Wall RCC- 11.75 cum,Plinth Beam RCC-6.265cum,Staircase RCC -5.2 cum, Raft Slab-55 cum
ARTECH L’ATTITUDE (TOWER B)
- Sub Structural Works – PCC-41 cum ,Pile cap RCC- 63.045 cum, Column RCC- 33.934 cum, Shear Wall RCC- 4.67 cum, Slab RCC-96 cum, Backfilling- 32 cum, Excavation-42 cum, Raft Slab RCC-66.5 cum, Staircase RCC -1.8 cum, Plinth Beam RCC- 2.26cum
As per the current work status from our site, we are targeted to complete the following works by the end of JUNE 2025.
ARTECH L’ATTITUDE (TOWER A)
- Sub Structural Works – Column RCC-48.56 cum, Slab RCC- 220 cum,Staircase RCC-8.4 cum, Shearwall RCC- 7.8 cum
ARTECH L’ATTITUDE (TOWER B)
- Sub Structural Works – Column RCC-36 cum,Slab RCC-95 cum,Shear Wall RCC-6.5 cum, Staircase RCC-5.3 cum, Backfilling-82 cum, Excavation-25 cum
Work status as on 09-05-2025, we have completed the following.
- Sub Structural Works – Tower A – Excavation-45 cum, Backfilling-28 cum, PCC- 9.5cum, Column RCC- 52.59 cum, GF Slab RCC- 210 cum, Shear Wall RCC- 9.01cum,Slab RCC-279.74 cum,Plinth Beam RCC-6.265cum,Staircase RCC -2.875 cum, Tower B – PCC-31.075 cum ,Pile cap RCC- 63.045 cum, Column RCC- 12.44 cum, Shear Wall RCC- 4.72 cum, Slab RCC-79.5 cum, Backfilling- 42cum, Excavation-75 cum, Raft Slab RCC-32.37cum, Staircase RCC -1.7 cum, Plinth Beam RCC- 2.26cum
As per the current work status from our site, we are targeted to complete the following works by the end of MAY 2025.
- Sub Structural Works – Tower A – PCC-24.05 cum, Footing RCC- 32cum, Column RCC-44.25 cum, Slab RCC- 225 cum, Excavation-112 cum, PCC- 11 cum, GF Slab RCC- 195 cum, Staircase RCC-5.75 cum, Shearwall RCC- 6.3 cum, Tower B – Slab RCC-95 cum, Plinth Beam RCC-4.5 cum, Staircase RCC-2.6cum, Shear Wall RCC- 5.2 cum, Raft Slab RCC- 65cum, PCC- 31cum, Backfilling-120 cum, Excavation-25 cum,Column RCC-26 cum,
Artech “L’Attitude
Work status as on 10-04-2025, we have completed the following.
ARTECH L’ATTITUDE (TOWER A)
- Sub Structural Works – Footing RCC- 58.325 cum,Excavation-85 cum, Backfilling-60 cum, PCC- 15cum, Raft Slab RCC- 48.2 cum, Column RCC- 50.62 cum, GF Slab RCC- 82 cum, Retaining Wall RCC- 8.995 cum,Slab RCC-279.74 cum,Plinth Beam RCC-6.265cum,Staircase RCC -2.875 cum,
ARTECH L’ATTITUDE (TOWER B)
- Sub Structural Works – PCC-7.75 cum ,Pile cap RCC- 52.5cum, Column RCC- 32.62 cum, Retaining Wall RCC- 5.1 cum, Slab RCC-111.625cum, PCC- 34 cum, Backfilling- 80cum, Excavation-114 cum, Lift Pit shear walls and columns- 14cum
As per the current work status from our site, we are targeted to complete the following works by the end of APRIL 2025.
ARTECH L’ATTITUDE (TOWER A)
- Sub Structural Works – Footing RCC- 32cum, Column RCC-72 cum, Slab RCC- 270cum, Excavation-112 cum, Backfilling-180 cum, PCC- 11 cum, GF Slab RCC- 195 cum, LGF1,LGF2 Slab RCC- 370 cum, Staircase RCC-22 cum, Retaining Wall RCC- 14 cum, Lift Wall RCC- 21cum, Backfilling-60 cum, Excavation-75 cum
ARTECH L’ATTITUDE (TOWER B)
- Sub Structural Works – Pile cap RCC-56 cum, Slab RCC-258 cum, Plinth Beam RCC-5.6 cum, GF Slab RCC- 145 cum,Staircase RCC-9 cum, Lift Wall RCC- 6 cum, Retaining Wall RCC- 5.1 cum, Raft Slab RCC- 196cum, PCC- 35cum, Backfilling-120 cum, Excavation-25 cum
Work status as on 10-03-2025, we have completed the following.
ARTECH L’ATTITUDE (TOWER A)
- Sub Structural Works – Footing RCC- 76 cum, Lift Pit with Combined Footing- 51.3 cum, Excavation-112 cum, Backfilling-180 cum, PCC- 17 cum, Raft Slab RCC- 48.2 cum, Column RCC- 13.14 cum, GF Slab RCC- 82 cum, Retaining Wall RCC- 15.7 cum
ARTECH L’ATTITUDE (TOWER B)
- Sub Structural Works – Pile cap RCC- 81.94 cum, Column RCC- 16.718 cum, Retaining Wall RCC- 5.1 cum, Raft Slab RCC- 72 cum, PCC- 34 cum, Backfilling- 94 cum, Excavation-115 cum, Lift Pit shear walls and columns- 14cum
As per the current work status from our site, we are targeted to complete the following works by the end of MARCH 2025.
ARTECH L’ATTITUDE (TOWER A)
- Sub Structural Works – Footing RCC- 47cum, Column RCC-34cum, Raft Slab RCC- 140 cum, Excavation-112 cum, Backfilling-180 cum, PCC- 29 cum, GF Slab RCC- 195 cum, LGF1,LGF2 Slab RCC- 370 cum, Staircase RCC-22 cum, Retaining Wall RCC- 14 cum, Lift Wall RCC- 21cum, Backfilling-85 cum, Excavation-125 cum
ARTECH L’ATTITUDE (TOWER B)
- Sub Structural Works – Pile cap RCC- 98 cum, LGF1,LGF2 Slab RCC-250 cum, GF Slab RCC- 145 cum,Staircase RCC-12 cum, Lift Wall RCC- 8cum, , Retaining Wall RCC- 5.1 cum, Raft Slab RCC- 196cum, PCC- 22cum
Work status as on 13-02-2025, we have completed the following.
- Sub Structural Works – EXCAVATION-187.65CUM,PCC-14.7CUM, BASE SLAB RCC-44.07CUM, EARTH FILLING-88.2CUM, COLUMN RCC-23CUM, SHEAR WALL RCC-28.8CUM, PLINTH BEAM RCC-5.4CUM, RAFT SLAB RCC-55.5CUM, GF SLAB RCC-110CUM, COLUMN RCC-32.77CUM, PILE CAP RCC-66.3CUM, GF SLAB RCC-134CUM, EXCAVATION -410CUM, BACKFILLING-322CUM, BACKFILLING-322CUM, LIFT WALL RCC -4.6CUM
As per the current work status from our site, we are targeted to complete the following works by the end of FEBRUARY 2025.
- Sub Structural Works – FOOTINGRCC-82.175,LIFT PIT WITH COMBINED FOOTING-50.37,EXCAVATION-156.32,BACK FILLING-261,PCC-33.2,BASE SLAB RCC-6.4,COLUMN RCC-23.1,RETAINING WALL-21.63,GROUND FLOOR RCC-85.2,LGF1 SLAB RCC-94.37,LGF2 SLAB RCC-126,PILECAP RCC-52.3,EXCAVATION-166,PLINTH BEAM-8.2,PCC-35RAFT SLAB -147,LGF1 SLAB RCC-122,BASEMENT COLUMN RCC-19.99
